Article

An Intelligent Fuzzy MCDM Model Based on D and Z Numbers for Paver Selection: IMF D-SWARA—Fuzzy ARAS-Z Model

by
Stanislav Jovanović
1,
Edmundas Kazimieras Zavadskas
2,*,
Željko Stević
3,
Milan Marinković
1,
Adel F. Alrasheedi
4 and
Ibrahim Badi
5
1
Faculty of Technical Sciences, University of Novi Sad, Trg Dositeja Obradovića 6, 21000 Novi Sad, Serbia
2
Institute of Sustainable Construction, Vilnius Gediminas Technical University, Saulėtekio al. 11, 10223 Vilnius, Lithuania
3
Faculty of Transport and Traffic Engineering Doboj, University of East Sarajevo, Vojvode Mišića 52, 74000 Doboj, Bosnia and Herzegovina
4
Statistics and Operations Research Department, College of Science, King Saud University, Riyadh 11451, Saudi Arabia
5
Mechanical Engineering Department, Libyan Academy, Misurata 2429, Libya
*
Author to whom correspondence should be addressed.
Axioms 2023, 12(6), 573; https://doi.org/10.3390/axioms12060573
Submission received: 25 April 2023 / Revised: 29 May 2023 / Accepted: 7 June 2023 / Published: 8 June 2023

Abstract

:
One of the most important challenges when building road infrastructure is the selection of appropriate mechanization, on which the efficiency of construction and the life of exploitation depends largely. As construction machinery, pavers occupy a significant place in civil engineering projects, so their selection, depending on a road category, is a very important activity. The objective of this paper is to develop an intelligent Fuzzy MCDM (Multi-Criteria Decision-Making) model, which consists of the integration of D and Z numbers for the selection of construction machinery. The IMF D-SWARA (Improved Fuzzy D Step-Wise Weight Assessment Ratio Analysis) method was used to determine weighting coefficients. A novel Fuzzy ARAS-Z (Additive Ratio Assessment) method has been developed to determine an adequate paver for a lower category of roads (asphalt width up to 5 m), which represents an important contribution and novelty of the paper. A total of 10 alternatives were evaluated based on 16 criteria which were classified into 4 main groups. The results have shown that the alternative A8—SUPER 1300-3 represents a paver with the best characteristics for the considered set of parameters. After that, verification tests were calculated, and they include a comparative analysis with four other MCDM methods based on Z numbers, a change in the normalization procedure, and the impact of changing the size of an initial fuzzy matrix. The tests showed the stability of the developed model with negligible deviations.
MSC:
90B20; 90B20; 90b50

1. Introduction

Every year, the world’s population is increasing, and such a trend should continue in the future [1]. The increased population creates a greater need for infrastructure construction, such as residential buildings and transport infrastructure for connecting cities and transporting people and goods. An additional reason for new infrastructure is the deterioration of already existing infrastructure due to the effects of loads and external impacts. It is possible for the existing infrastructure to be reconstructed at appropriate time intervals. Whether it is the construction of new or the reconstruction of existing infrastructure, construction machinery is required. The type of construction machinery depends on the type of building it is being built. Thus, it is possible to use excavators, trucks, graders, rollers and pavers [2,3].
In this paper, the authors limited themselves to mechanization for the construction of transport infrastructure. Transport infrastructure requires large amounts of money for construction on the one hand, but, on the other hand, it can have a significant impact on the development of the country’s economy [4,5,6]. When building transport infrastructure, the main principle we are guided by is to obtain the best possible quality for as little money as possible. It is important to emphasize that the ratio between construction costs and future maintenance costs is also significant. The more material resources are invested in construction, the less the amount of funds available for maintenance and vice versa. The cost of infrastructure construction is influenced by many factors such as the type of road, the price of component materials, the complexity of the terrain on which the road is being built, the number of constructions (bridges and tunnels) that are being built on the route, the weather conditions in which the road is being built and many other factors. For the construction of transport infrastructure, construction machinery is used. Depending on its properties, it can affect the speed of the execution of works and, therefore, the price of the works. From the available division of mechanization for the construction of transport infrastructure, in this research, the authors selected pavers since there is an objective need for them. Pavers are machines that are used to install asphalt mixes in the layers of pavement structure. In recent times, pavers have also been used to make layers of crushed stone. Road construction usually has several layers, and their upper layers are made of asphalt. Asphalt mixtures can be installed using excavators and graders, but the most dominant and high-quality method is by using a paver. The main parts of the paver are paving material tank, conveyor belt, augers, tamper and screed [7]. Pavers differ from each other in working widths, tank capacities, conveyor belt speeds, the speed of the paver itself, engine power, width, length, height, weight, etc. Roads and road infrastructure are classified in different ways depending on criteria. In Serbia, where data have been collected for research, there are many divisions, and some of them are a division based on the administrative criterion, functional classification and classification based on terrain type.
In general, considering all these categories, it is evident that the categories differ according to the types of cross sections, the number of traffic lanes, the width of individual lanes as well as the total width of the roadway. It is these data regarding road categories that are significant when deciding on the type of paver. It reflects the importance of this scientific paper in which a novel original IMF D-SWARA-ARAS-Z model for multi-criteria evaluation of pavers has been developed and presented for the first time in the literature. In this way, emphasis has been given to the methodological aspect of this paper and the further possibility of applying the developed model to solve any problem in different areas of decision-making. Therefore, the aim of the paper implies the selection of an adequate paver as construction machinery for the construction of roads with a roadway width not exceeding five meters. Another important contribution and novelty that is significant to emphasize is the integration of D and Z numbers in the Fuzzy MCDM model, which, according to the literature search, has also been presented in this paper for the first time.
The further structure of the paper includes six other sections in which the research is explained in detail from the aspect of reviewing similar studies in the field, a detailed presentation of the developed Fuzzy MCDM model, a description of a case study with explanations of the parameters of the MCDM model, its application in the selection of a paver with certain overviews of calculation details, validity tests and concluding considerations.

2. Literature Review

The cost of infrastructure construction is influenced by many factors, such as the type of a road, the price of component materials, the complexity of the terrain on which the road is being built, the number of constructions (bridges and tunnels) that are being built on the route, the weather conditions in which the road is being built and many other factors. For the construction of transport infrastructure, we use construction machinery, which, depending on its properties, can affect the speed of the execution of works and, therefore, the price of the works.
Based on all of this, it can be said that it is very important to have appropriate and optimal selection of road construction mechanization. Optimal mechanization selection can be made using MCDM models. MCDM methods [8] were applied in civil engineering for the first time in the 1990s and in the research by Duckstein et al. [9]. Temiz and Calis [10] used MCDM methods to select an appropriate excavation machine for a construction site. In the study, the authors analyzed qualitative and quantitative criteria including technical specifications, purchasing cost, fuel consumption, service conditions, secondary and replacement parts markets and comfort of the operator. In their study, the authors used the Analytical Hierarchy Process (AHP) and the Preference Ranking Organization Method for Enrichment of Evaluation (PROMETHEE). Ivanović et al. [11] applied a MCDM method to select a truck mixer concrete pump. The authors used the MEREC (method based on the removal effects of criteria) and the DNMARCOS (double normalized measurement alternatives and ranking according to the compromise solution) method to select construction equipment among 16 alternatives. Ghorabaee et al. [12] presented the extension of the classical SWARA (Step-Wise Weight Assessment Ratio Analysis) and CRITIC (CRiteria Importance Through Intercriteria Correlation) methods in order to evaluate construction equipment considering sustainability. Further, integrating the extended SWARA and CRITIC methods with the fuzzy EDAS methods, was proposed as a novel approach. Phogat and Singh [13] applied five multi-criteria decision-making methods to select machines for hilly road construction. The authors examined the following five methods: AHP, SAW, Distance Based Method (DBM), PROMETHEE and Elimination Et Choice Translating Reality (ELECTRE).
Additionally, multi-criteria analysis can be useful in processes of route planning, design, selection of the most proper maintenance and reconstruction solution [14]. According to the literature review, the authors concluded that the AHP method was mostly applied when designing and constructing roads and transport infrastructure. Some other authors came to similar conclusions [15]. Analytical Hierarchy Process (AHP), Simple Additive Weighting (SAW), Fuzzy Overlay, Promethee and TOPSIS, which are methods of Multi-Criteria Decision Making (MCDM), were also used to determine a forest road route in the Black Sea region of Turkey [16]. The selection of an optimal highway route to connect Rijeka, Koper and Trieste was completed by using the PROMETHEE II method. Five road route alternatives were ranked using five groups of criteria (economic, transport, constructional-technical, urban planning and eco-sociological), including 26 sub-criteria [17]. Sekulić et al. [18] selected an optimal road route using a spatial multi-criteria method. The authors conducted a case study in the Tlokweng region in Botswana. The study included 13 criteria that were used to evaluate alternatives. The criteria were arranged into three groups: economic, environmental and social criteria.
A multi-criteria decision making, along with graphic displaying, was used to find a solution for a parking layout of freight transport in Slovakia [19]. Marzouk and Abdelakder [20] used multi-criteria optimization and decision-making in order to decrease environmental pollution in construction projects. Marcelino et al. [21] developed a multi-criteria decision-making model for identifying road maintenance and rehabilitation at the network level in Portugal. The authors used the MACBETH (Measuring Attractiveness by a Categorical Based Evaluation Technique) method as an alternative to the AHP method. The model was based on technical, economic and social criteria.

3. Methods

In this section, the algorithm of the developed MCDM model based on Z numbers is presented in detail. As noted, this research is part of a larger project that involved the selection of construction machinery for the middle, lower category of roads, as well as for highways. The decision-making model for the selection of a paver for the middle category of roads was developed in the paper [22] in which the weights of the criteria were defined with the IMF D-SWARA method. Those weighting coefficients have been used in this paper and integrated with a novel MCDM model for ranking pavers based on Z numbers.

3.1. Z Numbers

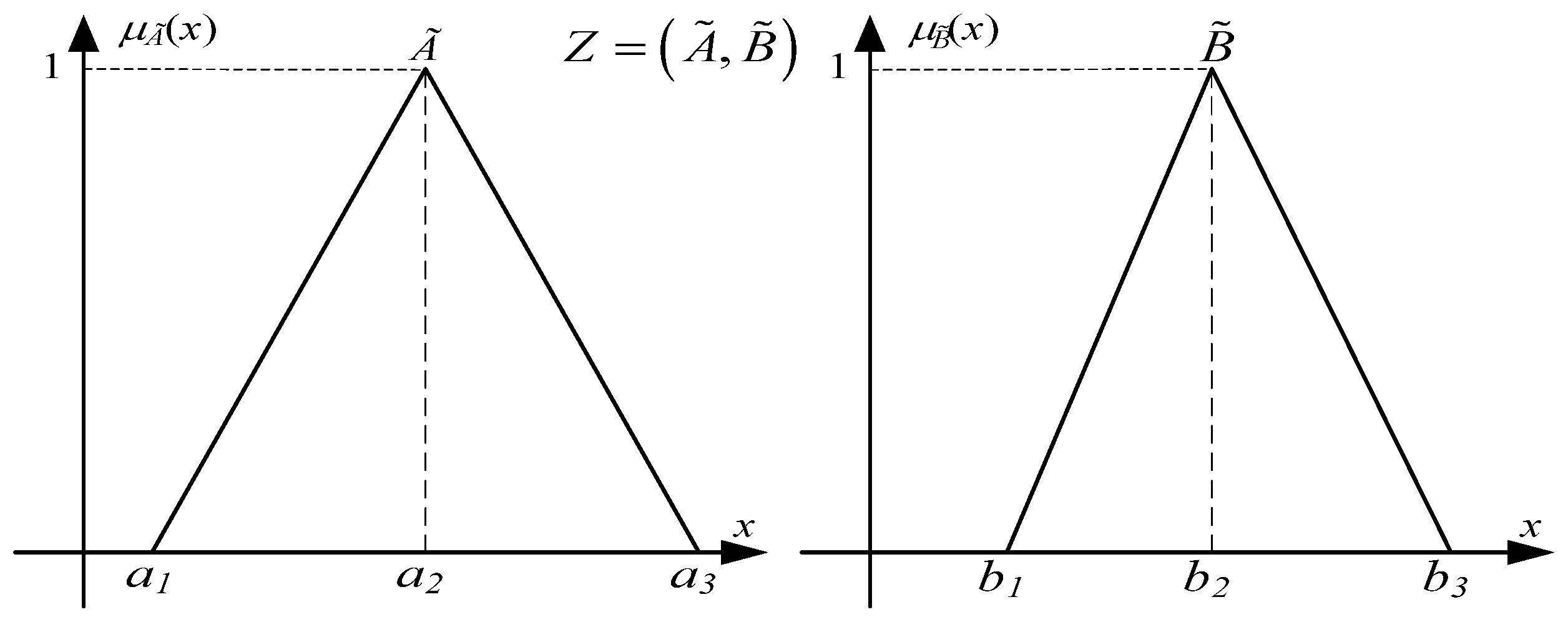

Z-numbers represent an ordered pair of fuzzy numbers, Z = ( A ˜ , B ˜ ). The first component is the fuzzy number A ˜ and is the fuzzy limit of a variable X, while the second component is the fuzzy number B ˜ and is the reliability of the first component ( A ˜ ). In Figure 1, the form of the Z-number with triangular fuzzy numbers is presented [23].
A general form of triangular Z-numbers can be presented as follows:
Z ˜ = { ( a 1 , a 2 , a 3 ; w A ˜ ) , ( b 1 , b 2 , b 3 ; w B ˜ ) }
where the values w A ˜ and w B ˜ represent the weight factors of fuzzy number A ˜ referring to B ˜ , which is, for the initial Z-number, defined by most authors as w A ˜ = w B ˜ = 1 , w A ˜ , w B ˜ [ 0 , 1 ] ( w A ˜ is the height of generalized fuzzy number and 0 w A ˜ 1 ) [25]. Based on the evidence, the Z-number is converted into a classic fuzzy number through the following steps:
Converting the second part ( B ˜ ) into a crisp number by applying the centered method:
α = a 1 + a 2 + a 3 3
Adding the weight of the second part ( B ˜ ) to the first part ( A ˜ ). The weighted Z-number is given as follows:
Z ˜ α = { x , μ A ˜ α ( x ) | μ A ˜ α ( x ) = α μ A ˜ ( x ) }
and it is presented as
Z ˜ α = ( a 1 , a 2 , a 3 ; α )
Converting the weighted Z-number into a regular fuzzy number. The regular fuzzy can be given as
Z ˜ = α A ˜ = ( α a 1 , α a 2 , α a 3 )

3.2. IMF D-SWARA Algorithm

IMF SWARA is more recent, and it has already been applied in various studies [26,27,28]. The SWARA method [29] in combination with D numbers [30] as already defined was applied to determine the weights of the criteria for the whole project of evaluation and selection of pavers for all road categories. The detailed IMF D-SWARA algorithm is shown in the paper [22], and the weights are shown further in the paper.

3.3. Fuzzy Bonferroni Mean (BM) Operator

Since it was a group decision making [31] in which four experts participated, it is necessary to determine the expert ratings after the transformation of Z numbers to obtain an initial fuzzy decision matrix. For this purpose, a fuzzy Bonferroni aggregator was used [32].
a ˜ i j = ( a i j l , a i j m , a i j u ) = { a i j l = ( 1 e ( e 1 ) i , j = 1 i j e a i l p a j l q ) 1 p + q a i j m = ( 1 e ( e 1 ) i , j = 1 i j e a i m p a j m q ) 1 p + q a i j u = ( 1 e ( e 1 ) i , j = 1 i j e a i u p a j u q ) 1 p + q
where e is the number of experts participating in the research, and p, q ≥ 0 are a set of non-negative numbers.

3.4. Fuzzy ARAS Method Based on Z Numbers

The ARAS method has undergone many modifications since its original form [33] until today [34,35] and has been applied in various fields.
In this section, the steps of the novel approach, which involves the integration of the Fuzzy ARAS method with Z numbers, are presented.
  • Define the required number of criteria and alternatives, followed by the formation of an MCDM model based on the performance of m alternatives evaluated on the basis of n criteria.
Ψ ˜ = [ ψ i 1 ˜ ˜ ψ i j ˜ ˜ ψ i n ˜ ψ m 1 ψ o 1 ˜ ˜ ˜ ˜ ψ m j ψ o j ˜ ˜ ˜ ˜ ψ m n ψ o n ˜ ˜ ]
Unlike most other methods, ARAS is extended with an additional alternative that implies the optimal value of the alternative according to a certain criterion depending on its orientation as defined in Equations (8) and (9).
ψ o j ˜ = max ψ i j ˜ i f j p r e f e r max i m u m
ψ o j ˜ = min ψ i j ˜ i f j p r e f e r min i m u m
2.
Performing the normalization procedure depending on a type of criteria.
The criteria that prefer maximum values are normalized as follows:
ς i j ˜ = ψ i j ˜ i = 1 o ψ i j ˜
The criteria that prefer minimum values are normalized as follows:
ς i j ˜ = 1 ψ i j ˜ i = 1 o 1 ψ i j ˜
3.
Multiplication of the normalized fuzzy Z matrix with previously calculated criterion weights wj.
γ i j ˜ = ς i j ˜ w j ˜
4.
Determining the optimality function:
O i ˜ = j = 1 n γ i j ˜
where Oi is the value of the function for i alternatives.
5.
The utility degree of alternatives is calculated by comparing the analyzed alternatives with the optimal one, which is denoted Oo.
A i ˜ = O i ˜ O o ˜
The calculated values of Ai should be arranged in descending order, thus obtaining the ranks of the alternatives.
In addition to the previously defined steps of the Fuzzy ARAS-Z method, a scale for evaluating alternatives, which is shown in Table 1, is defined.

4. Formulation of the MCDM Model

As stated in the introduction, there are several criteria based on which the road infrastructure in Serbia is classified. The administrative criterion divides roads into state and municipal roads depending on the road authority. According to the function they perform in a road network, the functional criterion divides roads into long-distance, connecting, feeder and access roads. According to the type of terrain on which roads are built, there are the following categories: mountainous, hilly, steep and plain. All the mentioned categories observe the roads in terms of one criterion. One criterion could be defined as common when observing most of these categorizations: the roadway width. Considering larger categories, it can be seen that there is a larger width of the roadway, and conversely, a smaller road category means a smaller width of the roadway. Due to these variations in the categories, for the purposes of this paper, and also in a previously published paper related to a similar topic but a different road category and a different methodology [22], the following width categories were adopted:
  • Category 1—asphalting width is up to 5 m.
  • Category 2—asphalting width is from 5 m to 10 m.
  • Category 3—asphalting width is over 10 m.
This paper presents the evaluation of paver performance for category 1 with the smallest width.

4.1. Description of the Problem

This section of the paper presents data on all alternatives that were considered during the selection of the most suitable paver. Data on ten alternatives of different types of manufacturers are presented. After the alternatives presented, an overview of the criteria based on which the evaluation was carried out was given. The criteria were established after reviewing the literature related to construction machinery as well as the catalogs of various paver manufacturers. After that, consultations with experts dealing with the production and installation of asphalt mixes were held. The experts in the field of asphalt mixtures, based on their experience and daily dealing with asphalt mixtures, provided guidelines used to adopt the final criteria. In the end, the authors of this paper decided to accept 16 criteria, which were then divided into four groups: speed criteria, which refer to the speed of the paver and the speed of asphalt mixture installation; technical and technological criteria, which refer to the capacities of the paver; dimension criteria, which refer to the dimensions of machines; and the adopted criteria include concepts related to economy, exploitation and environmental protection (EEE).

4.2. Definition of Alternatives

Data on pavers of three manufacturers were collected: Vögele, Caterpillar and Volvo. Data on alternatives are given in Table 2, and all data were obtained from paver vendors and catalogs.

4.3. Definition of Criteria

The set of criteria on the basis of which the evaluation of alternatives was carried out was defined taking into account the opinion and skills of experts and considering the following literature [36,37,38].
The criteria used to evaluate the pavers are
Group 1: Speed criteria with sub-criteria included: C1—Asphalting speed, C2—Transport speed, C3—Conveyor speed, C4—Drill speed.
Group 2: Technical and technological criteria: C5—Tank capacity, C6—Engine power, C7—Type (wheels/caterpillars), C8—Drill diameter.
Group 3: Criteria related to dimensions: C9—Asphalting width, C10—Asphalt installation thickness, C11—The dimensions of pavers, C12—The weight of pavers.
Group 4: Common criteria that includes sub-criteria related to environmental protection, exploitation and economy: C13—Fuel tank—capacity, C14—Theoretical performance, C15—Gas emissions, C16—The purchase price.

5. Intelligent MCDM Model Based on D and Z Numbers for Paver Selection

In this section of the paper, the calculation of the developed fuzzy MCDM model for paver selection using Z numbers is presented. The weighting coefficients obtained using the IMF D-SWARA method are as follows:
C 1 = ( 0.09 , 0.09 , 0.10 ) C 2 = ( 0.07 , 0.08 , 0.08 ) C 3 = ( 0.05 , 0.06 , 0.07 ) C 4 = ( 0.04 , 0.05 , 0.05 ) , C 5 =   ( 0.03 , 0.04 , 0.05 ) C 6 = ( 0.06 , 0.07 , 0.08 ) C 7 = ( 0.06 , 0.07 , 0.08 ) C 8 = ( 0.03 , 0.03 , 0.04 ) ,
C 9 = ( 0.09 , 0.10 , 0.10 ) C 10 = ( 0.07 , 0.07 , 0.08 ) C 11 = ( 0.06 , 0.06 , 0.07 ) C 12 = ( 0.04 , 0.05 , 0.06 ) , C 13 =   ( 0.04 , 0.05 , 0.06 ) C 14 = ( 0.06 , 0.07 , 0.07 ) C 15 = ( 0.03 , 0.04 , 0.04 ) C 16 = ( 0.07 , 0.07 , 0.08 )
In the next section of the paper, the new Fuzzy ARAS-Z method was applied in order to evaluate and rank 10 potential solutions previously defined. First, the evaluation of all alternatives is presented using the previously defined linguistic scale and using Z numbers. Table 3 shows the ratings of the pavers given by the first expert out of a total of four experts who participated in the group decision-making.
The next step involves converting Z numbers into TFN for each expert separately, and then applying the Fuzzy Bonferroni operator to obtain the initial fuzzy decision matrix. E.g., for A1, according to the first expert, an estimate with Z number A ˜ = (G) and B ˜ = VH has been given, which represents TFN (5, 7, 7) for A ˜ and (0.8, 1, 1) for B ˜ .
Then, α = 0.933 and by applying Equation (5), the converted TFN (4.86, 6.76, 6.76) is obtained as follows ( 0.933 × 5 , 0.933 × 7 , 0.933 × 7 ) .
The Fuzzy Bonferroni operator is applied as it is given in the example for the first alternative according to the first criterion, i.e., ψ 11 ˜ :
F u z z y B O p = 1 , q = 1 { ( 4.83 , 6.76 , 6.76 ) , ( 4.83 , 4.83 , 6.76 ) , ( 4.83 , 4.83 , 6.76 ) , ( 4.83 , 6.76 , 6.76 ) } = { ϖ C 1 ( 1 ) l = ( 1 4 ( 4 1 ) i , j = 1 i j 4 ϖ C 1 ( 1 ) i l p ϖ C 1 ( 1 ) j l q ) 1 1 + 1 = ( 0.083 ( 4.83 1 4.83 1 + 4.83 1 4.83 1 + + 4.83 1 4.83 1 ) ) 1 1 + 1 = 4.83 ϖ C 1 ( 1 ) m = ( 1 4 ( 4 1 ) i , j = 1 i j 4 ϖ C 1 ( 1 ) i m p ϖ C 1 ( 1 ) j m q ) 1 1 + 1 = ( 0.083 ( 6.76 1 4.83 1 + 6.76 1 4.83 1 + + 6.76 1 4.83 1 ) ) 1 1 + 1 = 5.77 ϖ C 1 ( 1 ) u = ( 1 4 ( 4 1 ) i , j = 1 i j 4 ϖ C 1 ( 1 ) i u p ϖ C 1 ( 1 ) j u q ) 1 1 + 1 = ( 0.083 ( 6.76 1 6.76 1 + 6.76 1 6.76 1 + . . + 6.76 1 6.76 1 ) ) 1 1 + 1 = 6.76
After the procedure has been completed, the initial decision matrix for the Fuzzy ARAS-Z method is obtained (Table 4).
After calculating the fuzzy initial decision matrix and defining the optimal alternative, the procedure of normalization was started. It is important to note that all criteria were modeled as beneficial, because the participants in the group decision-making assigned the highest marks to the best features using a previously defined scale. In this way, the transformation of cost into benefit criteria was performed, and only Equation (10) was applied in the normalization procedure. An example of the normalization procedure is as follows:
ς 11 ˜ = ( 4.83 81.85 , 5.77 76.31 , 6.76 62.03 ) = ( 0.06 , 0.08 , 0.11 ) , and the complete normalized fuzzy matrix is shown in Table 5.
In the next step, the fuzzy normalized matrix was weighted by applying Equation (12), the optimality function was determined by Equation (13), the utility degree of alternatives was defined by Equation (14), and the final results are shown in Table 6.
The values of Ai for the first alternative are obtained by applying Equation (14) as follows:
A 1 ˜ = O 1 ˜ O o ˜ = ( 0.06 0.15 , 0.09 0.11 , 0.13 0.07 ) = ( 0.38 , 0.80 , 1.80 )
The final results show that the alternative A8 has the best characteristics according to the considered set of criteria for the lower category of roads, and it is the paver SUPER 1300-3. The overall ranking of alternatives is A8 > A10 > A9 > A7 > A2 > A4 > A1 > A6 > A3 > A5.

6. Tests of Verification

6.1. Comparative Analysis

Decision-making is a specific form of activity [39] and many MCDM methods apply it to numerous decision problems from different disciplines [40,41]. In this part of the verification of the results obtained, a comparative analysis with four other fuzzy MCDM methods based on Z numbers was created. The Fuzzy MABAC-Z method [42,43], Fuzzy WASPAS-Z [44], Fuzzy MARCOS-Z [45,46] and Fuzzy SAW-Z method [45] were applied. The results of this analysis are shown in Figure 2, both in terms of ranks and in terms of the value of pavers.
The results of the first verification test show that the proposed model is completely stable, because there is no difference in the ranks of the alternatives. It is an interesting fact that in all methods except Fuzzy MARCOS-Z there is a slight difference in the values of all alternatives, but there are no changes in the ranks.

6.2. The Influence of Changing the Size of the Initial Fuzzy Decision Matrix

In the second verification test, the influence of the size of the initial fuzzy decision matrix on the final results was determined, i.e., the dynamic influence of the decision matrix was tested. A total of nine sets was formed, which implies that the alternative with the worst performance is eliminated from the IMF D-SWARA-Fuzzy ARAS-Z model. The procedure is repeated until the initial matrix is reduced to one alternative. The results of the dynamic influence of the initial matrix are shown in Figure 3 along with the ranks and values of the pavers.
After changing the size of the initial decision matrix in the Fuzzy ARAS-Z model, it can be seen that the model is still stable and that the alternatives retain their positions from the original model. The only difference occurs in the first set when alternative A5 is eliminated, with alternatives A1 and A4 rotating their positions (seven and six). However, in the following scenario, when alternative A3 is also eliminated, they return to their original positions, which is, in a way, very difficult to explain. Mainly, in this verification test which includes different normalization procedures, additional stability of the developed model was also demonstrated.

6.3. Impact of Changing the Normalization Procedure

In this section of the paper, the reproduction of the Fuzzy ARAS model based on Z numbers was performed with a change in the normalization procedure that can be found in the paper [47]. In the first case, using Equation (15), the linear normalization used in the fuzzy MARCOS method was defined [48,49]; in the second case, using Equation (16), the maximum linear normalization was defined [49]. The third scenario implies the minimum linear normalization [49] represented by Equation (17), while the fourth scenario is the nonlinear normalization procedure [50] represented by Equation (18).
n ˜ i j = ( n i j l , n i j m , n i j u ) = ( x i j l x i d u , x i j m x i d u , x i j u x i d u ) i f j B
n ˜ i j = ( n i j l , n i j m , n i j u ) = ( x i j l max x u , x i j m max x m , x i j u max x l ) i f j B
n ˜ i j = ( n i j l , n i j m , n i j u ) = ( ( x i j l max x u ) 2 , ( x i j m max x m ) 2 , ( x i j u max x l ) 2 ) i f j B
n ˜ i j = ( n i j l , n i j m , n i j u ) = 1 ( min x i j l x i j u , min x i j m x i j m , min x i j u x i j l ) i f j B

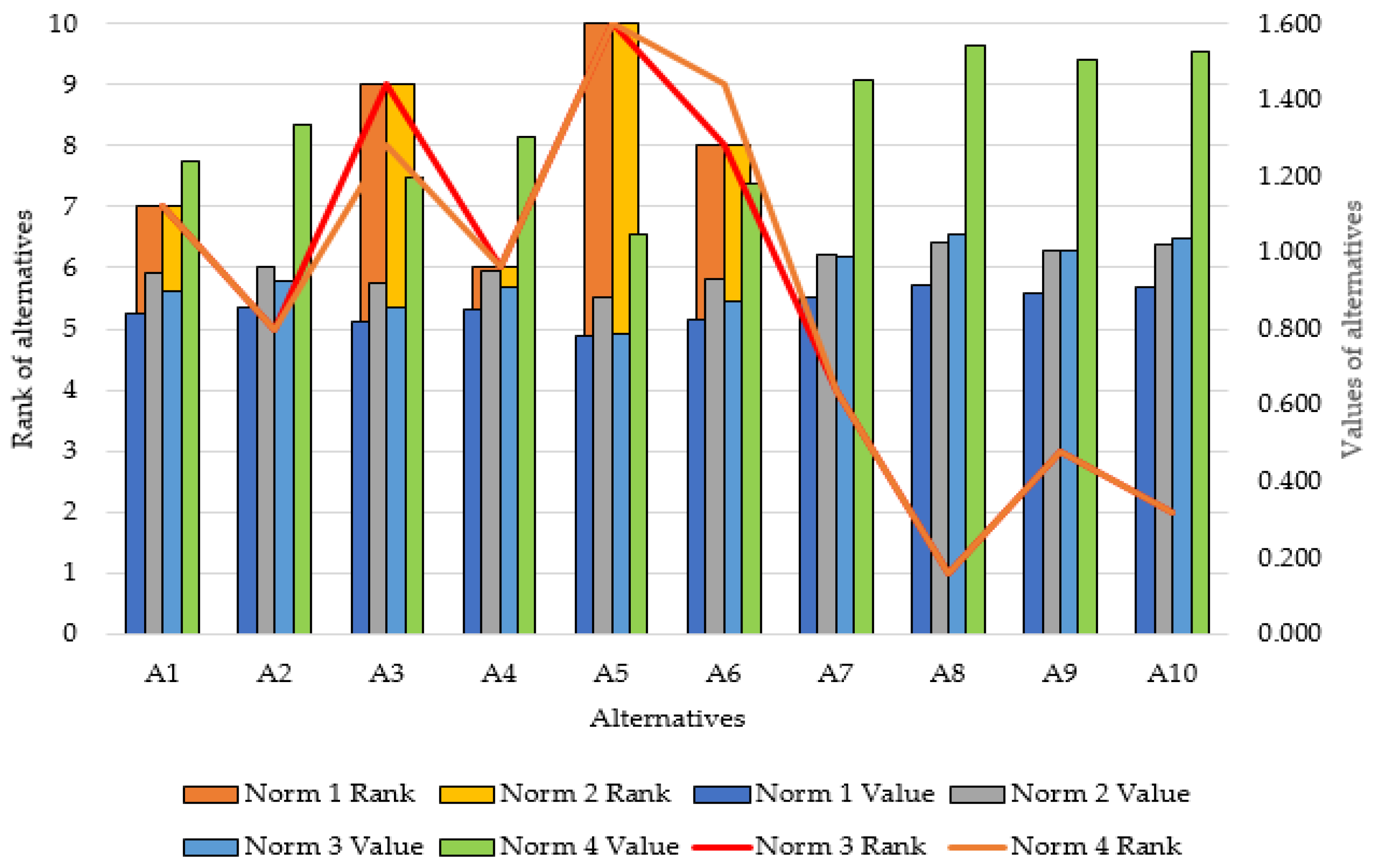

The results of this analysis are presented in Figure 4.
After applying different normalization procedures in the Fuzzy ARAS-Z model, it can be seen that the model is still stable and that the alternatives keep their positions from the original model. The only difference occurs in the procedure of applying nonlinear normalization, whereby alternatives A3 and A6 rotate their positions (nine and eight). Mainly, in this verification test which includes different normalization procedures, additional stability of the developed model has also been demonstrated.

7. Conclusions

In order to adequately use road infrastructure and enable the efficiency of road capacity [51], it is necessary to pay attention to construction materials and the quality of construction machinery. It is one of these segments that is the subject of the research and selection of adequate mechanization for infrastructure construction for roads with an asphalt width of up to five meters, which represents a lower category of roads. As part of the research, data for 10 different pavers representing potential solutions were collected and evaluated based on 16 criteria. In order to enable precision in the application of the intelligent Fuzzy MCDM model, a hierarchical structure with an equal number of elements on the second level was created. Due to this and the application of the strong IMF D-SWARA model, the precise weights of the criteria have been calculated, eliminating the possibility that one of the criteria has an unjustifiably high value, which is the case in other studies that apply an unbalanced hierarchical structure.
The most important contribution of the research from the methodological and scientific aspect involves the development of a novel original Fuzzy ARAS-Z model that has been used for the evaluation and selection of pavers. In this way, the emphasis is put on the novelty of the study, while the professional contribution is reflected in the selection of adequate construction machinery, i.e., pavers.
The results show the following ranking of the alternatives: A8 > A10 > A9 > A7 > A2 > A4 > A1 > A6 > A3 > A5. In order to verify the results obtained, three validity tests were applied which, with negligible deviations, showed an extremely high level of stability of the original IMF D-SWARA-Fuzzy ARAS-Z model.
Considering that this is a multistage project, future research should be directed towards the selection of pavers for highways in order to complete the project of evaluation and selection of adequate mechanization depending on the categories of roads in Serbia. In addition, more decision-makers can be included to access the conditions of the evaluation model and their performances. The same model can be applied in any other equipment decision-making approach in order to ensure the sustainability of construction road infrastructure. In addition, the direction of further research can be reflected through the development of new similar models and applications in civil engineering as integration of fuzzy rough theories.

Author Contributions

Conceptualization, S.J. and M.M.; methodology, E.K.Z. and Ž.S.; validation, A.F.A. and I.B.; formal analysis, S.J.; investigation, S.J. and M.M.; data curation, S.J. and M.M.; writing—original draft preparation, M.M. and Ž.S.; writing—review and editing, I.B., E.K.Z. and A.F.A.; supervision, E.K.Z. All authors have read and agreed to the published version of the manuscript.

Funding

The authors extend appreciation to King Saud University for support to this work through Researchers supporting project number (RSP2023R323), King Saud University, Riyadh, Saudi Arabia.

Data Availability Statement

The data presented in this study are available in the paper.

Conflicts of Interest

The authors declare no conflict of interest.

References

  1. Gerland, P.; Raftery, A.E.; Ševčíková, H.; Li, N.; Gu, D.; Spoorenberg, T.; Alkema, L.; Fosdick, B.K.; Chunn, J.; Lalic, N.; et al. World population stabilization unlikely this century. Science 2014, 346, 234–237. [Google Scholar] [CrossRef] [PubMed] [Green Version]
  2. Afanasyev, A.S.; Egoshin, A.M.; Alekseev, S.V. The choice substantiation method of road construction equipment for mining enterprises. J. Phys. Conf. Ser. 2019, 1399, 033021. [Google Scholar] [CrossRef] [Green Version]
  3. Atnaw, S.M.; Singh, L.; Hagos, F.Y.; Yousuf, A. Road Construction Equipment Management: A Case Study on Selected Industry. Int. J. Eng. Technol. Sci. 2016, 3, 91–97. [Google Scholar] [CrossRef]
  4. Bryan, J.; Hill, S.; Munday, M.; Roberts, A. Road infrastructure and economic development in the periphery: The case of A55 improvements in North Wales. J. Transp. Geogr. 1997, 5, 227–237. [Google Scholar] [CrossRef]
  5. Elmansouri, O.; Alossta, A.; Badi, I. Pavement Condition Assessment Using Pavement Condition Index and Multi-Criteria Decision-Making Model. Mechatron. Intell. Transp. Syst. 2022, 1, 57–68. [Google Scholar] [CrossRef]
  6. Gibbons, S.; Lyytikäinen, T.; Overman, H.G.; Sanchis-Guarner, R. New road infrastructure: The effects on firms. J. Urban Econ. 2019, 110, 35–50. [Google Scholar] [CrossRef]
  7. Tihonov, A.; Velichkin, V. Paver automation for road surfacing. IOP Conf. Ser. Earth Environ. Sci. 2017, 90, 012148. [Google Scholar] [CrossRef] [Green Version]
  8. Mohandes, S.R.; Sadeghi, H.; Mahdiyar, A.; Durdyev, S.; Banaitis, A.; Yahya, K.; Ismail, S. Assessing construction labours’ safety level: A fuzzy mcdm approach. J. Civ. Eng. Manag. 2020, 26, 175–188. [Google Scholar] [CrossRef] [Green Version]
  9. Duckstein, L.; Ashkar, F. A multiple criteria decision modelling approach to selection of estimation techniques for fitting extreme floods. Stoch. Hydrol. Hydraul. 1991, 5, 227–238. [Google Scholar] [CrossRef]
  10. Temiz, I.; Calis, G. Selection of Construction Equipment by Using Multi-Criteria Decision Making Methods. In Proceedings of the Creative Construction Conference 2017, CCC 2017, Primosten, Croatia, 19–22 June 2017. [Google Scholar]
  11. Ivanović, B.; Saha, A.; Stević, Ž.; Puška, A.; Zavadskas, E.K. Selection of truck mixer concrete pump using novel MEREC DNMARCOS model. Arch. Civ. Mech. Eng. 2022, 22, 173. [Google Scholar] [CrossRef]
  12. Keshavarz Ghorabaee, M.; Amiri, M.; Zavadskas, E.K.; Antucheviciene, J. A new hybrid fuzzy MCDM approach for evaluation of construction equipment with sustainability considerations. Arch. Civ. Mech. Eng. 2018, 18, 32–49. [Google Scholar] [CrossRef]
  13. Phogat, M.V.S.; Singh, A.P. Selection of Equipment for Construction of a Hilly Road Using Multi Criteria Approach. Procedia-Soc. Behav. Sci. 2013, 104, 282–291. [Google Scholar] [CrossRef] [Green Version]
  14. Karleuša, B.; Dragičević, N.; Deluka-Tibljaš, A. Review of multicriteria-analysis methods application in decision making about transport infrastructure. J. Croat. Assoc. Civ. Eng. 2013, 65, 619–631. [Google Scholar] [CrossRef]
  15. Jato-Espino, D.; Castillo-Lopez, E.; Rodriguez-Hernandez, J.; Canteras-Jordana, J.C. A review of application of multi-criteria decision making methods in construction. Autom. Constr. 2014, 45, 151–162. [Google Scholar] [CrossRef]
  16. Çalişkan, E.; Bediroglu, Ş.; Yildirim, V. Determination Forest Road Routes via Gis-based Spatial Multi-Criterion Decision Methods. Appl. Ecol. Environ. Res. 2019, 17, 759–779. [Google Scholar] [CrossRef]
  17. Vilke, S.; Krpan, L.; Milković, M. Application of the Multi-Criteria Analysis in the Process of Road Route Evaluation. Teh. Vjesn. 2018, 25, 1851–1859. [Google Scholar] [CrossRef]
  18. Sekulić, M.; Marinković, M.; Ivković, I. Spatial Multi-Criteria Evaluation Method for Planning of Optimal Roads Alignments, with Emphasize on Robustness Analysis. Int. J. Traffic Transp. Eng. 2021, 11, 424–441. [Google Scholar] [CrossRef]
  19. Straka, M.; Balog, M.; Trebuna, P. Multi-Criteria Decision Marking for the Needs of Layout of Haulage Parks. Asian J. Eng. Technol. 2015, 3, 55–64. [Google Scholar]
  20. Marzouk, M.; Abdelakder, E.M. On the use of multi-criteria decision making methods for minimizing environmental emissions in construction projects. Decis. Sci. Lett. 2019, 8, 373–392. [Google Scholar] [CrossRef]
  21. Marcelino, P.; de Lurdes Antunes, M.; Fortunato, E.; Gomes, M.C. Development of a Multi Criteria Decision Analysis Model for Pavement Maintenance at the Network Level: Application of the MACBETH Approach. Front. Built Environ. 2019, 5, 6. [Google Scholar] [CrossRef] [Green Version]
  22. Matić, B.; Marinković, M.; Jovanović, S.; Sremac, S.; Stević, Ž. Intelligent Novel IMF D-SWARA—Rough MARCOS Algorithm for Selection Construction Machinery for Sustainable Construction of Road Infrastructure. Buildings 2022, 12, 1059. [Google Scholar] [CrossRef]
  23. Zadeh, L.A. A note on Z-number. Inf. Sci. 2011, 181, 2923–2932. [Google Scholar] [CrossRef]
  24. Kang, B.; Wei, D.; Li, Y.; Deng, Y. Decision Making Using Z-numbers under Uncertain Environment. J. Comput. Inf. Syst. 2012, 8, 2807–2814. [Google Scholar]
  25. Božanić, D.; Jurišić, D.; Erkić, D. LBWA–Z-MAIRCA model supporting decision making in the army. Oper. Res. Eng. Sci. Theory Appl. 2020, 3, 87–110. [Google Scholar] [CrossRef]
  26. Zolfani, S.H.; Görçün, Ö.F.; Küçükönder, H. Evaluating logistics villages in Turkey using hybrid improved fuzzy SWARA (IMF SWARA) and fuzzy MABAC techniques. Technol. Econ. Dev. Econ. 2021, 27, 1582–1612. [Google Scholar] [CrossRef]
  27. Vojinović, N.; Sremac, S.; Zlatanović, D. A Novel Integrated Fuzzy-Rough MCDM Model for Evaluation of Companies for Transport of Dangerous Goods. Complexity 2021, 2021, 5141611. [Google Scholar] [CrossRef]
  28. Zolfani, S.H.; Görener, A.; Toker, K. A hybrid fuzzy MCDM approach for prioritizing the solutions of resource re-covery business model adoption to overcome its barriers in emerging economies. J. Clean. Prod. 2023, 413, 137362. [Google Scholar] [CrossRef]
  29. Sivageerthi, T.; Bathrinath, S.; Uthayakumar, M.; Bhalaji, R. A SWARA method to analyze the risks in coal supply chain management. Mater. Today Proc. 2021, 50, 935–940. [Google Scholar] [CrossRef]
  30. Xiong, L.; Su, X.; Qian, H. Supplier Selection Model Based on D Numbers and Transformation Function. Int. J. Comput. Commun. Control 2022, 17, 1–20. [Google Scholar] [CrossRef]
  31. Ashraf, A.; Ullah, K.; Hussain, A.; Bari, M. Interval-Valued Picture Fuzzy Maclaurin Symmetric Mean Operator with Application in Multiple Attribute Decision-Making. Rep. Mech. Eng. 2022, 3, 301–317. [Google Scholar] [CrossRef]
  32. Pamučar, D.; Deveci, M.; Canıtez, F.; Bozanic, D. A fuzzy Full Consistency Method-Dombi-Bonferroni Model for Prioritizing Transportation Demand Management Measures. Appl. Soft Comput. 2020, 87, 105952. [Google Scholar] [CrossRef]
  33. Zavadskas, E.K.; Turskis, Z. A new additive ratio assessment (ARAS) method in multicriteria decision-making. Technol. Econ. Dev. Econ. 2010, 16, 159–172. [Google Scholar] [CrossRef]
  34. Karagöz, S.; Deveci, M.; Simic, V.; Aydin, N. Interval type-2 Fuzzy ARAS method for recycling facility location problems. Appl. Soft Comput. 2021, 102, 107107. [Google Scholar] [CrossRef]
  35. Jovčić, S.; Simić, V.; Průša, P.; Dobrodolac, M. Picture Fuzzy ARAS Method for Freight Distribution Concept Selection. Symmetry 2020, 12, 1062. [Google Scholar] [CrossRef]
  36. Fischer, A.; Schug, R. Vögele Booklet on Paving; Joseph Vögele AG: Ludwigshafen, Germany, 2012. [Google Scholar]
  37. Arbeider, C.G.; Miller, S.R.; Doree, A.G.; Oosterveld, M. Planning the asphalt construction process—Towards more consistent paving and compaction operations. In Proceedings of the 17th AAPA International Flexible Pavements Conference 2017, Melbourne, Australia, 13–16 August 2017. [Google Scholar]
  38. Ma, F.; Sha, A.; Lin, R.; Huang, Y.; Wang, C. Greenhouse Gas Emissions from Asphalt Pavement Construction: A Case Study in China. Int. J. Environ. Res. Public Health 2016, 13, 351. [Google Scholar] [CrossRef]
  39. Filip, F.G. Collaborative Decision-Making: Concepts and Supporting Information and Communication Technology Tools and Systems. Int. J. Comput. Commun. Control 2022, 17, 4732. [Google Scholar] [CrossRef]
  40. Petrovas, A.; Baušys, R.; Zavadskas, E.K.; Smarandache, F. Generation of creative game scene patterns by the neu-trosophic genetic CoCoSo method. Stud. Inform. Control 2022, 31, 5–11. [Google Scholar] [CrossRef]
  41. Tešić, D.; Božanić, D.; Puška, A.; Milić, A.; Marinković, D. Development of the MCDM fuzzy LMAW-grey MARCOS model for selection of a dump truck. Rep. Mech. Eng. 2023, 4, 1–17. [Google Scholar] [CrossRef]
  42. Božanić, D.; Tešić, D.; Milić, A. Multicriteria Decision Making Model with Z-Numbers Based on FUCOM and MABAC Model. Decis. Mak. Appl. Manag. Eng. 2020, 3, 19–36. [Google Scholar] [CrossRef]
  43. Puška, A.; Stojanović, I. Fuzzy Multi-Criteria Analyses on Green Supplier Selection in an Agri-Food Company. J. Intell. Manag. Decis. 2022, 1, 2–16. [Google Scholar] [CrossRef]
  44. Akbari, R.; Dabbagh, R.; Ghoushchi, S.J. HSE risk prioritization of molybdenum operation process using extended FMEA approach based on Fuzzy BWM and Z-WASPAS. J. Intell. Fuzzy Syst. 2020, 38, 5157–5173. [Google Scholar] [CrossRef]
  45. Büyüközkan, G.; Havle, C.A.; Feyzioğlu, O. An integrated SWOT based fuzzy AHP and fuzzy MARCOS methodology for digital transformation strategy analysis in airline industry. J. Air Transp. Manag. 2021, 97, 102142. [Google Scholar] [CrossRef]
  46. Kumar, R.; Goel, P.; Zavadskas, E.K.; Stević, Ž.; Vujović, V. A New Joint Strategy for Multi-Criteria Decision-Making: A Case Study for Prioritizing Solid-State Drive. Int. J. Comput. Commun. Control 2022, 17, 5010. [Google Scholar] [CrossRef]
  47. Aytekin, A. Comparative Analysis of the Normalization Techniques in the Context of MCDM Problems. Decis. Mak. Appl. Manag. Eng. 2021, 4, 1–25. [Google Scholar] [CrossRef]
  48. Bakır, M.; Akan, Ş.; Özdemir, E. Regional aircraft selection with fuzzy piprecia and fuzzy marcos: A case study of the Turkish airline industry. Facta Univ. Ser. Mech. Eng. 2021, 19, 423–445. [Google Scholar] [CrossRef]
  49. Jahan, A.; Edwards, K.L. A state-of-the-art survey on the influence of normalization techniques in ranking: Improving the materials selection process in engineering design. Mater. Des. 2015, 65, 335–342. [Google Scholar] [CrossRef]
  50. Mukhametzyanov, I. On the conformity of scales of multidimensional normalization: An application for the problems of decision making. Decis. Mak. Appl. Manag. Eng. 2023, 6, 399–431. [Google Scholar] [CrossRef]
  51. Subotić, M.; Softić, E.; Radičević, V.; Bonić, A. Modeling of Operating Speeds as a Function of Longitudinal Gradient in Local Conditions on Two-Lane Roads. Mechatron. Intell. Transp. Syst. 2022, 1, 24–34. [Google Scholar] [CrossRef]
Figure 1. Z-number [24].
Figure 1. Z-number [24].
Axioms 12 00573 g001

Figure 2. Results of comparative analysis.
Figure 2. Results of comparative analysis.
Axioms 12 00573 g002

Figure 3. Results of the impact of the initial matrix size.
Figure 3. Results of the impact of the initial matrix size.
Axioms 12 00573 g003
Figure 4. The influence of the normalization procedure on the results.
Figure 4. The influence of the normalization procedure on the results.
Axioms 12 00573 g004
Table 1. Scale for evaluating using a Fuzzy ARAS-Z method.
Table 1. Scale for evaluating using a Fuzzy ARAS-Z method.
Linguistic VariableTFN ALinguistic VariableTFN B
Extremely poor—EP(1, 1, 1)Very small (VS)(0, 0, 0.2)
Very poor—VP(1, 1, 3)Small (S)(0.1, 0.25, 0.4)
Poor—P(1, 3, 3)Medium (M)(0.3, 0.5, 0.7)
Medium poor—MP(3, 3, 5)High (H)(0.55, 0.75, 0.95)
Medium—M(3, 5, 5)Very high (VH)(0.8, 1, 1)
Medium good—MG(5, 5, 7)
Good—G(5, 7, 7)
Very good—VG(7, 7, 9)
Extremely good—EG(7, 9, 9)
Table 2. Description of alternatives.
Table 2. Description of alternatives.
C1C2C3C4C5C6C7C8
A1—Volvo P2820D ABG204.517.972955.4caterpillars300
A2—P2870D ABG201617.972955.4wheels300
A3—AP355F25112080955caterpillars260
A4—AP300F30162080955wheels260
A5—SUPER 1000184.521851055caterpillars300
A6—SUPER 1003182022851055wheels300
A7—SUPER 1300304.525801074.4caterpillars300
A8—SUPER 1300-3304.529851074.4caterpillars300
A9—SUPER 1303302025801074.4wheels300
A10—SUPER 1303-3302029.4851074.4wheels300
C9C10C11C12C13C14C15C16
A1—Volvo P2820D ABG4.5Up to 205300/3240/39958155250330 with one conveyor; 230- with two conveyorsEU Stage V148,000
A2—P2870D ABG4.5to 255320/3240/39957635110330 with one conveyor; 230- with two conveyorsEU Stage V152,000
A3—AP355F4.6to 205047/3180/34157300110406EU Stage IIIB, U.S. EPA Tier 4 Final,255,000
A4—AP300F4to 304870/3180/33406600110406EU Stage IIIB, US EPA Tier 4 Final230,000
A5—SUPER 10003.9to 154950/3350/351510,250110270EU Stage IIIa, US EPA Tier 3165,000
A6—SUPER 10033.9to 154950/3265/351510,000105230EU Stage IIIa, US EPA Tier 3165,000
A7—SUPER 13005to 254950/3350/350010,600105350EU Stage IIIa, US EPA Tier 3180,000
A8—SUPER 1300-35to 254950/3350/350011,400110350EU Stage IIIa, US EPA Tier 3180,000
A9—SUPER 13034.5to 254950/3265/350010,200110250EU Stage IIIa, US EPA Tier 3185,000
A10 -SUPER 1303-34.5to 254950/3265/350011,100100250EU Stage IIIa, US EPA Tier 3185,000
Table 3. Evaluation of pavers for lower road categories using Z numbers by E1.
Table 3. Evaluation of pavers for lower road categories using Z numbers by E1.
E1 A ˜ B ˜ A ˜ B ˜ A ˜ B ˜ A ˜ B ˜ A ˜ B ˜ A ˜ B ˜ A ˜ B ˜ A ˜ B ˜
C1C2C3C4C5C6C7C8
A1GVHMVHMGHGVHVGHGHGVHVGH
A2GVHVGHMGHGVHVGHGHVGVHVGH
A3VGHGVHMGVHVGVHVGHGHGVHGH
A4EGHVGHMGVHVGVHVGHGHVGVHGH
A5GHMVHGHEGVHVGVHGHGVHVGH
A6GHEGHGVHEGVHVGVHVGVHVGVHVGH
A7EGHMVHVGHVGVHVGVHVGVHGVHVGH
A8EGHMVHEGHEGVHVGVHVGVHGVHVGH
A9EGHEGHVGHVGVHVGVHVGVHVGVHVGH
A10EGHEGHEGVHEGVHVGVHVGVHVGVHVGH
A ˜ B ˜ A ˜ B ˜ A ˜ B ˜ A ˜ B ˜ A ˜ B ˜ A ˜ B ˜ A ˜ B ˜ A ˜ B ˜
E1C9C10C11C12C13C14C15C16
A1VGHVGHVGVHGVHEGVHVGHEGVHEGVH
A2VGHVGVHVGVHGHGVHVGHEGVHEGH
A3VGVHVGHVGHGHGVHEGVHVGVHMPH
A4GVHEGVHGHMVHGVHEGVHVGVHMH
A5GHGVHGVHVGHGVHGVHVGHGVH
A6GHGVHGVHVGMGHGMVGHGVH
A7EGVHVGVHGVHVGVHGHVGVHVGHGH
A8EGVHVGVHGVHEGVHGVHVGVHVGHGH
A9VGHVGVHGVHVGHGVHGHVGHGM
A10VGHVGVHGVHEGHGMGHVGHGM
Table 4. Initial fuzzy ARAS-Z matrix.
Table 4. Initial fuzzy ARAS-Z matrix.
C1C2C3C4C5C6C7C8
A1(4.83, 5.77, 6.76)(4.83, 5.77, 6.76)(4.45, 4.87, 6.23)(4.73, 6.12, 6.49)(5.17, 6.06, 6.91)(4.9, 5.78, 6.56)(4.7, 6.09, 6.59)(5.75, 6.23, 7.53)
A2(4.83, 5.77, 6.76)(4.83, 5.77, 6.76)(4.45, 4.87, 6.23)(4.73, 6.12, 6.49)(5.17, 6.06, 6.91)(4.9, 5.78, 6.56)(6.09, 6.59, 7.97)(5.75, 6.23, 7.53)
A3(5.78, 6.14, 7.43)(5.78, 6.14, 7.43)(4.83, 5.77, 6.76)(6.76, 6.76, 8.69)(5.17, 6.06, 6.91)(4.9, 5.78, 6.56)(4.7, 6.09, 6.59)(4.45, 5.3, 6.23)
A4(6.23, 7.53, 8.02)(6.23, 7.53, 8.02)(4.83, 5.77, 6.76)(6.76, 6.76, 8.69)(5.17, 6.06, 6.91)(4.9, 5.78, 6.56)(6.09, 6.59, 7.97)(4.45, 5.3, 6.23)
A5(4.33, 5.17, 6.06)(4.33, 5.17, 6.06)(5.17, 6.06, 6.91)(6.59, 7.97, 8.47)(5.77, 6.76, 7.71)(4.9, 5.78, 6.56)(4.7, 6.09, 6.59)(5.75, 6.23, 7.53)
A6(4.33, 5.17, 6.06)(4.33, 5.17, 6.06)(5.77, 6.76, 7.71)(6.41, 8.24, 8.24)(5.77, 6.76, 7.71)(6.59, 7.49, 8.47)(6.09, 6.59, 7.97)(5.75, 6.23, 7.53)
A7(6.06, 7.79, 7.79)(6.06, 7.79, 7.79)(6.06, 6.91, 7.79)(6.41, 6.41, 8.24)(5.77, 6.76, 7.71)(6.59, 7.49, 8.47)(4.7, 6.09, 6.59)(5.75, 6.23, 7.53)
A8(6.41, 8.24, 8.24)(6.41, 8.24, 8.24)(6.41, 8.24, 8.24)(6.41, 8.24, 8.24)(5.77, 6.76, 7.71)(6.59, 7.49, 8.47)(4.7, 6.09, 6.59)(5.75, 6.23, 7.53)
A9(6.41, 8.24, 8.24)(6.41, 8.24, 8.24)(6.06, 6.91, 7.79)(6.76, 6.76, 8.69)(5.77, 6.76, 7.71)(6.59, 7.49, 8.47)(6.09, 6.59, 7.97)(5.75, 6.23, 7.53)
A10(6.41, 8.24, 8.24)(6.41, 8.24, 8.24)(6.76, 8.69, 8.69)(6.41, 8.24, 8.24)(5.77, 6.76, 7.71)(6.59, 7.49, 8.47)(6.09, 6.59, 7.97)(5.75, 6.23, 7.53)
Ao(6.41, 8.24, 8.24)(6.06, 7.35, 7.79)(6.76, 8.69, 8.69)(6.76, 8.24, 8.69)(5.77, 6.76, 7.71)(6.59, 7.49, 8.47)(6.09, 6.59, 7.97)(5.75, 6.23, 7.53)
C9C10C11C12C13C14C15C16
A1(5.12, 5.5, 6.69)(6.23, 7.12, 8.02)(6.12, 6.49, 7.87)(4.83, 6.76, 6.76)(6.76, 7.71, 8.69)(5.33, 5.78, 6.99)(6.76, 8.69, 8.69)(6.76, 8.69, 8.69)
A2(5.12, 5.5, 6.69)(6.59, 7.49, 8.47)(6.12, 6.49, 7.87)(4.45, 5.75, 6.23)(4.7, 6.09, 6.59)(5.33, 5.78, 6.99)(6.76, 8.69, 8.69)(6.76, 8.69, 8.69)
A3(5.95, 6.41, 7.79)(6.23, 7.12, 8.02)(5.5, 5.5, 7.07)(4.45, 5.75, 6.23)(4.83, 5.77, 6.76)(6.41, 8.24, 8.24)(6.59, 7.02, 8.47)(2.9, 2.9, 4.83)
A4(4.58, 5.95, 6.41)(6.59, 8.47, 8.47)(4.13, 5.33, 5.78)(3.82, 4.83, 5.77)(4.7, 6.09, 6.59)(6.41, 6.84, 8.24)(6.59, 7.02, 8.47)(2.9, 4.83, 4.83)
A5(3.93, 5.12, 5.5)(4.7, 6.59, 6.59)(4.58, 6.41, 6.41)(6.06, 6.06, 7.79)(4.83, 5.77, 6.76)(4.7, 6.09, 6.59)(6.06, 6.06, 7.79)(4.33, 5.17, 6.06)
A6(3.93, 5.12, 5.5)(4.7, 6.59, 6.59)(4.58, 6.41, 6.41)(4.95, 4.95, 6.36)(4.13, 5.33, 5.78)(3.27, 4.57, 4.57)(6.06, 6.06, 7.79)(4.33, 5.17, 6.06)
A7(6.41, 7.79, 8.24)(6.59, 7.49, 8.47)(4.58, 6.41, 6.41)(6.76, 6.76, 8.69)(4.33, 5.17, 6.06)(6.09, 6.59, 7.97)(6.06, 6.06, 7.79)(4.33, 5.17, 6.06)
A8(6.41, 7.79, 8.24)(6.59, 7.49, 8.47)(4.58, 6.41, 6.41)(6.76, 8.69, 8.69)(4.7, 6.09, 6.59)(6.09, 6.59, 7.97)(6.06, 6.06, 7.79)(4.33, 5.17, 6.06)
A9(5.12, 5.5, 6.69)(6.59, 7.49, 8.47)(4.58, 6.41, 6.41)(5.78, 6.14, 7.43)(4.83, 5.77, 6.76)(3.93, 5.5, 5.5)(6.06, 6.06, 7.79)(4.33, 5.17, 6.06)
A10(5.12, 5.5, 6.69)(6.59, 7.49, 8.47)(4.58, 6.41, 6.41)(6.06, 7.79, 7.79)(3.93, 4.64, 5.5)(3.93, 5.5, 5.5)(6.06, 6.06, 7.79)(4.33, 5.17, 6.06)
Ao(6.41, 7.79, 8.24)(6.59, 8.47, 8.47)(6.12, 6.49, 7.87)(6.76, 8.69, 8.69)(6.76, 7.71, 8.69)(6.41, 8.24, 8.24)(6.76, 8.69, 8.69)(6.76, 8.69, 8.69)
Table 5. Normalized matrix in the Fuzzy ARAS-Z method.
Table 5. Normalized matrix in the Fuzzy ARAS-Z method.
C1C2C3C4
A1(0.06, 0.08, 0.11)(0.04, 0.06, 0.1)(0.05, 0.07, 0.1)(0.05, 0.08, 0.09)
A2(0.06, 0.08, 0.11)(0.07, 0.09, 0.14)(0.05, 0.07, 0.1)(0.05, 0.08, 0.09)
A3(0.07, 0.08, 0.12)(0.05, 0.08, 0.11)(0.06, 0.08, 0.11)(0.08, 0.08, 0.13)
A4(0.08, 0.1, 0.13)(0.08, 0.1, 0.15)(0.06, 0.08, 0.11)(0.08, 0.08, 0.13)
A5(0.05, 0.07, 0.1)(0.04, 0.06, 0.1)(0.06, 0.08, 0.11)(0.07, 0.1, 0.12)
A6(0.05, 0.07, 0.1)(0.09, 0.12, 0.15)(0.07, 0.09, 0.13)(0.07, 0.1, 0.12)
A7(0.07, 0.1, 0.13)(0.04, 0.06, 0.1)(0.07, 0.09, 0.13)(0.07, 0.08, 0.12)
A8(0.08, 0.11, 0.13)(0.04, 0.06, 0.1)(0.08, 0.11, 0.13)(0.07, 0.1, 0.12)
A9(0.08, 0.11, 0.13)(0.09, 0.12, 0.15)(0.07, 0.09, 0.13)(0.08, 0.08, 0.13)
A10(0.08, 0.11, 0.13)(0.09, 0.12, 0.15)(0.08, 0.12, 0.14)(0.07, 0.1, 0.12)
Ao(0.08, 0.11, 0.13)(0.09, 0.12, 0.15)(0.08, 0.12, 0.14)(0.08, 0.1, 0.13)
C5C6C7C8
A1(0.06, 0.08, 0.11)(0.06, 0.08, 0.1)(0.06, 0.09, 0.11)(0.07, 0.09, 0.12)
A2(0.06, 0.08, 0.11)(0.06, 0.08, 0.1)(0.08, 0.09, 0.13)(0.07, 0.09, 0.12)
A3(0.06, 0.08, 0.11)(0.06, 0.08, 0.1)(0.06, 0.09, 0.11)(0.06, 0.08, 0.1)
A4(0.06, 0.08, 0.11)(0.06, 0.08, 0.1)(0.08, 0.09, 0.13)(0.06, 0.08, 0.1)
A5(0.07, 0.09, 0.13)(0.06, 0.08, 0.1)(0.06, 0.09, 0.11)(0.07, 0.09, 0.12)
A6(0.07, 0.09, 0.13)(0.08, 0.1, 0.13)(0.08, 0.09, 0.13)(0.07, 0.09, 0.12)
A7(0.07, 0.09, 0.13)(0.08, 0.1, 0.13)(0.06, 0.09, 0.11)(0.07, 0.09, 0.12)
A8(0.07, 0.09, 0.13)(0.08, 0.1, 0.13)(0.06, 0.09, 0.11)(0.07, 0.09, 0.12)
A9(0.07, 0.09, 0.13)(0.08, 0.1, 0.13)(0.08, 0.09, 0.13)(0.07, 0.09, 0.12)
A10(0.07, 0.09, 0.13)(0.08, 0.1, 0.13)(0.08, 0.09, 0.13)(0.07, 0.09, 0.12)
Ao(0.07, 0.09, 0.13)(0.08, 0.1, 0.13)(0.08, 0.09, 0.13)(0.07, 0.09, 0.12)
C9C10C11C12
A1(0.07, 0.08, 0.12)(0.07, 0.09, 0.12)(0.08, 0.09, 0.14)(0.06, 0.09, 0.11)
A2(0.07, 0.08, 0.12)(0.07, 0.09, 0.12)(0.08, 0.09, 0.14)(0.06, 0.08, 0.1)
A3(0.08, 0.09, 0.13)(0.07, 0.09, 0.12)(0.07, 0.08, 0.13)(0.06, 0.08, 0.1)
A4(0.06, 0.09, 0.11)(0.07, 0.1, 0.12)(0.06, 0.08, 0.1)(0.05, 0.07, 0.1)
A5(0.05, 0.08, 0.09)(0.05, 0.08, 0.1)(0.06, 0.09, 0.12)(0.08, 0.08, 0.13)
A6(0.05, 0.08, 0.09)(0.05, 0.08, 0.1)(0.06, 0.09, 0.12)(0.06, 0.07, 0.1)
A7(0.08, 0.11, 0.14)(0.07, 0.09, 0.12)(0.06, 0.09, 0.12)(0.08, 0.09, 0.14)
A8(0.08, 0.11, 0.14)(0.07, 0.09, 0.12)(0.06, 0.09, 0.12)(0.08, 0.12, 0.14)
A9(0.07, 0.08, 0.12)(0.07, 0.09, 0.12)(0.06, 0.09, 0.12)(0.07, 0.09, 0.12)
A10(0.07, 0.08, 0.12)(0.07, 0.09, 0.12)(0.06, 0.09, 0.12)(0.08, 0.11, 0.13)
Ao(0.08, 0.11, 0.14)(0.07, 0.1, 0.12)(0.08, 0.09, 0.14)(0.08, 0.12, 0.14)
C13C14C15C16
A1(0.09, 0.12, 0.16)(0.07, 0.08, 0.12)(0.08, 0.11, 0.12)(0.09, 0.13, 0.17)
A2(0.06, 0.09, 0.12)(0.07, 0.08, 0.12)(0.08, 0.11, 0.12)(0.09, 0.13, 0.17)
A3(0.06, 0.09, 0.12)(0.08, 0.12, 0.14)(0.07, 0.09, 0.12)(0.04, 0.04, 0.09)
A4(0.06, 0.09, 0.12)(0.08, 0.1, 0.14)(0.07, 0.09, 0.12)(0.04, 0.07, 0.09)
A5(0.06, 0.09, 0.12)(0.06, 0.09, 0.11)(0.07, 0.08, 0.11)(0.06, 0.08, 0.12)
A6(0.06, 0.08, 0.11)(0.04, 0.07, 0.08)(0.07, 0.08, 0.11)(0.06, 0.08, 0.12)
A7(0.06, 0.08, 0.11)(0.08, 0.09, 0.14)(0.07, 0.08, 0.11)(0.06, 0.08, 0.12)
A8(0.06, 0.09, 0.12)(0.08, 0.09, 0.14)(0.07, 0.08, 0.11)(0.06, 0.08, 0.12)
A9(0.06, 0.09, 0.12)(0.05, 0.08, 0.09)(0.07, 0.08, 0.11)(0.06, 0.08, 0.12)
A10(0.05, 0.07, 0.1)(0.05, 0.08, 0.09)(0.07, 0.08, 0.11)(0.06, 0.08, 0.12)
Ao(0.09, 0.12, 0.16)(0.08, 0.12, 0.14)(0.08, 0.11, 0.12)(0.09, 0.13, 0.17)
Table 6. Results of integrated IMF D-SWARA and Fuzzy ARAS-Z model.
Table 6. Results of integrated IMF D-SWARA and Fuzzy ARAS-Z model.
OiAiCrisp AiRank
A1(0.06, 0.09, 0.13)(0.38, 0.80, 1.80)0.8957
A2(0.06, 0.09, 0.13)(0.40, 0.81, 1.84)0.9115
A3(0.06, 0.08, 0.13)(0.38, 0.76, 1.78)0.8649
A4(0.06, 0.09, 0.13)(0.38, 0.80, 1.79)0.8956
A5(0.05, 0.08, 0.12)(0.34, 0.74, 1.67)0.82910
A6(0.06, 0.09, 0.13)(0.37, 0.78, 1.73)0.8728
A7(0.06, 0.09, 0.14)(0.40, 0.83, 1.87)0.9324
A8(0.06, 0.10, 0.14)(0.41, 0.87, 1.89)0.9651
A9(0.06, 0.09, 0.14)(0.41, 0.84, 1.89)0.9453
A10(0.06, 0.10, 0.14)(0.41, 0.87, 1.89)0.9602
So(0.07, 0.11, 0.15)
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Jovanović, S.; Zavadskas, E.K.; Stević, Ž.; Marinković, M.; Alrasheedi, A.F.; Badi, I. An Intelligent Fuzzy MCDM Model Based on D and Z Numbers for Paver Selection: IMF D-SWARA—Fuzzy ARAS-Z Model. Axioms 2023, 12, 573. https://doi.org/10.3390/axioms12060573

AMA Style

Jovanović S, Zavadskas EK, Stević Ž, Marinković M, Alrasheedi AF, Badi I. An Intelligent Fuzzy MCDM Model Based on D and Z Numbers for Paver Selection: IMF D-SWARA—Fuzzy ARAS-Z Model. Axioms. 2023; 12(6):573. https://doi.org/10.3390/axioms12060573

Chicago/Turabian Style

Jovanović, Stanislav, Edmundas Kazimieras Zavadskas, Željko Stević, Milan Marinković, Adel F. Alrasheedi, and Ibrahim Badi. 2023. "An Intelligent Fuzzy MCDM Model Based on D and Z Numbers for Paver Selection: IMF D-SWARA—Fuzzy ARAS-Z Model" Axioms 12, no. 6: 573. https://doi.org/10.3390/axioms12060573

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
