Risk Perception Gaps Between Construction Investors and Financial Investors of International Public–Private Partnership (PPP) Projects
Abstract
:1. Introduction

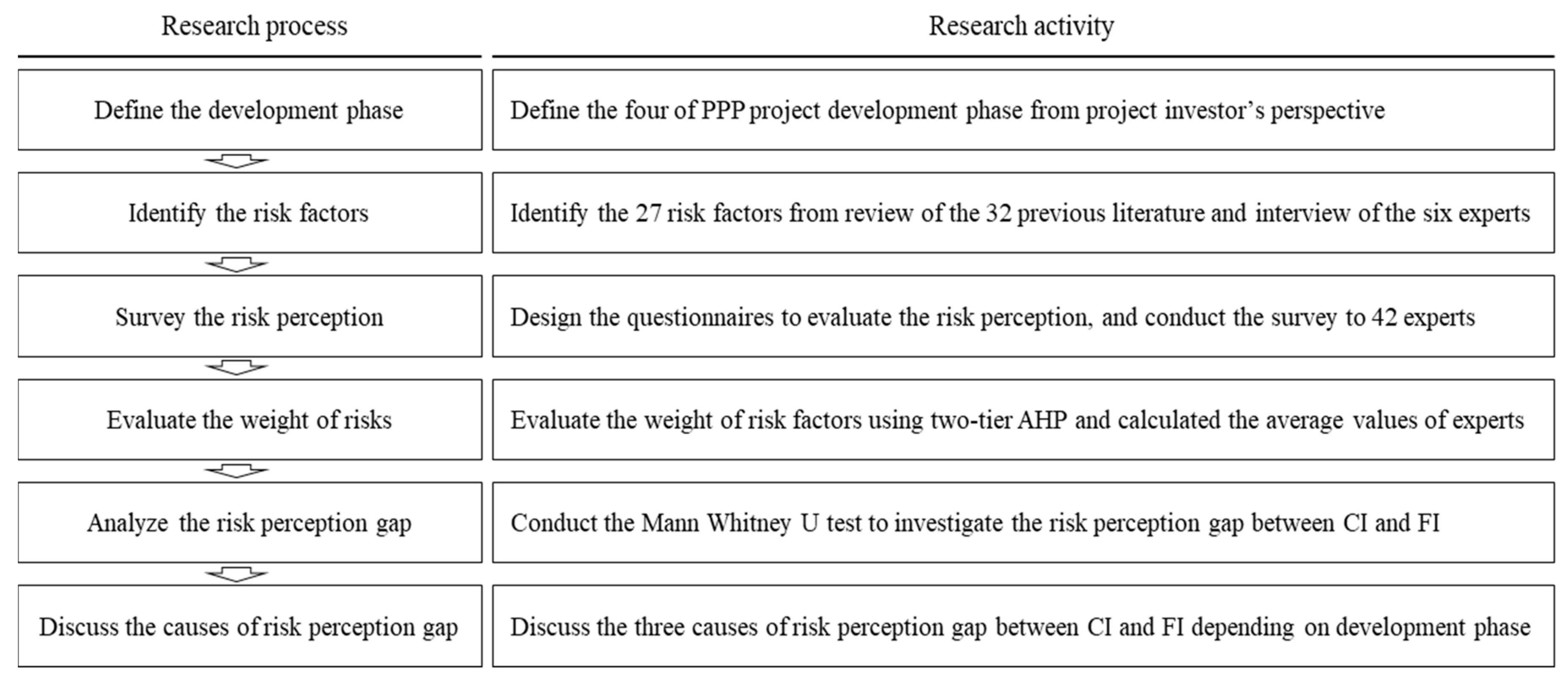

2. Research Backgrounds

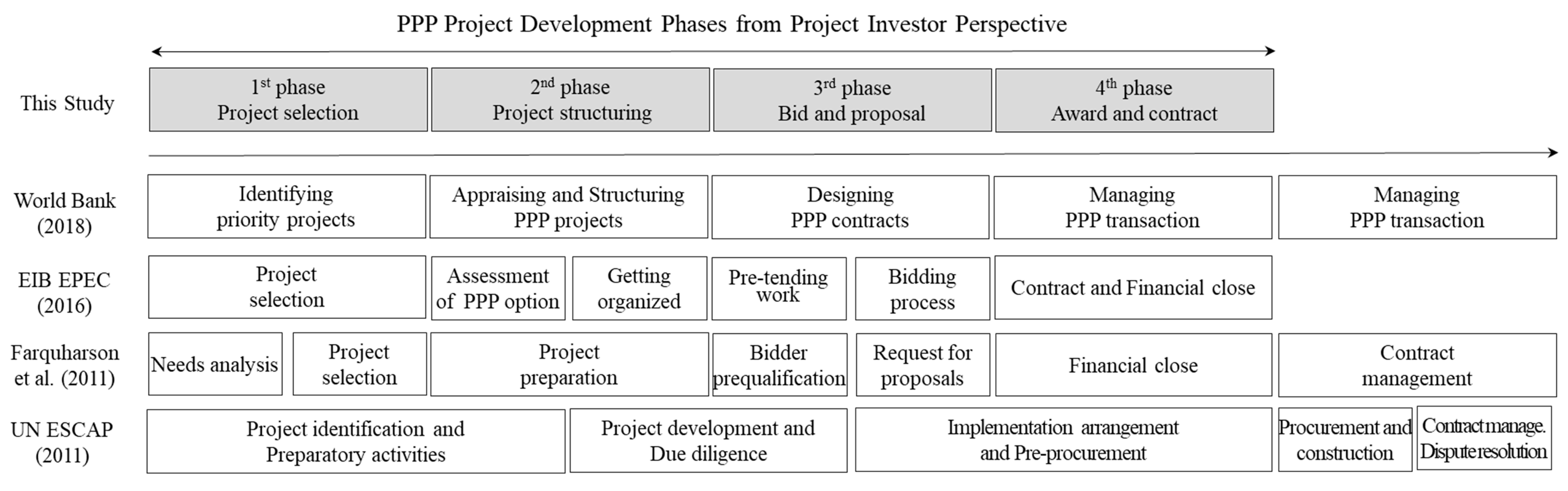

2.1. Development Phase of an International PPP Project
2.2. Stakeholders in International PPP Projects
2.2.1. Previous Research about Stakeholder Theory on PPP Project
2.2.2. Private Stakeholders in International PPP Project
3. Methodology
3.1. Risk Identification
3.2. Questionnaire and Survey
3.3. Weight Measurement
3.4. Mann–Whitney U test
4. Results
4.1. Risk Perception Gap in Project Selection Phase
4.1.1. Stakeholder Risk
4.1.2. Financial Risk
4.1.3. Construction Risk
4.1.4. Country Risk
4.2. Risk Perception Gap in Bid and Proposal Phase
4.2.1. Stakeholder Risk
4.2.2. Financial Risk
4.2.3. Construction Risk
4.2.4. Country Risk
5. Discussion
5.1. Time-Dependent Risk
5.2. Risk Exposure Period
5.3. Risk Transfer and Responsibility
6. Conclusions
Author Contributions
Funding
Conflicts of Interest
Appendix A. Questionnaire Examples for Evaluating Perception on Risk Importance (AHP)
Appendix A.1. Respondent Information
Appendix A.2. Pair-Wise Comparison Matrix for Risk Importance
Project Selection | Stakeholder Risk | Financial Risk | Construction Risk | Country Risk |
Stakeholder Risk | 1 | |||
Financial Risk | N/A | 1 | ||
Construction Risk | N/A | N/A | 1 | |
Country Risk | N/A | N/A | N/A | 1 |
Bid and Proposal | Stakeholder Risk | Financial Risk | Construction Risk | Country Risk |
Stakeholder Risk | 1 | |||
Financial Risk | N/A | 1 | ||
Construction Risk | N/A | N/A | 1 | |
Country Risk | N/A | N/A | N/A | 1 |
Project Selection | Track Record of Leading Investor | Track Record of EPC Contractor | Track record of O and m Contractor | Track Record of Public Authorities | Voting Rights among Stake. | Risk Allocation among Stake. |
Track record of leading investor | 1 | |||||
Track record of EPC contractor | N/A | 1 | ||||
Track record of O and M contractor | N/A | N/A | 1 | |||
Track record of public authorities | N/A | N/A | N/A | 1 | ||
Voting rights among stake. | N/A | N/A | N/A | N/A | 1 | |
Risk allocation among stake. | N/A | N/A | N/A | N/A | N/A | 1 |
Bid and Proposal | Track record of leading investor | Track record of EPC contractor | Track record of O and M contractor | Track record of public authorities | Voting rights among stake. | Risk allocation among stake. |
Track record of leading investor | 1 | |||||
Track record of EPC contractor | N/A | 1 | ||||
Track record of O and M contractor | N/A | N/A | 1 | |||
Track record of public authorities | N/A | N/A | N/A | 1 | ||
Voting rights among stake. | N/A | N/A | N/A | N/A | 1 | |
Risk allocation among stake. | N/A | N/A | N/A | N/A | N/A | 1 |
References
- World Bank Private Participation in Infrastructure Database. 2019. Available online: https://ppi.worldbank.org (accessed on 27 October 2020).
- Lee, M.; Han, X.; Quising, P.; Villaruel, M.L. Hazard Analysis on Public–Private Partnership Projects in Developing Asia; Asian Development Bank Economics Working Paper Series; Asian Development Bank: Mandaluyong, Philippines, 2018. [Google Scholar]
- Romero, M.J. History RePPPeated: How Public Private Partnerships are Failing; Eurodad: Brussels, Belgium, 2018. [Google Scholar]
- Reddy, N.S.; Sharma, P. Why PPP Modeled Infrastructure Projects Failed: A Critical Review with a Special Focus on Road Sector. Int. J. Adv. Eng. Manag. Sci. 2017, 3, 239816. [Google Scholar] [CrossRef]
- Chan, A.P.; Lam, P.T.; Chan, D.W.; Cheung, E.; Ke, Y. Critical success factors for PPPs in infrastructure developments: Chinese perspective. J. Constr. Eng. Manag. 2010, 136, 484–494. [Google Scholar] [CrossRef]
- Ng, S.T.; Wong, Y.M.W.; Wong, J.M.W. A Structural Equation Model of Feasibility Evaluation and Project Success for Public–Private Partnerships in Hong Kong. IEEE Trans. Eng. Manag. 2010, 57, 310–322. [Google Scholar] [CrossRef] [Green Version]
- Hwang, B.-G.; Zhao, X.; Gay, M.J.S. Public private partnership projects in Singapore: Factors, critical risks and preferred risk allocation from the perspective of contractors. Int. J. Proj. Manag. 2013, 31, 424–433. [Google Scholar] [CrossRef]
- Chou, J.-S.; Pramudawardhani, D. Cross-country comparisons of key drivers, critical success factors and risk allocation for public-private partnership projects. Int. J. Proj. Manag. 2015, 33, 1136–1150. [Google Scholar] [CrossRef]
- Liu, J.; Love, P.E.D.; Smith, J.; Regan, M.; Davis, P.R. Life Cycle Critical Success Factors for Public-Private Partnership Infrastructure Projects. J. Manag. Eng. 2015, 31, 04014073. [Google Scholar] [CrossRef]
- Song, J.; Hu, Y.; Feng, Z. Factors Influencing Early Termination of PPP Projects in China. J. Manag. Eng. 2018, 34, 05017008. [Google Scholar] [CrossRef]
- Yu, Y.; Chan, A.P.C.; Chen, C.; Darko, A. Critical Risk Factors of Transnational Public–Private Partnership Projects: Literature Review. J. Infrastruct. Syst. 2018, 24, 04017042. [Google Scholar] [CrossRef]
- Kong, D.; Tiong, R.L.; Cheah, C.Y.; Permana, A.; Ehrlich, M. Assessment of credit risk in project finance. J. Constr. Eng. 2008, 134, 876–884. [Google Scholar] [CrossRef]
- Salman, A.F.; Skibniewski, M.J.; Basha, I. BOT viability model for large-scale infrastructure projects. J. Constr. Eng. Manag. 2007, 133, 50–63. [Google Scholar] [CrossRef]
- Chan, A.P.C.; Yeung, J.F.Y.; Yu, C.C.P.; Wang, S.Q.; Ke, Y. Empirical Study of Risk Assessment and Allocation of Public-Private Partnership Projects in China. J. Manag. Eng. 2011, 27, 136–148. [Google Scholar] [CrossRef] [Green Version]
- Ng, S.T.; Wong, Y.M.W.; Wong, J.M.W. Factors influencing the success of PPP at feasibility stage—A tripartite comparison study in Hong Kong. Habitat Int. 2012, 36, 423–432. [Google Scholar] [CrossRef]
- Ye, X.; Shi, S.; Chong, H.-Y.; Fu, X.; Liu, L.; He, Q. Empirical Analysis of Firms’ Willingness to Participate in Infrastructure PPP Projects. J. Constr. Eng. Manag. 2018, 144, 04017092. [Google Scholar] [CrossRef] [Green Version]
- Budayan, C. Evaluation of Delay Causes for BOT Projects Based on Perceptions of Different Stakeholders in Turkey. J. Manag. Eng. 2019, 35, 04018057. [Google Scholar] [CrossRef]
- El-Gohary, N.M.; Osman, H.; El-Diraby, T.E. Stakeholder management for public private partnerships. Int. J. Proj. Manag. 2006, 24, 595–604. [Google Scholar] [CrossRef]
- Bank, W.; PPIAF. Public-Private Partnerships, Reference Guide; The World Bank and PPIAF: Washington, DC, USA, 2017. [Google Scholar]
- Bao, F.; Chan, A.P.C.; Chen, C.; Darko, A. Review of Public–Private Partnership Literature from a Project Lifecycle Perspective. J. Infrastruct. Syst. 2018, 24, 04018008. [Google Scholar] [CrossRef]
- Lu, J.Z.; Chao, J.J.; Sheppard, J.R. Guarantees for Mobilizing Private Investment in Infrastructure; The World Bank: Washington, DC, USA, 2019. [Google Scholar]
- Page, S.; Verdouw, W.; Ham, M.; Helwig, J. Revenue Risk Sharing for Highway Public-Private Partnership Concessions: A Discussion Paper; U.S. Federal Highway Administration: Washington, DC, USA, 2016.
- Park, S. Improving the Bankability of PPP with Proper Risk Sharing: The Korean Experience; PIMAC: Yeongi-gun, Korea, 2014. [Google Scholar]
- United Nations ESCAP. A Guidebook on Public-Private Partnership in Infrastructure; Economic and Social Commission for Asia and The Pacific (ESCAP) United Nations: Bangkok, Thailand, 2011. [Google Scholar]
- Farquharson, E.; Torres de Mästle, C.; Yescombe, E.R. How to Engage with the Private Sector in Public-Private Partnerships in Emerging Markets; The World Bank: Washington, DC, USA, 2011. [Google Scholar]
- EIB. The Guide to Guidance: How to Prepare, Procure and Deliver PPP Projects; EIB: Luxembourg, 2016. [Google Scholar]
- Freeman, R.E. Strategic Management: A Stakeholder Approach; Cambridge University Press: Cambridge, UK, 2010. [Google Scholar]
- Ackermann, F.; Eden, C. Strategic management of stakeholders: Theory and practice. Long Range Plan. 2011, 44, 179–196. [Google Scholar] [CrossRef]
- Laplume, A.O.; Sonpar, K.; Litz, R.A. Stakeholder theory: Reviewing a theory that moves us. J. Manag. 2008, 34, 1152–1189. [Google Scholar] [CrossRef]
- South, A.J.; Levitt, R.E.; Dewulf, G.P. Dynamic stakeholder networks and the governance of PPPs. In Advances in Public-Private Partnerships; American Society of Civil Engineers: Reston, VA, USA, 2017; pp. 499–515. [Google Scholar]
- Institute, P.M. A Guide to the Project Management Body of Knowledge (PMBOK Guide); Project Management Inst: Newtown Square, PA, USA, 2000; Volume 2. [Google Scholar]
- Littau, P.; Jujagiri, N.J.; Adlbrecht, G. 25 years of stakeholder theory in project management literature (1984–2009). Proj. Manag. J. 2010, 41, 17–29. [Google Scholar] [CrossRef]
- Jergeas, G.F.; Williamson, E.; Skulmoski, G.J.; Thomas, J.L. Stakeholder management on construction projects. Aace Int. Trans. 2000, 12, 1–6. [Google Scholar]
- Olander, S.; Landin, A. Evaluation of stakeholder influence in the implementation of construction projects. Int. J. Proj. Manag. 2005, 23, 321–328. [Google Scholar] [CrossRef]
- Aladağ, H.; Işik, Z. The Effect of Stakeholder-Associated Risks in Mega-Engineering Projects: A Case Study of a PPP Airport Project. IEEE Trans. Eng. Manag. 2018, 67, 174–186. [Google Scholar] [CrossRef]
- Rittel, H.W.; Webber, M.M. Dilemmas in a general theory of planning. Policy Sci. 1973, 4, 155–169. [Google Scholar] [CrossRef]
- Zhang, X. Critical success factors for public-private partnerships in infrastructure development. J. Constr. Eng. Manag. 2005, 131, 3–14. [Google Scholar] [CrossRef]
- De Schepper, S.; Dooms, M.; Haezendonck, E. Stakeholder dynamics and responsibilities in Public-Private Partnerships: A mixed experience. Int. J. Proj. Manag. 2014, 32, 1210–1222. [Google Scholar] [CrossRef]
- Yuan, J.; Skibniewski, M.J.; Li, Q.; Zheng, L. Performance objectives selection model in public-private partnership projects based on the perspective of stakeholders. J. Manag. Eng. 2009, 26, 89–104. [Google Scholar] [CrossRef]
- Zhang, Y.; Gu, J.; Shan, M.; Xiao, Y.; Darko, A. Investigating private sectors’ behavioral intention to participate in PPP projects: An empirical examination based on the theory of planned behavior. Sustainability 2018, 10, 2692. [Google Scholar] [CrossRef] [Green Version]
- Deep, A.; Kim, J.; Lee, M. Realizing the Potential of Public–Private Partnerships to Advance Asia’s Infrastructure Development; Asian Development Bank: Mandaluyong, Philippines, 2019. [Google Scholar]
- De Clerck, D.; Demeulemeester, E. An ex ante bidding model to assess the incentive creation capability of a public–private partnership pipeline. Int. J. Proj. Manag. 2016, 34, 117–131. [Google Scholar] [CrossRef]
- Chiang, Y.-H.; Cheng, E.W. Perception of financial institutions toward financing PFI projects in Hong Kong. J. Constr. Eng. Manag. 2009, 135, 833–840. [Google Scholar] [CrossRef]
- Mandri-Perrott, C. Private Sector Participation in Light Rail-Light Metro Transit Initiatives; World Bank Publications: Washington, DC, USA, 2010. [Google Scholar]
- Jung, W.; Han, S.H. Which risk management is most crucial for controlling project cost? J. Manag. Eng. 2017, 33, 04017029. [Google Scholar] [CrossRef]
- Dikmen, I.; Budayan, C.; Talat Birgonul, M.; Hayat, E. Effects of risk attitude and controllability assumption on risk ratings: Observational study on international construction project risk assessment. J. Manag. Eng. 2018, 34, 04018037. [Google Scholar] [CrossRef]
- Tang, L.; Shen, Q.; Skitmore, M.; Cheng, E.W.L. Ranked Critical Factors in PPP Briefings. J. Manag. Eng. 2013, 29, 164–171. [Google Scholar] [CrossRef] [Green Version]
- Liu, T.; Wilkinson, S. Critical Factors Affecting the Viability of Using Public-Private Partnerships for Prison Development. J. Manag. Eng. 2015, 31, 05014020. [Google Scholar] [CrossRef]
- Ozdoganm, I.D.; Talat Birgonul, M. A decision support framework for project sponsors in the planning stage of build-operate-transfer (BOT) projects. Constr. Manag. Econ. 2010, 18, 343–353. [Google Scholar] [CrossRef]
- Yu, Y.; Darko, A.; Chan, A.P.C.; Chen, C.; Bao, F. Evaluation and Ranking of Risk Factors in Transnational Public–Private Partnerships Projects: Case Study Based on the Intuitionistic Fuzzy Analytic Hierarchy Process. J. Infrastruct. Syst. 2018, 24, 04018028. [Google Scholar] [CrossRef]
- Yuan, J.; Wang, C.; Skibniewski, M.J.; Li, Q. Developing key performance indicators for public-private partnership projects: Questionnaire survey and analysis. J. Manag. Eng. 2012, 28, 252–264. [Google Scholar] [CrossRef]
- Ranasinghe, M. Private sector participation in infrastructure projects: A methodology to analyse viability of BOT. Constr. Manag. Econ. 1999, 17, 613–623. [Google Scholar] [CrossRef]
- Ho, S.P.; Liu, L.Y. An option pricing-based model for evaluating the financial viability of privatized infrastructure projects. Constr. Manag. Econ. 2002, 20, 143–156. [Google Scholar] [CrossRef]
- Jiang, X.; Lu, K.; Xia, B.; Liu, Y.; Cui, C. Identifying significant risks and analyzing risk relationship for construction PPP projects in China using integrated FISM-MICMAC approach. Sustainability 2019, 11, 5206. [Google Scholar] [CrossRef] [Green Version]
- Battisti, F.; Campo, O. A Methodology for Determining the Profitability Index of Real Estate Initiatives Involving Public–Private Partnerships. A Case Study: The Integrated Intervention Programs in Rome. Sustainability 2019, 11, 1371. [Google Scholar] [CrossRef] [Green Version]
- Global Infrastructure Hub. Leading Practices in Governmental Processes Facilitating Infrastructure Project Preparation; Global Infrastructure Hub: Sydney, Australia, 2018. [Google Scholar]
- NathanAssociates. Public-Private Partnerships: A Basic Introduction for Non-Specilalists; EPS PEAKS: London, UK, 2017. [Google Scholar]
- Chowdhury, A.N.; Chen, P.-H.; Tiong, R.L. Credit enhancement factors for the financing of independent power producer (IPP) projects in Asia. Int. J. Proj. Manag. 2015, 33, 1576–1587. [Google Scholar] [CrossRef]
- Soomro, M.A.; Zhang, X. Evaluation of the Functions of Public Sector Partners in Transportation Public-Private Partnerships Failures. J. Manag. Eng. 2016, 32. [Google Scholar] [CrossRef]
- Liu, J.; Love, P.E.; Davis, P.R.; Smith, J.; Regan, M. Conceptual framework for the performance measurement of public-private partnerships. J. Infrastruct. Syst. 2014, 21, 04014023. [Google Scholar] [CrossRef]
- Wang, Y.; Wang, Y.; Wu, X.; Li, J. Exploring the Risk Factors of Infrastructure PPP Projects for Sustainable Delivery: A Social Network Perspective. Sustainability 2020, 12, 4152. [Google Scholar] [CrossRef]
- Tserng, H.P.; Ho, S.-P.; Chou, J.-S.; Lin, C. Proactive Measures of Governmental Debt Guarantees to Facilitate Public-Private Partnerships Project. J. Civ. Eng. Manag. 2014, 20, 548–560. [Google Scholar] [CrossRef]
- Chowdhury, A.N.; Chen, P.H.; Tiong, R.L.K. Analysing the structure of public–private partnership projects using network theory. Constr. Manag. Econ. 2011, 29, 247–260. [Google Scholar] [CrossRef]
- Korean Development Institute. Long-term Strategy for Entry in International Infrastructure Market; Korean Development Institute: Sejong, Korea, 2018. [Google Scholar]
- Saaty, T.L. The Analytic Hierarchy Process; McGraw-Hill: New York, NY, USA, 1980; Volume 324. [Google Scholar]
- Ramanathan, R. A note on the use of the analytic hierarchy process for environmental impact assessment. J. Environ. Manag. 2001, 63, 27–35. [Google Scholar] [CrossRef] [Green Version]
- Vargas, R.V.; IPMA-B, P. Using the analytic hierarchy process (AHP) to select and prioritize projects in a portfolio. In Proceedings of the PMI Global Congress, Washington, DC, USA, 9–12 October 2010; Volume 32, pp. 1–22. [Google Scholar]
- Guarini, M.R.; Battisti, F.; Chiovitti, A. Public initiatives of settlement transformation: A theoretical-methodological approach to selecting tools of multi-criteria decision analysis. Buildings 2018, 8, 1. [Google Scholar] [CrossRef] [Green Version]
- Korean Development Institute. Multi-Criteria Decision Making for Preliminary Feasibility Study; Korean Development Institute: Sejong, Korea, 2001. [Google Scholar]
- Cheng, E.W.; Li, H. Information priority-setting for better resource allocation using analytic hierarchy process (AHP). Inf. Manag. Comput. Secur. 2001, 9, 61–70. [Google Scholar] [CrossRef]
- Saaty, T.L. How to make a decision: The analytic hierarchy process. Eur. J. Oper. Res. 1990, 48, 9–26. [Google Scholar] [CrossRef]
- Hollander, M.; Wolfe, D.A.; Chicken, E. Nonparametric Statistical Methods; John Wiley & Sons: Hoboken, NJ, USA, 2013; Volume 751. [Google Scholar]
- Agency, J.I.C. The Preparatory Survey on XE KATAM Hydropower Pland Project in Lao P.D.R; JICA, The Kansai Electric Power, NEWJEC: Tokyo, Japan, 2015. [Google Scholar]
- Middleton, C. Private Dams, Public Interest in mainland Southeast Asia: Hydropower Governance in a Beyond-Aid Political Economy. In Proceedings of the Trans-Regional and -National Studies of Southeast Asia (TRaNS) Conference, Seoul, Korea, 27–28 May 2016; Sogang Institute for East Asian Studies: Seoul, Korea, 2016. [Google Scholar]
- Kräussl, R. Sovereign Ratings and Their Impact on Recent Financial Crises. 2003. Available online: https://www.econstor.eu/handle/10419/78065?locale=en (accessed on 27 October 2020).
- Sobják, A. Corruption Risks in Infrastructure Investments in Sub-Saharan Africa; OECD Global Anti-Corruption & Integrity Forum: Paris, France, 2018. [Google Scholar]

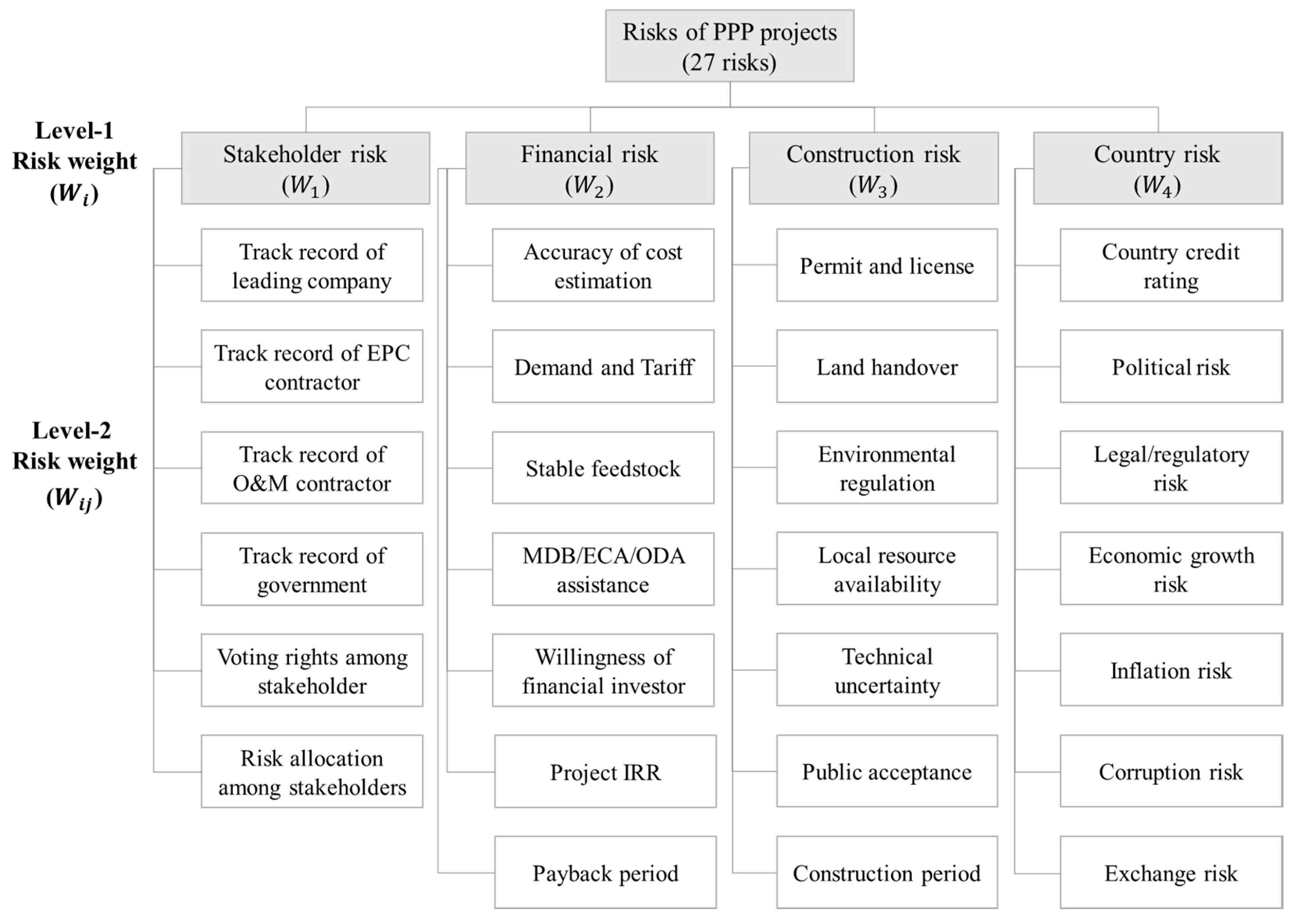

Level-1 | Level-2 | Definition of Risk | References |
---|---|---|---|
Stakeholder Risk | Track record of leading investor | Leading investor does not experience PPP projects in the host country, and has no financial soundness | [9,15,47,59] |
Track record of EPC contractor | EPC contractor does not experience PPP projects in the host country, and has no financial soundness | [5,7,8,35] | |
Track record of O&M contractor | O&M contractor does not experience PPP projects in the host country, and has no financial soundness | [10,15,25,35] | |
Track record of public authorities | The public authorities do not experience PPP projects in the host country, and has no financial soundness | [9,10,51,62] | |
Voting rights among stakeholders | Decision-making process and authority among stakeholders are arbitrary established by leading company | [14,47,54] | |
Risk allocation among stakeholders | Risk and responsibilities are not fairly allocated from each stakeholder perspective | [8,11,15,50] | |
Financial Risk | Uncertainty of project cost | The accuracy of project cost estimation is not reliable and does not consider the risks and uncertainties | [12,25,44,62] |
Demand and Tariff | Risk of demand and end-user price is not secured by agreement or government guarantee | [25,43,54,61] | |
Stable feedstock | Fuel supply is not expected to be provided by agreement or government guarantee | [8,44,61] | |
MDB/ECA/ODA assistance | Multilateral Development Bank, Export Credit Agency or Official Development Assistance do not participate | [25,58] | |
Willingness of financial investor | Financial investors are not interested in international PPP project comparing other financial investment | [5,10,53] | |
Project IRR | Internal rate of return (IRR) of project is not highly attractive to project investors | [15,16,47,52] | |
Payback period | Payback period of SPC is evaluated as relatively long to attract financial investors | [16,25,43] | |
Construction Risk | Permit and license | Construction permit process and license requirement are not established in host country | [5,7,8,25] |
Site handover | Site is expected to be handover as planned by local government | [5,7,8,25] | |
Environmental regulation | There could be environmental issues and strict environmental regulation to suspend construction completion | [6,11,25,54] | |
Local resource availability | Local resources such as material, equipment, and labor are not available in host country | [13,14,17,39] | |
Technical uncertainty | There could be significant technical risk to delay construction completion or reduce construction quality | [7,8,51] | |
Public acceptance | There could be significant public acceptance issues to suspend construction completion | [10,16,17,39] | |
Construction period | Construction period is evaluated too short to complete construction as planned | [8,13,17] | |
Country Risk | Country credit rating | Country credit rating from authorized financial institution is not appropriate to invest | [13,16,44] |
Political risk | Political status of host country is not stable and property rights are not secured | [11,25,49] | |
Legal and regulatory risk | Legal/regulatory framework for PPP project is not established | [25,48,63] | |
Economic growth risk | Average economic growth rate over five years was low to attract financial investors | [15,43,62] | |
Inflation risk | Average inflation rate over five years was high and the economic condition is unstable | [7,8,14] | |
Corruption risk | Corruption is expected to hard to perform construction completion | [7,8,14] | |
Exchange risk | Payment currency is local currency or cannot be hedged | [5,8,11] |
Risk Factors | Construction Investor | Financial Investor | p-Value | ||
---|---|---|---|---|---|
Weight | Rank | Weight | Rank | ||
Stakeholder risk | 0.338 | 1 | 0.388 | 1 | 0.047 * |
- Track record of leading company | 0.076 | 1 | 0.094 | 1 | 0.194 |
- Track record of EPC contractor | 0.051 | 5 | 0.067 | 2 | 0.050 * |
- Track record of O&M contractor | 0.049 | 6 | 0.058 | 4 | 0.086 |
- Track record of public authorities | 0.053 | 4 | 0.057 | 5 | 0.659 |
- Voting rights among stakeholders | 0.054 | 3 | 0.055 | 6 | 0.344 |
- Risk allocation among stakeholders | 0.056 | 2 | 0.058 | 3 | 0.596 |
Financial risk | 0.230 | 3 | 0.215 | 3 | 0.385 |
- Uncertainty of project cost | 0.041 | 8 | 0.043 | 9 | 0.657 |
- Demand and Tariff | 0.038 | 10 | 0.040 | 10 | 0.667 |
- Stable feedstock | 0.031 | 16 | 0.031 | 13 | 0.605 |
- MDB/ECA/ODA assistance | 0.029 | 20 | 0.029 | 15 | 0.919 |
- Willingness of financial investor | 0.031 | 17 | 0.028 | 16 | 0.470 |
- Project IRR | 0.032 | 15 | 0.023 | 20 | 0.018 * |
- Payback period | 0.028 | 21 | 0.021 | 23 | 0.113 |
Construction risk | 0.188 | 4 | 0.171 | 4 | 0.890 |
- Permit and license | 0.032 | 14 | 0.036 | 11 | 0.791 |
- Land handover | 0.031 | 18 | 0.031 | 12 | 0.316 |
- Environmental regulation | 0.027 | 23 | 0.022 | 21 | 0.037 * |
- Local resource availability | 0.023 | 27 | 0.022 | 22 | 0.898 |
- Technical uncertainty | 0.024 | 25 | 0.021 | 25 | 0.469 |
- Public acceptance | 0.027 | 24 | 0.020 | 26 | 0.105 |
- Construction period | 0.024 | 26 | 0.019 | 27 | 0.255 |
Country risk | 0.244 | 2 | 0.226 | 2 | 0.372 |
- Country credit rating | 0.041 | 9 | 0.053 | 7 | 0.112 |
- Political risk | 0.042 | 7 | 0.048 | 8 | 0.734 |
- Legal/regulatory risk | 0.038 | 11 | 0.031 | 14 | 0.042 * |
- Economic growth risk | 0.030 | 19 | 0.023 | 19 | 0.128 |
- Inflation risk | 0.028 | 22 | 0.025 | 18 | 0.380 |
- Corruption risk | 0.032 | 13 | 0.025 | 17 | 0.224 |
- Exchange risk | 0.034 | 12 | 0.021 | 24 | 0.008 ** |
Risk Factors | Construction Investor | Financial Investor | p-Value | ||
---|---|---|---|---|---|
Weight | Rank | Weight | Rank | ||
Stakeholder risk | 0.256 | 2 | 0.334 | 1 | 0.002 ** |
- Track record of leading company | 0.057 | 2 | 0.084 | 1 | 0.007 ** |
- Track record of EPC contractor | 0.040 | 9 | 0.055 | 2 | 0.012 * |
- Track record of O and M contractor | 0.039 | 12 | 0.047 | 8 | 0.048 * |
- Track record of public authorities | 0.038 | 15 | 0.047 | 9 | 0.057 |
- Voting rights among stakeholders | 0.040 | 8 | 0.049 | 7 | 0.089 |
- Risk allocation among stakeholders | 0.040 | 10 | 0.052 | 5 | 0.222 |
Financial risk | 0.325 | 1 | 0.270 | 2 | 0.030 * |
- Uncertainty of project cost | 0.060 | 1 | 0.052 | 3 | 0.538 |
- Demand and Tariff | 0.052 | 3 | 0.049 | 6 | 0.505 |
- Stable feedstock | 0.046 | 4 | 0.040 | 12 | 0.296 |
- MDB/ECA/ODA assistance | 0.039 | 14 | 0.041 | 10 | 0.792 |
- Willingness of financial investor | 0.041 | 6 | 0.035 | 14 | 0.105 |
- Project IRR | 0.046 | 5 | 0.026 | 18 | 0.004 ** |
- Payback period | 0.041 | 7 | 0.027 | 17 | 0.009 ** |
Construction risk | 0.243 | 3 | 0.187 | 4 | 0.042 * |
- Permit and license | 0.040 | 11 | 0.039 | 13 | 0.930 |
- Land handover | 0.039 | 13 | 0.032 | 15 | 0.064 |
- Environmental regulation | 0.034 | 17 | 0.024 | 19 | 0.002 ** |
- Local resource availability | 0.031 | 20 | 0.024 | 20 | 0.054 |
- Technical uncertainty | 0.033 | 18 | 0.024 | 21 | 0.007 ** |
- Public acceptance | 0.034 | 16 | 0.024 | 22 | 0.038 * |
- Construction period | 0.033 | 19 | 0.019 | 27 | 0.007 ** |
Country risk | 0.177 | 4 | 0.207 | 3 | 0.078 |
- Country credit rating | 0.028 | 22 | 0.052 | 4 | 0.001 ** |
- Political risk | 0.030 | 21 | 0.040 | 11 | 0.042 * |
- Legal/regulatory risk | 0.027 | 23 | 0.028 | 16 | 0.910 |
- Economic growth risk | 0.023 | 26 | 0.021 | 25 | 0.473 |
- Inflation risk | 0.021 | 27 | 0.022 | 24 | 0.473 |
- Corruption risk | 0.023 | 25 | 0.022 | 23 | 0.870 |
- Exchange risk | 0.025 | 24 | 0.021 | 26 | 0.428 |
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations. |
© 2020 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (http://creativecommons.org/licenses/by/4.0/).
Share and Cite
Park, C.Y.; Jung, W.; Han, S.H. Risk Perception Gaps Between Construction Investors and Financial Investors of International Public–Private Partnership (PPP) Projects. Sustainability 2020, 12, 9003. https://doi.org/10.3390/su12219003
Park CY, Jung W, Han SH. Risk Perception Gaps Between Construction Investors and Financial Investors of International Public–Private Partnership (PPP) Projects. Sustainability. 2020; 12(21):9003. https://doi.org/10.3390/su12219003
Chicago/Turabian StylePark, Chan Young, Wooyong Jung, and Seung H. Han. 2020. "Risk Perception Gaps Between Construction Investors and Financial Investors of International Public–Private Partnership (PPP) Projects" Sustainability 12, no. 21: 9003. https://doi.org/10.3390/su12219003
APA StylePark, C. Y., Jung, W., & Han, S. H. (2020). Risk Perception Gaps Between Construction Investors and Financial Investors of International Public–Private Partnership (PPP) Projects. Sustainability, 12(21), 9003. https://doi.org/10.3390/su12219003
