Article

A Method to Include Life Cycle Assessment Results in Choosing by Advantage (CBA) Multicriteria Decision Analysis. A Case Study for Seismic Retrofit in Peruvian Primary Schools

by
Ian Vázquez-Rowe
1,*,
Cristina Córdova-Arias
2,
Xavier Brioso
2 and
Sandra Santa-Cruz
3
1
Peruvian Life Cycle Assessment and Industrial Ecology Network (PELCAN), Department of Engineering, Pontificia Universidad Católica del Perú, Lima 15088, Peru
2
GETEC Research Group, Department of Engineering, Pontificia Universidad Católica del Perú, Lima 15088, Peru
3
GERDIS Research Group, Department of Engineering, Pontificia Universidad Católica del Perú, Lima 15088, Peru
*
Author to whom correspondence should be addressed.
Sustainability 2021, 13(15), 8139; https://doi.org/10.3390/su13158139
Submission received: 2 May 2021 / Revised: 16 June 2021 / Accepted: 23 June 2021 / Published: 21 July 2021

Abstract

:
Building information modeling (BIM) is an emerging technology that improves visualization, understanding, and transparency in construction projects. Its use in Latin America and the Caribbean (LA&C), while still scarce, is developing in combination with multi-criteria decision-making (MCDM) methods, such as the choosing by advantages (CBA) method. Despite the holistic nature of MCDM methods, the inclusion of life cycle environmental metrics is lagging in construction projects in LA&C. However, recent studies point toward the need to optimize the synergies between BIM and life cycle assessment (LCA), in which a method like CBA could allow improving the quality of the decisions. Therefore, the main objective of this study is to integrate LCA and CBA methods to identify the effect that the inclusion of environmental impacts can have on decision-making in public procurement, as well as comparing how this final decision differs from an exclusively LCA-oriented interpretation of the results. Once the LCA was performed, a set of additional criteria for the CBA method were fixed, including transparency, technical, and social indicators. Thereafter, a stakeholder participative workshop was held in order to gather experts to elucidate on the final decision. The methodology was applied to a relevant construction sector problem modelled with BIM in the city of Lima (Peru), which consisted of three different construction techniques needed to retrofit educational institutions. Results from the LCA-oriented assessment, which was supported by Monte Carlo simulation, revealed a situation in which the masonry-based technique showed significantly lower environmental impacts than the remaining two options. However, when a wider range of technical, social, and transparency criteria are added to the environmental indicators, this low-carbon technique only prevailed in those workshop tables in which environmental experts were present and under specific computational assumptions, whereas teams with a higher proportion of government members were inclined to foster alternatives that imply less bureaucratic barriers. Finally, the results constitute an important milestone when it comes to including environmental factors in public procurement in LA&C.

1. Introduction

Building information modeling (BIM) technology arises as a prominent approach that improves visualization, understanding, and transparency in construction projects [1,2], through the automatization of construction operations owing to the development of accurate virtual models for buildings [3]. Several studies highlight that BIM currently allows a reasonable integration of the initial stages of project development [3,4,5]. To a great extent, this is due to the development of systems that are able to generate complex models that integrate time (i.e., planning and scheduling), budgets, construction, and design parameters to simulate and coordinate the execution of the project [6].
Despite the multiple benefits of BIM, in many cases it is necessary to couple its results with multi-criteria decision-making (MCDM) methods in order to allow decision-makers or even policy-makers to consider the best alternative of an array of options based on multiple factors [7]. Some commonly used MCDM methods applied in the building sector, which may be used individually or through hybridization with other methods, include the analytical hierarchy process (AHP), the Technique for Order of Preference by Similarity to Ideal Solution (TOPSIS), or fuzzy sets—FSs [8]. However, in recent years, choosing by advantages (CBA) has emerged as a popular alternative to these methods [9,10]. The methodological framework of the CBA approach is based exclusively on the advantages rather than advantages and disadvantages, preventing double counting [11], and it has been shown to improve collaboration between designers, builders, and users [12]. In addition, it has also proved to reduce decision times, fostering consensus building throughout stakeholders, enhancing the transparency of the system [9,13], and helping include environmental policy design aspects [14].
A second limitation of the use of BIM and complementary MCDM methods is the fact that it is yet to be universalized in the construction sector. In fact, an important correlation has been observed between countries in which public procurement requires the use of BIM techniques and its implementation in the private sector [15,16]. Whereas New Zealand, the United Kingdom, the United States, and Finland present high adoption rates [17,18], countries in the LA&C region still appear in an early phase of implementation [15,19]. In the specific case of Peru, for instance, the government has only recently passed legislation to gradually include BIM in public procurement in the period 2020–2025 [20].
A third issue of concern in the automatization of processes in the building sector is that, despite efforts to include environmental sustainability information in the modelling, there is still a lack of interoperability of BIM with the life cycle assessment (LCA) software, the main environmental assessment methodology that allows the computation of project-specific environmental impacts throughout the life-cycle of infrastructure [21,22,23,24,25]. Although an increasing number of studies have delved into coupling BIM and LCA directly [26,27], most studies to date have opted to include isolated environmental indicators in MCDM methods to complement BIM [28,29,30,31].
In this context, the main objective of this study is to integrate LCA and CBA methods to identify the effect that the inclusion of environmental impacts can have on decision-making in public procurement, as well as comparing how this final decision differs from an exclusively LCA-oriented interpretation of the results. The methodology was applied to a relevant construction sector problem modelled with BIM in the city of Lima (Peru). The case study selected is linked to the development of a seismic retrofit strategy for primary schools at a high risk of suffering damage in the event of a high magnitude earthquake. The results of this study are expected to be of utility for public policy support, as well as in terms of showing the applicability of environmental information in the building and construction sector.

2. Materials and Methods

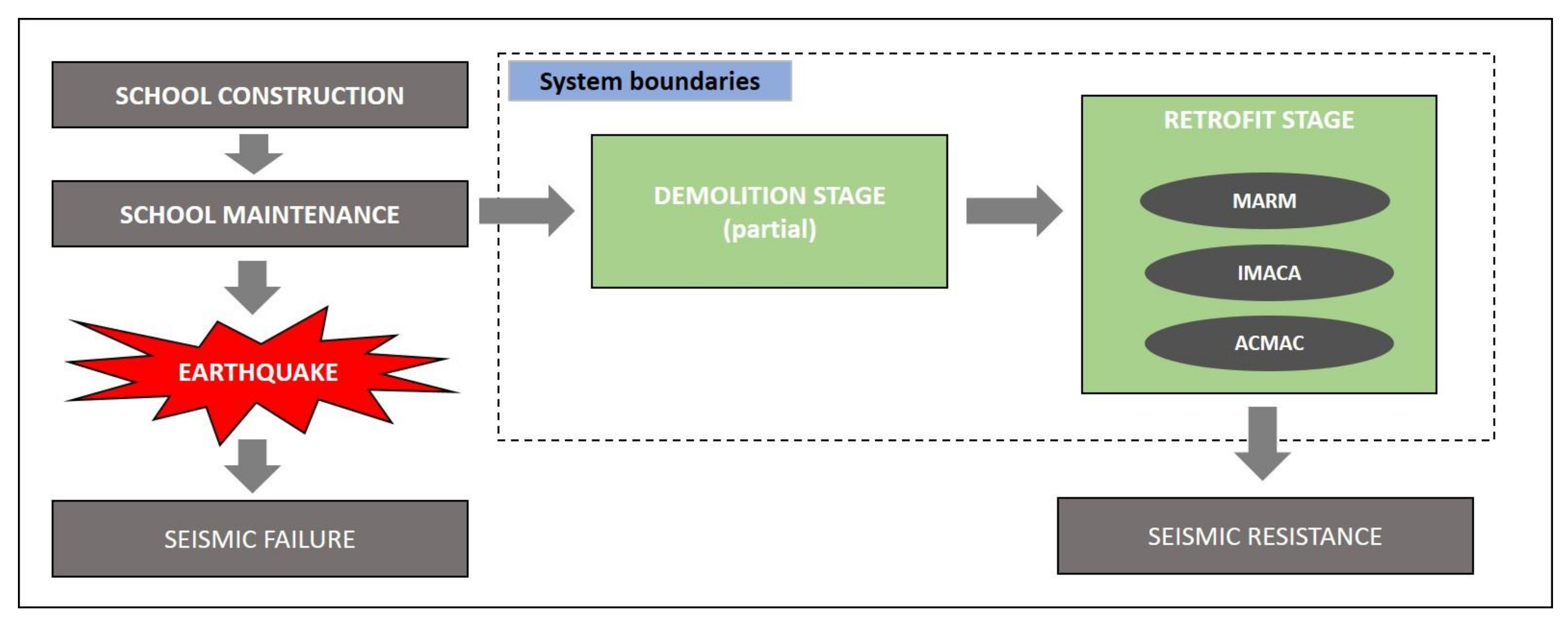

2.1. Description of the Case Study

Educational institutions, namely schools, are critical for the economic and social development of nations. In fact, beyond preparing future generations, these infrastructures are used for other purposes, such as polling stations or recreational areas for the local community outside the official timetable. Therefore, these infrastructures need to be continuously monitored for refurbishment to adapt to new technologies and to maintain their utility for society. In certain areas of the world, these buildings are also considered critical in the event of natural disasters (e.g., floods or earthquakes), being the pivotal centers for initial disaster response [32].
In the specific case of Lima (Peru), which is located in an area subject to devastating earthquakes due to the subduction of the Nazca plate [33], schools are considered essential buildings by seismic legislation [34]. In this context of high seismicity, the population of Lima has nevertheless increased abruptly owing to massive immigration from rural areas ever since the mid-1970s, especially in the years of terrorism, greater life expectancy, a sharp reduction in infant mortality, and the lack of major seismic events in this period [35]. This led to an augmentation of the city’s population from 3.1 million people in 1972 to 9.2 million in 2017 [36]. This increase in turn led to a tumultuous urban sprawl, in which new districts were created from scratch with scarce public services. Consequently, from an educational perspective, the government of Alberto Fujimori in the period 1992–1998 developed an ambitious policy to build over 15,000 schools in the metropolitan area of Lima. At least one school was inaugurated every day in that period, allowing the Peruvian capital to lower its infrastructure deficit, with positive effects in terms of school attendance for children [37]. However, most of these schools, which are still currently operational, show critical deficiencies in their structure, far from meeting the standards of current Peruvian anti-seismic regulations [38]. More specifically, these buildings suffer from short-column shear failure, a structural failure that consists of slender columns partially restrained by infill walls [39]. In other words, in the event of a magnitude 8.0 Mw earthquake, most of these schools would suffer significant structural damage, with some even collapsing, posing a threat to infants’ and teachers’ lives [40,41]. Moreover, an event of these characteristics would seriously damage the disaster response system of the city, which relies on schools for sheltering [32,34].
Recent efforts by the Peruvian government, however, are trying to reduce the vulnerability of these infrastructures by drawing up an ambitious plan to retrofit these schools to withstand big earthquakes [42]. For this, three different low-cost incremental seismic rehabilitation (ISR) techniques (i.e., steel, concrete and masonry) were developed, all of which were validated in previous studies in terms of seismic resistance and economic values [38,43]. The retrofitting techniques applied aim at avoiding the fragile failure mechanism of short column, while increasing stiffness, strength, and ductility of the structure in the longitudinal direction in the event of an earthquake. The strategy adopted did not consider the use of seismic insulators, but rather a retrofit based on strengthening with conventional materials. This implies that the ISR techniques selected do not necessarily comply with the current seismic standards, but do allow to reinforce a wide range of older buildings and constructions. The rationale behind this exclusion was the need for the retrofit strategy to be massive, targeting thousands of schools (>15,000) throughout the nation at competitive prices and in a relatively short window of time. Therefore, there is a need to implement a building strategy that is well-known in the construction sector. In addition, ISR techniques allow avoiding full detainment of school activities and the use of temporal classrooms.
The original 780-PRE schools consist of reinforced concrete frames with infill masonry panels in the longitudinal direction (0.13-m thick) and confined masonry walls with reinforced concrete frames in the transversal direction. All these schools have a similar structure: two-story building, with 3 classrooms in the lower level, and another 3 classrooms in the upper level [38].

2.1.1. Reinforcement of Columns and Infill Masonry Walls with Steel Mesh (MARM)

The first retrofitting technique consists in placing confined masonry walls on each side of a principal column by jacketing these elements through welded steel mesh, creating a compound wall [38]. The retrofit is performed in two stages. First, the strengthening of four columns is done in both stories. Thereafter, two more columns are retrofitted to finalize the process.

2.1.2. Incorporation of Steel Bracings (ACMAC)

The second retrofit technique implies the use of steel frames with concentric bracings, which are added to the structure. The bracings are welded to the frames, which are connected to the reinforced concrete through shear connectors. In a first stage of the retrofit, two steel beams are place in each axes of the first story. Accomplishing this action, however, does not improve the strength of the second story, so the retrofitted structure barely gains resistance. Therefore, a second stage is executed which consists of placing a final steel frame in the second story, which improves the overall performance of the structure [38].

2.1.3. Frame Reinforcement and Incorporation of Reinforced Concrete Walls (IMACA)

The third retrofit technique, referred to as IMACA, consists in strengthening three continuous columns of the longitudinal axes, increasing the central column size and turning adjacent columns into concrete walls. This technique requires the reinforcement of the footings of the columns due to the increase of axial forces for the seismic action. In the first phase, only one frame will be strengthened, and the back frame will be strengthened in a second phase [38].

2.2. Methodological Framework

Guaranteeing the safety of primary students during a seismic event should the event occur in school hours is critical. However, there are additional benefits from this action, including the importance that these venues have in sheltering citizens in the aftermath of a seismic event [44]. Considering that the main parameter that must be enforced in retrofitting these schools is covered by the ISR techniques abovementioned, the question that remains to be answered is linked to the choice of one of these three techniques based on auxiliary parameters, which can include economic, logistic, social, and environmental indicators, among others.

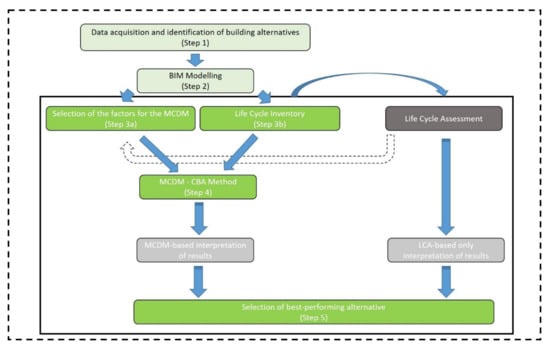

In this sense, Figure 1 presents a graphical representation of the methodological framework used in the current study. Step 1 is a preliminary step in which information is collected and the different building techniques are identified. Thereafter, a second preliminary step (i.e., Step 2) was conducted that consisted of the BIM modelling. The BIM modelling, which is described in Santa Cruz et al. [42], served as the benchmark to obtain the quantity take-off (i.e., bill of materials) that was used in the study. This leads, already within the current operational framework, to the definition of additional criteria in the MCDM (Step 3a) through the participation of stakeholders, but also to a clear computation of the foreground system in the life cycle inventory (LCI) in the LCA (see Step 3b).
Once Step 3b is finalized, the life cycle impact assessment (LCIA) can be conducted through the LCA software selected in order to perform an exclusively LCA-oriented interpretation of results. In contrast, the LCA results can be used in Step 3a to expand the number of additional criteria in the CBA method. The amount of environmental indicators, usually referred to as impact categories, will depend on the choice of LCA practitioners, but can be presented in different ways, as will be discussed below.
Finally, the CBA method is modelled in a decision matrix in order to identify the most appropriate building technique (Step 4), allowing an alternative decision process that not only includes environmental criteria, but also a wider range of parameters.

2.3. BIM Modelling

BIM is defined as the digital representation of the physical and functional characteristics of any built object, constituting a reliable basis for making decisions (ISO, 2018). It is used to describe tools, processes, and technologies that provide documentation and digital construction models of a project, including its entire life cycle [45,46]. Hence, BIM allows the management of these digital representations, creating long-term value and promoting innovation [47].
In parallel, the definition of virtual reality is based on concepts that refer to the sensation of being in an environment, generated by natural or mediated means [1,48]. In this context, immersive virtual reality (IVR) and non-immersive are mainly differentiated by the level of presence or immersion that is enhanced through stereoscopic visualization and other resources [49]. IVR and BIM models have proven to be appropriate tools to improve visualization and understanding [49,50]. In fact, in recent years, successful meetings with stakeholders have been implemented in Peru to analyze the construction processes and select the best alternative by coupling BIM and CBA [51,52], and also integrating IVR, BIM, and CBA [53,54].
As aforementioned, although BIM automates and connects the stages of the design process, providing information for data storage, there are still limitations with other databases (e.g., life-cycle databases), since it is necessary to manually enter the embedded life cycle impacts of the construction materials [55]. Despite this constraint, certain studies have shown that coupling LCA and BIM makes it possible to identify environmental critical points and their mitigation, demonstrating that an automated link between LCA and BIM can be achieved when technical, organizational, and informational issues are overcome [56]. Considering that studies coupling BIM and LCA have mainly focused on manual or semi-automatic solutions in the initial design phases, there is a growing trend toward automatic compilation of data exchange [57]. Consequently, it is necessary to develop comprehensive frameworks to assess different sources of uncertainty and variability for BIM-LCA models.
In the current study, as detailed below, the LCA and CBA workflow that supports BIM construction is presented and analyzed in detail as applied to a retrofitting project in Peruvian schools.

2.4. Life Cycle Assessment

2.4.1. Goal and Scope

LCA is an internationally standardized methodology to analyze the life-cycle environmental impacts that occur in a production system [21,22]. Its use in the building sector has grown substantially in recent years [58,59], and has proved to be of great use in understanding the case-specific environmental profile of building projects [60]. In contrast, its application to policy is lagging given the heterogeneity of the sector, as well as the multiple methodological perspectives that can be applied within LCA [61]. In the current study, the use of LCA was considered to be the most appropriate environmental management tool to establish a comparative evaluation of the environmental profile of three alternative retrofit techniques with similar seismic performance.
The function of the production system was considered as an anti-seismically prepared school building that complies with the current Peruvian anti-seismic code for this type of infrastructure. Therefore, the functional unit (FU) was fixed as the demolition and construction intervention to retrofit a 780-PRE school in the city of Lima (Peru). The system boundaries, as shown in Figure 2, included two main stages. On the one hand, the demolition stage, which included the disposal of the demolition waste in a sanitary landfill in the region of Lima. On the other hand, the retrofit phase, which included all the operations needed to upgrade the schools until they met the seismic standards enforced, as well as all the upstream processes in terms of transport, machinery, or raw materials.

2.4.2. Data Collection and Life Cycle Inventory

Data were gathered from an array of bibliographical sources. Having said this, an important portion of the primary data were obtained from the BIM 3D model, as described in Santa-Cruz et al. [42]. This allowed using automated and auditable high-accuracy estimations of the quantity take-off needed for the three ISR techniques.
On the one hand, for the demolition stage, the main data linked to the demolition process were taken from BIM. These data, which can be observed in Table 1, included the demolition volumes, which were highest for the IMACA technique. Transport of the demolition waste was modelled considering an approximate distance of 50 km from a given educational institution to the landfilling site, and heavy duty tipper trucks with a capacity of 6 m3 of waste. Moreover, particulate matter formation (PMF) due to the demolition, loading and unloading, as well as the transport of the demolition waste, were modelled based on the AP-42 standard of US EPA [62].
On the other hand, inventory data for the retrofit stage included the main raw materials used in the construction process, the energy needed in the construction process (both obtained from BIM), as well as the transport distances from the local suppliers of these products. Background data for the modeling of upstream flows in the production system were retrieved from the ecoinvent v3.4 database [63]. However, the production of cement and concrete was based on the data provided by Peru LCA, the Peruvian LCA database [64,65]. Electricity production life cycle modelling was obtained from [66].

2.4.3. Life Cycle Impact Assessment

The life cycle impact assessment (LCIA) stage was conducted by selecting three different metrics to report environmental burdens. First, greenhouse gas (GHG) emissions were computed using the IPCC 2013 assessment method. The selection of this impact category was based on the importance of climate change metrics in current environmental decision-making [67], especially considering the commitment of Peru to mitigating its GHG emissions by 2030 in the frame of the Paris Agreement [68].
Second, a second impact category considered in the study was fine particulate matter formation (FPMF), using the ReCiPe 2016 v1.02 midpoint method. This category was selected considering the urban conditions in which the schools are located, as well as the hyper-dry climate conditions in Lima, where annual average rainfall is below 15 mm [69], fostering a greater prevalence of particulate matter in the lower air column.
Finally, given the holistic nature of this study, an endpoint impact category, human health damage, was applied using the ReCiPe method aforementioned [70]. It should be noted that this endpoint category includes the damage caused by the environmental impacts of climate change, FPMF, and six additional impact categories: stratospheric ozone depletion, ionizing radiation, ozone formation, human toxicity (carcinogenic and on-carcinogenic), and water consumption.
All life-cycle modellings were carried out using the SimaPro v8.5.2 software [71].

2.5. Choosing by Advantages

The CBA method, as aforementioned, is an MCDM method that has gained relevance in recent years, owing to its perspective of differentiating the available alternatives by summarizing their advantages [7]. Moreover, CBA introduces the subjective decision-making part at the end of the pipeline through weighing the importance of the advantages identified [13].
For a CBA to be applied, a set of alternatives must be present in the decision-making process. In the current study, these alternatives are represented by the three retrofit techniques. Thereafter, a set of factors are identified, which are defined as the parameters of each alternative that influence the decision. These factors may be of completely different nature, including social or environmental issues, among others. Table 2 presents the factors that were selected in the study, which include social, transparency, and environmental dimensions. It should be noted that seismic performance was not included within the factors considering that all three ISR techniques perform similar and no advantages would be established between them. A following step within the CBA method is to define a criterion that describes how a particular factor should be interpreted. Thereafter, a fourth step implies the quantification of each factor, and what their attributes are named, which will lead to the definition of the respective advantages in each factor [7].
The final step needed to obtain the results to compare the alternatives consisted of a collaborative workshop with the participation of stakeholders from the different stages of a construction project. As described in Santa-Cruz et al. [42], invited stakeholders included representatives from professional societies (e.g., National Associations of Engineers and Architects), local governments (e.g., municipal authorities), education boards as users of these constructions, academia and authorities responsible for supervising risk management policies and plans. Workshop participants were, thereafter, divided into four groups of 8–10 people. These groups were not homogeneous, and based on the individual profile of the group member, three different group profiles were identified, as shown in Table 3.
Each group was led by a moderator linked to the research study to clarify doubts regarding the workshop dynamic, explain the details of the project, and articulate the methodology to quantify each factor. Consequently, each group provided consensual weights for each factor, which eventually led to the definition of the respective advantages in each sector. The weighting of the importance of advantages (IoAs) corresponds to a value that is given for each factor for each alternative. By adding the IoA for all factors considered, the decision-maker obtains the total importance of a given alternative and can compare the result to that of other alternatives [7]. It was left to the discretion of each working group to decide on the specific value that represented the differences between the two alternatives.

2.6. Sensitivity and Uncertainty Analysis

It should be noted that the data quality utilized made it possible to use primary data for the production of cement and concrete in Peru [64], whereas no local data were available for the other two materials. Hence, considering the variability of data quality in terms of geographical correlation, a stochastic assessment was conducted using the Monte Carlo (MC) simulation. For this, pseudo-random values (1000 iterations) for each data point present in each of the three production systems were generated following their probability distribution calculated with the Pedigree matrix [72,73]. The MC simulation function in the SimaPro software was used to carry out this computation.
A sensitivity analysis was conducted in the CBA method to identify to what extent the decision-making process is susceptible to changes in the final decision based on methodological choices. For this, regardless of the baseline scenario, which represents the modelling process undergone by workshop participants, three additional scenarios were simulated in which certain environmental factors were eliminated (see Table 4). Moreover, it should be noted that beyond the IoAs values used in the workshop, two alternative computational processes were modelled. On the one hand, weighting was performed considering the advantages per category rather than per factor. On the other hand, a final perspective considered the calculation of the IoA values applying a linearity principle of the advantages.

3. Results and Discussion

3.1. Environmental Impacts of the Three Retrofit Techniques

The deterministic environmental impact results obtained for the three retrofit techniques show that, regardless of the environmental indicator analyzed, MARM appeared to be the best performing alternative. For instance, in the case of GHG emissions, the total emissions per FU for this alternative were 24.33 t CO2eq (see Table 5), 49% lower than for IMACA (47.63 t CO2eq) and 77% as compared to ACMAC (101.2 t CO2eq). Interestingly, ACMAC proved to be the best-performing alternative when the demolition stage was analyzed independently, given the lower interventions needed in this process. In contrast, reinforced steel frames and bracings appeared to be the material with the highest environmental impact, representing 84% of total GHG emissions in ACMAC.
Results from the stochastic assessment of MC simulation, as shown in Figure 3, strengthen the tendencies that were presented above from a deterministic approach, since ACMAC appeared as the least favorable option when compared to MARM and IMACA, respectively, in 100% of the iterations. Moreover, when MARM and IMACA were compared, 100% of the iterations showed a better environmental performance for MARM, which demonstrates the stratified results of this study from an environmental perspective.
If the results are analyzed on a global scale, considering the approximately 15,000 schools that are in need of these retrofit operations, the benefits of selecting the MARM technique rather than the ACMAC option would translate into a mitigation of up to 1.13 Mt CO2eq, which is ca. 1.5% of the target reductions in 2030, a remarkable amount for a country that is currently revising its strategies to improve its commitments in the frame of the Paris Agreement [68]. In fact, the nationally determined contributions (NDCs) presented by Peru already consider certain climate mitigation actions linked to the building sector (i.e., reduction of GHG emissions in the cement industry). Hence, we argue that end-of-pipe mitigation actions in the construction process that do not only consider the production of building materials, but also the appropriateness of selecting certain materials instead of others, could be an important strategy to enhance climate policies in the Peruvian construction sector, especially at a moment in which, despite the long tail of the pandemic, major international actors (e.g., the United States or the European Union) are pushing for further cuts in GHG emissions by 2030 [74]. All in all, from an environmental perspective, it appears that the benefits of selecting the MARM option over the other two techniques imply substantial gains provided that significant trade-offs do not occur in other impact categories, an issue that does not seem to occur when other human health-related categories are assessed (see Table 5).
In this context, the two additional impact categories assessed do not show any trade-offs with similar patterns across the three retrofit techniques. On the one hand, in the case of FPMF, the results follow a similar trend to those observed for climate change, with ACMAC showing the worst performance of the three alternatives with a total emission of 167.5 kg PM2.5eq per FU. For IMACA the emissions of particulate matter were substantially lower, adding up to 54.51 kg PM2.5eq per FU, whereas the lowest values were obtained for MARM (28.01 kg PM2.5eq per FU). Interestingly, the greater portion of the FPMF emissions occur in the retrofit stage, mainly due to upstream processes in the production of the materials used during the construction process, as well as the emissions linked to transport. Therefore, although on-site particulate matter due to demolition and loading of demolition waste was found to be lowest for the ACMAC scenario, from a life-cycle perspective results showed this technique as the least recommended. However, the lack of appropriate models to estimate the particulate matter emitted in the demolition stage may be underestimating the relative contribution of this intervention within the system boundaries of the three techniques assessed [75,76]. On the other hand, for damages to human health similar trends were identified, as seen in Table 5, with disability-adjusted life years being 85% lower for MARM than that for ACMAC, strengthening the fact that by aggregating a wider range of midpoint impact categories in this endpoint category, the decision would remain unchallenged from an LCA perspective.

3.2. Integrating Environmental Impacts in CBA

When the LCA results are integrated in the CBA method, a set of weights are given to the different factors (see Table 2). More specifically, three of these factors represent each of the impact categories used in the LCA. The weights, as observed in Table 6, vary depending on the average values given by the members of each workshop group. Groups 1 and 3, whose members present an environmental profile (see Table 3), showed an increased importance of environmental factors (42% and 52%, respectively), as compared to groups 2 and 4, in which environmental factors represented the lowest aggregated weights as compared to the economic and transparency categories.
Once the IoAs are included in the decision matrix, as shown in Table 7, it is observed that the IMACA technique ranks lowest in all the scenarios that were performed. In contrast, there are two different tendencies when the other two techniques are compared. On the one hand, final results for the baseline scenario in groups 1 and 3 provide a final advantage to the MARM technique, although the advantage with respect to ACMAC for Group 1 is very low, which does not allow a clear interpretation of the results. On the other hand, the results for groups 2 and 4, show a clear advantage for ACMAC.

3.3. Comparison of the Two Decision-Making Perspectives

When the two perspectives are compared, the decision that is taken differs substantially. In this sense, when an LCA-only perspective is considered based on the environmental metric selected, MARM appears as the clear choice to be taken, which ultimately leads to an important mitigation of environmental impacts. In contrast, the CBA method presents two possible decisions depending on the profile of the experts that participated in the workshop. On the one hand, when experts in environmental sciences were present in the workshop tables, a higher weighting was given to the environmental criteria, which led these groups to select the same decision as the LCA-only perspective (i.e., the MARM retrofit technique). However, teams with a higher proportion of government members were inclined to foster alternatives that imply less bureaucratic barriers. In this case, the best performing option, ACMAC, happens to be also the choice with the highest environmental impacts, four-fold more than MARM.
Considering the total number of factors included in the MCDM matrix, it could be argued that the number of environmental factors included in the study (3) is relatively high. Therefore, the fact that MARM performs well in workshop tables with environmental specialists could be due to two different reasons: either the prioritization of environmental aspects in these tables, or the fact that a large number of environmental indicators were included in the MCDM procedure in the first place. To answer this question, a sensitivity analysis (see Table 4 in Section 2.5) was conducted in order to assess how the elimination of certain environmental criteria could affect the overall interpretation of the results.
The opposing results observed in Table 8 lead to an interesting situation in which the two divergent views lead to the selection of either the best or worst environmental option out of the three assessed. On the one hand, it is interesting to observe that in Scenario 1, in which human health damage is left as the only environmental indicator, ACMAC is the preferred option for all groups. This occurs for Group 1 also in scenarios 2 and 3, regardless of the computational process modelled. In contrast, results in Group 3 show a better performance of MARM in scenarios 2 and 3.

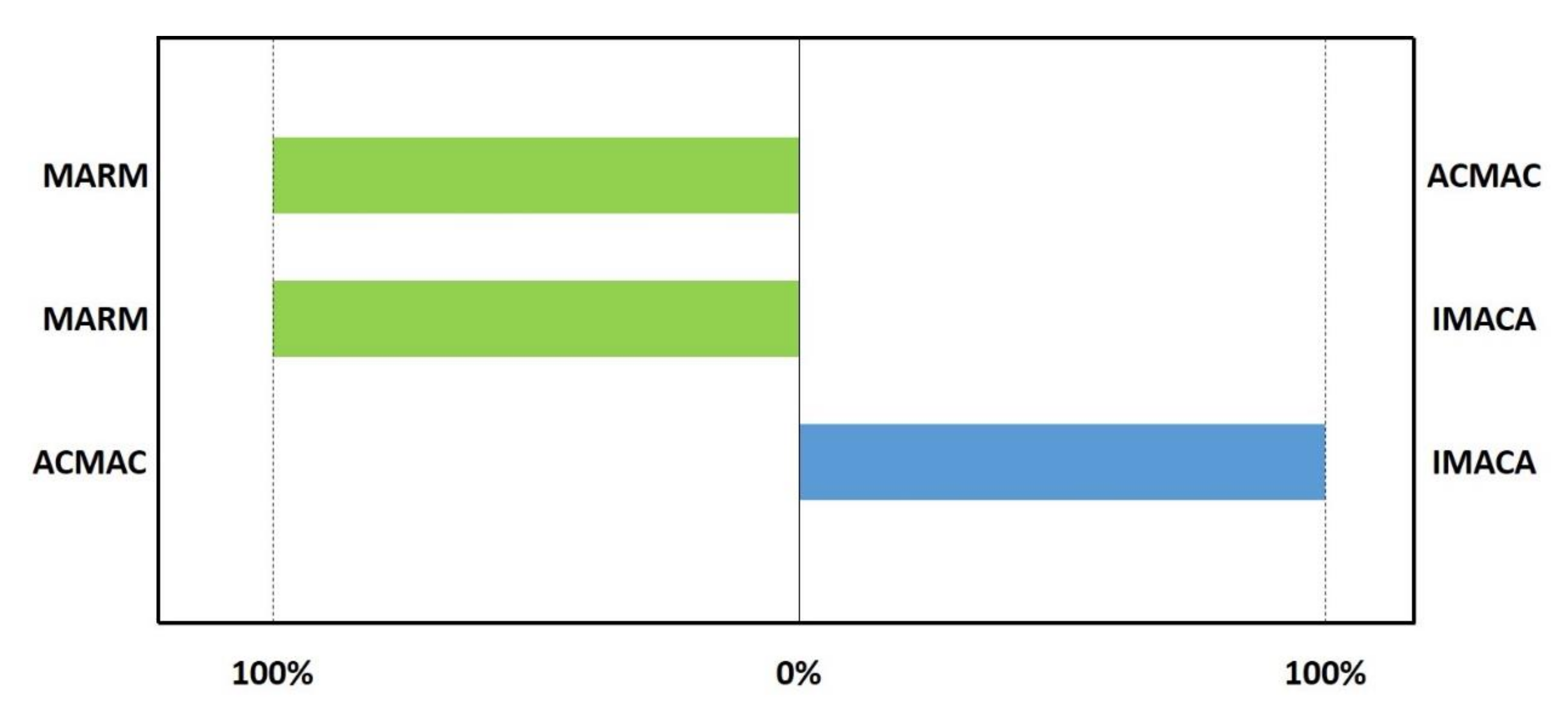

When these results are crossed with the weights shown in Table 6 a high disparity is visible between groups, with a two- or three-fold increase in total weight in environmentally prone groups as compared to groups 2 and 4. We argue that these divergences are, to a certain extent, linked to the lack of a robust framework in which environmental indicators should be included in public procurement in Peru [77]. Although green public procurement (GPP) is being steadily incorporated to promote the definition of environmental requirements in public procurement [78], by using scientific and verifiable criteria [79], its proliferation in LA&C countries is still scarce.
The Peruvian Government has recently begun to promote the use of GPP in a process steered by the Ministry of Environment [80], in which environmental requirements are established and included in product- or service-based guidelines for public procurement. The idea of these mechanisms, which are named Fichas de Homologación, is to provide a set of homogeneous technical criteria for a given product. Based on the results obtained in Table 8, however, it appears that environmental advice in these guidelines could collide with transparency, economic, and social factors.
Hence, we argue that different approaches can be followed to include environmental criteria in GPP strategies. First, results shown in Section 3.1 would steer the decision towards the use of the MARM alternative. While LCA practitioners and other environmental scientists would be eager for this approach to be used, it would imply an important shock to the way public procurement is currently being implemented in a country like Peru. Moreover, a series of barriers, such as lack of environmental knowledge and awareness, capacity building [78], and other motivational, operational, or economic factors [81], would probably reduce the effectivity of this approach, despite the succulent GHG emission reductions that have been theoretically modelled for this particular case study.
A second approach, as shown in Section 3.2, can be seen as a more hierarchic and balanced perspective, in which environmental criteria are integrated in a wider decision-making scheme. This mechanism enhances communication between different stakeholders and provides a less abrupt path toward including environmental aspects in public procurement. However, if environmental stakeholders are not correctly represented, or environmental factors included in the MCDM are not clear or excessively complex, the success of this pathway could be limited. For instance, as seen in the current case study, the profile of the stakeholders in each group or the addition or elimination of criteria can have an important impact on the final results.
A final option, which can be combined with the previous one, implies that rather than using LCA directly to select the alternative with the lowest environmental impact, environmental impact reductions may be attained through a higher level of transparency in the procurement process, in which suppliers demonstrate that they are reporting their environmental impacts and pushing forward actions to reduce their environmental footprint. Under these premises, suppliers would be nudged to implement environmental impact improvement actions regardless of the construction alternative chosen to retrofit the schools. While this alternative does not guarantee that the most environmentally favorable options are considered in the decision process, it may foster research and innovation mechanisms [82,83] that allow attaining environmental improvements in all construction processes.
In any case, the inclusion of environmental impacts and indicators in (green) public procurement must be promoted based on the common standards and/or guidelines that can allow the implementation of environmental policy to public purchases [84]. Beyond the scope of the case study presented, an interesting option to explore, which is being endorsed by the European Commission, is the creation of Product Environmental Footprint Category Rules (PEFCRs). These aim at delivering a comprehensive selection of environmental impacts that adequately and consistently represent the environmental profile of a given product or process [85,86]. Unfortunately, these guidelines are yet to be implemented on a wider scale in LA&C, and cannot be coupled with public procurement unless the product category exists [87]. Consequently, it is plausible to assume that the implementation of these environmental reporting and verification mechanisms in LA&C will be delayed. Hence, in the meantime, we argue that the methodological mindset suggested in this study can serve as an interesting proxy to offer governmental agencies robust environmental data and results through which they can include environmental considerations in (green) public procurement.

4. Conclusions

Including environmental assessment metrics in the decision-making process to compare a set of three retrofit techniques for schools allowed the visualization of substantial differences in terms of environmental burdens between them. An initial LCA-oriented assessment, which was supported by MC simulation, revealed a situation in which the masonry-based technique (i.e., MARM) showed significantly lower environmental impacts than the remaining two options. However, when a wider range of technical, social, and transparency criteria are added to the environmental indicators, this ISR technique only prevailed in those workshop tables in which environmental experts were present and under specific computational assumptions (The Ministry of Education decided to implement the ACMAC technique as a pilot study to reinforce a school in Lima in August 2020 [88], considering that it proved to be the best-weighted regarding auditability and transparency criteria). Either way, we have aimed to establish a method that allows stakeholders to mitigate risk by adding better environmental impact practices in the decision-making process. In fact, considering low-carbon alternatives in seismic retrofitting activities is expected to have an important role in mitigating environmental impacts in high seismic activity areas, such as most of the Peruvian territory.
We argue that the results from the case study constitute an important milestone when it comes to including environmental factors in public procurement in Peru and more generally in LA&C. However, for LCA-oriented results to make their way consistently into policy decision-making in Peru, legislation and standardization guidelines are necessary. Bearing in mind that the window of time for these legislative actions to be in place could be considerable, the two alternative methodologies proposed in the current study (i.e., direct LCA results or LCA results included in an MCDM matrix) appear as appealing options to push policy decisions based on environmental factors forward. Therefore, we suggest that future research should focus on improving the governance that would allow more robust legislation to foster GPP, especially for projects in the construction sector that use BIM, since its use will slowly become compulsory in Peru and other countries in LA&C in upcoming years.

Author Contributions

Conceptualization, X.B. and I.V.-R.; methodology, I.V.-R.; software, C.C.-A. and S.S.-C.; validation, X.B., I.V.-R. and S.S.-C.; formal analysis, I.V.-R.; investigation, C.C.-A.; resources, S.S.-C.; data curation, C.C.-A.; writing—original draft preparation, I.V.-R.; writing—review and editing, I.V.-R., X.B. and S.S.-C.; visualization, I.V.-R. and X.B.; supervision, X.B. and S.S.-C.; project administration, S.S.-C.; funding acquisition, S.S.-C. All authors have read and agreed to the published version of the manuscript.

Funding

This research was partially funded by the Consejo Nacional de Ciencia, Tecnología e Innovación Tecnológica del Perú, according to the Convenio de Gestión N 232-2015-FONDECYT.

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Acknowledgments

Kurt Ziegler-Rodriguez is thanked for his support with the life cycle modelling.

Conflicts of Interest

The authors declare no conflict of interest.
