Risk Severity Matrix for Sustainable Public-Private Partnership Projects in Developing Countries

by
Shabir Hussain Khahro
1,*,
Tauha Hussain Ali
2,
Shafiqul Hassan
3,
Noor Yasmin Zainun
4,
Yasir Javed
5 and
Shahbaz Aziz Memon
2
1
Department of Engineering Management, Prince Sultan University, Riyadh 11586, Saudi Arabia
2
Department of Civil Engineering, Mehran University of Engineering & Technology, Sindh 76062, Pakistan
3
College of Law, Prince Sultan University, Riyadh 11586, Saudi Arabia
4
Faculty of Civil Engineering & Built Environment, Jamilus Research Center, Universiti Tun Hussein Onn Malaysia, Parit Raja 86400, Malaysia
5
Department of Computer System, College of Information Technology, Prince Sultan University, Riyadh 11586, Saudi Arabia
*
Author to whom correspondence should be addressed.
Sustainability 2021, 13(6), 3292; https://doi.org/10.3390/su13063292
Submission received: 31 January 2021 / Revised: 10 March 2021 / Accepted: 12 March 2021 / Published: 17 March 2021

Abstract

:
The concept of a Public-Private Partnership (PPP) is not new for developing countries, although many initiatives are being contemplated for potential implementation. This paper evaluates the crucial success factor for the effective execution of PPP projects and it also investigates the appropriate distribution of the risks involved in PPP projects. Quartile analysis of features has been made after a detailed literature review for risk identification. The risk severity analysis is done using a quartile assessment. The data is collected from various contractors working on PPP projects in Pakistan. The comparative analysis has been conducted using available research work on PPP in developing countries. A risk severity rank model is created using 47 key risks in PPP projects for developing countries. Finally, the top risks identified by this research are compared with the previous studies conducted in China, India and Egypt. It is concluded that inflation, revenue risk from end-user, foreign exchange fluctuation, political situation, law and order, and corruption are the major risks in developing countries for better management of PPP projects. Most of the PPP projects are public-oriented. The society of any city is directly affected by most PPP projects. This paper presents the identified key risks of PPP projects in developing countries which are mostly financial and public-oriented. This work will support the PPP concept significance, meeting United Nations Sustainable Development Goal (SDG) 8 and 11. Recent countries’ political and economic circumstances and sustainability have transformed PPP ventures into a successful way to support the governments to develop roads, energy and facilities through private partners’ financial and technological capacities. Although PPP is used worldwide, its effective utilization in developing countries is still lacking. This paper is an enhancement to its successful use of the PPP domain for developing countries.

1. Introduction

Throughout recent years, the Public-Private Partnership (PPP) has evolved to be a crucial mechanism for implementing social development projects throughout developed countries [1]. PPP fosters development growth, enhanced operating and building efficiency, growth in the local economy, improved service quality through the integration of private sector skills, experience and knowledge base that has drawn growing attention from politicians, industry practitioners and academics. It is an approach taken to increase the economic value of infrastructure goods and includes a wide range of services in the public sector [2,3]. PPP has grown into a way of providing infrastructure services worldwide. However, as compared to developing countries, most emerging markets have struggled to draw private investment in recent years [4,5]. PPP is a form of private participation in a public project in which the public and private sectors collaborate and work towards a common objective. Two parties assume responsibility for the purchase and delivery of public goods; financing may be either charged or given by the private sector, depending on the particular scope of the project [6]. As a result, PPP has been used in different sectors around the world, particularly in the infrastructure sector, as it is considered a catalyst for economic growth [7]. PPP relates to a complex procurement mechanism in which arrangements are carried out between public and private entities over a wider selection of contractual deals involving a value and/or commodity. The PPP model is popular in infrastructure project development (e.g., roads, tunnels, bridges, etc.) [8,9], as these projects usually involve considerable expenditure, which is a heavy financial strain on most governments, especially in developing countries [10]. PPP effectiveness depends in large part on the efficiency of the tendering process [11].
The PPP is increasingly becoming the preferred form of delivering public services in developing countries [12,13]. In several countries, pressure from the lowering of public debt has prompted their policymakers to include private sector companies in several investments of economic and social infrastructure, such as toll roads, colleges, hospitals, car parks and facilities [14]. Risk management in PPP projects differs radically from conventional public projects where the public sector buys an asset from private sector contractors and consultants whose responsibility is limited to product design and development, and where financial and operational risks remain with the public sector [15,16]. Risk management is a major concern when carrying out a PPP project, particularly in PPP technological infrastructure projects [1,17]. Risk evaluation was one of the most challenging problems of building and PPP [18,19]. Fostering government-investor discussions is essential to an effective risk reduction strategy [20]. Public organizations find forming PPP beneficial but pose unnecessary risks [21]. Developing mega infrastructure cost a lot, and it is very difficult for a country like Pakistan with a very tight budget to meet the requirements and the speed to meet the needs. Given the difficult economic situation, the public sector announced its collaboration with the private sector to take advantage of the private sector’s expertise, financial ability and technical skills, which is why PPP was created. The PPP scheme is thought to be able to provide a better value for money especially for infrastructure projects [22]. Because of its existence, developed and developing countries around the world have broadly embraced the definition of PPP in the past decade and are steadily growing [23]. PPP contracts are of a very complicated nature, and several factors include the performance of PPP ventures. One of the factors that plays a vital role in any PPP project’s performance is risk recognition and its proper (public and private) distribution between the parties. The first step towards a successful risk management framework is to conduct a reasonable risk assessment and risk distribution between the private sector and the public sector in such a way that each party carries with it the risks it can handle better [22]. Therefore, the public sector must contend with some of the risks associated, the private sector must handle other risks and all sides will bear the remaining risks.
PPP contracts are of a long-term sort, and given the contract length, the scope of this contract structure is much greater than most other forms of contracting arrangement [3]. There are other main reasons for the project’s effective completion, such as political environment, law and order situation, financial access, stronger procurement policies, government incentives, capital sector accessible, etc. In developing countries like Pakistan, where the country’s economic condition is not stable enough, it is believed that PPP contracts are the most favorable public goods procurement option. To order to render every PPP initiative a success story, there is a critical need to consider the roots of previous PPP failures. The idea of implementing the PPP in Pakistan was very positive and was intended to be very effective but the lack of regulations, the continuity of policies at the government level and the unequal sharing of risk between the parties restricted the impact of PPP projects in Pakistan [24]. The key purpose of this study is to define the risk factors involved in PPP programs, as well as the partner’s wise risk distribution. [25] notes that good risk control is one of the most critical aspects of PPP project performance. There have been several of the ventures proposed in the past under the framework of the PPP contract program but much of the project was ineffective due to lack of government-level regulations and inadequate risk management. There is an urgent need to recognize and distribute the risks associated with PPP ventures in developing countries like Pakistan to prevent these kinds of problems. Still, the risk allocation and severity model for PPP projects in Pakistan has not been assessed in such detail. In the lack of such a report, evaluating the PPP programs successfully becomes quite challenging for government departments, business staff, etc. An analysis to avoid these problems is needed; the risks involved should be classified in Pakistan’s PPP projects and would be beneficial in determining the extent, and in allocating the risks to the group who can best manage the danger [16].
PPP is becoming increasingly critical in improving the sustainability of society [26]. Since the 1980s the Malaysian government has introduced the PPP plan for infrastructure creation. The literature suggests that owing to a lack of risk management, a variety of PPP projects have struggled to achieve their targets [27]. India is one of the world’s largest PPP markets, with over 1300 major national infrastructure projects [28,29]. PPP reflects an important and tested procurement method for the network. While several countries have implemented PPP for infrastructure development in recent years, not all of the projects were successful. Most PPP failures result from inadequate risk distribution and a lack of knowledge about success factors in countries in particular [30]. Consequently, this study aims to define the risk factors involved in PPP programs and the partner’s wise risk distribution in PPP projects. It also aims to build a risk intensity index to assist stakeholders employed in developing countries’ construction industry in managing PPP projects in general and risks explicitly associated with PPP.

2. Research Methodology

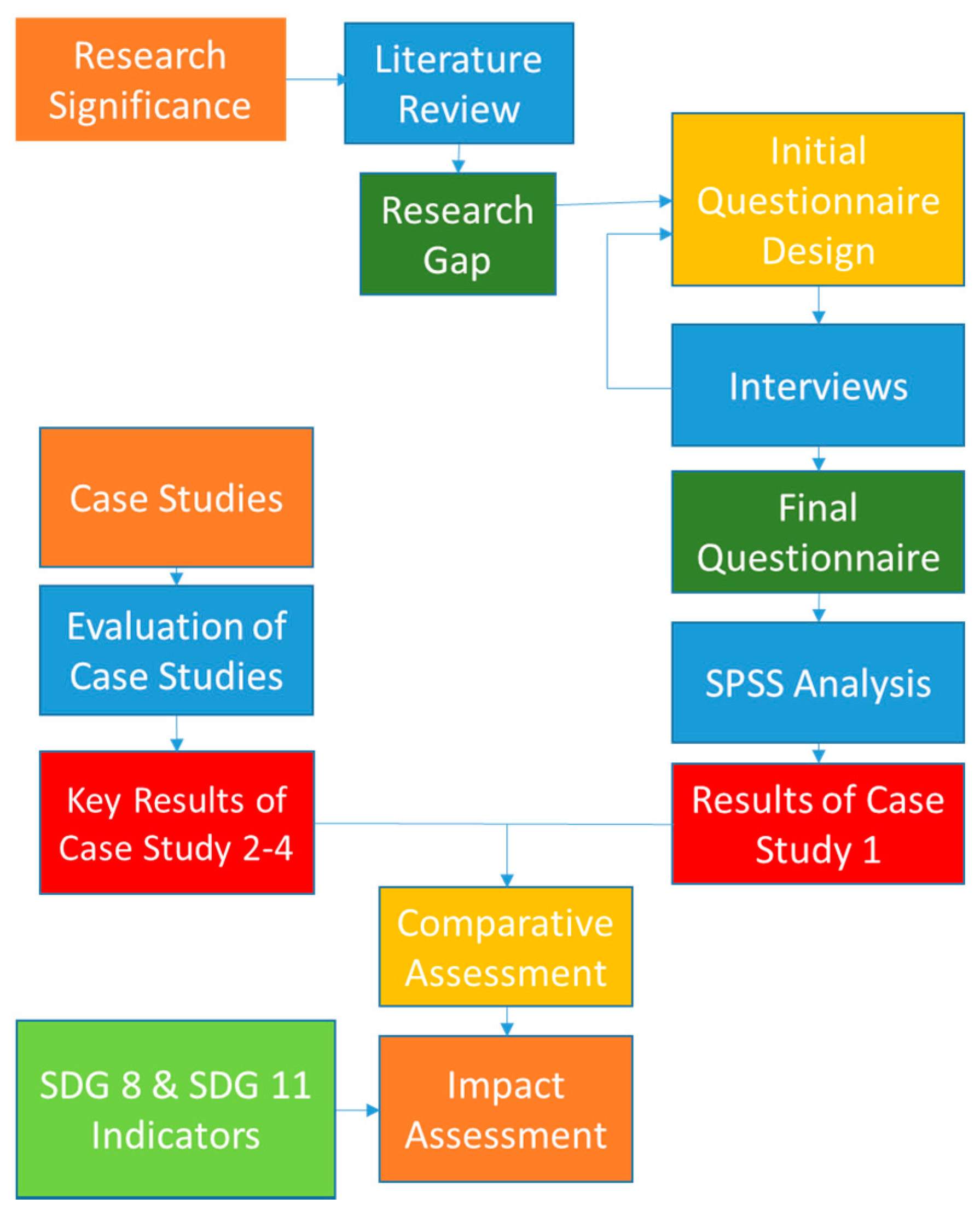

This research has been conducted in three phases. The Delphi approach was adopted to carry this research. In phase one, qualitative analysis was conducted through a detailed literature review followed by unstructured interviews with the experts working on PPP projects. A total number of 53 risk factors were identified in the literature review process. These risks were discussed with five experts currently working on different PPP projects. A list of 47 risk factors was finalized after the expert’s opinion in the unstructured interviews. The interviews were conducted in October 2019. After the expert’s feedback, a final set of questionnaires was designed to get detailed expert opinion working on various PPP projects. The respondents were requested to rank the significance level and impact level of all risk factors using a scale ranging from 1 to 5 where 1 stands for least significant and 5 stands for highly significant risk. A similar approach was applied to the impact scale. A total number of 51 questionnaires were sent in-person, hard post and by email and 42 questionnaires were received successfully. The success recipient rate is 88% which is quite a good response from the experts. The reason behind this lower number is the limited PPP projects and professionals in Pakistan. The data was collected between December 2019 and January 2020.
The data were analyzed in Statistical Package for Social Sciences (SPSS) using various ranking methods and a final rank of the risk is generated. In the last phase, the mapping and risk severity matrix is made and it is finally compared with the recent studies conducted in neighboring countries. The complete research sequence is shown in Figure 1.

3. Data Collection and Analysis

The questionnaire was distributed among 42 professionals working in the public and private sector of Pakistan. As the concept of PPP has only been introduced in recent years, limited professionals are have PPP experience. The number will increase with the increase of projects in the country. Regarding the experience of respondents managing PPP projects, Figure 2 shows the experience of respondents in PPP projects.

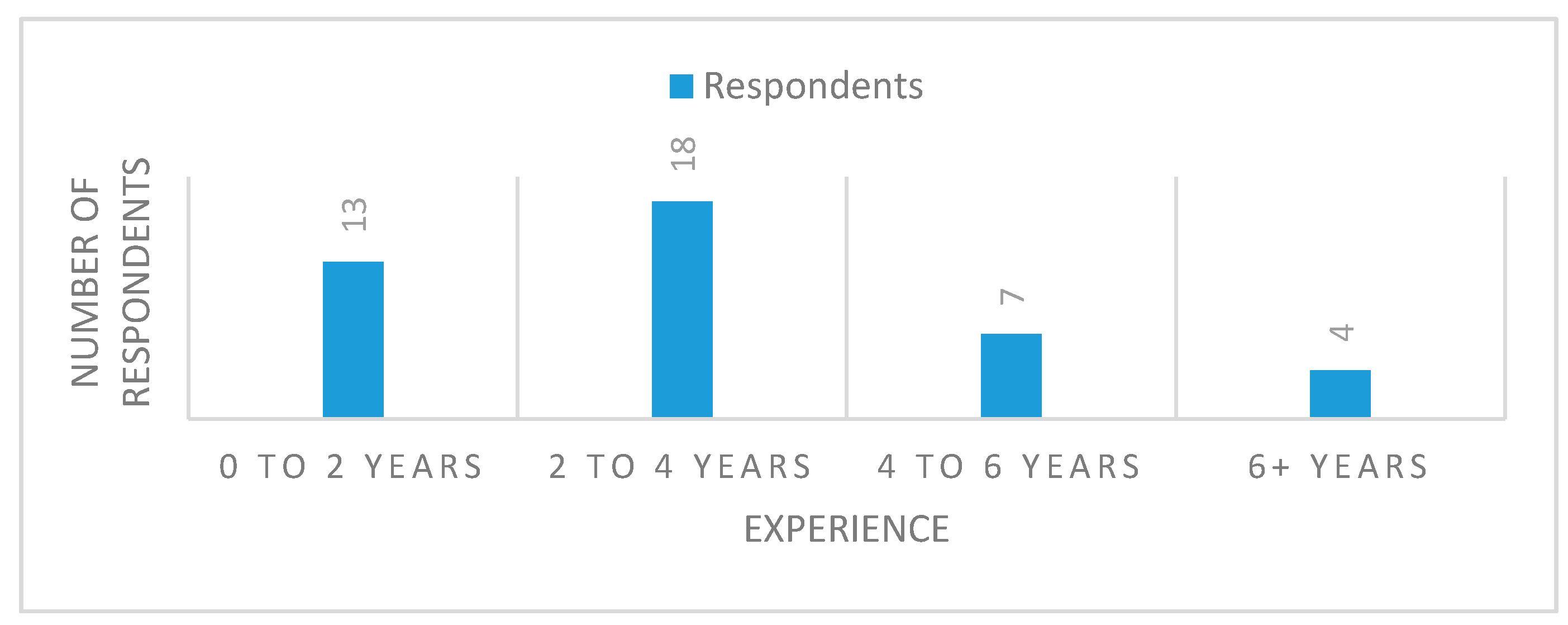

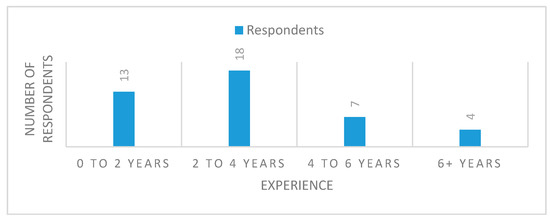

The respondents have experience of PPP projects within Pakistan and other countries including United Arab Emirates, Kingdom of Saudi Arabia, United Kingdom, the Philippines, United States of America, Australia, Canada and Qatar. Of the respondents currently working on various development projects on PPP, the majority had experience in infrastructure projects; along with infrastructure projects, some of the respondents had experience in the education sector, health sector, power sector, etc.

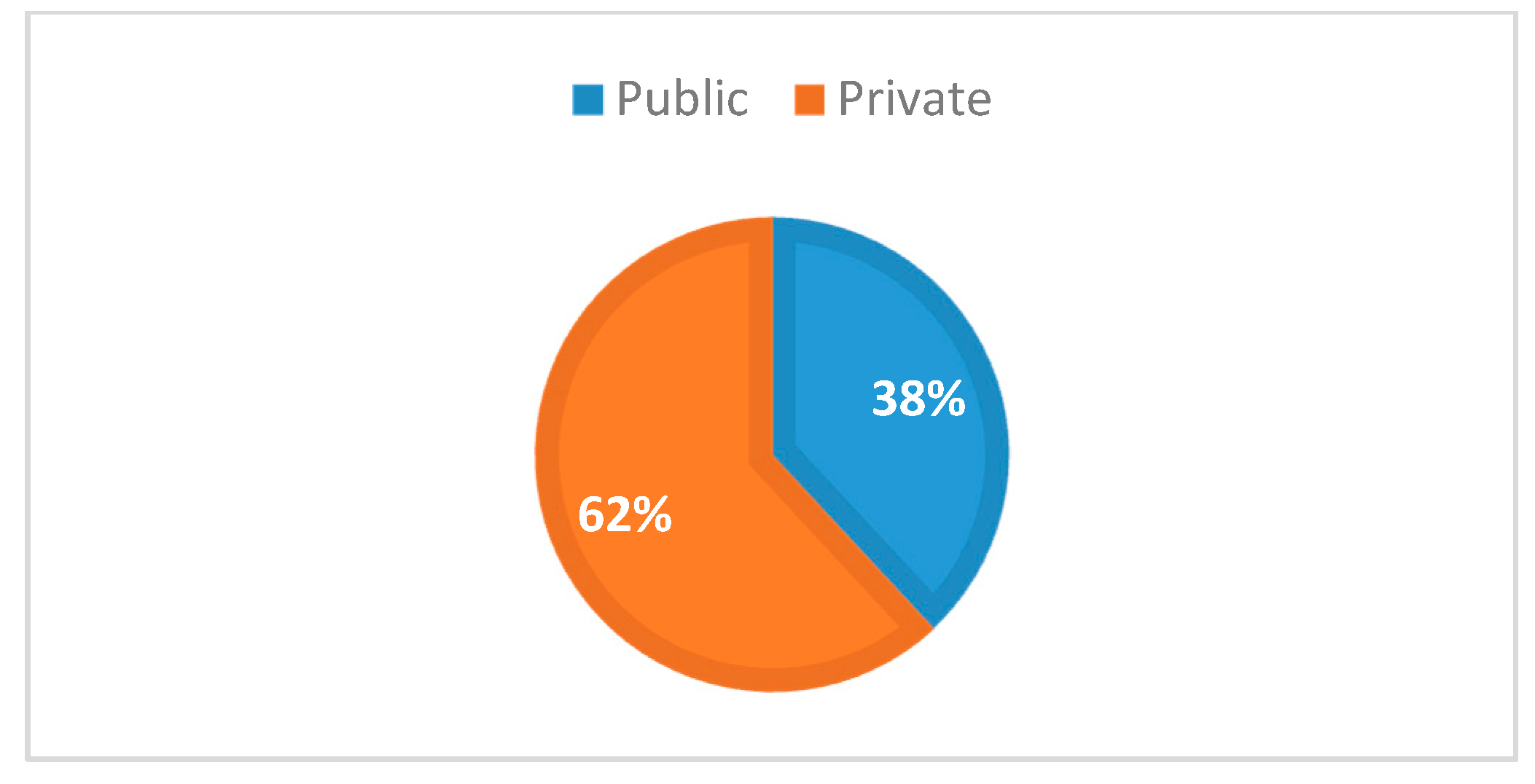

Regarding the domain of respondent’s work, 62% of respondents were working in the private sector while 38% of respondents worked in the public sector, as shown in Figure 3.
All of the defined risks were listed in a 12-category questionnaire. Based on their experience in the field of PPP projects, the respondents were asked to answer the probability as well as the impact of each risk on the Likert scale from 1 to 5, where 1 represents the least likelihood and the smallest impact, and 5 represents the highest likelihood and impact. Each risk has a different likelihood of occurrence that any specific risk may occur whereas each risk has a different impact on the project. One risk may have a higher likelihood but its impact on the project may be low. Therefore, based on this rationale, any risk with a higher likelihood of occurrence and higher potential to impact the project is termed as serious risk whereas any risk with a lower likelihood of occurrence and lower potential to impact the project is termed as less significant risk. The respondents were also asked to determine which party will efficiently bear the particular risk: whether both parties will bear the private party, the public party or the risk equally.

4. Risk Severity Matrix for PPP Projects in Developing Countries

The risk ranking was made on a quadrant assessment approach and the four-quadrant grid is described as follows:
  • 1st Quadrant: High probability, high impact: Risks having probability and impact more than 2.5 were included in 1st quadrant; 1st quadrant risks are actively monitored and are mitigated as soon as they are identified.
  • 2nd Quadrant: Low probability, high impact: Risks having a probability less than 2.5 but the impact of those risks is greater than 2.5 belong to the 2nd quadrant; these risks are examined and proper allocation of these risks can be helpful to minimize their effect.
  • 3rd Quadrant: High probability, low impact: Risks having a probability greater than 2.5, but the impact of those risks is less than 2.5 are included in the 3rd quadrant; an eye is being kept on these type of risks and the occurrence of these risks is minimized.
  • 4th Quadrant: Low probability, low impact: Risks having impact and likelihood of occurrence less than 2.5 are included in the 4th quadrant; these risks can be managed by proper allocation of risks (See Figure 4).
In the last stage, based on the quadrant assessment, each risk is ranked based on its severity. It is observed that inflation is the most important risk because it has a higher possibility of risk occurrence and it has higher potential to damage the project. As the economy of developing countries like Pakistan is not sustainable, the current account deficit and dollars unavailability in the country leads to inflation and foreign exchange fluctuation which stands at third in the risk severity list of this study. This can cause inflation in the country and it will impact human life, other industries and construction projects. Revenue risk from the end-user is ranked as a second important risk, because due to the political and governance instability of the country the investor is reluctant to invest in the PPP projects. Such conditions may lead to project holdups and the revenue issues are normalized with the stabilization of the political and governance situation. Political risks rank as a fourth important risk in this study because a PPP investor will never invest in a country where there is no political stability. The investor feels a threat to its investment and every investor investing in PPP projects are expecting a return and investment outcomes from the projects. Due to political instability and week governance, there are higher chances of a law-and-order situation disturbance which also has a great role in the success of PPP projects execution and attraction of other investors possibly investing in PPP projects in any country. Similarly, all other risk types in this study have been ranked on the same principle mentioned earlier.

5. Comparative Assessment

As stated earlier, PPP contracts are gaining in importance in various countries due to various benefits and ease. According to Chan et al. [31], there were about 2400 infrastructure projects in the implementation phase in China under the umbrella of PPP contract system with a total investment of over RMB 470 billion (75 billion USD); while on the other hand there were up to 142 PPP transport projects under commencement between 2007–2011 amounting 402 billion USD [32]. According to the website of Acer Pakistan the estimated cost for PPP projects in Pakistan is around 16 billion USD at the moment, including projects which are in the planning and implementation phase [33]. Therefore, a detailed comparative assessment was also done for a better understanding of the concept.
Case 1: In this case, the results of this country are given and the case represents the construction sector of Pakistan.
Case 2: In this case, a recent study conducted in China was considered to analyze the results. The reason to select this case is that China is one of the growing economies in the Asian region and many companies working on PPP projects for many years are from China.
Case 3: In this case, a study conducted in India was considered to analyze the results. The reason to select this case is that India is a neighboring country of Pakistan and there are many similarities in both countries including governance style, political stability and others. India is also one of the growing economies in the Asian region and there are many ongoing PPP projects in India.
Case 4: In this case, a study conducted in Egypt was considered to analyze the results. The reason to select this case is that Egypt is a country with different regions, political setup and governance style. Egypt also introduced various PPP projects for infrastructure development.
To compare the identified risks in Pakistan, a comparison was made between the top risks identified in this study with the risks identified in three countries including China, India and Egypt through the literature review as shown in Table 1.
Table 1. Risk rank relationship between Pakistan, China, India and Egypt.
Table 1. Risk rank relationship between Pakistan, China, India and Egypt.
S.NoPPP Risk Relationship in Pakistan, China, India and Egypt
Risk FactorRisk Ranking in the Pakistani CaseRisk Ranking in the Chinese Case [31]Risk Ranking in the Indian Case [34]Risk Ranking in the Egyptian Case [35]
1Inflation11453
2Revenue risk from end user26621
3Foreign exchange fluctuation313------1
4Political risk4------32
5Law and order situation5------10------
6Operation cost overrun6121125
7Government/concessionaire corruption73------9
8Land acquisition827242
9Physical obstacles that cannot be avoided9------------54
10Financial inability of the concessionaire104944
11Political/public opposition113336
12Interest rate fluctuation128617
13Imperfect contract139641
14Inadequate law and supervision system145------16
15Poor public decision-making process15274
16Constructional inability of concessionaire1620------50
17Planning risks17------------32
18The event of default of any partner18------9------
19Regulatory/contractual risk199------18
20Force majeure2030615
21Coordination between the parties2126------45
22Maintenance risks22------------40
23Legislation changes2324410
25Change in market demand2510647
26Swings in public opinion26------712
27Delay in project approvals/permits27181219
28Government intervention281------23
29Nationalization/expropriation2935------14
30Change in tax regulation303168
32Unforeseen weather and geological conditions32341159
33Permits risks3327------24
34Material shortage34321035
35Government policy35------------5
36Dispute resolution36------------13
37Market competition3729------49
38Deficiency of design38------1137
39Lack of supporting infrastructure3921------7
40Completion (handling over) risk4016------22
41Labour unavailability41321055
43Project/operation changes43151030
44Environmental sustainability risk44281------
45Technological risks45------1251

6. Discussion

This analysis of the findings reveals that, according to the researcher, inflation is the greatest obstacle for the effective execution of a PPP project in Pakistan, while it is number 14 in the Chinese case, number 5 in the Indian case and number 3 in the Egyptian case. The key explanation for this disparity is each country’s economic situation. Political risk is very significant as PPP contracts are long-term in nature and changing policy may generate trouble for the private partner in the PPP arrangement; according to the experts, political risk is number four in Pakistan, number three in India and number two in Egypt. Foreign exchange is a factor affecting ventures in countries with poor economies such as Pakistan, Egypt, etc. in the studies carried out; according to experts from Pakistan and Egypt, foreign exchange fluctuation is number 3 in the case of Pakistan, number 1 in the case of Egypt, while number 13 in the case of China does not cover this possibility, according to a study carried out in India. There is a significant difference between the risk ranking of Pakistan, China and India whereas the results of Pakistan and Egypt are similar to each other. According to their opinion, the concept of PPP is new in Pakistan in comparison with China and India; secondly, there is a significant difference in the economies of Pakistan, China and India. While comparing the top 10 risks, it is understandable that in the ranking of Pakistan and Egypt, risks related to financing are in majority (i.e., 5 out of 10 in Pakistani case and 4 out of 10 in the Egyptian case). While in the case of China and India, risks related to the attitude of the government towards investors and political situation are amongst the top. The risk ranks of this study driven after the experts from the construction industry of Pakistan were compared with the previous studies conducted.
In the next phase, a comparative assessment is made to analyze the possible correlation of the risk ranks between different countries. The risk ranks of Pakistan PPP projects were compared with China, India and Egypt. The X axis shows the PPP risk rank in Pakistan and Y axis shows the PPP risk ranks of other countries as shown in Figure 5.

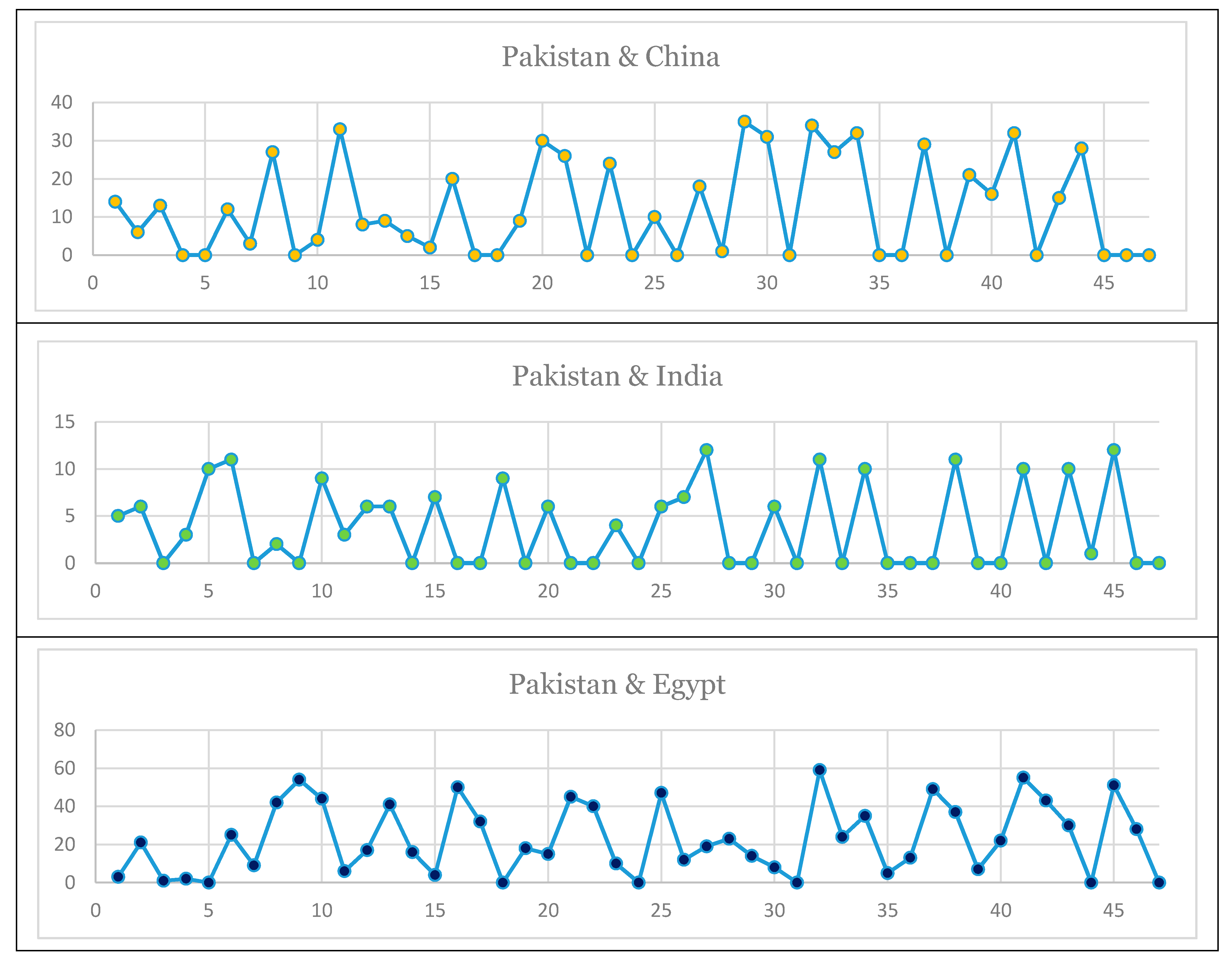

It is evident from Figure 5 that the PPP risks in Pakistan and India are very close and it might be due to the similar region and governance systems. Whereas, PPP risks in Pakistan and Egypt are quite a wage and it is due to a different region and governance approach. It is also observed that the PPP risks in Pakistan and China are also similar but the similarity is not strong as compared to India. This is obviously due to the economic stability of China as compared to Pakistan.

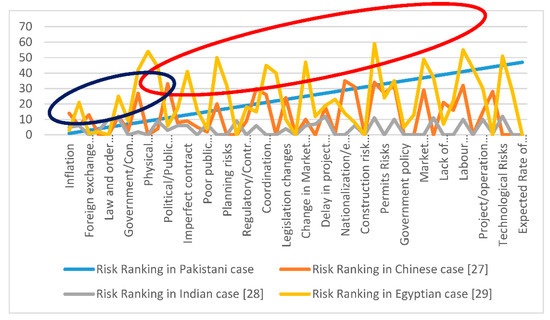

As per Figure 6, It is observed that the risk position between Pakistan and India is the same but the Indian construction industry is a bit mature in PPP as compared to Pakistan and therefore risk intensity is low.
Similarly, there is a close relationship of PPP risk between Pakistan and the Chinese construction industry but there are few risks that vary because of strict governmental policies of the Chinese government over PPP projects. Whereas, it is analyzed that there is not a close relationship of risks between Pakistan and Egypt because the political and regional dynamics of both countries are different.

7. Contribution of Research with United Nations Sustainable Development Goals

PPP concept and construction projects have a high potential to support both Sustainable Development Goal (SDG) in the longer run. The public and private sector initiatives for meeting the basic needs of people can be effectively achieved by the PPP concept, especially in developing countries where governments are facing limited financial sources. PPP can also contribute significantly to job creation at all levels as more than 50 industries are directly and indirectly linked with the construction industry. Figure 7 shows the conceptual framework of PPP benefits meeting the UN SDGs.
As per SDG 8 (decent work and economic growth), it is estimated that 172 million people worldwide were without work in 2018 which is about 5% of the unemployment rate and as a result of an expanding labor force, the number of unemployed people is projected to increase by 1 million every year and reach 174 million by 2020 [36]. Similarly, as reported in SDG 11 (sustainable cities and communities), in 2018, 4.2 billion people, 55% of the world’s population, lived in cities. By 2050, the urban population is expected to reach 6.5 billion [37].
In the future, 8 out of 10 mega-cities will be in the developing world. In the coming decades, 90 percent of urban expansion will be in the developing world [36]. Thus, meeting such key targets, the PPP procurement method can contribute significantly and it can support governments to meet the required targets by the next few years. PPP projects can play a role in reducing the unemployment rate in the world and especially in developing countries.

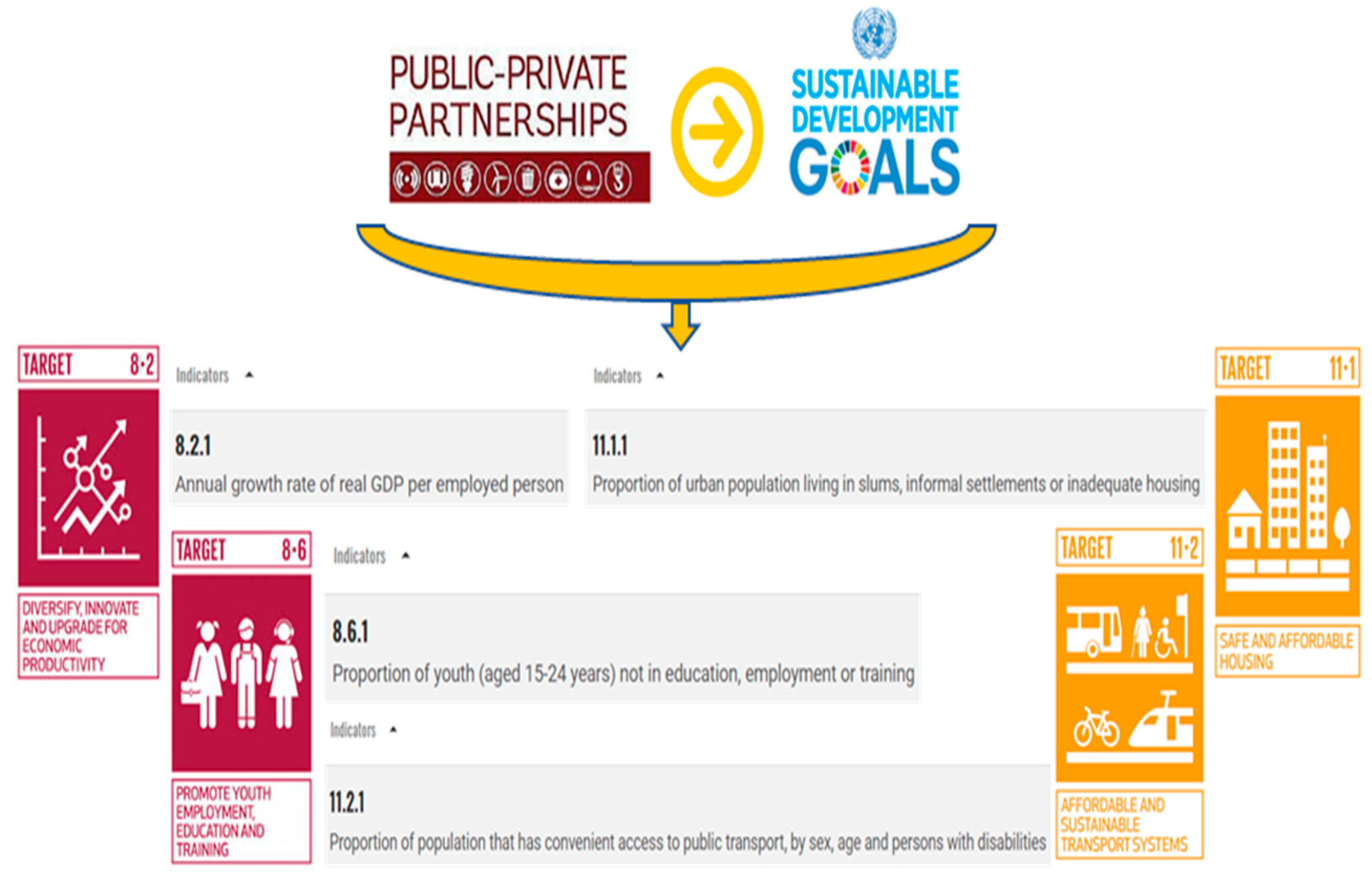

As shown in Figure 8, PPP projects have the potential to contribute to various indicators. PPP construction projects can contribute significantly to the GDP of any country (SDG 8.2.1) and also contribute to skilled, unskilled and semi-skilled jobs (SDG 8.6.1). PPP projects can be initiated to housing schemes where ordinary people cannot build their houses and shelters. The governments can execute various housing scheme project using PPP projects to support people to acquire shelter (SDG11.1.1). It is evident from the literature review that most of the government sector projects under PPP are infrastructure projects. The developing countries initiated various infrastructure projects including roads, bridges, train tracks, metro trains, industries and many other civil engineering structures (SDG11.2.1).

8. Conclusions

This study focusses on the risk evaluation for Pakistani PPP projects. The main objective of this study was to carry out a risk analysis for PPP projects in Pakistan by identifying and prioritizing the various risks affecting PPP projects in Pakistan and determining their partner-wise allocation, designing the risk severity matrix and finally benchmarking risks with neighboring states. A total of 47 risk factors were identified through the literature review and interviewing experts. It is concluded that one of the main causes of the failure of PPP projects is the improper risk allocation of risks between the parties; therefore, this study addresses the issue of risk allocation in the Pakistani context. A few major risks in PPP projects are inflation, revenue risk from end-user, foreign exchange fluctuation, countries political condition, law and order situation, operation cost overrun, corruption and land acquisition. PPP risks in Pakistan and India are very close and might be due to similar region and governance systems. PPP risks in Pakistan and China are also similar but the similarity is not strong as compared to India. PPP risks in Pakistan and Egypt are distinct. It is also observed that PPP project financers are very conscious to invest their money in any developing country. They want to assure that their investment is safe for the total life span of the contract they signed. They also look for a guaranteed offer by any country and arrange a deal that brings them benefit, like tax waivers.

9. Recommendations and Suggestions

It is recommended that the government of Pakistan and other stakeholders interested in PPP projects should design a new supplementary guideline to ascertain the concerns of PPP investors as they have already made huge efforts to attract PPP investors in Pakistan. The main risks highlighted by this study mostly depend on the political stability of country because the varying political condition may cause the PPP investor to hold off as he feels his invest is not secure. Political instability and weak governance may also lead to corruption in the governing department and will also hinder the PPP investor. Therefore, it is necessary to design guidelines which will provide security to PPP investors to the effect that, if the government will change, it will not harm their investment. They should be assured that in case of any inflation they will be compensated and their benefit will not be affected. In general, the governments of developing countries should provide a fair, reasonable and safe ground for PPP investors to invest money for providing better infrastructure, service and facilities to their people.
It is strongly suggested that the governments in developing countries should support and facilitate PPP projects on suitable terms with tax relaxation for both sides. The government and financers should both highlight their concerns under the PPP project. PPP procurement system can significantly contribute to United Nations SDG 8 and SDG11. PPP projects can support developing countries to improve their infrastructure, services and facilities, and directly support the GDP of a country as the construction industry is, directly and indirectly, interconnected with more than 50 industries.

Author Contributions

Conceptualization, S.H.K. and T.H.A., review and editing, S.H.; visualization, N.Y.Z., Y.J. methodology, software, validation, formal analysis, investigation, writing—original draft preparation S.A.M. All authors have read and agreed to the published version of the manuscript.

Funding

The authors are also thankful to Prince Sultan University, Riyadh, Saudi Arabia for providing financial assistance (Article Processing Charges) and scholarly support for this publication.

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Data Availability Statement

Not applicable.

Conflicts of Interest

The authors declare no conflict of interest.

References

  1. Kavishe, N.; Chileshe, N. Critical success factors in public-private partnerships (PPPs) on affordable housing schemes delivery in Tanzania: A qualitative study. J. Facil. Manag. 2019, 17, 188–207. [Google Scholar] [CrossRef]
  2. Cui, C.; Liu, Y.; Hope, A.; Wang, J. Review of studies on the public–private partnerships (PPP) for infrastructure projects. Int. J. Proj. Manag. 2018, 36, 773–794. [Google Scholar] [CrossRef]
  3. Vaslavskiy, Y.; Vaslavskaya, I. Infrastructure Public–Private Partnership Projects: Budget Consolidation Policy in Russia and Government Expenditures’ Efficiency Increase. In Modeling Economic Growth in Contemporary Russia; Emerald Publishing Limited: Bingley, UK, 2019; pp. 203–232. [Google Scholar] [CrossRef]
  4. Wang, H.; Liu, Y.; Xiong, W.; Song, J. The moderating role of governance environment on the relationship between risk allocation and private investment in PPP markets: Evidence from developing countries. Int. J. Proj. Manag. 2019, 37, 117–130. [Google Scholar] [CrossRef]
  5. Yuan, J.; Li, X.; Chen, K.; Skibniewski, M.J. Modelling residual value risk through ontology to address vulnerability of PPP project system. Adv. Eng. Inform. 2018, 38, 776–793. [Google Scholar] [CrossRef]
  6. Wong, H.Y. A Study of the Application of Public Private Partnership in Transport Projects. Master’s Thesis, University of Hong Kong, Hong Kong, China, 2005. [Google Scholar]
  7. Olusola Babatunde, S.; Opawole, A.; Emmanuel Akinsiku, O. Critical success factors in public-private partnership (PPP) on infrastructure delivery in Nigeria. J. Facil. Manag. 2012, 10, 212–225. [Google Scholar] [CrossRef]
  8. Burawat, P. Productivity improvement of highway engineering industry by implementation of lean six sigma, TPM, ECRS, and 5S: A case study of AAA Co., Ltd. Humanit. Soc. Sci. Rev. 2019, 7, 83–92. [Google Scholar] [CrossRef] [Green Version]
  9. Suryanto, S.; Rusli, B.; Candradewini. Analysis of housing finance policies for low-income community in west bandung, west java province, Indonesia. Humanit. Soc. Sci. Rev. 2019, 7, 1038–1045. [Google Scholar] [CrossRef] [Green Version]
  10. Zhang, S.; Chan, A.P.C.; Feng, Y.; Duan, H.; Ke, Y. Critical review on PPP Research—A search from the Chinese and International Journals. Int. J. Proj. Manag. 2016, 34, 597–612. [Google Scholar] [CrossRef]
  11. Liu, T.; Wang, Y.; Wilkinson, S. Identifying critical factors affecting the effectiveness and efficiency of tendering processes in Public-Private Partnerships (PPPs): A comparative analysis of Australia and China. Int. J. Proj. Manag. 2016, 34, 701–716. [Google Scholar] [CrossRef]
  12. Agarchand, N.; Laishram, B. Sustainable infrastructure development challenges through PPP procurement process: Indian perspective. Int. J. Manag. Proj. Bus. 2017, 10, 642–662. [Google Scholar] [CrossRef]
  13. Musawa, M.S.; Ismail, S.; Ahmad, H. Disclosure of public-private partnership (PPP) voluntary information Case of Malaysian PPP projects. Asia-Pac. J. Bus. Adm. 2017, 9, 146–163. [Google Scholar] [CrossRef]
  14. Liu, J.; Love, P.E.; Smith, J.; Regan, M.; Sutrisna, M. Public-Private Partnerships: A review of theory and practiceof performance measurement. Int. J. Product. Perform. Manag. 2014, 63, 499–512. [Google Scholar] [CrossRef]
  15. Jin, X.H.; Zhang, G. Modelling optimal risk allocation in PPP projects using artificial neural networks. Int. J. Proj. Manag. 2011, 29, 591–603. [Google Scholar] [CrossRef]
  16. Siddiqui, F.; Akhund, M.A.; Ali, T.H.; Khahro, S.H.; Khoso, A.R.; Imad, H.U. Barriers in Adoption of Building Information Modeling in Pakistans Construction Industry. Indian J. Sci. Technol. 2019, 12, 1–7. [Google Scholar] [CrossRef]
  17. Risk management: Awareness, Identification and Mitigation in Public Private Partnerships of Technical infrastructure Projects in Da Nang. In Proceedings of the 4th International Conference on Green Technology and Sustainable Development (GTSD), Ho Chi Minh City, Vietnam, 23–24 November 2018.
  18. Valipour, A.; Sarvari, H.; Tamošaitiene, J. Risk Assessment in PPP Projects by Applying Different MCDM Methods and Comparative Results Analysis. Adm. Sci. 2018, 8, 80. [Google Scholar] [CrossRef] [Green Version]
  19. Osei-Kyei, R.; Chan, A.P.C. Risk assessment in public-private partnership infrastructure projects: Empirical comparison between Ghana and Hong Kong. Constr. Innov. 2017, 17, 204–223. [Google Scholar] [CrossRef]
  20. Wang, Y.; Cui, P.; Liu, J. Analysis of the risk-sharing ratio in PPP projects based on government minimum revenue guarantees. Int. J. Proj. Manag. 2018, 36, 899–909. [Google Scholar] [CrossRef]
  21. Keers, B.B.M.; van Fenema, P.C. Managing risks in public-private partnership formation projects. Int. J. Proj. Manag. 2018, 36, 861–875. [Google Scholar] [CrossRef]
  22. Hwang, B.G.; Zhao, X.; Gay, M.J.S. Public private partnership projects in Singapore: Factors, critical risks and preferred risk allocation from the perspective of contractors. Int. J. Proj. Manag. 2013, 31, 424–433. [Google Scholar] [CrossRef]
  23. Bing, L.; Akintoye, A.; Edwards, P.J.; Hardcastle, C. The allocation of risk in PPP/PFI construction projects in the UK. Int. J. Proj. Manag. 2005, 23, 25–35. [Google Scholar] [CrossRef]
  24. Khan, A.H.; Jamil, M.; Sattar, M. The trend of Build Operate and Transfer (BOT) projects in Pakistan. In Proceedings of the First International Conference on Construction in Developing Countries (ICCIDC-I), Karachi, Pakistan, 4–5 August 2008; pp. 88–97. [Google Scholar]
  25. Marques, R.C.; Berg, S. Risks, Contracts and Private Sector Participation in Infrastructure. J. Constr. Eng. Manag. 2011, 137, 925–932. [Google Scholar] [CrossRef]
  26. Yuan, J.; Li, W.; Guo, J.; Zhao, X.; Skibniewski, M.J. Social risk factors of transportation PPP projects in China: A sustainable development perspective. Int. J. Environ. Res. Public Health 2018, 15, 1323. [Google Scholar] [CrossRef] [PubMed] [Green Version]
  27. Rashid, I.A.; El-Mikawi, M.; Baha, H.E.M. Factors affecting the calculations of Return on Investment (ROI) in Public-Private Partnerships (PPP) projects In Egypt. Acad. Res. Community Publ. 2019, 2, 332–345. [Google Scholar]
  28. Kumar, L.; Jindal, A.; Velaga, N.R. Financial risk assessment and modelling of PPP based Indian highway infrastructure projects. Transp. Policy 2018, 62, 2–11. [Google Scholar] [CrossRef]
  29. Owolabi, H.A.; Bilal, M.; Oyedele, L.O.; Alaka, H.A.; Ajayi, S.O.; Akinade, O.O. Predicting Completion Risk in PPP Projects Using Big Data Analytics. IEEE Trans. Eng. Manag. 2020, 67, 430–453. [Google Scholar] [CrossRef] [Green Version]
  30. Chou, J.S.; Pramudawardhani, D. Cross-country comparisons of key drivers, critical success factors and risk allocation for public-private partnership projects. Int. J. Project Manag. 2015, 33, 1136–1150. [Google Scholar] [CrossRef]
  31. Xu, Y.; Yeung, J.F.Y.; Chan, A.P.C.; Chan, D.W.M.; Wang, S.Q.; Ke, Y. Developing a risk assessment model for PPP projects in China-A fuzzy synthetic evaluation approach. Autom. Constr. 2010, 19, 929–943. [Google Scholar] [CrossRef]
  32. Paul, R.K. Risk Mitigation in PPPs: Lessons from Bangladesh Experience; Asian Institute of Technology: Khlong Nueng, Thailand, 2012. [Google Scholar]
  33. Nodari, R.O. Agriculture: Risk assessment for Brazil’s GM bean. Nature 2011, 479, 299. [Google Scholar] [CrossRef]
  34. Gupta, A.K.; Trivedi, M.K.; Kansal, R. Risk variation assessment of Indian road PPP projects. Int. J. Environ. Sci. Technol. 2013, 2, 1017–1026. [Google Scholar]
  35. Badran, Y. Risk Analysis and Contract Management for Public Private. Master’s Thesis, The American University in Cairo, Cairo, Egypt, 2013. [Google Scholar]
  36. United Nations. Goal 8: Decent work and economic growth|UNDP. In United Nations Development Program; United Nations: San Francisco, CA, USA, 2020; pp. 1–4. [Google Scholar]
  37. Goal 11: Sustainable Cities and Communities—SDG Tracker Website. 2021. Available online: https://sdg-tracker.org/cities (accessed on 10 March 2021).
Figure 1. Research sequence.
Figure 1. Research sequence.
Sustainability 13 03292 g001
Figure 2. Respondent’s experience profile working on Public-Private Partnership (PPP) projects.
Figure 2. Respondent’s experience profile working on Public-Private Partnership (PPP) projects.
Sustainability 13 03292 g002
Figure 3. Respondent domain of work.
Figure 3. Respondent domain of work.
Sustainability 13 03292 g003

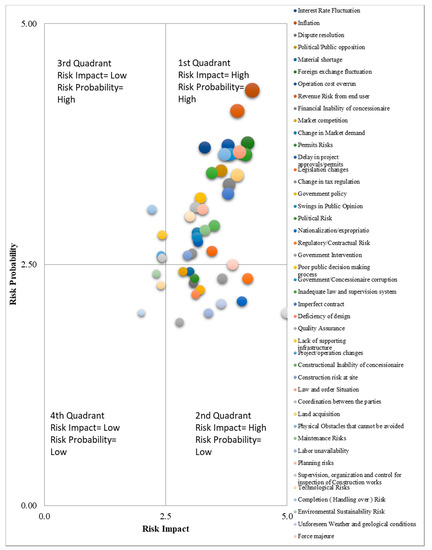

Figure 4. Risk severity matrix.
Figure 4. Risk severity matrix.
Sustainability 13 03292 g004
Figure 5. PPP risk ranks correlation.
Figure 5. PPP risk ranks correlation.
Sustainability 13 03292 g005
Figure 6. Risk intensity of PPP projects.
Figure 6. Risk intensity of PPP projects.
Sustainability 13 03292 g006

Figure 7. PPP projects integration with the UN Sustainable Development Goal (SDG)’s benefit framework.
Figure 7. PPP projects integration with the UN Sustainable Development Goal (SDG)’s benefit framework.
Sustainability 13 03292 g007
Figure 8. Contribution of PPP to SDG targets and indicators.
Figure 8. Contribution of PPP to SDG targets and indicators.
Sustainability 13 03292 g008
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations.

Share and Cite

MDPI and ACS Style

Khahro, S.H.; Ali, T.H.; Hassan, S.; Zainun, N.Y.; Javed, Y.; Memon, S.A. Risk Severity Matrix for Sustainable Public-Private Partnership Projects in Developing Countries. Sustainability 2021, 13, 3292. https://doi.org/10.3390/su13063292

AMA Style

Khahro SH, Ali TH, Hassan S, Zainun NY, Javed Y, Memon SA. Risk Severity Matrix for Sustainable Public-Private Partnership Projects in Developing Countries. Sustainability. 2021; 13(6):3292. https://doi.org/10.3390/su13063292

Chicago/Turabian Style

Khahro, Shabir Hussain, Tauha Hussain Ali, Shafiqul Hassan, Noor Yasmin Zainun, Yasir Javed, and Shahbaz Aziz Memon. 2021. "Risk Severity Matrix for Sustainable Public-Private Partnership Projects in Developing Countries" Sustainability 13, no. 6: 3292. https://doi.org/10.3390/su13063292
