Structural Relationship of Causes and Effects of Construction Changes: Case of UAE Construction

by
Ismail Abdul Rahman
1,
Abdulla Eisaa Saleh Al Ameri
2,
Aftab Hameed Memon
3,*,
Nashwan Al-Emad
1 and
Ahmed S. A. Marey Alhammadi
2
1
Faculty of Civil and Environmental Engineering, Universiti Tun Hussein Onn Malaysia (UTHM), Batu Pahat 86400, Johor, Malaysia
2
Faculty of Business and Technology Management, Universiti Tun Hussein Onn Malaysia (UTHM), Batu Pahat 86400, Johor, Malaysia
3
Department of Civil Engineering, Quaid-e-Awam University of Engineering, Science and Technology, Sindh 67450, Pakistan
*
Author to whom correspondence should be addressed.
Sustainability 2022, 14(2), 596; https://doi.org/10.3390/su14020596
Submission received: 8 October 2021 / Revised: 22 November 2021 / Accepted: 29 November 2021 / Published: 6 January 2022

Abstract

:
Changes during construction is one of the critical issues faced in the construction industry. Effective management of construction changes will reduce the financial burden faced in construction projects due to cost overrun, and practitioners will be able to complete projects on time. On the other hand, construction changes exert severe effects on project performance. Hence, this paper uncovers several changes occurring in construction projects. It also evaluates the effect on various parameters of project performance due to changes. This was done by uncovering the underlying causes and effects of changes through the PLS method of structural equation modeling technique. SmartPLS software was used to develop and evaluate the study model based on 58 change causes and 48 change effects that were identified from the literature review. Causes of changes were categorized into three constructs which are client-related causes (CLE), consultant-related causes (COS), and contractor-related causes (CON). At the same time, the effects variables were grouped as Time Overrun (TO), Cost Overrun (CO), and Quality (QA). The survey data for generating the model was collected from 218 practitioners working on construction megaprojects of the UAE. Assessment on the constructed model found that the contractor (CON) group is the most influential group of causes with the highest values of the model’s predictive explanatory power (accuracy), which is 0.396, 0.339, and 0.410 to time overrun, cost overrun, and quality assurance of the effects groups, respectively. At the same time, the Quality Assurance (QA) group is considered the most substantial parameter which are affected due to changes occurring in construction projects of UAE. This model is deemed beneficial for the UAE construction industry in facilitating the effective recognition of possible causes and effects of change among the UAE construction projects. As a result, the practitioners will make necessary arrangements to control the potential changes in future projects.

1. Introduction

In UAE, the construction is considered the leading sector that drives the country’s economy [1]. It is an essential element in driving the UAE economy to a better standard and continues to be an essential task in the UAE’s development, urbanization, and industrialization [2,3]. It has helped to translate the vision 2025 of UAE into a more innovative, planned development status [4]. It plays an essential role in the creation of jobs. It employs over 2,000,000 workers; accounting for about 7.2 percent of the total workforce, stabilizing the economy [5]. UAE’s construction industry has expanded rapidly. A number of megaprojects such as Dubai Creek Harbour, Al-Maktoum International Airport, and Dubai, the sustainable city (net-zero energy city in Dubai), have given exposure to the construction industry in the world.
Unfortunately, construction works in UAE experience changes during work in progress, which significantly affects progress and performance due to uncertainty. The changes have a severe impact on project cost, schedule, and quality. It is reported that the Dubai metro project faced a delay of five years to complete due to changes occurring through the project lifecycle. As a result, the cost was increased by 85%, as cited in [6]. Although every stakeholder involved in construction works aims to achieve project completion within planned scope, time and budget can become challenging when changes occur in project activities [7]. Changes in the project are unavoidable [8] and create serious adverse effects [9]. Hence, it is very imperative to control changes in construction. This can be effectively performed by identifying critical causes of changes. Thus, this study aims to uncover underlying causes and effects caused by changes in construction projects of UAE through advanced multivariate techniques of Structural Equation Modeling (SEM). Identification of the causes of changes and relative effects are helpful in planning the strategies for executing the works successfully.

2. Causes and Effects of Changes in Construction Projects

The construction industry is considered to be the primary contributor to developing socio-economic status. Unfortunately, construction projects often face common issues such as time overrun, waste generation, poor productivity, etc. These issues are due to several reasons. One of the reasons is that the construction projects are uncertain. Due to the uncertainty phenomenon in construction works, most construction projects experience changes during the execution of the work. Change in the construction industry usually arises when the scope of work performed differs from the scope of work outlined in the contract documents [10]. Adding or reducing the scope or even modifying contract conditions affect construction cost, time, and quality [11].
Changes in construction are inevitable which are notified by change orders [12]. These are considered a serious concern of the practitioners as they can lead to project failure, time overrun, cost overrun, and inadequate project quality [13]. A study of Saudi Arabian construction works showed that 70% of the project faced extended project time. These changes occur due to variations in design, expenses delays, inadequate planning and scheduling, absence of site management by contractors, labor deficiency, and financial problems with a project’s contractors [14]. Ahmed et al. [15] reported that the construction projects in Pakistan are affected by the huge claims of cost escalation. One of the primary reasons of this escalation is the extra time required for the project due to changes. Changes cause numerous negative impacts on project performance [16] and may lead to disputes and declines in productivity [11,17].
Change management is amongst the major challenges which hurdle the success of the projects, and it may be caused by design error, mistakes in drawings, amendment in contract condition, modification in scope, etc. A research study revealed that construction projects face 10–17% of the overrun in project cost due to changes [17]. Change can be difficult for all stakeholders involved in project management and can lead to contractual disputes [13]. It can create misunderstanding between parties such as contractors who consider consultants and clients responsible for any change.
The owner may perceive losses as a result of change caused by the contractor’s poor management [18]. Today, managing changes is a critical issue that can have a significant impact on project performance if not handled properly [19]. Sun and Meng [20] reported that conditions are the major source of change in any project. Generally, any event which causes alteration or modification of the work item is considered to change. Design and scope changes are the most common reasons for changes in any project [21], but unfortunately, only a few studies have paid proper attention to this issue [22].
Similarly, lack of contractor’s experience in similar projects or poor financial condition of stakeholders also causes changes in projects [13]. Alaryan and Dawood [23] pointed out that changes in design or material specification and inconsistency in contract documents also cause change. In addition, financial difficulties of the contractor, slow decision making, or inflexible nature of the owner also cause changes in projects [24]. A comprehensive review of the literature identified 53 common causes of construction changes and 48 effects occurring due to changes. A broad examination of the factors highlighted that the causes could be classified based on the source or controlling stakeholder. Hence, the factors were categorized in the three groups: client-related factors, consultant-related factors, and contractor-related factors. The effects were related to the basic parameters of projects performance as time, cost, and quality. The effects of changes were classified into three categories: time over, cost overrun, and quality assurance. The list of the causes and effects of the changes was tabulated and presented in Table 1.

3. Structural Equation Modeling

Structural Equation Modeling (SEM) is a method for explaining the relationship between many variables. The variables that can be measured directly are known as observed variables. In contrast, the variables that cannot be measured directly (latent variables) are dependent on the factors that are associated with them. A typical SEM framework includes a structural model that connects latent variables and a measurement model that links latent variables to observed variables. SEM is particularly popular in the social sciences and psychology, where unmeasured quantities and psychological constructs like human intelligence and creativity can be related to and investigated using observed data [25]. SEM is a technique that can be used for both confirmation and exploration. In SEM, each path model comprises two submodels: a structural or inner model and measurement or outer model. The structural model determines the relationship between latent variables. The measurement model determines the relationships between latent variables and their manifests [26]. This powerful method can also be used to analyze models with poorly measured variables, and many research issues in construction management and engineering can be addressed [27]. SEM has demonstrated numerous advantages in prediction and theory development. Even with small sample size, SEM is considered a very effective technique for assessing the reliability of multi-item construct measures [28].
Being a robust analysis technique, the use of SEM is proliferating [29]. SEM is applicable for decision support system development, predictive models, risk analysis, and so on. For example, Doloi et al. [30] used SEM to quantify the relationships between the causes of project delays in Indian construction projects. Islam and Faniran [31] drew attention to the SEM’s effectiveness in determining relationships between multiple independent variables. Memon and Rahman [32] used SEM to identify cost overrun impediments in Malaysia. Khahro et al. [33] modeled the factor of green procurement using a PLS approach to SEM.
In Structural Equation Modelling, two approaches are commonly used [34], namely, Structural Equation Modeling Using Covariance (CB-SEM) and Variance-Based Structural Equation Modeling (VB-SEM), also known as Partial Least Square Structural Equation Modeling (PLS-SEM). Partial Least Square Structural Equation Modeling (PLS-SEM) is also known in the literature as component-based SEM or PLS path modelling. In contrast to CB-SEM’s goal of obtaining a good fit, the PLS approach aims to get determinate values of the latent variables for predictive purposes [35]. The PLS-SEM method aims to maximize the explained variance of the dependent latent constructs [36]. As a result, the entire process is optimized for prediction rather than goodness-of-fit. PLS-SEM can be used for confirmatory analysis and for exploratory studies where the theoretical foundation is lacking. It is more robust than CB SEM, has fewer identification issues, and works well with small and large samples. Furthermore, PLS does not make any prior distributional assumptions.

4. Model Development

Partial Least Square Structural Equation Modeling (PLS-SEM) method was used for measurement analysis and hypotheses. In this study, PLS-SEM model was developed and run with the software package SmartPLS v3.0. Initially, a hypothetical model is developed that serves as a basis for testing the relationships among variables [37]. The hypothetical model has two latent variables known as exogenous and endogenous, which act as the PLS model’s structural (inner) part. The exogenous variables are represented by three groups of change causes: client-related causes [CLE], consultant-related causes [CST], and contractor-related causes [CON]. Whereas, endogenous variables represent three groups of change effects: time overrun [TO], cost overrun [CO], and quality assurance [QA].
Based on the factors and constructs listed in Table 1 above, the model was constructed based on 53 causes of changes groups in three exogenous constructs and 48 change of effects categorized in three endogenous constructs. The model development aimed to assess the relationship between causes and effects. The endogenous and exogenous constructs are connected to form the structural component of the model [38]. A hypothetical model was developed for assessing the relationship between the causes and effects of changes, as shown in Figure 1.

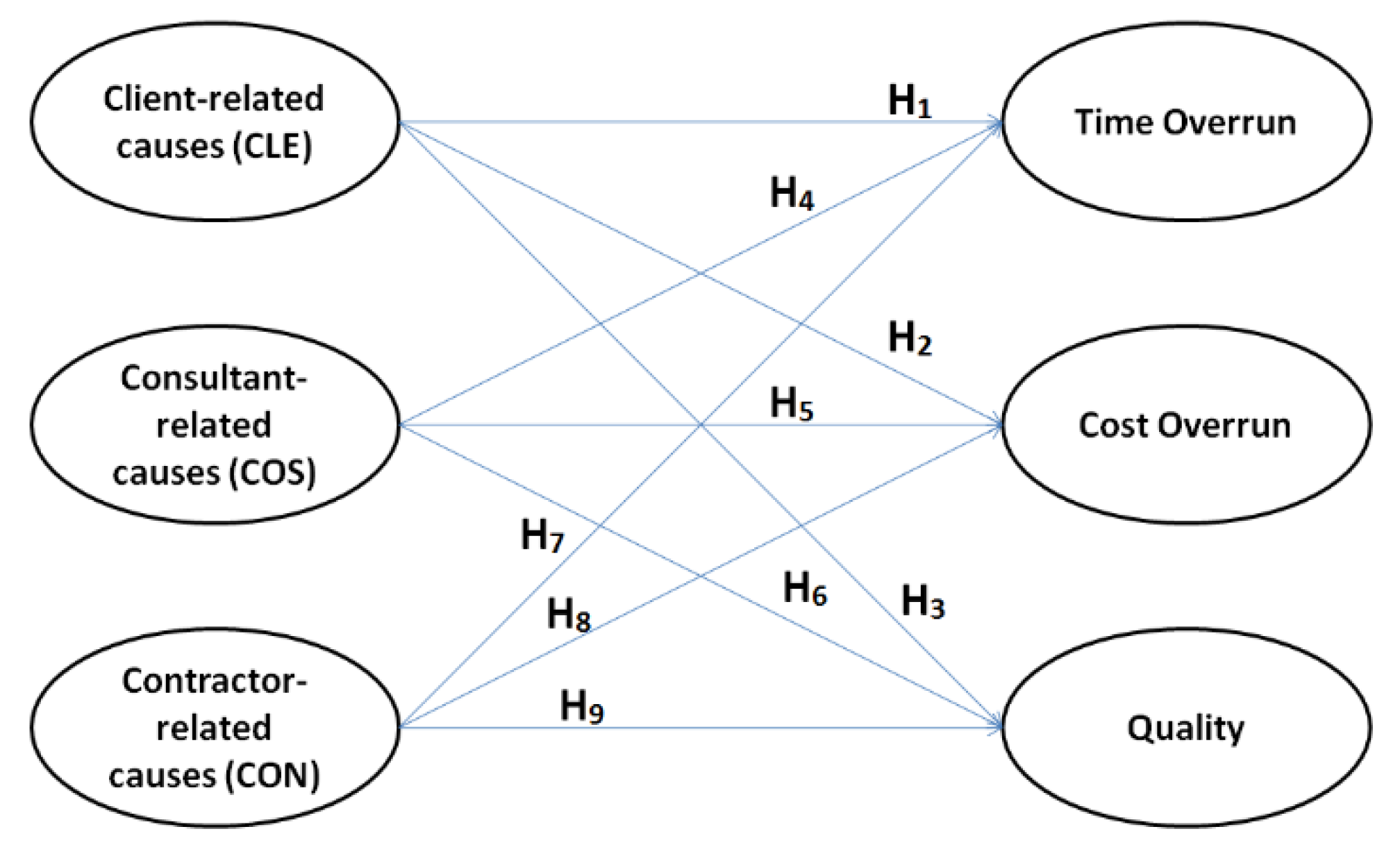

In Figure 1, it is observed that there are 9 hypotheses developed to test the cause-and-effect relationship of changes as described below.
Hypothesis 1 (H1).
CLE has a significant relationship with TO.
Hypothesis 2 (H2).
CLE has a significant relationship with CO.
Hypothesis 3 (H3).
CLE has a significant relationship with QA.
Hypothesis 4 (H4).
CST has a significant relationship with TO.
Hypothesis 5 (H5).
CST has a significant relationship with CO.
Hypothesis 6 (H6).
CST has a significant relationship with QA.
Hypothesis 7 (H7).
CON has a significant relationship with TO.
Hypothesis 8 (H8).
CON has a significant relationship with CO.
Hypothesis 9 (H9).
CON has a significant relationship with QA.

5. Data Collection

Data collection was carried out through a survey where the respondents were construction practitioners randomly selected based on their working experience in handling a number of mega projects in Dubai. The survey was conducted using Google online survey application. The respondents were asked to choose the degree of importance of 58 change causes affecting 48 change effects based on a 5-point Likert scale. In addition, the respondents were asked to indicate the level of significance for each cause and effect of change as 1 for not significant, 2 for slightly significant, 3 for moderately significant, 4 for very significant, and 5 for extremely significant. This survey resulted in acquiring 218 valid responses as demographic information in Figure 2.

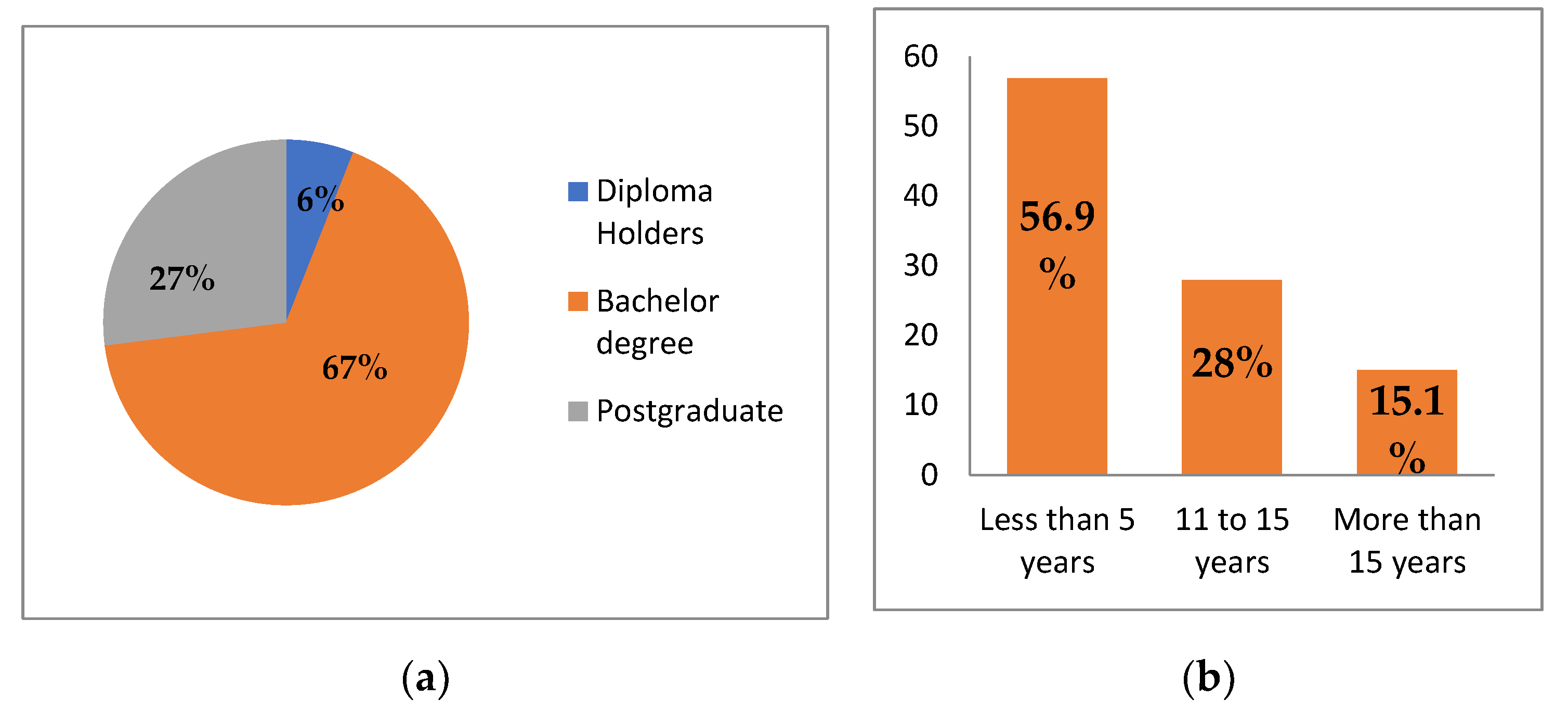

Figure 2 indicates that most of the respondents (67%) have bachelor’s degrees. In terms of experience, more than half of respondents (56.9%) had been working for less than five years in the UAE construction industry. In addition, it was observed that two-thirds of the respondents (71.6%) are technical workers, 15.1% of the respondents hold the position of executive management, and 13.3% of respondents are senior managers.

6. Model Evaluation

The two stages of model evaluation in SEM modeling are conducted for measurement (outer) and structural (inner) models. The assessment was conducted on the relationship between constructs and their related indicators for the measurement stage, while the structural evaluation was conducted between exogenous and endogenous constructs.

6.1. Evaluation of Measurement Model

Evaluation of measurement model is to check the internal consistency of the model and to evaluate whether relationships between independent and dependent variables are adequate or not [28]. For the reflective model approach, the evaluation of the measurement model is conducted in three stages. The first stage is to evaluate the model performance after each model computational iteration (individual item reliability) where indicator factor loading < 0.5. The second stage is to check the construct’s convergent validity and reliability include composite reliability (CR > 0.708), average variance extracted (AVE > 0.5), and Cronbach’s alpha (α ≥ 0.7). The third stage is confirming the discriminant validities of the model, where the square root of the average variance extracted (AVE) is more than correlation values between the other exogenous constructs. The process of model evaluation and iteration can be carried out alternatively until all evaluation criteria are fulfilled.
Evaluation of the measurement involved six iterations and assessment processes, resulting in a deletion of 70 indicators from the construct with low factor loading (<0.5). Deleting these indicators caused an improved value of the average variance extracted (AVE) to an acceptable level from 0.513 to 0.612. The final model showing the results of paths and strength of the factor are shown in Figure 3 where latent variable 1 represents the client-related causes, latent variable 2 represents a consultant-related group of causes, and latent variable 3 describes the contractor-related causes. Similarly, latent variable 4 illustrates time overrun, latent variable 5 represents cost overrun, and latent variable 6 represents quality-related factors.

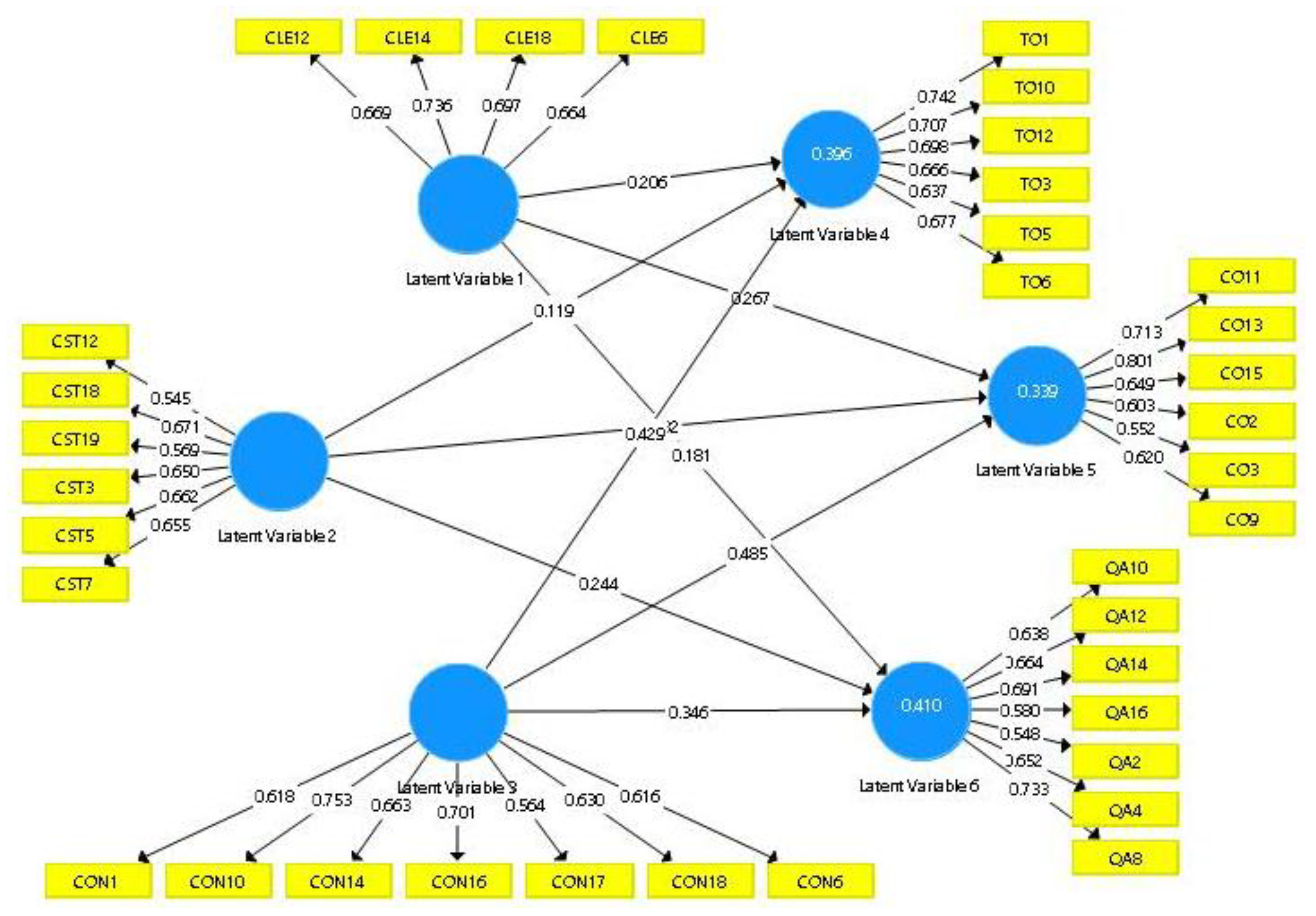

Figure 3 shows the final constructed PLS model with path coefficients (β value) in the range of 0.119 to 0.485. This indicates that contractor (CON) has the highest β value of 0.485, showing the group has a strong relationship with the effects of change in the construction industry [28]. Research points to the contractor as the responsible party that carries most of the risks for the changes in the project. This is because sometimes the contractor has to perform work different from that required by the contract documents [10]. The overall model can be classified as having significant explaining power based on the coefficient of determination (R2) value. Among the change effects, Quality Assurance (QA) is the significant group with the highest R2 value. Regression analyzes the interaction effects [39] of exogenous and endogenous variables. Overall, it can be seen that the changes have a significant effect on time overrun, cost overrun, and quality. Shoar and Chileshe [22] also confirmed that the changes significantly affect time and cost overrun.
Furthermore, the developed model is categorized as reflective since the indicators’ path is in an outward direction from the constructs. Hence, the model evaluation is based on nostalgic model specifications and criteria. The overall results of the measurement model evaluation are as presented in Table 2.
Results illustrated in Table 2 indicate that all the values of item reliability and convergent validity of the study’s measurement model are above the mentioned cut-off values; it successfully meets the first set of evaluation criteria. Furthermore, the measurement model achieves two discriminant validity criteria through cross-loading and Fornell and Larcker measures [40]. Thus, it indicates that the assessment of measurement criteria is entirely fulfilled.

6.2. Test of Hypotheses

Non-parametric bootstrapping was applied to test the hypothesis by calculating the t-value. Table 3 shows the summary of the path results and the corresponding t-values calculated. For all the paths, a two-tailed t-test was used.
Results in Table 3 show that the t-value for most of the pathways was above the minimum cut-off level, i.e., 1.96 = 5% [41]. However, for the relations, i.e., client-related causes with quality, consultant-related causes with time overrun, and cost overrun, the t-value is less than 1.96. This means that most of the assumptions are supported and accepted. Thus, there are only three insignificant relations.

6.3. Evaluation of Structural Model

The structural model’s evaluation assessed the inner model based on two criteria by evaluating the model’s predictive capabilities and relationships among constructs. The first criterion is to check the strength of the impact path (β value) of the independent variables to the dependent variables where the cut-off value of β is greater than or equal to 0.1 regardless of its sign (negative or positive) [41]. Table 4 shows the results of the evaluation of the structural model.
The results illustrated in Table 4 indicate that all the four criteria for assessing the structural model are fulfilled. Hence, this model is statistically validated and can be accepted for further application.

6.4. Goodness of Fit

Goodness of fit (GoF) is an index used to identify the geometric mean for endogenous structures of the average community (AVE) and the average determination coefficient (R2) as cited by [33]. The GoF index serves as the basis for validating the global PLS model with a value of 0 to 1. For values of 0.1, 0.25, and 0.36, respectively, the GoF index can be classified into three criteria of small, medium, and high validating capacity [42]. The average AVE for the entire construct variable and the average R2 for all build variables is as shown in Table 5.
Thus, goodness of fit, G o F = A V E ¯ × R 2 = = 0.675 × 0.381 = 0.507 (large validating power). The GoF index for this study model was calculated from Table 5 as 0.507. GoF is used to validate the large complex model’s prediction power by recording for both measurement and structural parameters [43]. The GoF value of this study shows that the developed model has large validating power. It can be concluded that the empirical data matches the model well and is highly predictive compared to the baseline values.

7. Discussion on Findings and Benefits

With the help of the SEM model, this study investigated the issue of change and discovered the cause-and-effect factors of changes. The developed model is appropriate for the implementation phase of the construction cycle and because the respondents were construction practitioners, including clients, consultants, and contractors. It is most beneficial to the contractor’s organization in the following ways:
  • The contractor can use the model outcome on the rank of change causes as a strategic tool to identify potential causes and reasons. It will accelerate and improve construction performance efficiency if its possible effects are correctly identified and understood.
  • The model outcomes will assist the company in selecting the most appropriate change management model. In addition, it will help to manage potential effects, reducing or even eliminating potential problems that could harm project performance as a whole.
  • The results can also be used to identify potential project managers with sufficient knowledge and experience in project and change management and appropriate change management tools, models, and techniques.
  • The model can also be used to develop high-quality and robust teamwork in managerial positions, allowing them to work under challenging situations caused by unforeseen external factors such as policy changes, economic turmoil, and so on.
  • Because the data used to develop the model was current, the results will provide contractors with awareness in updating their understanding of the critical change management approaches in dealing with recent construction’s change causes.
  • The model results can also be used to inform new company policies aimed at improving construction workers’ and engineers’ skills to find the best solutions for potential change effects, particularly long-term effects.

8. Contribution of the Study

The success of a project is entirely dependent on effective change management. If the adopted change management approach is followed correctly, it will improve work quality and delivery. This study provided a thorough investigation of the causes and effects of the changes in construction. The study’s findings are important to the construction industry for the following reasons. Firstly, they are important for identifying the causes aid in avoiding or minimizing the occurrence of change phenomena. Secondly, identifying the effects of change enables practitioners to learn and appreciate the importance of properly executing communication to reduce and mitigate the negative impact on the overall scope and objectives of the project. Finally, the study developed a SEM model to understand the relationships between causes and effects, which will assist practitioners in relating both factors to comprehend the visual aspect of the phenomenon fully. The model can be used as a visual tool to understand the change causes and effects and how to correlate each cause and effect. It also aids in transforming data into decision-making documents that can be used throughout the project lifecycle.

9. Conclusions

Change is considered a constant element occurring in any construction project. Changes have a direct impact on the project performance. The practitioners argue that the change usually results in rework, which slow down the work performance and causes monetary loss. This loss is not recoverable and creates an extra burden on the client. Hence, changes must be controlled for efficient performance. Otherwise, change can lead to the failure of the projects. Since changes severely impact project time, cost, and quality, this paper successfully established the relationship between the change causes and effects of UAE construction projects through the PLS-SEM modeling approach. It also presents the development and evaluation of the constructed model to ensure that the model is adequate for the determined relationship representation. The model entails that the contractor (CON) group of causes is considered the most significant cause in originating the change. “Owners’ expectations and quality improvement by client” is reported as the major factor in this group. The practitioners pointed out that the owner expectations are very high. Construction activities are labor-intensive and resource-dependent. If any of the staff shows poor workmanship, it affects the work quality. Similarly, if the materials are not uniform in sizes, the quality of the work is affected. It is observed form the model that Quality assurance (QA) is the most significant effect among the effects groups. Poor quality often results in reworking, which has effect on project time and cost. For the practitioners, it is very essential to manage changes for achieving successful construction projects. However, the scope of the research was limited to the study of the UAE construction industry. However, further investigation should cover other countries and produce a comparative study to understand the issue from different aspects wholly. Based on the study’s findings, it is recommended that further investigation be carried out to quantify the effect of change in terms of the time overrun caused, cost overrun, quality, and other relevant quantification measures. Furthermore, other stakeholders such as authorities and other agencies to study their role in generating the issue of change management should be involved in data collection. More research work is required to develop a change management platform that can simplify change through proper approaches, models, and change control methods.

Author Contributions

Conceptualization, I.A.R.; and A.E.S.A.A.; methodology, I.A.R.; and A.E.S.A.A.; software, A.E.S.A.A.; A.S.A.M.A.; validation, A.H.M.; I.A.R.; formal analysis, A.E.S.A.A.;; investigation, A.E.S.A.A.; resources, A.H.M.; I.A.R.; data curation, A.E.S.A.A.; A.S.A.M.A.; writing—original draft preparation, A.H.M.; N.A.-E.; writing—review and editing, A.H.M.; N.A.-E.; visualization, I.A.R.; supervision, I.A.R.; project administration, I.A.R.; funding acquisition, All the authors jointly. All authors have read and agreed to the published version of the manuscript.

Funding

This research received no external funding.

Institutional Review Board Statement

The study was conducted according to the guidelines of the Declaration of University Tun Hussein Onn Malaysia as part of doctoral studies.

Data Availability Statement

Data was collected from the construction practitioners with commitment that it will be kept confidential and used for academic purpose. This data is used for PhD research project undertaken at University Tun Hussein Malaysia. Data can be made available for editorial purpose as and when required.

Acknowledgments

The authors are thankful to Universiti Tun Hussein Onn Malaysia for supporting this research work.

Conflicts of Interest

There is no conflict of interest.

Appendix A

Table A1. Cross-Loading Analysis.
Table A1. Cross-Loading Analysis.
CodeCLECOSCONCOQATO
CLE140.8050.3090.2530.1840.3280.274
CLE180.8340.3770.0060.2410.3890.200
COS50.2550.8100.2270.1350.2560.345
COS70.4390.8900.2270.2230.3750.378
CON100.1490.2400.8330.2450.2740.418
CON140.0570.1770.8280.2650.2820.326
CON160.1660.2320.7860.3310.2300.287
CO110.1160.1600.3160.7620.1520.248
CO130.3010.2110.2540.8940.2230.245
CO150.2010.1490.2630.7600.2060.184
QA120.2840.2390.1280.0310.7160.299
QA140.2950.2640.2150.2040.7540.296
QA80.4140.3520.3530.2730.8480.461
TO100.2350.3490.3450.2260.4080.834
TO120.2300.2660.3080.1150.3800.809
TO60.2210.3870.3550.3050.3370.748
Note: CLE = client-related causes, COS = consultant-related causes, CON = contractor-related causes, CO = cost overrun, QA = quality, TO = time overrun.

References

  1. Enshassi, A.; Al Swaity, E.; Arain, F. Investigating common causes of burnout in the construction industry. Int. J. Constr. Proj. Manag. 2016, 8, 43. [Google Scholar]
  2. Ahmed, A. Fragmentation Problems and Management Strategies in the UAE Construction Industry. Master’s Dissertation, Heriot-Watt University, Dubai, United Arab Emirates, 2017. [Google Scholar]
  3. Abdullahi, M.; Bala, K. Analysis of the Causality Links between the Growth of the Construction Industry and the Growth of the Nigerian Economy. J. Constr. Dev. Ctries. 2018, 23, 103–113. [Google Scholar]
  4. Mohammad, N.; Ani, A.I.C.; Rakmat, R.A.O. Causes and effects of variation orders in the construction of terrace housing projects: A case study in the State of Selangor, Malaysia. Int. J. Supply Chain Manag. 2017, 6, 226–232. [Google Scholar]
  5. Daleure, G. UAE Goes Global. In Emiratization in the UAE Labor Market; Springer: Singapore, 2017; pp. 7–26. [Google Scholar]
  6. Johnson, R.M.; Babu, R.I.I. Time and cost overruns in the UAE construction industry: A critical analysis. Int. J. Constr. Manag. 2018, 402–411. [Google Scholar] [CrossRef]
  7. Hansen, S.; Rostiyanti, S.F.; Rif’at, A. Causes, Effects, and Mitigations Framework of Contract Change Orders: Lessons Learned from GBK Aquatic Stadium Project. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2020, 12, 05019008. [Google Scholar] [CrossRef]
  8. Lukhele, T.; Botha, B.; Mbanga, S. Exploring Project Complexity Relations to Scope Changes in Construction Projects: A Case Study of NEC Projects in South Africa. Constr. Econ. Build. 2021, 21, 18–33. [Google Scholar] [CrossRef]
  9. Fathi, M.; Shrestha, P.P.; Shakya, B. Change Orders and Schedule Performance of Design-Build Infrastructure Projects: Comparison between Highway and Water and Wastewater Projects. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2020, 12, 04519043. [Google Scholar] [CrossRef]
  10. Egan, J.J.; Seder, J.E.; Anderson, D.L. Practices in Construction Change Order Management. Technical Article. Cost Eng. 2012, 54, 12–17. [Google Scholar]
  11. Hasanzadeh, S.; Esmaeili, B.; Nasrollahi, S.; Gad, G.M.; Gransberg, D.D. Impact of owners’ early decisions on project performance and dispute occurrence in public highway projects. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2018, 10, 04518004. [Google Scholar] [CrossRef] [Green Version]
  12. Alnuaimi, A.S.; Taha, R.A.; Mohsin, M.A.; Al-Harthi, A.S. Causes, effects, benefits, and remedies of change orders on public construction projects in Oman. J. Constr. Eng. Manag. 2010, 136, 615–622. [Google Scholar] [CrossRef]
  13. Sambasivan, M.; Deepak, T.J.; Salim, A.N.; Ponniah, V. Analysis of delays in Tanzanian construction industry: Transaction cost economics (TCE) and Structural Equation Modeling (SEM) approach. Eng. Constr. Archit. Manag. 2017, 24, 308–325. [Google Scholar] [CrossRef]
  14. Assaf, S.A.; Al-Hejji, S. Causes of delay in large construction projects. Int. J. Proj. Manag. 2006, 24, 349–357. [Google Scholar] [CrossRef]
  15. Ahmed, S.; Memon, A.H.; Memon, N.A.; Laghari, A.N.; Akhund, M.A.; Imdad, H.U. Common Factors of Cost Escalation in Construction Industry of Pakistan. Eng. Technol. Appl. Sci. Res. 2018, 8, 3508–3511. [Google Scholar] [CrossRef]
  16. Takim, R.; Akintoye, A. Performance indicators for successful construction project performance. In Proceedings of the18th Annual ARCOM Conference, Northumbria, UK, 2–4 September 2002; Volume 2, pp. 545–555. [Google Scholar]
  17. Safapour, E.; Kermanshachi, S. Investigation and analysis of human, organizational, and project based rework indicators in construction projects. In Proceedings of the ASCE International Conference on Computing in Civil Engineering, Atlanta, GA, USA, 17–19 June 2019. [Google Scholar]
  18. Ashworth, A.; Perera, S. Contractual Procedures in the Construction Industry; Routledge: New York, NY, USA, 2018. [Google Scholar]
  19. Padala, S.P.S.; Maheswari, J.U.; Hirani, H. Identification and classification of change causes and effects in construction projects. Int. J. Constr. Manag. 2020. [CrossRef]
  20. Sun, M.; Meng, X. Taxonomy for change causes and effects in construction projects. Int. J. Proj. Manag. 2009, 27, 560–572. [Google Scholar] [CrossRef]
  21. Won, J.; Cheng, J.C.; Lee, G. Quantification of construction waste prevented by BIM-based design validation: Case studies in South Korea. Waste Manag. 2016, 49, 170–180. [Google Scholar] [CrossRef]
  22. Shoar, S.; Chileshe, N. Exploring the Causes of Design Changes in Building Construction Projects: An Interpretive Structural Modeling Approach. Sustainability 2021, 13, 9578. [Google Scholar] [CrossRef]
  23. Alaryan, A.; Emadelbeltagi, A.E.; Dawood, M. Causes and effects of change orders on construction projects in Kuwait. Int. J. Eng. Res. Appl. 2014, 4, 1–8. [Google Scholar]
  24. Memon, A.H. Contractor perspective on time overrun factors in Malaysian construction projects. Int. J. Sci. Environ. Technol. 2014, 3, 1184–1192. [Google Scholar]
  25. Wong, K.Y.; Zeng, D.; Lin, D.Y. Efficient estimation for semi parametric structural equation models with censored data. J. Am. Stat. Assoc. 2018, 113, 893–905. [Google Scholar] [CrossRef]
  26. Abusafiya, H.A.; Suliman, S.A.M. Causes and effects of cost overrun on construction project in Bahrain: Part 2 (PLS-SEM path modelling). Mod. Appl. Sci. 2017, 11, 28–37. [Google Scholar] [CrossRef] [Green Version]
  27. Molenaar, K.; Washington, S.; Diekmann, J. Structural equation model of construction contract dispute potential. J. Constr. Eng. Manag. 2000, 126, 268–277. [Google Scholar] [CrossRef]
  28. Hair, J.F.; Hult, G.T.M.; Ringle, C.; Sarstedt, M. A Primer on Partial Least Squares Structural Equation Modeling (PLS-SEM); Sage Publications: New York, NY, USA, 2017. [Google Scholar]
  29. Byrne, B.M. Structural Equation Modeling with AMOS Basic Concepts, Applications, and Programming; Routledge, Taylor and Francis Group: New York, NY, USA, 2010. [Google Scholar]
  30. Doloi, H.; Sawhney, A.; Iyer, K.C. Structural equation model for investigating factors affecting delay in Indian construction projects. Constr. Manag. Econ. 2012, 30, 869–884. [Google Scholar] [CrossRef]
  31. Islam, M.D.M.; Faniran, O.O. Structural equation model of project planning effectiveness. Constr. Manag. Econ. 2005, 23, 215–223. [Google Scholar] [CrossRef]
  32. Memon, A.H.; Rahman, I.A. SEM-PLS analysis of inhibiting factors of cost performance for large construction projects in Malaysia: Perspective of clients and consultants. Sci. World J. 2014, 2014, 165158. [Google Scholar] [CrossRef] [Green Version]
  33. Khahro, S.H.; Memon, A.H.; Memon, N.A.; Arsal, A.; Ali, T.H. Modeling the Factors Enhancing the Implementation of Green Procurement in the Pakistani Construction Industry. Sustainability 2021, 13, 7248. [Google Scholar] [CrossRef]
  34. Haenlein, M.; Kaplan, A.M. A beginner’s guide to partial least squares (PLS) analysis. Underst. Stat. 2004, 3, 283–297. [Google Scholar] [CrossRef]
  35. Chin, W.W. The partial least squares approach to structural equation modelling. In Modern Methods for Business Research; Marcoulides, G.A., Ed.; Erlbaum: Mahwah, NJ, USA, 1998; pp. 295–336. [Google Scholar]
  36. Chin, W.W.; Newsted, P.R. Structural equation modeling analysis with small samples using partial least squares. In Statistical Strategies for Small Sample Research; Hoyle, R., Ed.; Sage Publications: Thousand Oaks, CA, USA, 1999; pp. 307–341. [Google Scholar]
  37. Rahman, I.A.; Memon, A.H.; Karim, A.T.A. Examining factors affecting budget overrun of construction projects undertaken through management procurement method using PLS-SEM approach. Procedia-Behav. Soc. Sci. 2013, 107, 120–128. [Google Scholar] [CrossRef] [Green Version]
  38. Yong, A.G.; Pearce, S. A beginner’s guide to factor analysis: Focusing on exploratory factor analysis. Tutor. Quant. Methods Psychol. 2013, 9, 79–94. [Google Scholar] [CrossRef]
  39. Zhang, J.; Long, J.; VonSchaewen, A.M.E. How Does Digital Transformation Improve Organizational Resilience?—Findings from PLS-SEM and fsQCA. Sustainability 2021, 13, 11487. [Google Scholar] [CrossRef]
  40. Fornell, C.; Larcker, D.F. Evaluating structural equation models with unobservable variables and measurement error. J. Mark. Res. 1981, 18, 39–50. [Google Scholar] [CrossRef]
  41. Hair, J.F.; Sarstedt, M.; Ringle, C.M.; Mena, J.A. An assessment of the use of partial least squares structural equation modeling in marketing research. J. Acad. Mark. Sci. 2012, 40, 414–433. [Google Scholar] [CrossRef]
  42. Wetzels, M.; Schroder, G.O.; Oppen, V.C. Using PLS path modeling for assessing hierarchical construct models: Guidelines and empirical illustration. MIS Q. 2009, 33, 177–195. [Google Scholar] [CrossRef]
  43. Akter, S.; D’Ambra, J.; Ray, P. An evaluation of PLS based complex models: The roles of Power analysis, Predictive Relevance and GOF Index. In Proceedings of the AMCIS 2011, Detroit, MI, USA, 4–8 August 2011; Available online: http://aisel.aisnet.org/amcis2011_submissions/151 (accessed on 7 July 2020).
Figure 1. Hypothetical model.
Figure 1. Hypothetical model.
Sustainability 14 00596 g001
Figure 2. Demography of the respondents. (a) Academic qualification. (b) Working experience.
Figure 2. Demography of the respondents. (a) Academic qualification. (b) Working experience.
Sustainability 14 00596 g002
Figure 3. Final PLS Model of Causes and Effects of Changes in Construction Projects.
Figure 3. Final PLS Model of Causes and Effects of Changes in Construction Projects.
Sustainability 14 00596 g003
Table 1. Causes and effects of changes constructing constructs.
Table 1. Causes and effects of changes constructing constructs.
S. NoConstructFactor CodeDescription
CAUSES OF CHANGES
1CLE
(Client-Related Factors)
CLE01Clients’ financial problems
2CLE02Late payments
3CLE03Delay in order issuance by clients
4CLE04Owners’ needs
5CLE05Economic inflation
6CLE06Elections and clients’ representative changes
7CLE07Inadequate understanding of clients’ needs
8CLE08Conflicts with consultant and contractor
9CLE09Multiple contractors
10CLE10Clients’ organizational problems
11CLE11Unprofessional clients
12CLE12Clients’ authority change
13CLE13Inadequate site mobilization by contractor
14CLE14Inadequate bidding documents by clients
15CLE15Lack of coordination
16CLE16Replacement of key personnel by clients
17CLE17Lack of capable clients representative
18CLE18Skill shortage on certain trades
19CLE19Unsafe practices during construction
20COS
(Consultant-Related Factors)
CST01Poor material specifications
21CST02Lack of scheduling and planning
22CST03Poor site and work investigation by consultant
23CST04Late revision of designs
24CST05Poor site management team
25CST06Inexperienced consultant
26CST07Poor estimations of cost and quantity
27CST08Multiple consultants
28CST09Poor investigation of project location
29CST10Poor consultant coordination
30CST11New regulations and codes
31CST12Poor prediction of equipment types
32CST13Site restrictions
33CST14Weather conditions
34CST15Geological problems
35CST16Poor distribution of labor
36CON
(Contractor Related Factors)
CON01Inexperienced subcontractors
37CON02Subcontractors’ financial problems
38CON03Errors in contractual documents
39CON04Problems with other organizations
40CON05Government pressure
41CON06Design errors
42CON07Large amount of labor costs
43CON08Conflicts with residents
44CON09Delay in providing utilities
45CON10Owners’ expectations and quality improvement by client
46CON11Large amount of overhead costs (e.g., office rents, contract costs, etc.)
47CON12Unavailability of technical professionals in the contractor’s organization
48CON13Lack of contractor’s administrative personnel
49CON14Low level of labor efficiency/productivity
50CON15Inadequate skill of equipment-operator
51CON16Poor programming of material procurement
52CON17Non-familiarity of contractor with local regulations
53CON18Poor inspection and supervision by contractor
EFFECTS CAUSED DUE TO CHANGES
1TO
(Time Overrun)
TO01Delay in completion schedule
2TO02Logistics delays
3TO03Slower project progress
4TO04Decrease in productivity
5TO05Delay completion schedule
6TO06Dispute between owner and contractor
7TO07Decrease in productivity of workers
8TO08Additional specialist personnel
9TO09Cost overruns due to inflation and fluctuations
10TO10Addition of work
11TO11Deletion of work
12TO12Rework/redesign
13TO13Work duration extension
14TO14Productivity degradation
15CO
(Cost Overrun)
CO01Increase in overhead expenses
16CO02Increase the cost of the projects
17CO03Additional money for contractor
18CO04Delay in payment
19CO05Additional specialist equipment
20CO06Additional health and safety equipment/measure
21CO07Unnecessary procurement
22CO08Accumulations of interest rate on the capital to finance the project
23CO09Waste on abandoned work
24CO10Demolition costs
25CO11Increase in overheads
26CO12Additional equipment and materials
27CO13Additional payment to contractors
28CO14Interrupted cash flow
29CO15Increased retention/contingency sum
30CO16Overtime costs
31CO17Litigation costs
32QA
(Quality Assurance)
QA01Rejected material
33QA02Poor quality of materials
34QA03Changes in materials specifications
35QA04Problems with new materials
36QA05Changes in material types and specifications during construction
37QA06Replacement/substitution of materials
38QA07Quality degradation
39QA08Damage to reputation
40QA09Degradation of health and safety
41QA10Demolition and re-work
42QA11Decrease in quality of work
43QA12Complaints of one or more of the parties to the contact
44QA13Rework of bad quality performance
45QA14Slow response and poor inspection
46QA15Extension of time on the project
47QA16Wastage and under-utilization of man-power resources
48QA17Abandonment of building project
Table 2. Overall performance of the measurement model.
Table 2. Overall performance of the measurement model.
NoAssessmentAchievement
1Individual item reliabilityOutcome: 6 iterative processes were carried out and 70 weak factors were omitted leaving 36 significant manifests for the final output
2Convergent validity Cronbach’s alpharho_AComposite reliabilityAverage variance extracted (AVE)
CLE0.6390.6410.7860.579
CO0.6550.6640.7830.521
CON0.7520.7480.8280.547
CST0.7540.7620.8350.503
QA0.7130.7110.8140.569
TO0.7670.7750.8330.518
3Discriminant validity-Cross-loadingCross loading values of the model are presented in Appendix A. The results show that the cross-loading value for each manifest variable is higher in their relative latent variable than other latent variables (as indicated with bold font). This has confirmed the discriminant validity of the model.
4Discriminant validity—Fornell and Larcker criterion CLECSTCONCOQATO
CLE0.692
CST0.5230.628
CON0.3790.6200.652
CO0.4090.5530.5660.661
QA0.4400.5530.5660.4040.646
TO0.4310.4920.5810.4440.4720.689
Table 3. Test of hypotheses.
Table 3. Test of hypotheses.
ExogenousRelation with EndogenousHypothesist-ValueSignificant Level (>1.96)
CLETOH1: CLE has a significant relationship with TO3.403Significant
CLECOH2: CLE has a significant relationship with CO2.988Significant
CLEQAH3: CLE has a significant relationship with QA1.158Not significant
CSTTOH4: CST has a significant relationship with TO1.608Not significant
CSTCOH5: CST has a significant relationship with CO0.503Not significant
CSTQAH6: CST has a significant relationship with QA2.916Significant
CONTOH7: CON has a significant relationship with TO3.978Significant
CONCOH8: CON has a significant relationship with CO2.680Significant
CONQAH9: CON has a significant relationship with QA2.161Significant
Table 4. Overall performance of the structural model.
Table 4. Overall performance of the structural model.
NoAssessmentAchievement
1Coefficients of determination, R2Outcome: Based on the final model, the R2 values for the structural model are 0.396 for TO, 0.339 for CO, and 0.410 for QA which according to Cohen (1998) specification, the developed model can be classified as having moderate explaining power in representing the impact of the 6 groups of causes and effects on the overall construction project performance
2Effect size, f2Exogenous
construct
Endogenous
construct
R2 includedR2 excludedf2Interpretation
f2 ≥ 0.02 (small)
f2 ≥ 0.15 (medium)
f2 ≥ 0.35 (large)
CLECO0.7200.7160.014No effect
TO0.7700.7700.000No effect
QA0.7160.7140.002No effect
CSTCO0.7200.7140.021Small effect
TO0.7700.7520.078Small effect
QA0.7830.7810.002No effect
CONCO0.7200.6880.114Small effect
TO0.7700.7310.170Medium effect
QA0.7710.7730.002No effect
3Predictive relevancy, q2Exogenous
construct
Endogenous
construct
Q2 includedQ2
excluded
q2Interpretation
q2 ≥ 0.02 (small)
q2 ≥ 0.15 (medium)
q2 ≥ 0.35 (large)
CLECO0.1140.0990.017Small relevant
TO0.1600.1490.013Not relevant
QA0.1480.1400.009Not relevant
CSTCO0.1140.118−0.005Not relevant
TO0.1600.1600.000Not relevant
QA0.1480.1380.012Not relevant
CONCO0.4720.4530.036Small relevance
TO0.1600.1190.049Small relevance
QA0.1480.1250.027Small relevance
Table 5. Calculation of goodnessof fit.
Table 5. Calculation of goodnessof fit.
ConstructsAverage Variance Index (AVE) from Construct Validity and ReliabilityR2 Values
CLE0.612
CON0.769
CST0.694
TO0.5820.396
CO0.7050.339
QA0.6880.410
Average0.6750.381
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations.

Share and Cite

MDPI and ACS Style

Rahman, I.A.; Al Ameri, A.E.S.; Memon, A.H.; Al-Emad, N.; Alhammadi, A.S.A.M. Structural Relationship of Causes and Effects of Construction Changes: Case of UAE Construction. Sustainability 2022, 14, 596. https://doi.org/10.3390/su14020596

AMA Style

Rahman IA, Al Ameri AES, Memon AH, Al-Emad N, Alhammadi ASAM. Structural Relationship of Causes and Effects of Construction Changes: Case of UAE Construction. Sustainability. 2022; 14(2):596. https://doi.org/10.3390/su14020596

Chicago/Turabian Style

Rahman, Ismail Abdul, Abdulla Eisaa Saleh Al Ameri, Aftab Hameed Memon, Nashwan Al-Emad, and Ahmed S. A. Marey Alhammadi. 2022. "Structural Relationship of Causes and Effects of Construction Changes: Case of UAE Construction" Sustainability 14, no. 2: 596. https://doi.org/10.3390/su14020596

APA Style

Rahman, I. A., Al Ameri, A. E. S., Memon, A. H., Al-Emad, N., & Alhammadi, A. S. A. M. (2022). Structural Relationship of Causes and Effects of Construction Changes: Case of UAE Construction. Sustainability, 14(2), 596. https://doi.org/10.3390/su14020596

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
