Article

The Social Risk of High-Speed Rail Projects in China: A Bayesian Network Analysis

1
School of Management Science & Real Estate, Chongqing University, Chongqing 400045, China
2
International Research Center for Sustainable Built Environment, Chongqing University, Chongqing 400045, China
3
Construction Economics and Management Research Center, Chongqing University, Chongqing 400045, China
*
Author to whom correspondence should be addressed.
Sustainability 2020, 12(5), 2087; https://doi.org/10.3390/su12052087
Submission received: 4 February 2020 / Revised: 3 March 2020 / Accepted: 4 March 2020 / Published: 8 March 2020
(This article belongs to the Special Issue Rethinking Social Sustainable Construction Practices)

Abstract

:
In China, high-speed rail projects have brought huge social and economic benefits to the affected regions after they are completed. However, the potential externalities of such projects cause competition for the station during the project planning phase, thus triggering social risks. This paper studies the mechanisms responsible for generating the social risk associated with such high-speed rail projects. Employing typical case studies, a social risk list for a given project is established. Based on the risk list, a Bayesian network model is developed and verified through case studies, expert interviews, and expert grading. Using the model’s functions of reverse inference and sensitivity analysis, the key risk factors, sensitive risk factors, and maximum causal chain are identified. Countermeasures are then proposed to mitigate the social risk, such as increasing the transparency of and democratizing the planning process for high-speed rail projects, improving the mechanism by which local governments can express interest in such projects, and enhancing emergency management mechanisms. The findings provide points of reference for social risk management when it comes to planning high-speed rail projects and, more generally, offer significant guidance for socially sustainable decision-making processes for mega projects with massive externalities.

1. Introduction

In the past two decades, world-renowned achievements have been made in the construction of China’s high-speed rail (HSR) system. The development of HSR has, in turn, produced positive externalities. Regional connectivity has been improved, the concentration of economic activities and production factors in individual cities along the line has been accelerated, and economies of scale and scope have been formed [1]. According to a recent survey, compared to the situation prior to the construction of the HSR system, over 850 million new opportunities have been created to connect, trade, and exchange ideas each year, leading to additional economic activity, stronger innovation, and increased productivity [2]. The HSR system aims to enhance China’s urbanization process by encouraging a complementary relationship among cities and allowing skills and technology to flow to smaller centers, thereby enhancing their competitiveness. By their transport connecting to national and international supply chains and innovation networks, a wide range of local stakeholders are benefited. For the general public, HSR means convenient transportation; for developers, HSR means higher housing prices; and for local governments, HSR represents political capital and local industrial development. Therefore, HSR is an immensely popular undertaking in such areas.
However, the massive externalities of HSR have caused social problems during the planning process. In the national Medium and Long-Term Railway Plan, the overall direction of the HSR (including starting and ending points for segments of the line) has been basically determined. What remains to be completed is clarification of the detailed distribution of HSR lines and stations. In the formal pre-feasibility study reports that are generated for this purpose, there are usually two or three different possible routes for the design of a local railway line and station through different regions, and one of them will be recommended by the experts. During this time, HSR planning is affected not only by objective factors such as geological and economic conditions, but also by the competitive game that plays out among stakeholders. Since 2009, because of the strong appeals from local populations and governments for the implementation of HSR transit in their areas, the “Battle for HSR” has not stopped. Thus, the HSR project, originally designed to be a public welfare project, has instead triggered several mass incidents, including demonstrations, petitions, traffic jams, and even conflicts between police and civilians. The Linshui 5/16 incident is a typical example. This incident occurred during the planning of the Dazhou-Chongqing HSR project in 2015. According to incomplete statistics, tens of thousands of people participated in the petition signing and subsequent march, 68 people (including members of the police force and civilians) were injured, and dozens of vehicles were burned [3]. In addition, there is evidence to suggest that new HSR lines are typically costly during the construction and operation stages [4]. Therefore, even though government plans to construct HSR lines can face public opposition, often organized through social actions, secondary risks to the projects such as locally incurred debts may also be realized during the later stages of these projects. To address such concerns, a ranking methodology to prioritize HSR corridors was proposed by Guirao and Campa and validated in Spain [5]. In China, however, there is no such approach to planning that considers social risks.
To date, research on HSR has primarily focused on the following four aspects [6]: (1) improvement of regional traffic accessibility [7,8]; (2) impact on the labor markets for commuting relations [9]; (3) promotion of industry and regional economy [10,11]; and (4) impact on the competitiveness of other transportation facilities [12]. The existing research has mainly focused on the social and economic effects after HSR is implemented. However, little attention has been given to the social risk bound up with the planning phase—risk generated, in turn, by the expected social and economic effects of HSR during its operational phase. Such risk needs to be studied and addressed. In the present study, the social risk of Chinese HSR projects is defined as the possibility of social instability associated with such projects, due to their potential social and economic externalities—and the active competition among stakeholders to which those externalities may lead during the project planning phase. To reduce the possibility for such social instability, the study analyzes the development process for HSR projects as well as the mechanisms responsible for the social risk they create. A Bayesian network (BN) model is developed to simulate the generation of social risk and the key elements of the risk-generation process are obtained. The findings are significant for governmental efforts to reduce social risk in HSR planning but, more generally, they offer important guidance for socially sustainable decision-making processes for mega projects that may cause social risk via the distribution of external benefits.

2. Literature Review

2.1. The Social Risk of Mega Projects

As the German social scientist Niklas Luhmann noted, we live in a society in which it is impossible not to take risks. As the frequency of human activities increases and the scope of those activities expands, the influence of our decision-making processes on the natural as well as social worlds has also been greatly enhanced [13]. The main components of the risk structure evolve from risk associated with nature to uncertainties arising from human endeavors [14]. Additionally, compared with general engineering projects, there are more stakeholders in complex mega projects. The stakeholders include not only the project developers and contractors but also local governments, community groups, and the public at large [15,16,17]. Thus, mega projects face many risks that may potentially carry a significant impact, as well as a wide range of risk bearers. If these risks cannot be effectively controlled, they will spread to the larger society and threaten social stability [18]. Therefore, with respect to risk management for mega projects, attention should be given not only to risks related to cost overruns, time delays, safety incidents, and other such issues at the project performance level [19,20,21], but also to possible social risks. In previous studies, social risk has been defined as a possibility that can lead to social conflict, which, in turn, causes social instability and disorder [22]. If this possibility becomes concretized, social risk will be transformed into a social crisis, posing a threat to the sustainable development of human beings [23]. Further, Bohorquez defined social risk as the conditions or factors that generate vulnerability in communities in the wake of potentially destructive events [24]. In the Chinese context, Feng described social risk as the probability of political authority being threatened over a certain period [25]. In China, such social risk often manifests itself in the form of mass incidents, such as rallying, marching, petitioning, traffic blocking, collective fighting, and even more destructive collective violence, such as smashing, burning, or even murder.
Social risk management, defined as an institutional and social process that enables the convergence of policies, actors, strategies, and actions, reduces or ameliorates the conditions or factors that generate vulnerabilities in communities after potentially destructive events [16,24,26]. Current studies of social risk management focus on risk assessment [27,28,29,30]. By contrast, there are relatively few studies on the sources and mechanisms of social risk, although some previous work has explored the sources and mechanisms in question [31]. Regarding the sources of social risk, some scholars have argued that it derives from objective factors such as the technical problems of facilities and unscientific decision-making processes [32], whereas others trace the sources to subjective factors, such as the gap between people’s desires and solutions for satisfying those desires [33], general psychological anxiety, or conflicts of interest among groups [34]. Regarding the generation or propagation of social risk, Roger Kasperson put forward the theory of social amplification of risk. He pointed out that the social expansion of risk includes two mechanisms: the mechanism responsible for the propagation of information about risks and the social-response mechanism involved in the uptake of that information [18]. Qu expounded the risk propagation or conduction mechanism systematically, and considered that the risk source, risk characteristics, risk carrier, and risk conduction path are the essential factors bearing on risk conduction [35].
Despite these contributions to the literature, however, key questions remain, especially for mega projects. What is the generation logic by which social risk is propagated from the stage of planning and location to the stage of public crisis? What are the key factors that affect social risk generation? These problems need to be resolved in engineering practice.

2.2. Modeling the Risk-Generation Mechanism

From the view of connection and development afforded by materialist dialectics, we can see that risks are not isolated and stationary but interconnected and dynamic [21]. The generation of risk is a process of qualitative change caused by quantitative change; this process is enabled by a mechanism that has been characterized in the domino theory as well as the energy transfer theory. Heinrich’s domino theory states that accidents result from a chain of sequential issues [36], such that the process by which risk is generated can be described as a chain reaction [37]. Meanwhile, according to the energy release theory proposed by Hadden, the essence of risk generation is the process of energy transfer [38]. Once the energy exceeds the range that the system can bear, it will cause a risk explosion [39]. If we combine these two theories, we can describe the generation of risk as a sequential process, or chain reaction, along the following lines.
In a microscopic view, after a long period of accumulation, the energy associated with social risk bursts out when it breaks through the system’s limit and then transfers to the next link, continues to accumulate once more, then bursts out and transfers again, and so on into wider and wider social spheres. In a more macroscopic view, this process can be divided into three parts: risk factors, risk events, and risk consequences [40]. Risk factors are the source from which risk events develop and a mega project is a system with various risk factors in its internal and external environment [21]. If risk factors are not controlled, energy will accumulate and break through the system’s “load-bearing” range, thereby being transmitted from risk factors to risk events [41]. The concept of risk events thus refers to the accidents or actions through which the energy of social risk is released into the wider socio-physical environment, leading to risk consequences. It is the middle link in the chain of risk generation. Risk consequence corresponds to the final loss of the project. Such loss is usually reflected in the deviation of the actual situation of the project from the expected goal [42]. Hence, cost overruns, time delays, and negative social impacts are all manifestations of risk loss. This macroscopic, three-part model of the mechanism responsible for risk generation is shown in Figure 1.
In terms of research methods that have been used to study the generation mechanism of social risk, qualitative methods are the most used [43]. Zhang proposed a social-amplification framework for social risks connected to engineering projects carrying high environmental risks; this framework includes the transmission, reception, and evolution of risk signals [44]. Based on the theory of social combustion, Xiang constructed a social risk evolution model during the phase of project construction, including the combustion substance, combustion aid, and ignition temperature that cause social risks [45]. Meanwhile, drawing on psychological studies of anxiety, Tan analyzed the mechanism responsible for the social risk of NIMBY (not in my back yard) projects, from breeding, through spreading, to diffusion [46]. These studies outline productive theoretical frameworks for the study of social risk generation and its significance. However, as noted previously, during social risk generation, there are complicated relationships among risk factors, risk events, and risk consequences, and multiple stakeholders are involved. Thus, working only with qualitative models makes it difficult to develop a complete explanation of the risk-generation process. In the present study, a BN analysis is used to overcome this limitation, by explaining the process of social risk generation via the concept of a risk network, in terms of which the mechanism involved can be more fully described and explained.

3. Methodology

The Bayesian network (BN), also known as the belief network, is a method based on probabilistic statistics that is used for analyzing data associated with complex uncertainty problems. A BN is a directed acyclic graph composed of nodes and directed edges connecting these nodes [47]. Variables are represented as nodes and the causal relationship between nodes is represented as directed edges, which generally point from a parent node to a child node. A BN consists of two parts: first, a qualitative description of the problem to be solved (referred to as the BN structure) and, second, a quantitative calculation designed to solve the problem (referred to as the network parameters). The reliability of BNs has been verified through many engineering applications, such as schedule risk management [48], project portfolio risk analysis [49], and stakeholder impact evaluation [50]. Generally speaking, BNs have the following advantages [48]: (1) small samples, as well as incomplete and noisy data sets, can be handled; (2) can be developed using expert opinions instead of historical data and still make reliable predictions; (3) can readily calculate the probability of events before and after the introduction of evidence and update, as necessary, their diagnosis or prediction; and (4) graphs are used to describe the interrelationships among nodes, making those interrelationships intuitive and easy to understand. Therefore, BNs provide an appropriate tool for studying the mechanism that generates social risk in the context of HSR projects.
The present study aimed to analyze the generation mechanism of social risk for HSR projects and suggests ways to reduce such risk. Combining a traditional risk management framework with a well-designed BN model adapted from Van Truong Luu [48], we propose a research framework of four phases. First, we identify risks by studying typical cases of HSR social risk. Second, based on the risk list, the causal link between risks is determined through case studies as well as expert interviews to build the BN structure. To determine the parameters of the risks, both expert interview and expert grading method are used. The BN model is thus developed and then applied to two case studies for validation purposes. Third, using the reverse inference and sensitivity analysis functions of Genie2 (a BN software program), the key risk factors, maximum causal chain, and sensitive risk factors are obtained. Finally, risk-control countermeasures are outlined to address these key points (Figure 2).

4. Research Process

4.1. Risk Identification

To accurately identify the social risks of HSR projects, typical cases first need to be selected and analyzed. Through the Internet, newspapers, and related books, we have collected news reports, expert comments, and video materials about a number of cases of social risk related to HSR projects. To select typical cases from these data, four criteria were eventually established after repeated discussions. The criteria are as follows:
  • The case needs to involve events that happened no more than a decade ago.
  • It needs to have been reported by mainstream media, such that data about the case are readily available.
  • It needs to have caused widespread social concern and had a long-lasting effect on public opinion.
  • It needs to have been associated with an individual incident or mass incident—that is, an incident in which a large group of people participated.
Based on this set of criteria, 10 typical cases of HSR projects were selected for risk identification; they are listed in Table 1. To make it more intuitive, the routes of these HSR projects and administrative regions participating in the HSR competition are shown in Figure 3 of China’s 2020 HSR network.
By combining the relevant concepts from Section 2.2 with the research background for our study of social risk for HSR projects, we formulated the following definitions. The internal and external factors (subjective factors and objective factors) in the cases listed in Table 1 are regarded as risk factors for the social risk associated with the HSR projects. The key decisions or actions of the stakeholders leading to the actual losses (vs. potential risks) are called risk events and the actual losses, including the diminishment of government credibility, damage to personal safety damage, and property loss, are called risk consequences.
The specific operation of identifying risks via the case studies is divided into three steps:
Step 1. Sort out the phenomena, events, actions, and results in the data. For convenience, these elements are collectively referred to as risk performance.
Step 2. Summarize the risk factors, risk events, and risk consequences associated with risk performances. Thus, taking the Linshui 5/16 incident caused by the Dazhou-Chongqing HSR project as an example, in Step 1, nine risk factors, three risk events, and one risk consequence can be extracted (Table 2). In this way, risk identification is performed for each case.
Step 3. Integrate the risks extracted from each case in Step 2. In all, 20 risk factors, three risk events, and one risk consequence were obtained through the process of risk identification. Depending on the source of the risk in question, risk factors and risk events are classified into three categories: those associated with the planning system, those related to the local government, and those pertaining to the local population. For example, risk factors such as “Insufficient sharing of information” and “Demands of different interest groups not being taken into account” come from the planning system. Risk factors such as “Rent-seeking efforts by the local government” and “Fierce intergovernmental competition” come from the local government. Finally, risk factors such as “The local population’s sense of injustice and relative deprivation” come, clearly, from the local population.
The above steps enable the compilation of an accurate risk list detailing risk factors, risk events, risk consequences, and their corresponding sources. Table 3 details the risk list highlighting the social risks that stem from HSR projects in China.

4.2. BN Model Building

4.2.1. Establishing the BN Structure

According to the generation mechanism discussed previously, social risk is transmitted according to a chain path of “risk factor → risk event → risk consequence.” If social risk factors are not controlled in the early stage, the risk energy will start to accumulate. When that energy is amplified to a certain degree, it can lead to risk events. When analyzing our case studies, we found that during the generation process of social risk for HSR projects, there is often more than one risk event. In other words, the risk events of social risk are a series of multi-stage dynamic occurrences involving an interplay between local populations and local governments (see Figure 4).
During the first stage, given a prior probability of relevant risk factors, when the risk energy accumulates beyond the tolerance threshold of the local population, they, as the first movers, decide whether to take action or not. In the cases we examined, the action involves a sequence of individual incidents, such as an individual organizing a petition, writing letters, visiting local officials, and initiating mobilization online.
During the second stage, as the second mover, the local government, observing the action of the local population, decides whether to immediately formulate an emergency response or not, to prevent or at least defuse individual incidents—given the prior probability of risk factors. The theory of risk-society expansion holds that the response of risk managers to information flow can either strengthen or reduce people’s perception of risk and shape their behaviors accordingly, in a manner that may, in turn, bring about new social or economic consequences. These consequences may far exceed the direct harm of the risk event itself, when it comes to human health or the health of the environment, leading to further important indirect effects, and even spreading to society at large [51]. If the government engages in inappropriate behavior or fails to address the issues at hand, then it may, in conjunction with the impact of related risk factors, cause further expansion of the risk.
During the third stage, the prior probability of the risk factors is given and the local population has already observed the emergency response, or lack thereof, on the part of the local government. At this point, the local population decides whether to end the protest or take more drastic actions, such as mobilizing more groups to expand social influence. In the cases we examined, it was at this point that what were individual incidents in the first stage expanded to mass incidents, including mass petition signing drives, traffic congestion, street demonstrations, and conflicts between civilians and police. Once a risk event has evolved into a large-scale mass incident, it invariably gives rise to extensive concern and negative public opinion, greatly damaging the political authority of the government. It may also cause property loss and casualties along with more widespread violence. For these reasons, in China, it is generally believed that the occurrence of large-scale mass incidents will inevitably lead to the risk consequence of social instability [52].
The causal relationships among risk factors, risk events, and risk consequence are the path of risk generation for Chinese HSR projects. This path mirrors the structure of the BN that we use to model the mechanism for risk generation in this context. Based on the risk-generation model and the risk list we created based on the case studies that experts helped us analyze, we posited 25 sets of causal relationships such as “Insufficient sharing of information → Local population: individual incidents,” thereby establishing the structure of the BN of social risk generation for Chinese HSR projects. Figure 5 provides a visualization of our model.

4.2.2. Determining the BN Parameters

To complete our BN model of the mechanism by which social risk is generated for HSR projects, we had to determine the BN parameters. In China, mass social incidents are highly politically sensitive, one-off (difficult to reproduce), and atypical. The data regarding such incidents in China is thus highly limited. Therefore, we used the expert grading method to determine the BN parameters.
As the basis for expert grading, we must find a way to assess the risk level of each of the risk nodes in the BN structure. According to the classic risk theory, the risk level can be measured by a function of likelihood and consequence [16,53]. Therefore, a questionnaire using the five-point Likert scale was designed for evaluating the likelihood of the occurrence and severity of its consequences for each risk node. Based on the practical experience of the experts of mega projects in China, the likelihood of occurrence scale includes scores ranging from 1 to 5, with 1 being “low” and 5 being “very high” (Table 4). Drawing on relevant national policy documents, the severity of consequence scale refers to the losses caused by social risk. It, too, includes scores ranging from 1 to 5, with 1 being “negligible” and 5 being “very serious” (Table 5). With each risk node having been evaluated along these two dimensions, a two-dimensional risk matrix was established. This matrix allowed the risk level of each risk node to be divided into low, medium, and high (Figure 6).
The parameters in the BN model include the prior probability of risk factors and the conditional probability table (CPT) of risk events. First, we determined the prior probability of risk factors by sending questionnaires to selected experts. There were three sections in the questionnaire: Section 1 introduced the background of the questionnaire and the specifics of each individual case to ensure that respondents gained a thorough understanding of the social risks of each of the HSR projects described previously. Section 2 provided a detailed introduction of the assessment criteria in Table 4 and Table 5, and in Section 3, respondents were presented with the social risk assessment that sums up the risk factors associated with the HSR projects, including the likelihood of each of the risk factors occurring and the severity of the risk consequences. A total of 22 experts in the field were invited to complete the questionnaire and 21 valid questionnaires were returned. Experts consisted of the following: professors who have undertaken extensive research on risk management and social conflicts from universities belonging to Project 985 in China; PhD members of the research team working on the present study; senior project managers from the China National Railway Corporation and China Railway Group, Ltd.; and senior managers in engineering consulting enterprises that are ranked in the top 10 in China. They were all proficient in social risk management and familiar with HSR project practice. Thus, we made every effort to ensure that the questionnaire data provided by the experts were credible and authoritative. After the questionnaire data were standardized, the data on risk levels were inputted into the BN using the Access software program to obtain the prior probability of each risk factor.
Then, to obtain the CPT of each risk event node (B1, B2, and B3), discussions were conducted with three top experts in the field of social risk management. Based on relevant materials, these experts evaluated the risk levels of each node in each case in Table 1. Grading data were again standardized and then inputted into GeNIe2 for parameter learning by the EM algorithm to generate CPTs of the risk event nodes. Due to the small number of typical cases in this study, the CPTs were modified manually. However, in the BN structure, the risk event nodes (B1, B2, and B3), as originally represented, had many parent nodes and therefore were very complex CPTs, raising the problems of inconvenience and time-consuming revisions. To address these problems, we changed the node type from “general” to “Noisy-MAX.” Taking the B1 node with three risk states and nine parent nodes as an example, when its node type is “general,” 39 conditional probabilities are required to complete its CPT. By changing its node type to “Noisy-MAX,” the multi-valued Noisy-OR gates proposed and improved by Diez [54] and Srinivas [55] can help model interactions among variables with multiple states and allow for specifying these interactions with few parameters [56]. By undertaking this step, the number of required conditional probabilities were reduced to the number of a given node’s parents [49]. To ensure accuracy, repeated discussions were conducted and node parameters with obvious problems were corrected to the average values provided by the three experts. Once the probability distributions of all a child node’s parent nodes have been established, the GeNie2 software application will automatically calculate the CPT of that child node. Through these procedures, we obtained the CPTs of all the risk event nodes (B1, B2, and B3). After the prior probability of the risk factors and the CPTs of risk events were inputted into the network, a complete BN model was generated.

4.2.3. Model Validation

To ensure the validity of the model, two cases with different risk consequences were used for model verification. The first case, the Dazho–Chongqing HSR project (Case A) was a large-scale mass incident, which resulted in 68 people being injured and incidents of criminal damage. In contrast, the Rizhao–Lankao HSR project (Case B) experienced relatively few protests, with only individual online petitions and no mass incident. By inputting the data of the two cases (from the grading process of the top experts mentioned above) into the model, we obtained the results shown in Figure 7 and Figure 8. From Figure 7, in case A, we see that the probability of a high-risk occurrence of B3 (mass incident) is 79%. Therefore, mass incidents are more likely to occur in such situations, leading to social instability. From Figure 8, in case B, we see that the probability of a low-risk occurrence of B3 (mass incident) is 71%; therefore, that social instability is much less likely. The simulation results of the two cases are clearly different and are consistent with real-world occurrences; thus, the BN model is effective and can be used as the basis for subsequent inference and analysis.

5. Results

BN models have powerful capacities for inference and diagnosis, and the BN applications used in the present study include reverse inference and sensitivity analysis. Reverse inference, also called target-driven or hypothesis-driven reasoning, is useful for diagnosing and explaining the cause of an accident in a manner that runs counter to a directed graph—that is, graph modeling an accident whose result is already determined [57]. Sensitivity analysis refers to a technique for conducting uncertainty analysis; the technique sifts out from several influential factors the sensitive factors that have an especially important impact on the subject. Due to the reverse inference and sensitivity analysis capacities of the BN model, the regularities underlying the generation of social risk can be identified.

5.1. Reverse Inference

5.1.1. Key Risk Factors

As mentioned in Section 4.2.1, in China, the occurrence of large-scale mass incidents is believed to lead to the risk consequence of social instability. Based on the reverse inference algorithm in BNs, the high-risk state of the “Local population: mass incidents” node is set to 100%, which means that social instability is inevitable. Additionally, the percentages of H, M, and L states represent the probability of risk factors/events at different levels of risk when consequences (instances of social instability) occur. Factors with a high-risk state greater than 50% are called key risk factors and are marked yellow Figure 9. Figure 9 shows that the key risk factors include A1, A2, A8, A9, A17, A19, and A20. When one or more of the key risk factors occur, the possibility of social instability is relatively high.

5.1.2. Maximum Causal Chain

In the present study, a maximum causal chain refers to the most likely path that causes the risk consequence. By using the “strength of influence” tool under “network” in GeNie2, the maximum causal chain corresponding to our BN analysis can be generated; it is shown in bold in Figure 10. The interaction between the local population and the local government, that is, the dynamic evolution of risk events of the form B1 → B2 → B3, is the maximum causal chain of social risk. Combined with Figure 9, when a high-level mass incident (B3) occurs, the probability of a high-risk individual incident (B1) is 85%, and the probability that the local government will not handle the individual incident (B2) in a timely fashion is 70%. The results of this analysis are basically consistent with the facts in the cases under study.

5.2. Sensitivity Analysis

In addition to the key risk factors and the maximum causal chain, the sensitive risk factors also need to be considered. Although the absolute probability of the occurrence of such factors is smaller than that of the key risk factors, the factors have a considerable impact on other nodes. By identifying and monitoring sensitive risk factors, we can help managers prevent hidden risks and reduce losses.
To identify the sensitive risk factors, GeNIe2 implements an algorithm proposed by Kjaerulff and Van der Gaag [58], that performs a simple sensitivity analysis in BN. Given a target node, the algorithm efficiently calculates derivatives of the posterior probability distributions over the target node for each of the numerical parameters of the BN [59]. These derivatives highlight the importance of developing precise network numerical parameters for calculating the posterior probabilities of the target, so we call them sensitive values [56,60]. Based on the results of reverse inference, with the “Mass incident” node (B3) set as the target, the sensitivity analysis tool in Genie 2 is used to analyze the sensitivity of each risk factor node (i.e., nodes A1–A20). At the end of this process, we rank the risk factors according to their sensitivity values (Table 6), and, based on the principle of 80/20, take the top 20% (nodes A14, A13, A6, and A4) as the sensitive risk factors. The results are shown in Table 6.
Hence, using the reverse inference and sensitivity analysis capacities of the BN model and combining these capacities with the sources of risk detailed in Table 3, we summarize the results given by the model regarding the social risks of the HSR projects (Table 7).
Therefore, in project management, it is necessary to focus on the risk factors and risk events, as shown in Table 7. It is also imperative to take risk-control countermeasures that limit the likelihood of occurrence of risks, and thereby reduce the potential for risk losses.

6. Discussion of Results and Description of Countermeasures

As part of our discussion of these research results, we turn now to a brief discussion of risk-controlling countermeasures. The government is the main risk manager of social risk in China [15]; therefore, these three countermeasures are mainly formulated for potential adoption by the government.

6.1. First Countermeasure: Increase the Transparency of and Democratize HSR Planning

Based on the results presented in Table 7, several problems affect the process of HSR project planning, including insufficient sharing of information and poor public participation. Moreover, when decision-making officials have biased interests or the planning scheme leads to negative public opinion, these shortcomings are likely to lead to mass incidents. There are two explanations for this pattern. First, in China, HSR project planning is a relatively closed decision-making process limited to experts and these decision-makers lack a mechanism for disclosing information to the public. Hence, changes in planning schemes often generate public opinion utilizing dialogue conducted through unofficial media and, consequently, public opinion rarely receives a positive official response. As the stakeholders of HSR projects, the public is understandably anxious about this information asymmetry. Second, social-impact evaluations of planned HSR projects are currently conducted via Social Stability Risk Assessment. However, this method of risk assessment fails to consider public risk perceptions [61] as key points of “concern assessment” [62]. There is thus little chance the method can prevent the effects of social risk.
In this regard, relevant government departments should start by improving the way information regarding HSR schemes is disseminated, to ensure that this major administrative decision is well publicized—and well-understood by the public. Through government websites, government media, newspapers, radio, television, and other means that are accessible to the public, the basis, process, latest progress, and results of planning schemes can be disclosed in a timely, transparent manner. At the same time, the summary of public opinions and official risk assessments of the project should be disclosed. Second, and with the help of this improved information disclosure, high-quality public participation and engagement should be encouraged. Drawing on the experience of the British Railway Network Company’s Long-Term Planning Process standard [63], while adjusting it for the current cultural and technological conditions in China, we propose three suggestions concerning public participation in planning for HSR projects. First, the local government should provide the public with official online channels to generate more ideas and views. Second, more emphasis should be placed on the nongovernmental organizations that act as mediators between the public and government. Third, the social impact of the planning process should itself be well tracked and evaluated for a period. In these ways, the public can express their opinion in a more civilized and equitable manner, thus defusing social risk.

6.2. Second Countermeasure: Improve the Mechanism by Which Local Governments can Express Interest in HSR Projects

As our analysis suggests, the local population is only one source of the social risk of HSR projects. Further, as indicated in Table 7, the motives and behaviors of local governments are also responsible. In China, the construction of the HSR project is jointly financed by the central government and local governments; local governments inject capital in the form of land, and thus they have their say in the planning of the railway. For example, in the case of the Zhengzhou–Chongqing HSR project, the Henan provincial government has repeatedly put forward suggestions for revisions to the plan and conducted discussions with the railway corporation and various experts about possible adjustments to the plan. In general, local government officials see HSR as a new economic growth point for their region, as they seek to increase the region’s sustainable fiscal revenue. Securing HSR can also be instrumental for their own career advancement. Therefore, in the case of individual incidents, motivated by a free-ride tendency, local governments may choose to acquiesce to public protests to create a public-opinion atmosphere that attracts the attention of superiors, and thus helps them compete for the HSR station. It can be concluded that local governments can intervene in HSR planning through two main channels: (1) by making interest appeals to higher decision-making departments through formal or informal means; and (2) by expanding the influence of these interest appeals through an emphasis on the social risks brought by public discontent.
It is therefore advisable to find a formal approach or establish a legal system that allows local governments to make their interest appeals reasonably and legally and to ensure the effectiveness of those appeals without governments having to resort to the encouragement or at least passive acceptance of mass incidents. First, an organizational structure can be set up for purposes of expressing interest in HSR projects. Relevant decision-making departments of government and experts on HSR projects are the expression subjects and the project risk-control agencies, and acting independently from those expression subjects are the coordination subjects. Second, institutionalized interest expression procedures should be established. For example, local governments can integrate public opinion, economic performance data, and environmental reports, and then submit formal written documents to coordination subjects. To ensure the effectiveness of the system for these expressions of interest by local governments, government departments and experts need to make all these appeals and their associated responses available to the public. In the case of special circumstances, such as major differences between local governments, the coordination subject can organize coordination meetings.

6.3. Third Countermeasure: Enhance Emergency Management Mechanisms

As the key risk factors directly related to civic actions, “Sense of injustice and relative deprivation,” “Civic organizations and group leaders,” and “Imitative and conformist behavior” show the basic logic of collective action. For Stephen P. Robbins, a group is a collection of two or more people with the same interests or emotions who are somehow related to each other [64]. Through their initial contact with members of the group via mass media, group leaders form their own set of cognitive systems and become public-opinion leaders to initiate group mobilization. In the emotions arising from this interaction, the group will form a kind of group consciousness. The members of the group will quickly and without judgment accept certain information and act accordingly, or subconsciously, by imitation, as they respond similarly to a stimulus [65]. Among potential stimuli, “Regional conflict” tends to cause strong individual dissatisfaction and helps create an emotional consensus; this process can quickly improve the cohesion of the group.
To cope with this dynamic, it is necessary to improve the emergency management mechanism used at various stages of risk events. At the stage of individual incidents, the local government should attach great importance to the opinions of the people, pay attention to consultation and social mediation, and promote a responsive system for handling letters and visits as well as a system for receiving visits by group leaders. In addition, to prevent further deterioration of the event, it is necessary to implement real-time monitoring of public-opinion dynamics to stay abreast of the potential for social conflicts and disputes. At the stage of mass incidents, it is necessary to ensure that the emergency management department has a reasonable organizational structure and personnel composition, and to prepare an emergency plan for mass incidents that can be quickly implemented. The command system should mobilize police according to the pre-set plan to control the situation and minimize social and economic losses caused by mass incidents [66]. After the event, accurate information should be released to the media, lessons from the event should be learned, and the whole experience should be concluded with all parties on a good or at least mutually acceptable footing. Emergency plans should also be revised as necessary.

7. Conclusions and Future

According to sociologist Zhao Dingxin, “in recent years, social struggle in China has evolved from a reactive type to an active type [67].” Because of their potential social and economic benefits, HSR projects lead to efforts by the public and local governments to capture such projects for their regions. In the past decade, there have been a number of related mass incidents in China, resulting in adverse social impacts. In this context, the present study explored the mechanism of social risk of HSR projects using a BN model, and, based on the analysis supported by that model, put forward risk-control countermeasures. Our research conclusions can help the government reduce social uncertainty in the planning of HSR projects, in a manner that is conducive to the long-term stability of the country. More broadly, with ongoing economic development and urbanization in China, many projects involving large-scale infrastructures with massive externalities are being planned. At the same time, the Chinese public’s desire to participate in public decision-making processes related to their own interests has increased, due to their increased awareness of rights, including the right to self-expression. Therefore, similar problems are likely to arise around other infrastructure projects. Our findings can thus guide a wide range of social risk scenarios, going forward. The research process and methodology can be applied to the analysis of social risk in other countries, providing a profitable reference.
Our main conclusions are as follows:
  • Through a risk-identification process drawing on typical cases, a risk list containing 20 risk factors, three risk events, and one risk consequence was created; in this list, the risks are divided into three levels according to their source. Based on the causal relationship among the risks identified by the study of typical cases and through interviews with experts, a BN structure was constructed. Using an expert-based grading system, parameters were assigned to each node. The BN model was then applied to two case studies for validation purposes. The results yielded a valid BN model of the generation of social risk for HSR projects.
  • Results from the reverse inference and sensitivity analysis functions of the BN model indicated that nodes A1, A2, A8, A9, A17, A19, and A20 in the model were the key risk factors; that nodes A4, A6, A13, and A14 were the sensitive risk factors; and that B1→B2→B3 was the maximum causal chain. The study then considered ways in which social risk might be effectively controlled. Bringing the above results to bear on the risk sources, including the planning system, local populations, and local governments, the paper proposed three countermeasures: namely, increase the transparency of and democratize HSR planning, improve the mechanism by which local governments can express interest in HSR projects, and enhance emergency management mechanisms.
There are two main limitations to this study. First, the research mainly depends on expert knowledge and is therefore somewhat subjective. This is a problem that also arises in research on China’s emergency management and public-safety management systems [43]. Second, the research is conducted from a macro perspective, without considering the heterogeneity of the public’s perception of risk at the individual level. Given these considerations, further studies should focus on two issues. First, a planning method that balances science and public opinion needs to be developed, to implement optimal—i.e., socially sustainable—decision-making procedures. Second, as big data platforms are gradually used in the field of emergency management, big data analysis of the behavioral patterns of large-scale and heterogeneous actors can be used to improve the objectivity of research in this area and help optimize social risk management.

Author Contributions

Conceptualization, Y.X. and P.X.; Funding acquisition, P.X.; Investigation, Y.X.; Methodology, Y.X.; Software, Y.X.; Supervision, P.X. All authors have read and agreed to the published version of the manuscript.

Funding

The work described in this paper is fully supported by a joint grant from Chongqing Social Science Foundation Project (2018ZD02) and Project 2019CDJSK03PT07, No. 2017CDJSK03XK19, supported by the Fundamental Research Funds for the Central Universities.

Conflicts of Interest

The authors declare no conflict of interest.

References

  1. Chen, Z.H.; Kingsley, H. High Speed Rail and China’s New Economic Geography; Edward Elgar Publishing: Cheltenham/Northampton, UK, 2019; pp. 1–4. [Google Scholar]
  2. Martha, L.; Richard, B.; Liu, Z.M. China’s High-Speed Rail Development; World Bank Publications: Washington, DC, USA, 2019; pp. 73–74. [Google Scholar]
  3. Linshui 5•16 Incident. Available online: https://baike.baidu.com/item/5%C2%B716%E9%82%BB%E6%B0%B4%E7%BE%A4%E4%BC%97%E8%81%9A%E9%9B%86%E6%B8%B8%E8%A1%8C%E4%BA%8B%E4%BB%B6/17574386?fr=aladdin (accessed on 18 May 2015).
  4. Guirao, B. Spain: Highs and lows of 20 years of HSR operation. J. Transp. Geogr. 2013, 31, 201–206. [Google Scholar] [CrossRef]
  5. Guirao, B.; Campa, J.L. The construction of a HSR network using a ranking methodology to prioritise corridors. Land Use Policy 2014, 38, 290–299. [Google Scholar] [CrossRef]
  6. Dong, S.; Yang, Y.; Li, F.; Cheng, H.; Li, J.; Bilgaev, A.; Li, Z.; Li, Y. An evaluation of the economic, social, and ecological risks of China-Mongolia-Russia high-speed railway construction and policy suggestions. J. Geogr. Sci. 2018, 28, 900–918. [Google Scholar] [CrossRef] [Green Version]
  7. Urena, J.M.; Menerault, P.; Garmendia, M. The high-speed rail challenge for big intermediate cities: A national, regional and local perspective. Cities 2009, 26, 266–279. [Google Scholar] [CrossRef]
  8. Masson, S.; Petiot, R. Can the high speed rail reinforce tourism attractiveness? The case of the high speed rail between Perpignan (France) and Barcelona (Spain). Technovation 2009, 29, 611–617. [Google Scholar] [CrossRef]
  9. Guirao, B.; Campa, J.L.; Casado-Sanz, N. Labour mobility between cities and metropolitan integration: The role of high speed rail commuting in Spain. Cities 2018, 72, 140–154. [Google Scholar] [CrossRef]
  10. Hensher, D.A.; Ellison, R.B.; Mulley, C. Assessing the employment agglomeration and social accessibility impacts of high speed rail in Eastern Australia. Transportation 2014, 41, 463–493. [Google Scholar] [CrossRef]
  11. Wang, J.E.; Jiao, J.J.; Jin, F.J. Spatial effects of high-speed rails on interurban economic linkages in China. Acta Geogr. Sin. 2014, 69, 1833–1846. [Google Scholar]
  12. Christiaan, B.; Eric, P. Intermodal competition in the London–Paris passenger market: High-Speed Rail and air transport. J. Urban Econ. 2012, 71, 278–288. [Google Scholar]
  13. Barnes, M. A Long Terra View of Project Management—Its Past and Its Likely Future. In Proceedings of the 16th World Congress on Project Management, Berlin, Germany, 20–24 May 2002. [Google Scholar]
  14. Xiang, P.C.; Jia, F.Y.; Li, X.H. Critical Behavioral Risk Factors among Principal Participants in the Chinese Construction Industry. Sustainability 2018, 10, 3158. [Google Scholar] [CrossRef] [Green Version]
  15. He, Z.; Huang, D.; Zhang, C.; Fang, J. Toward a Stakeholder Perspective on Social Stability Risk of Large Hydraulic Engineering Projects in China: A Social Network Analysis. Sustainability 2018, 10, 1223. [Google Scholar] [CrossRef] [Green Version]
  16. Liu, Z.Z.; Zhu, Z.W.; Huang, H.J.; Huang, J. Handling social risks in government-driven mega project: An empirical case study from West China. Int. J. Proj. Manag. 2016, 34, 202–218. [Google Scholar] [CrossRef]
  17. Yang, R.J.; Zou, P.X.W. Stakeholder-Associated Risks and their Interactions in Complex Green Building Projects: A Social Network Model. Build. Environ. 2014, 73, 208–222. [Google Scholar] [CrossRef]
  18. Kasperson, R.E. The Social Amplification of Risk: Progress in Developing an Integrative Framework. Social Theories of Risk; Greenwood Press: Westport, CT, USA, 1992; pp. 153–178. [Google Scholar]
  19. Baloi, D.; Price, A.D.F. Modelling global risk factors affecting construction cost performance. Int. J. Proj. Manag. 2003, 21, 261–269. [Google Scholar] [CrossRef]
  20. Assaf, S.A.; Al-Hejji, S. Causes of delay in large construction projects. Int. J. Proj. Manag. 2006, 24, 349–357. [Google Scholar] [CrossRef]
  21. Hallowell, M.; Esmaeili, B.; Chinowsky, P. Safety risk interactions among highway construction work tasks. Constr. Manag. Econ. 2011, 29, 417–429. [Google Scholar] [CrossRef]
  22. Lin, Y. Policy thinking of strengthening social risk management in China. Comp. Econ. Soc. Syst. 2002, 6, 16–19. [Google Scholar]
  23. Beek, U. Ecological Politics in an Age of Risk; Polity Press: Cambridge, UK, 1995; p. 77. [Google Scholar]
  24. Bohorquez, J.E.T. Development and social risk management: an historical contradiction? Rev. Geogr. Norte. Gd. 2011, 48, 133–157. [Google Scholar]
  25. Feng, Z.Z.; Huang, Z. Primary and Secondary Social Stability Risk: Classification and elimination. J. Beijing Norm. Univ. (Soc. Sci.) 2014, 5, 106–111. [Google Scholar]
  26. Mosley, P.; Holzmann, R.; Jorgensen, S. Social protection as social risk management: Conceptual underpinnings for the social protection sector strategy paper. J. Int. Dev. 1999, 11, 1005–1027. [Google Scholar]
  27. Cernea, M.M.; Mcdowell, C. Risks and Reconstruction: Experiences of Resettlers and Refugees; World Bank Publications: Washington, DC, USA, 2000; p. 11. [Google Scholar]
  28. Chen, L.; Wu, K.Z.; Tan, J.H.; Li, M.F. Study on Social Risk Appraise of Construction Project in China—A Case from Guangzhou. Appl. Mech. Mater. 2012, 174, 2916–2924. [Google Scholar] [CrossRef]
  29. Mei, G.D.; Wu, Z.Z. Study on Social Risk Evaluation Index System for Tailings Pond Dam-Break Based on the Vulnerability Theory. Adv. Mater. Res. 2012, 594, 2301–2308. [Google Scholar] [CrossRef]
  30. Mahmoudi, H.; Renn, O.; Vanclay, F.; Hoffmann, V.; Karami, E. A Framework for Combining Social Impact Assessment and Risk Assessment. Environ. Impact Assess. 2013, 43, 1–8. [Google Scholar] [CrossRef]
  31. Hou, G.H.; Wang, Y.D. NIMBY risk chain: A risk explanation framework for the evolution of NIMBY crisis. Fudan Public Adm. Rev. 2015, 1, 11–205. [Google Scholar]
  32. Wei, C.; Yu, S. Perspective on Social Stability Risk Assessment for Major Projects—The Social Stability Risk Assessment for Rail Transit Projects. J. Shanghai Ship Shipp. Res. Inst. 2013, 36, 8–11. [Google Scholar]
  33. Xu, W.H. Government Management under Crisis Situation; China Renmin University Press: Beijing, China, 1998. [Google Scholar]
  34. Zhang, Y.L.; Xu, G.Q. Research on the Social Stability Risk Assessment System of Major Events—The Experience and Enlightenment of Huaian Model. J. People’s Public Secur. Univ. China (Soc. Sci. Ed.) 2010, 3, 106–110. [Google Scholar]
  35. Qu, Y.F.; Wang, H.M. The analysis of the South-North Water Diversion Project’s social risk based on risk conduction mechanism. In Proceedings of the International Conference on E-Business and E-Government, Shanghai, China, 6–8 May 2011. [Google Scholar]
  36. Chi, S.; Han, S. Analyses of systems theory for construction accident prevention with specific reference to OSHA accident reports. Int. J. Proj. Manag. 2013, 31, 1027–1041. [Google Scholar] [CrossRef] [Green Version]
  37. Heinrich, H.W. Industrial accident prevention: a scientific approach. Ind. Labor Relat. Rev. 2011, 4, 609. [Google Scholar]
  38. Huang, W.C.; Shuai, B.; Zhang, Y.; Yu, Y.C.; Xu, Y.F. Study on formation mechanism of risk field in railway dangerous goods transportation system based on superposition-triggering principle. J. Safety Sci. Technol. 2019, 15, 144–150. [Google Scholar]
  39. You, P.F. Risk Mechanism Analysis of Subway Tunnel Construction. China Safety Sci. J. 2012, 22, 116–120. [Google Scholar]
  40. Xiang, P.C.; Lu, T. Discussion on risk generation mechanism of engineering project. Constr. Econ. 2011, 9, 45–47. [Google Scholar]
  41. Xiang, P.C.; Zhang, Y.; Zhang, J.H. Research on Behavior Risk Transmission Mechanism of Engineering Project Subjects. Constr. Econ. 2012, 8, 47–50. [Google Scholar]
  42. Xiang, P.C.; Xie, L.L.; Wang, L.; Zhao, Y.L. Discussion on Engineering Project Integrated Risk Management. Constr. Econ. 2008, 5, 37–39. [Google Scholar]
  43. Luo, X.H.; Hu, L.Y.; Liu, D.H. Social stability risk assessment of major engineering project under conditions of black-box operation and information disclosure: Dynamic game analysis based on hierarchical Bayesian network. Technol. Econ. 2018, 37, 120–133. [Google Scholar]
  44. Zhang, X.C.; Shi, G.Q.; Liu, H.C.; Liu, N. Social Stability Risk Types and Social Amplification Effect of High Environmental Risk Projects. J. Eng. Stud. 2018, 10, 288–296. [Google Scholar]
  45. Xiang, P.C.; Zhang, H.B. Evolving Mechanism of Social Stability Risk and Preventive Measures for Major Environmental Risk Engineering Projects—Based on Social combustion theory. J. Social. Theory Guide 2016, 3, 12–15. [Google Scholar]
  46. Tan, S. The Formation and Prevention to the Social Risk of NIMBY Project from Axiety Psychological Perspective. J. Beijing Univ. Aeronaut. Astronaut. (Soc. ScI. Ed.) 2013, 26, 25–29. [Google Scholar]
  47. Janjić, A.; Stanković, M.; Velimirović, L. Multi-criteria Influence Diagrams—A Tool for the Sequential Group Risk Assessment; Springer International Publishing: Berlin, Germany, 2015; pp. 165–193. [Google Scholar]
  48. Luu, V.T.; Kim, S.; Van Tuan, N.; Ogunlana, S.O. Quantifying schedule risk in construction projects using Bayesian belief networks. Int. J. Proj. Manag. 2009, 27, 39–50. [Google Scholar] [CrossRef]
  49. Ghasemi, F.; Sari, M.; Yousefi, V.; Falsafi, R.; Tamošaitienė, J. Project Portfolio Risk Identification and Analysis, Considering Project Risk Interactions and Using Bayesian Networks. Sustainability 2018, 10, 1609. [Google Scholar] [CrossRef] [Green Version]
  50. Yu, T.; Man, Q.; Wang, Y.; Shen, G.Q.; Hong, J.; Zhang, J.; Zhong, J. Evaluating different stakeholder impacts on the occurrence of quality defects in offsite construction projects: A Bayesian-network-based model. J. Clean Prod. 2019, 241, 118390. [Google Scholar] [CrossRef]
  51. Liu, H.J.; Li, S.Z. The Amplification of Social Risk and Its Control Under the Context of Gender Imbalance: Case Study of Mass Disturbance. China Soft Sci. 2010, 5, 152–160. [Google Scholar]
  52. Zhu, D.M. Decision Making and the Source of Risk: Governance from the Source for Social Stability. J. Public Manag. 2015, 12, 137–160. [Google Scholar] [CrossRef]
  53. Shi, Q.; Liu, Y.; Zuo, J.; Pan, N.; Ma, G. On the management of social risks of hydraulic infrastructure projects in China: A case study. Int. J. Proj. Manag. 2015, 33, 483–496. [Google Scholar] [CrossRef]
  54. Diez, F.J. Parameter adjustment in Bayes networks. The Generalized Noisy-OR gate. In Proceedings of the Ninth Annual Conference on Uncertainty in Artificial Intelligence; Morgan Kaufmann: San Mateo, CA, USA, 1993; pp. 99–105. [Google Scholar]
  55. Srinivas, S. A generalization of the Noisy-OR model. In Proceedings of the Ninth Annual Conference on Uncertainty in Artificial Intelligence; Morgan Kaufmann: San Mateo, DC, USA, 1993; pp. 208–215. [Google Scholar]
  56. GeNIe Modeler User Manual. Available online: https://www.renrendoc.com/p-22200243.html (accessed on 29 September 2019).
  57. Liang, C.; Ghazel, M.; Cazier, O.; Bouillaut, L.; El-Koursi, E. Bayesian Network Modeling Applied on Railway Level Crossing Safety. In Proceedings of the International Conference on Reliability, Safety and Security of Railway Systems, Pistoia, Italy, 14 November 2017. [Google Scholar]
  58. Kjærulff, U.; Van der Gaag, L.C. Making Sensitivity Analysis Computationally Efficient. In Proceedings of the 16th Conference on Uncertainty in Artificial Intelligence, San Francisco, CA, USA, 30 June–3 July 2000. [Google Scholar]
  59. Halabi, A.; Kenett, R.S.; Sacerdote, L. Using dynamic bayesian networks to model technical risk management efficiency. Qual. Reliab. Eng. Int. 2017, 33, 1179–1196. [Google Scholar] [CrossRef]
  60. Gomez, C.; Victor, F.; Arnaldo, V.; Rosa, M.; Villegas, D.; Puntero, P.; Zheng, D.L. Bayesian Network Modelling of ATC Complexity Metrics for Future SESAR Demand and Capacity Balance Solutions. Entropy 2019, 21, 379. [Google Scholar] [CrossRef] [Green Version]
  61. Hu, X.M.; Zhang, L.Y. The Analysis on the Predicament and Countermeasures of Social Stability Risk Assessment of Major Projects from the Perspective of Scientism and Humanism. Adm. Tribune 2018, 2, 118–125. [Google Scholar]
  62. White Paper on Risk Governance: Towards an Integrative Approach. Available online: www.irgc.org (accessed on 14 December 2009).
  63. Running the Railway/Long Term Planning. Available online: https://www.networkrail.co.uk/running-the-railway/long-term-planning/ (accessed on 4 March 2020).
  64. Stephen, P.R. Organizational Behavior; China Renmin University Press: Beijing, China, 2016; pp. 218–219. [Google Scholar]
  65. Gustave, L.B. The Crowd: A Study of the Popular Mind; China Friendship Publishing: Beijing, China, 2019; pp. 21–22. [Google Scholar]
  66. Liu, D.H.; Su, Y. Scenario optimal model of social mediatio, information warning and police deploy in mass incident. Syst. Eng. Theory Pract. 2014, 34, 147–156. [Google Scholar]
  67. Zhao, D.X. Social movement and revolutions; Social Sciences Academic Press: Beijing, China, 2014; p. 116. [Google Scholar]

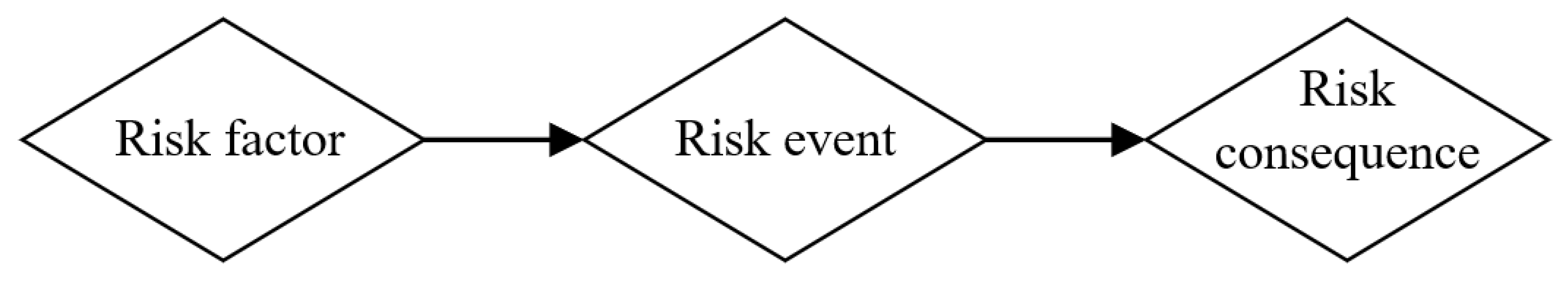

Figure 1. General mechanism of risk generation.
Figure 1. General mechanism of risk generation.
Sustainability 12 02087 g001

Figure 2. Research framework.
Figure 2. Research framework.
Sustainability 12 02087 g002
Figure 3. Sketch map of typical HSR lines and contender regions (2020).
Figure 3. Sketch map of typical HSR lines and contender regions (2020).
Sustainability 12 02087 g003
Figure 4. The path of social risk generation for HSR projects in China.
Figure 4. The path of social risk generation for HSR projects in China.
Sustainability 12 02087 g004

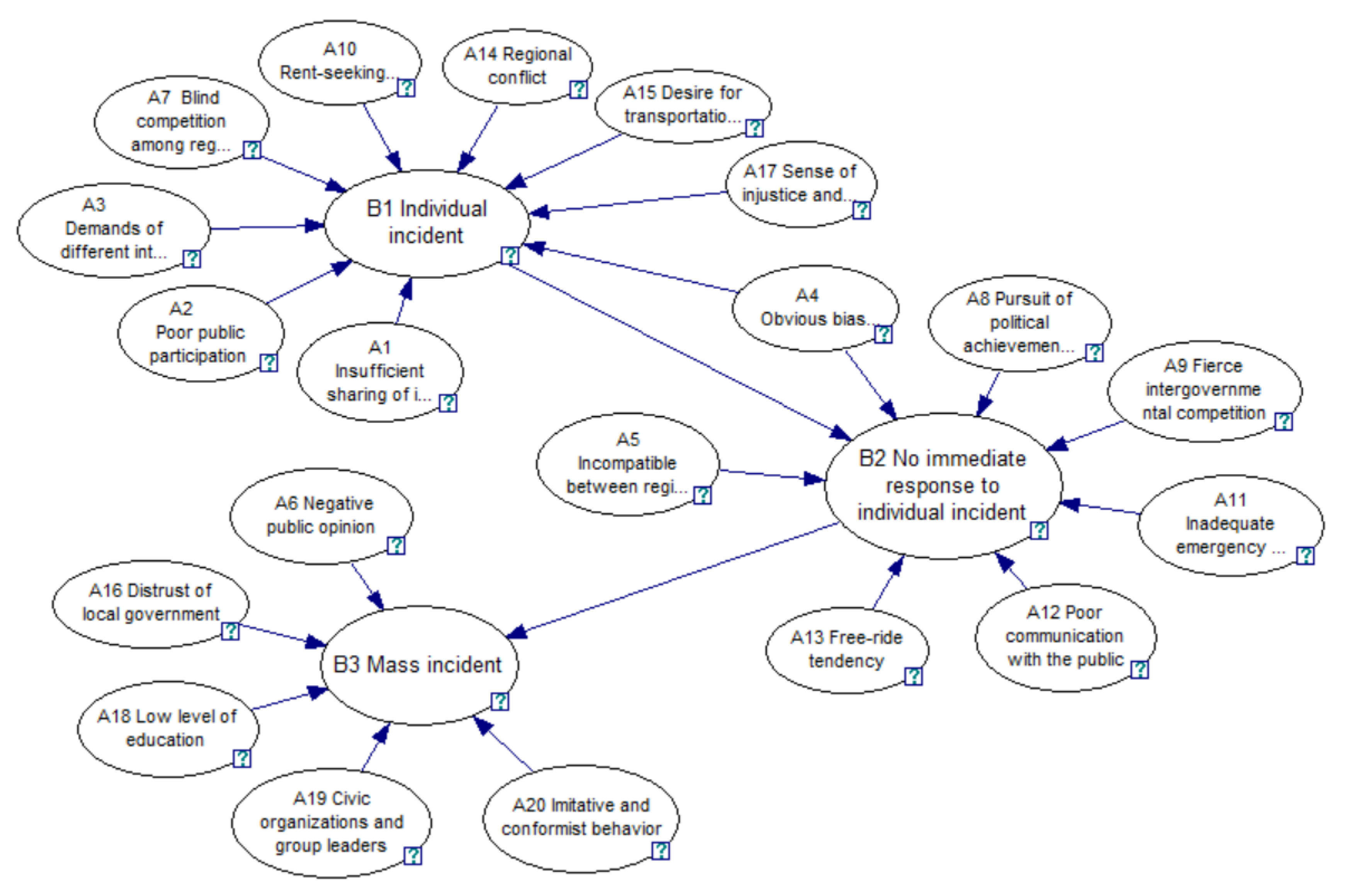

Figure 5. Bayesian network (BN) structure of social risk generation for HSR projects in China.
Figure 5. Bayesian network (BN) structure of social risk generation for HSR projects in China.
Sustainability 12 02087 g005
Figure 6. Two-dimensional matrix for risk assessment.
Figure 6. Two-dimensional matrix for risk assessment.
Sustainability 12 02087 g006

Figure 7. The BN simulation result of case A.
Figure 7. The BN simulation result of case A.
Sustainability 12 02087 g007
Figure 8. The BN simulation result of case B.
Figure 8. The BN simulation result of case B.
Sustainability 12 02087 g008

Figure 9. Reverse inference result and key risk factors.
Figure 9. Reverse inference result and key risk factors.
Sustainability 12 02087 g009

Figure 10. Maximum causal chain result in BN.
Figure 10. Maximum causal chain result in BN.
Sustainability 12 02087 g010
Table 1. Typical cases of social risk for high-speed railway (HSR) projects.
Table 1. Typical cases of social risk for high-speed railway (HSR) projects.
Project NameHSR Contender
(Indicated by the Name of the Administrative Region)
Behavior of Local PeopleResponse of Local GovernmentInitial Decision of HSR StationFinal Decision of HSR Station
Shanghai–Kunming HSRShaoyang, LoudiDemonstrations and petition signing; displaying banners and demonstrations against local governmentSupporting the demonstrators and actively striving to capture the projectStation in LoudiStations in both cities
Zhengzhou–Chongqing HSR (1)Shiyan, Xiangyang Demonstrations and large-scale petition signing; online votingSupporting the demonstrators and actively striving to capture the projectUndecided Station in Xiangyang
Zhengzhou–Chongqing HSR (2)Dengzhou, XinyeSetting up nongovernmental organizations; demonstrations and petition signing; displaying banners all over the areaSupporting the demonstrators and actively striving to capture the projectStation in DengzhouStation located between the two cities
Shanghai–Hangzhou–Rong River HSRJingzhou, JingmenOrganizing initiatives in multiple locations; petition signing (more than 10,000 signatures)Following the planning directives of the superior Planning DepartmentUndecidedStation in Jingmen
Dazhou–Chongqing HSRLinshui, Guang’anMass demonstrations; displaying banners and demonstrations against government officials; petition signing (more than 10,000 signatures); conflicts between police and civiliansSupporting the demonstrators and actively striving to capture the projectUndecidedStations in both cities
Chongqing–Xi’an HSRWanzhou, DazhouMassive social network campaigns and disputes; massive use of online votingSupporting the demonstrators and actively striving to capture the projectStation in WanzhouUndecided
Beijing–Kowloon HSRGushi, HuangchuanPetition signing (more than 10,000 signatures); displaying banners all over the areaSupporting the demonstrators and actively striving to capture the projectStation in HuangchuanUndecided
Chengdu–Guiyang HSRLuzhou, Yibin Petition signing (more than 10,000 signatures); “netizens” write to the ministry of railways; massive social network campaigns and disputesSupporting the demonstrators and actively striving to capture the projectUndecided Station in Yibin
Huhehaote-Nanning HSRJiyuan, LuoyangLarge-scale petitions organized onlineSupporting the demonstrators and actively striving to capture the projectUndecidedStation in both cities
Rizhao–Lankao HSRZoucheng, QufuSmaller-scale petitions organized online by individualsFollowing the planning directives of the superior Planning DepartmentUndecidedStation in Qufu
Table 2. Risk identification for the Dazhou–Chongqing HSR project.
Table 2. Risk identification for the Dazhou–Chongqing HSR project.
Risk Factor/Event/ConsequenceRisk PerformanceName
Risk factorBefore being classified as part of Guang’an, Linshui had a larger population and a more developed economy than Guang’an. After Linshui was classified as part of Guang’an, the pace of its economic development and the quality of its former residents’ welfare were not as good as they were for the long-term residents of Guang’an, resulting in discord between the former residents of Linshui and the original Guang’an people.Regional conflicts
In the master plan of Linshui County 2009–2030, Linshui County is positioned as the transportation hub of eastern Sichuan and northern Chongqing. Railway lines and railway stations have been planned for the southeast portion of the county. However, there is no railway in Linshui County currently.Incompatibility between regional and local levels of planning for economic development
People believe that the railway can utilize the geographical advantages of Linshui County and improve what is perceived as the economic backwardness of Linshui. Therefore, the local population has built up large expectations for the Dazhou-Chongqing HSR.The local population’s desire for transportation facilities
Officials of the Guang’an municipal government visited the superior Planning Department and demanded that the route of the Dazhou-Chongqing HSR be changed to Guang’an.The influence of rent-seeking by the local government
Individuals set up “road-protecting” QQ groups to divide up online the tasks undertaken in support of the HSR.The influence of civic organizations and group leaders
Sentence in the petition: “We don’t want a few people to determine the historical fate of the two counties off the top of their heads. Instead, a fair, carefully reasoned decision is urgently needed.”The local population’s sense of injustice and relative deprivation
Leaders of Guang’an City state that they will only accept the western line plan. At the same time, leaders of Linshui County are also striving to capture the project. Fierce intergovernmental competition
In the process of HSR planning, there is no effective social risk assessment and no formal way for people to express their demands.Poor public access to participation in the planning process
A total of 68 people (including police and civilians) are injured, several vehicles are burned, and property is lost. The credibility of the local government is seriously diminished.Insufficient emergency management capacity of local government
Risk eventSome people wrote letters and paid visits to the county party committee and county government. Some initiated petitions on community websites such as “Spicy Community.” On May 12, a small-scale petition signing initiative was launched in Huangtongshu Park.Local population involved in an individual incident
Over the next two days, neither the petition on the Internet nor the petition signing event was responded to by the government.Local government fails to provide an immediate response to the individual incident
On May 14, the voices of those organizing demonstrations and expressing appeals on the streets became mainstream. On May 16, tens of thousands of people gathered and marched in the streets. Later, police–civilian clashes occur and traffic trunk roads were blocked.Local population involved in a mass incident
Risk consequenceA total of 68 people (including police and civilians) were injured, several vehicles were burned, and property was lost. The credibility of the local government was seriously diminished.Social instability
Table 3. Risk list.
Table 3. Risk list.
Risk Factor
/Event/Consequence
Sources of RiskNo.Name
Risk factor
A
Planning systemA1Insufficient sharing of information
A2Poor public participation
A3Demands of different interest groups not being taken into account
A4Obvious bias of decision-makers
A5Incompatibility between regional and local levels of planning for economic development
A6Negative public opinion
A7Blind competition among regions, industries, and groups
Local governmentA8Pursuit of political achievements/reputation
A9Fierce intergovernmental competition
A10Rent-seeking efforts by local government
A11Inadequate emergency management capability
A12Poor communication with the public
A13Free-ride tendency
Local populationA14Regional conflict
A15Desire for transportation facilities
A16Distrust of local government
A17Sense of injustice and relative deprivation
A18Low level of education
A19Civic organizations and group leaders
A20Imitative and conformist behavior
Risk event
B
Local populationB1Individual incident
Local governmentB2No immediate response to individual incident
Local populationB3Mass incident
Risk consequence C-CSocial instability
Table 4. Scale for the likelihood of occurrence.
Table 4. Scale for the likelihood of occurrence.
Questionnaire Value12345
Namelowmedium lowgeneralhighvery high
Probability0–0.20.2–0.40.4–0.60.6–0.80.8–1
Table 5. Scale for the severity of consequences.
Table 5. Scale for the severity of consequences.
Questionnaire ValueNameDetailed Description
1negligibleNo (or little) public opposition
No negative public opinion or effect on governmental authority
No property loss and no injuries
2lessIndividual opposition that can be resolved through effective work
Minimal negative public opinion and effect on governmental authority
Little property loss and no injuries
3mediumSmall-scale conflicts that can be immediately alleviated via on-site management
Little negative public opinion and effect on governmental authority
Moderate property losses and individual injuries
4seriousMedium-scale conflicts that require external assistance to mitigate
Considerable negative public opinion and effect on governmental authority
Large property losses and some casualties
5very seriousLarge-scale mass incidents or extreme incidents involving individuals
Widespread negative public opinion and significantly negative effect on governmental authority
Extensive property damage and numerous casualties
Table 6. Sensitive values of risk factors for “mass incident”.
Table 6. Sensitive values of risk factors for “mass incident”.
RankRisk FactorSensitive ValueRankRisk FactorSensitive Value
1A140.74211A160.101
2A130.40312A20.074
3A60.35213A120.042
4A40.26714A10.041
5A30.24415A200.039
6A50.20716A80.029
7A70.20517A170.029
8A100.20518A150.025
9A110.19119A90.024
10A180.15420A190.020
Table 7. Summary of results.
Table 7. Summary of results.
Sources of RiskKey Risk FactorSensitive Risk FactorLink in the
Maximum Causal Chain
Planning systemA1 (Insufficient sharing of information)A6 (Negative public opinion)-
A2 (Poor public participation)A4 (Obvious bias of decision-makers)
Local populationA17 (Sense of injustice and relative deprivation)A14 (Regional conflict)B1 (Individual incidents)
A19 (Civic organizations and group leaders)B3
(Mass incidents)
A20 (Imitative and conformist behavior)
Local government A8 (Pursuit of political achievements/reputation)A13 (Free-ride tendency)B2 (No immediate response to individual incident)
A9 (Fierce intergovernmental competition)
A20 (Imitative and conformist behavior)

Share and Cite

MDPI and ACS Style

Xue, Y.; Xiang, P. The Social Risk of High-Speed Rail Projects in China: A Bayesian Network Analysis. Sustainability 2020, 12, 2087. https://doi.org/10.3390/su12052087

AMA Style

Xue Y, Xiang P. The Social Risk of High-Speed Rail Projects in China: A Bayesian Network Analysis. Sustainability. 2020; 12(5):2087. https://doi.org/10.3390/su12052087

Chicago/Turabian Style

Xue, Yutong, and Pengcheng Xiang. 2020. "The Social Risk of High-Speed Rail Projects in China: A Bayesian Network Analysis" Sustainability 12, no. 5: 2087. https://doi.org/10.3390/su12052087

APA Style

Xue, Y., & Xiang, P. (2020). The Social Risk of High-Speed Rail Projects in China: A Bayesian Network Analysis. Sustainability, 12(5), 2087. https://doi.org/10.3390/su12052087

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
