Article

Is Public–Private Partnership (PPP) a Preferred Strategy for Procuring Smart Infrastructure in Developed Countries: An Empirical Study of the Perceived Benefits, Barriers and Recommended Strategies

by
Nimesha Sahani Jayasena
1,*,
Daniel W. M. Chan
1 and
Mohan M. Kumaraswamy
2
1
Department of Building and Real Estate, The Hong Kong Polytechnic University, Hung Hom, Kowloon, Hong Kong, China
2
Department of Civil Engineering, The University of Hong Kong, Pokfulam Road, Hong Kong, China
*
Author to whom correspondence should be addressed.
Sustainability 2022, 14(11), 6421; https://doi.org/10.3390/su14116421
Submission received: 4 April 2022 / Revised: 18 May 2022 / Accepted: 20 May 2022 / Published: 24 May 2022
(This article belongs to the Special Issue Smart Cities, Connected Communities, and Environmental Sustainability)

Abstract

:
Attention to Smart Infrastructure (SI) has risen due to its advantages, including better access, increased quality of life, and simplified maintenance management. To develop SI, Public–Private Partnerships (PPPs) are identified as potentially beneficial procurement strategies, which boost capacities to manage risks by pooling diverse resources. However, the applicability of PPP in SI developments in developed countries is scarcely researched. This may be due to underestimating the other potential benefits from PPP, although developed countries may have their own funding to develop SI. Hence, this research aims to evaluate the significant factors influencing the success of PPP in SI projects in developed countries based on public-sector satisfaction (S1), private-sector satisfaction (S2), and end-user satisfaction (S3). A comprehensive literature review was followed by expert interviews and an international survey, focusing on developed countries. The Partial Least Squares Structural Equation Modeling (PLS-SEM) technique was applied to map the connections amongst the influencing factors and S1, S2, and S3. The results reveal that legal and political-related factors significantly impact on S2 and S3, while social barriers significantly impact on S1. The effect of the constructs and factors on S1, S2, and S3 along with their rankings are unveiled in this research paper, providing a sound basis to increase success levels and minimize shortfalls in PPP to boost SI developments in developed countries.

1. Introduction

Infrastructure plays a major role in our day-to-day lives. A prerequisite for rapid economic development is the provision of appropriate and usually ‘advanced’ infrastructure services. The use of electricity and water, the disposal of solid waste and wastewater, and travel are all supported by built infrastructure in the urban environment. As a result, many governments have placed a high priority on the expansion and development of infrastructure sectors such as telecommunications, power, trains, highways, ports, and airports [1]. Given the importance of even such basic built infrastructure, rapid urbanization, environmental challenges, health and safety challenges, and heightened demands for a higher quality of life all contribute to the imperative for Smart Infrastructure (SI). Apart from more recent demands as above, according to [2], many cities are struggling to keep up with the rapid expansion of urban areas due to outdated infrastructure and limited funds. As a result, there is more traffic, a lower quality of life, a loss of economic potential, and significant health implications in developed countries as well.
SI provides benefits such as establishing livable surroundings, energy savings, better access, increased quality and value of service, improved public health and safety, and simplified maintenance management, all of which improve inhabitants’ quality of life [3,4,5,6,7]; the concept of smart cities and SI has become a popular topic in scientific literature and international policy over recent decades because of these reasons. SI enables greater control and monitoring of operational functionalities than in conventional infrastructure [8,9], and such provisions for connectivity and control of the assets, services, and infrastructure usually constitute the main advantage of SI over conventional infrastructure, increasing the reliability and efficiency of the total asset/facilities management process. Smith [10] also mentioned that SI enables more effective and efficient management, whereby citizens could enjoy a better quality of life with enhanced safety, health, security, and resource and data management. Even though it is evident that SI brings a bundle of benefits improving the quality of life of the citizens, it can be seen that many governments cannot develop SI as a result of the high cost, advanced technologies needed, and management issues. Hence, pooling their resources with the private sector in delivering SI is seen as a smarter solution. Therefore, application of Public–Private Partnership (PPP) in SI developments is a fruitful research area. As there can be many factors affecting the success of PPP in delivering SI, it is essential to identify those factors and investigate how exactly they could influence success.
Hence, conducting a research study on developing a basis to explore the success of PPP in SI development projects in developed countries was identified as a crucial need; further, it was clearly identified upfront that these needs in ‘developed’ countries may well differ from corresponding needs in ‘developing countries’ since the former focus more on ‘value for money’ and ‘quality of services to end-users’ while the latter may be constrained to focus on a more basic sourcing of project finance itself.
Therefore, this research aims to evaluate the factors affecting the success of PPP in SI developments in developed countries in particular. The research question that the study explores and reports on in this paper is formulated as follows:
What are the principal factors underpinning success in SI developments in developed countries and how are they affecting success?
In construction project management studies, the most widely used types of factors for evaluating project success and potential success were identified as benefits and enablers, barriers, and recommended strategies and enhancing factors (e.g., [11]); hence, the same model was applied to evaluate the success of PPP in SI developments in developed countries. The next step was to identify a basket of suitable measurement criteria to measure the success of PPP in SI projects. Stakeholder satisfaction was identified by Liu et al. [12] as a highly important factor for performance measurement in PPP projects and suggested that it is important to have public-sector satisfaction (S1), private-sector satisfaction (S2), and end-user satisfaction (S3) for the success of a PPP project. Yuan et al., Liu et al., and Mladenovic et al. [13,14,15] also explained a similar perspective on the importance of satisfaction of the stakeholders for the success of PPP project. Moreover, it was concluded that S1, S2, and S3 would capture the many other diverse subfactors that lead to satisfaction, making them key to assessing the success of a PPP project; hence, they were used in this research to measure the success of PPP in SI developments in developed countries. Therefore, this research aims to evaluate the factors affecting the success of PPP in SI developments in developed countries, where success is measured in terms of S1, S2, and S3. The findings of the study deliver a solid basis for developed countries to target and achieve success through PPP in delivering SI projects.

2. Literature Review: Significance and Use of Public–Private Partnership (PPP) in Smart Infrastructure Developments in Developed Countries

SI is becoming more important in both developed and developing countries to enable people to live better lives in a sustainable and safe manner [16]. It can be seen that developed countries focus more on upgrading the existing infrastructure to be smart rather than developing SI as a whole new project [17] as they already have the required basic infrastructure facilities. This is a major difference between developed and developing countries, as many developing countries do not have the basic infrastructure facilities. However, development of SI is a challenging, complex process, whether in a developed country or a developing country. The reasons behind this range from different discourses deployed by technologists and legislators and lack of capability to relate urban sustainability concerns, to pressures on social and territorial cohesion necessitating distinct governance solutions [18]. Further, the need of interdisciplinary Research and Development exercises in developing SI can be seen as a major barrier. As explained by Tan and Taeihagh [19], even though there is an emerging requirement of delivering SI, high financial costs incurred in infrastructure development and maintenance, as well as various governance challenges act as barriers to development. According to [3], challenges in developing SI in both developed and developing countries include inadequacy of financial resources, lack of knowledge and competencies, lack of citizen participation, political uncertainties, and the diversity of stakeholders. To overcome these various challenges generated when developing SI, PPP in SI developments was identified as a potential solution by Jayasena et al. [3] and Selim et al. [20].
It can be determined that many governments in both developed and developing countries are in dire need of long-term planning to meet rapid population growth, urbanization, and environmental degradation, thereby increasing the significance of SCs and SI [21,22]. SI requires special systems and features compared to conventional infrastructure [23], e.g., with more advanced software, technologies, components, and applications, usually also involving digitalization, robotics and Artificial Intelligence (AI), and multiple stakeholders, thereby incurring higher costs in development. Further, SI developments are liable to higher risks than conventional infrastructure, also reinforcing the need for private sector inputs [16]. However, since governments and related administrative bodies are in desperate need of deploying SI to enhance the quality of life of citizens, the ways forward are increasingly sought through PPPs. In pandemic situations, it was seen that many governments have inadequate funding or resources to even protect public health. This strengthens the case for PPP as a good strategy for developing SI. However, as in the COVID-19 pandemic situation worldwide, it is seen that the ‘private sector’ also sometimes needs government support and financial relief in lockdown situations; hence, mutual benefits do accrue in such partnerships.
Governments in developed countries such as the United States, the United Kingdom, and Australia have also used PPPs to leverage private money and upgrade, rehabilitate, and maintain infrastructure [24]. For example, in Australia, the Wodonga Wastewater Treatment Plant Project and the Ballarat North Water Reclamation Project are two examples of successful PPP infrastructure delivery projects. The Chicago skyway project and the Indiana toll road are two examples of the deployment of PPP in infrastructure development projects in the United States. As a result, PPPs are becoming increasingly popular in several developed countries as a means of acquiring and delivering public services and infrastructure. PPP has been used in developing smart cities in developed countries as Japan [25], and according to Manville et al. [26], there are many smart city initiatives that span across multiple countries in Europe and are funded by the European Union through the Competitiveness and Innovation Programme (CIP) and PPPs.
However, there have been unsuccessful PPPs in infrastructure developments as well. By looking at these examples and the significance of PPP in Smart Infrastructure developments, which were summarized in the literature review section, it is evident that there is an imperative for researching the factors affecting the success of PPP in SI developments in developed countries. There are a limited number of research studies, which have discussed the application of PPP in delivering SI. Through these published literatures, the following factors, which are presented in Table 1, were identified as the factors affecting the success of PPP in SI projects.

3. Development of the Research Framework and Hypotheses

A three-step procedure was followed to identify the factors affecting the success of PPP in SI development projects. In the first step, a comprehensive literature review was conducted in order to identify the factors affecting PPP in delivering SI. These identified factors from the published literature are presented in Table 1. In the second step, 10 expert interviews in developed countries helped to identify currently perceived (in practice) benefits and enablers, barriers, and recommended strategies and enhancing factors. These were grouped by distilling the perceptions of the experts, which were obtained through expert interviews using the content analysis technique. Finally, in the third step, the identified factors from the literature review and the expert interviews were compared and the final factors were derived, categorized, and validated based on the expert opinions obtained through interviews. This final set of factors is presented in Table 2.
The factors presented in Table 2 are used as the basis for deriving the quantitative findings of this study.
The research framework for this study is based on both theoretical and logical foundations. Partial Least Squares Structural Equation Modelling (PLS-SEM) method was used to develop the models, which was conducted in two phases.
Phase 1: Validating the quality of the gathered data and quantifying the relationships between the latent variables and their manifest variables in a measurement model. Latent variables are hidden variables, which cannot be seen or directly measured, and manifest variables are observed variables that indicate the presence of a latent variable [34,35].
Phase 2: Specifying the relationships between the latent variables in the structural model.

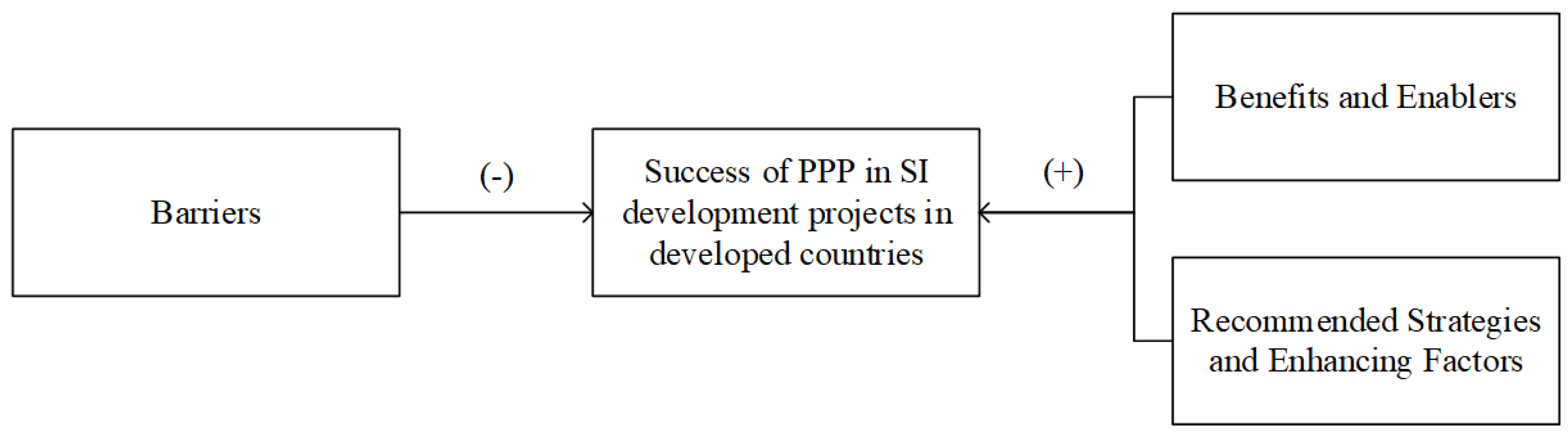

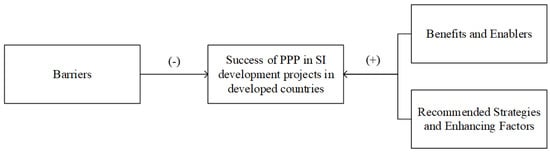

Figure 1 presents the hypotheses testing framework of the research study. The hypothesis was that the categories of factors (i.e., (1) benefits and enablers, (2) barriers, and (3) recommended strategies and enhancing factors) collectively influence the success of PPP in SI development projects. Therefore, these factors should be simultaneously analyzed. The success of PPP in SI developments was measured using three factors, which are S1, S2, and S3.
To evaluate the effect of the factors using PLS-SEM, a conceptual model was developed presenting the connections among latent variables and the relative manifest variables. The conceptual model was developed based on the three categories, benefits and enablers, barriers, and recommended strategies and enhancing factors, affecting the success of PPP in SI projects in developed countries. As per Table 2, 23 benefits and enablers were identified and categorized into four constructs as ‘Political and Legal’, ‘Financial and Economic’, ‘Technical’, and ‘Social’. Barriers were also identified and categorized under the four constructs of ‘Financial and Economic’, ‘Legal and Socio-Political’, ‘Social’, and ‘Technical’, totaling 36 barriers. Furthermore, 25 recommended strategies and enhancing factors were identified and also categorized into five constructs as ‘Stakeholder’ Related, ‘Legal and Sociopolitical’ Related, ‘Technical’ Related, ‘Social’ Related, and ‘Financial’ Related, as presented in Table 2.
Findings derived through the literature and the expert interviews generally confirm that barriers can hinder, if not obstruct success in PPP in SI development projects—that is, barriers have a potentially negative influence on S1, S2, and S3. Meanwhile, it was confirmed that enablers and enhancing factors help to achieve success in PPPs in SI projects and have a positive influence on the success of PPP in SI development projects (S1, S2, and S3). In light of these insights and in the context of the above research framework, the following research hypotheses are proposed:
  • HE1a, HE1b, HE1c: PLBE have positive influence on S1, S2, S3, respectively
  • HE2a, HE2b, HE2c: FEBE have positive influence on S1, S2, S3, respectively
  • HE3a, HE3b, HE3c: TBE have positive influence on S1, S2, S3, respectively
  • HE4a, HE4b, HE4c: SBE have positive influence on S1, S2, S3, respectively
  • HB1a, HB1b, HB1c: FB have negative influence on S1, S2, S3, respectively
  • HB2a, HB2b, HB2c: LSPB have negative influence on S1, S2, S3, respectively
  • HB3a, HB3b, HB3c: SB have negative influence on S1, S2, S3, respectively
  • HB4a, HB4b, HB4c: TB have negative influence on S1, S2, S3, respectively
  • HR1a, HR1b, HR1c: SREF have positive influence on S1, S2, S3, respectively
  • HR2a, HR2b, HR2c: LREF have positive influence on S1, S2, S3, respectively
  • HR3a, HR3b, HR3c: TREF have positive influence on S1, S2, S3, respectively
  • HR4a, HR4b, HR4c: SRF have positive influence on S1, S2, S3, respectively
  • HR5a, HR5b, HR5c: FREF have positive influence on S1, S2, S3, respectively

4. Research Methodology

4.1. Research Approach

A mixed method research approach was adopted in order to achieve the aim of this study, which is to evaluate the factors affecting the success of PPP in SI developments in developing countries, where the success is measured in terms of public-sector satisfaction (S1), private-sector satisfaction (S2), and end-users satisfaction (S3). The mixed approach of a dual qualitative and quantitative strategy is used to counteract the weaknesses of each individual approach [36]; hence, it was adopted in this research study.

4.2. Data Collection

Data collection for the research was conducted in 4 phases.
  • Phase 1: A comprehensive literature review was carried out to review the concepts of SI, importance of SI for developed countries, and to review the importance of PPP in SI developments in developed countries. Further, factors affecting PPP in SI projects were identified through the published literature.
  • Phase 2: Ten expert interviews were conducted to identify the factors affecting the success of PPP in SI development projects in developed countries and to categorize the identified factors into the constructs. Then, the factors identified through the literature review were combined with the factors identified from the expert interviews and the final set of factors was validated based on the expert opinions obtained through interviews.
  • Phase 3: A pilot survey of the questionnaire was conducted to test the research tools such as questions, survey structure, and distribution channels. The target population of the pilot survey included both academic and industry practitioners (five experts from academia and five experts from the industry), who have expertise, knowledge, and experience in PPP and SI developments. As per the received feedback, the questionnaire was revised to improve the clarity and to be more user-friendly and understandable.
  • Phase 4: Subsequent to phase 3, the international questionnaire survey in the developed countries was conducted to evaluate the factors affecting the success of PPP in SI development projects in developed countries. The structure of the questionnaire and target population are explained below.
The questionnaire consisted of six sections. The first section explained the aim of the research. The second section was to gather background information of the respondents, including their designation, work sector, profession, country of practice, and experience in SI developments and/or PPP projects. In the third, fourth, fifth, and sixth sections, the respondents were asked to assess the measurement items of benefits and enablers, barriers, and recommended strategies and enhancing factors, respectively, and to assess the importance of public-sector satisfaction (S1), private-sector satisfaction (S2), and end-user satisfaction (S3). The respondents assessed the measurement items on a five-point Likert scale. The Five-point Likert scale has been widely recommended and used in construction management research [11,37] because of its advantage to yield unambiguous results. Initially, a pilot study was also conducted before finalizing the questionnaire.
The population of the survey comprised all the industry practitioners and academics with knowledge and understanding of PPP and/or SI development projects in developed countries. As in [11], there was no sampling frame for this study; thus, the sample was based on nonprobability sampling. Convenience and snowball sampling techniques under nonprobability sampling were used in this survey to have a valid and effective sample size, similar to previous construction management researches such as [11,37,38,39]. When it is difficult to obtain a response from sample elements chosen at random, snowball sampling is preferred [40]. Müller and Turner [41] investigated the impact of project managers on project success using a similar sample strategy, and this sampling strategy was utilized by Liu et al. [42] to investigate risk routes in building projects.
Using this approach, 220 questionnaires were distributed to potential respondents. Eventually, 101 completed questionnaires from 10 developed countries were returned, corresponding to a 45.9% response rate, and 100 questionnaires were used for analysis after removing the incomplete questionnaire. The central limit theorem was satisfied by this sample size as the sample size was above 30 [11,43]. Further, because SI developments are yet limited within the developed countries, the number of experienced professionals is limited in this research area. According to Hair et al. [44], “PLS-SEM minimum sample size should be equal to the larger of the following: (1) ten times the largest number of formative indicators used to measure one construct or (2) ten times the largest number of structural paths directed at a particular latent construct in the structural model” (p. 144). However, as mentioned in Kock and Hadaya [45] and Goodhue et al. [46], this method can result in erroneous estimates of the minimum sample size. Hence, the minimum R-squared method was used in this study in order to validate the sample size of this study. There are several studies that have used SEM with a smaller sample size than required such as those of Ahmadabadi and Heravi [38], Ozorhon et al. [47], and Yuan et al. [13] to validate their own structures. According to Kock and Hadaya [45], if a researcher is aware that all of the path coefficients of a model will be strong before gathering empirical data, leading to large effect sizes, the researcher can use a smaller sample size in a PLS-SEM analysis. The respondent profiles and the developed countries from which responses were received are shown in Table 3.
Through the analysis of Table 2, it is evident that the respondents for the questionnaire are experienced professionals in developed countries, which strengthens the reliability and validity of the study.

4.3. Data Analysis

In this research, Structural equation modelling (SEM), was used in analyzing the data collected through the questionnaire survey. Since its introduction in the 1980s, SEM) has grown in popularity as a powerful multivariate statistical tool [48]. SEM is a technique that can be used for examining relationships between dependent and independent variables and is based on the general linear model. SEM can be considered as a combination of factor analysis, multiple regression analysis, and path analysis to simultaneously examine the structure of the relationships among constructs [44,49]. The variables (independent and dependent) can be either unobserved or observed variables. SEM has four distinctive features, in the comparison of SEM with traditional correlation analysis. SEM estimates numerous and interrelated dependencies. Moreover, SEM denotes unobserved concepts in these relationships and measurement errors are also being considered in the estimation. Further, the SEM model explains a whole set of relationships [50,51]; as a result of the abovementioned advantages, SEM has been used in an increasing number of studies in the field of construction project management [11,52,53,54,55]. As a result, SEM was chosen as the best appropriate data analysis technique for this study.
Two types of SEM techniques were identified as the covariance-based SEM (CB-SEM) and the partial least squares SEM (PLS-SEM). The two models are different and are appropriate for different use in research. The CB-SEM is appropriate for confirmation of established theory while the PLS-SEM is prediction-oriented and appropriate for exploratory and confirmatory research [56]. Furthermore, PLS-SEM is recommended if there is a smaller sample size [44]. Therefore, in this research, PLS-SEM will be utilized for modeling in this study.

5. Research Findings and Discussion

In this section, the findings of the Partial Least Squares Structural Equation Modelling (PLS-SEM) analysis are presented. Three models have been developed based on the benefits and enablers, barriers, and recommended strategies and enhancing factors.

5.1. Benefits and Enablers for Adopting PPPs in SI Developments in Developed Countries

5.1.1. Measurement Model Evaluation

Table 4 and Table 5 illustrate the evaluation of the results of the measurement models in the model of benefits and enablers influencing the adoption and success of PPP in SI development projects in developed countries. The model developed through PLS-SEM analysis is presented in Figure 2. Table 4 presents the factor loading, Cronbach’s alpha coefficients, Rho_A, composite reliability scores and AVE of the collected data. Factor loadings are standardized regression weights or the correlation coefficient for the variable and factor [57]. Factor loading as an indicator illustrates the variance explained by the variable on that particular factor. Reliability and convergent validity were analyzed by assessing composite reliability and Average Variance Extracted (AVE). These values were obtained using the smartPLS software.
The factor loadings of the measurement items FEBE 3 and SBE 5 were removed from the model as their factor loadings were below 0.50. Subsequent to the deletion of those 2 factors, the analysis was rerun to obtain a reliable and valid model. As illustrated in Figure 2, this study involves only reflective measurement. Therefore, some measurement items can be deleted without affecting the meaning of the construct, as reflective measurement items are highly correlated and substitutable [56]. As the measurement items with a low factor loading contribute insignificantly to the explanatory power of the model and could cause biasing of the estimations of other measurement items, they can be dropped [58].
According to Table 4, Cronbach’s alpha coefficients, Rho A, and composite reliability scores of the collected data are above 0.70. This indicates a satisfactory level of reliability and consistency of the measurement items. Convergent validity of the constructs is also satisfactory as all factor loadings and AVEs are above 0.50. An AVE of 0.50 indicates a satisfactory level as the construct explains 50% of the variance in its measurement items. Table 5 presents discriminant validity of the constructs.
As illustrated in Table 5, the Fornell–Larcker criterion was fulfilled as each latent construct’s AVE value is greater than the respective construct’s highest squared correlation with another construct. The discriminant validity of the constructs was justified as the factor loading of each measurement item on the related construct was higher than the other cross-loadings. Hence, the reliability and validity of this measurement model can be confirmed.

5.1.2. Structural Model Evaluation

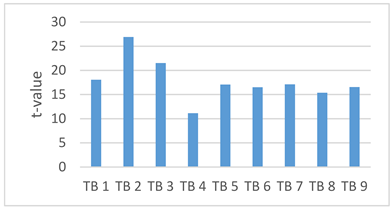

Table 6 illustrates the bootstrapping results for the benefits and enablers PLS-SEM structural model.

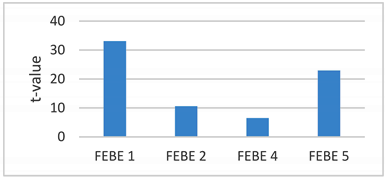

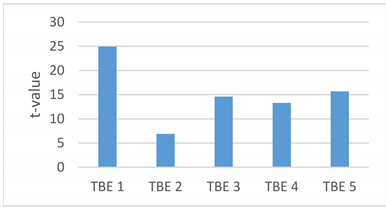

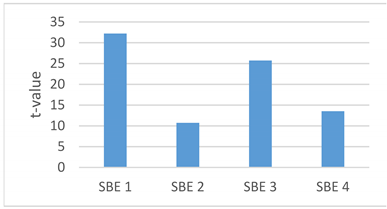

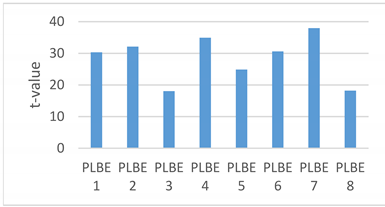

According to the presented t-values in Table 6, paths linking FEBE—S3, PLBE—S2, PLBE—S3, and TBE—S1 have a t-value greater than 2.56. This indicates that these paths are statistically significant at the 0.01 level. Therefore, HE2c, HE1b, HE1c, and HE3a were appropriately supported. According to Ekanayake et al. [52], Darko et al. [11], and Aibunu and Al-Lawati [59], higher path coefficients indicate a greater impact on the variables. Therefore, it can be seen that the strongest path is between PLBE and S2. The dotted lines in Figure 3 illustrate the insignificant paths. The arrows in the structural model indicate the relationship between one construct and another (hypothesized relationship) and the relationship between the measurement items and the construct. The coefficients of determination (R2) value of the dependent variables were greater than 0.3; this further confirmed the model’s quality and predictive accuracy [56].

5.2. Barriers to Adopting PPPs in SI Development Projects in Developed Countries

5.2.1. Measurement Model Evaluation

Table 7 and Table 8 illustrate the evaluation of the results of the measurement models in the model of barriers influencing the adoption and success of PPP in SI development projects in developed countries. The model developed through PLS-SEM analysis is presented in Figure 3. Similar to the benefits and enablers model, Table 6 presents the factor loading, Cronbach’s alpha coefficients, Rho_A, and composite reliability scores and AVE of the collected data regarding the barriers influencing the adoption and success of PPP in SI developments in developed countries.
Similar to the benefits and enablers model, measurement items with a factor loading below 0.50 were searched to be removed from the structural model as the model in this study is only a reflective model. However, in the barriers model, there were no measurement items with a factor loading less than 0.50. According to the Table 7, Cronbach’s alpha coefficients, Rho_A, and composite reliability scores of the collected data are above 0.70. This indicates a satisfactory level of reliability and consistency of the measurement items. Convergent validity of the constructs is also satisfactory as all factor loadings and AVEs are above 0.50. An AVE of 0.50 indicates a satisfactory level as the construct explains 50% of the variance in its measurement items.
Table 8 presents discriminant validity of the constructs.
As illustrated in Table 8, the Fornell–Larcker criterion was fulfilled as each latent construct’s AVE value is greater than the respective construct’s highest squared correlation with another construct. The discriminant validity of the constructs was justified as the factor loading of each measurement item on the related construct was higher than the other cross-loadings. Hence, the reliability and validity of this measurement model can be confirmed.

5.2.2. Structural Model Evaluation

Table 9 illustrates the bootstrapping results for the barriers PLS-SEM-based structural model.

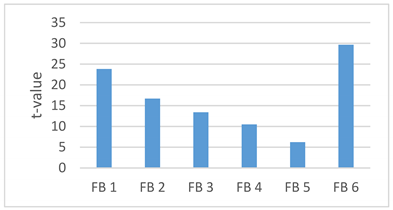

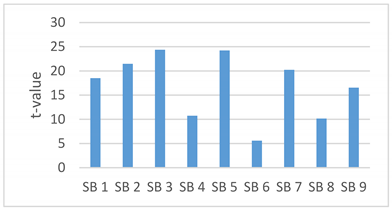

According to the presented t-values in Table 9, paths linking LSPB—S2, SB—S1, SB—S3, TB—S1, and TB—S3 have a t-value greater than 2.56. This indicates that these paths are statistically significant at the 0.01 level. Therefore, HB2b, HB3a, HB3c, HB4a, and HB4a were appropriately supported. The path linking FB—S1 has a t-value greater than 1.96, indicating that this path is statistically significant at the level of 0.05. Therefore, HB1a was also appropriately supported. According to Ekanayake et al. [52], Darko et al. [11], and Aibunu and Al-Lawati [59], higher path coefficients point to a greater impact on the variables. Therefore, it can be seen that the strongest path is between TB and S3. The dotted lines in Figure 3 illustrate the insignificant paths. The coefficients of determination (R-square) value of the dependent variables were greater than 0.3; this further confirmed the model’s quality and predictive accuracy [56].

5.3. Recommended Strategies and Enhancing Factors for Improving PPPs in Delivering SI Development Projects in Developed Countries

5.3.1. Measurement Model Evaluation

Table 10 and Table 11 illustrate the evaluation of the results of the model of recommended strategies and enhancing factors influencing the adoption and success of PPP in SI development projects in developed countries. The model developed through PLS-SEM analysis is presented in Figure 4. Similar to the benefits and enablers model, Table 10 presents the factor loading, Cronbach’s alpha coefficients, Rho_A, and composite reliability scores and AVE of the collected data regarding the recommended strategies and enhancing factors influencing the adoption and success of PPP in SI developments in developed countries.
Similar to the other models, measurement items with a factor loading below 0.50 were searched to be removed from the structural model as the model in this study is only a reflective model. However, in the recommended strategies and enhancing factors model, there were no measurement items with a factor loading less than 0.50. According to Table 10, Cronbach’s alpha coefficients, Rho_A, and composite reliability scores of the collected data are above 0.70. This indicates a satisfactory level of reliability and consistency of the measurement items. Convergent validity of the constructs is also satisfactory as all factor loadings and AVEs are above 0.50. An AVE of 0.50 indicates a satisfactory level as the construct explains 50% of the variance in its measurement items.
Table 11 presents discriminant validity of the constructs.
As illustrated in Table 11, the Fornell–Larcker criterion was fulfilled as each latent construct’s AVE value is greater than the respective construct’s highest squared correlation with another construct. The discriminant validity of the constructs was justified as the factor loading of each measurement item on the related construct was higher than the other cross-loadings. Hence, reliability and validity of this measurement model can be confirmed.

5.3.2. Structural Model Evaluation

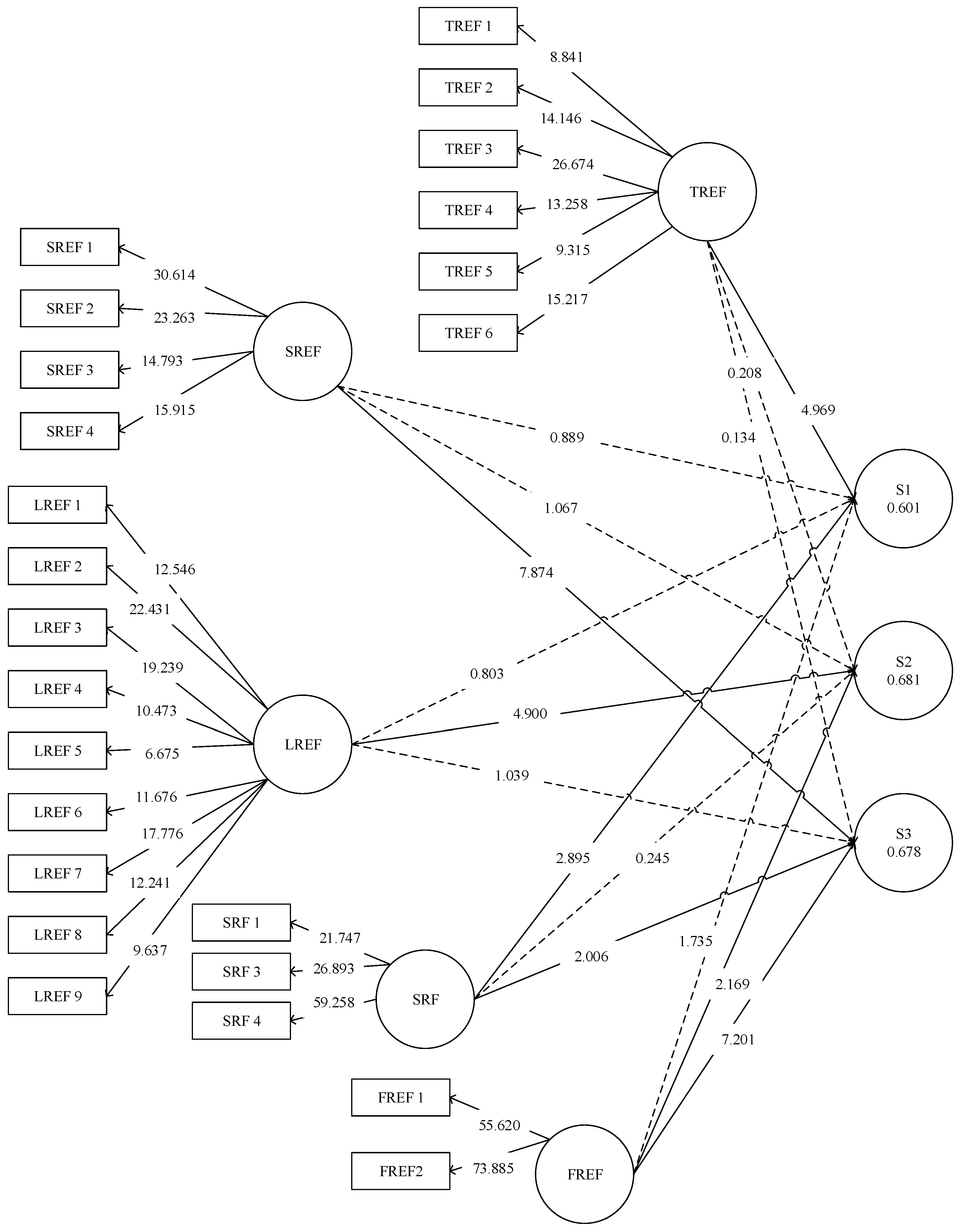

Table 12 illustrates the bootstrapping results for the recommended strategies and enhancing factors PLS-SEM-based structural model.

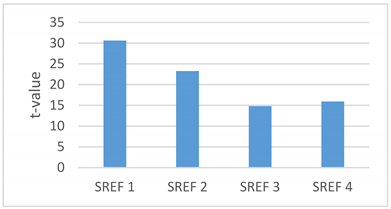

According to the presented t-values in Table 12, paths linking FREF—S3, LREF—S2, LREF—S3, SREF—S3, SRF—S1, and TREF—S1 have a t-value greater than 2.56. This indicates that these paths are statistically significant at the 0.01 level. Therefore, HR5c, HR2b, HR2c, HR1c, HR4a, and HR3a were appropriately supported. The paths linking FREF—S2 and SRF—S3 have t-values greater than 1.96 and this indicates that this path statistically significant at the level of 0.05. Therefore, HR5b and HR4c were also appropriately supported. According to Ekanayake et al. (2021), Darko et al. (2018), and Aibunu and Al-Lawati (2010), higher path coefficients state a greater impact on the variables. Therefore, it can be seen that the strongest path is between SREF and S3. The dotted lines in Figure 4 illustrate the insignificant paths. The coefficients of determination (R2) value of the dependent variables were greater than 0.3. Therefore, this further confirmed the model’s quality and predictive accuracy [56].

6. Discussion

In this study, a model was proposed to investigate the influences of various benefits and enablers, barriers, and recommended strategies and enhancing factors on the success of PPP in SI development projects in developed countries.

6.1. Benefits and Enablers for Adopting PPPs in SI Development Projects in Developed Countries

Table 13 presents the summary of the findings for benefits and enablers impacting the adoption and success of PPP in SI developments in a developed country. It can be seen that all the measurement items in the model influence significantly on the constructs, which shows the validity of the measurement items identified in this research. The bold ranks in Table 13 present the significant constructs for S1, S2, and S3.
Technical benefits and enablers (TBE) have been recognized as the most significant influencing construct on public sector satisfaction (S1) in a developed country, which in turn affects the adoption and success of PPP in SI development projects. As the public sector does not have the required technical know-how, it is clear that TBE affects mostly as benefits and enablers for the satisfaction of public sector. Moreover, it has been identified that financial benefits and enablers (FEBE) do not affect S1 significantly in developed countries. The reason for this result is also clear, as the governments of developed countries have the required financial capabilities to finance their infrastructure developments. In consideration of private sector satisfaction (S2), it is clear that the PLBE has the greatest impact, which has a substantial impact on the acceptance and success of PPP in SI development projects in a developed country. This could be due to the private sector’s willingness to obtain the PLBE for their projects in exchange for delivering a service to the population. It has also been identified that TBE, SBE, and FEBE do not have a significant impact on S2 in developed countries. This could be because the private sector already has the financial and technological capacity to carry out the developments, but they require PLBE to complete the projects. For the satisfaction of the end users (S3), it can be determined that there is a significant influence from the PLBE and FEBE. Among all the constructs, for the success of PPP in SI projects in developed countries, PLBE affects the most.

6.2. Barriers to Adopting PPPs in SI Development Projects in Developed Countries

Table 14 presents the summary of the findings for barriers impacting on the success of PPP in SI developments in developed countries. It can be seen that all the measurement items in the model influence the constructs significantly, which also shows the validity of the measurement items of the barriers identified in this research. The bold ranks in Table 14 present the significant constructs for S1, S2, and S3.
In a developed country, social barriers (SB) have been identified as the most significant influences on S1. This is due to the fact that the public sector should always view citizens as vital stakeholders in every endeavor. Technical barriers (TB) can be seen as the second significant influencers. Legal and sociopolitical barriers (LSPB) do not seem to impact significantly on the S1. When it comes to S2, it is clear that LSPB has the most impact. Therefore, it can be seen that the private sector involved in SI projects in developed countries also considers barriers in the legal background such as weak/inconsistent legal PPP framework, barriers to transferring ownership/management control of the assets and/or repatriating funds, frequent political/policy shifts affecting SI development and operations, etc. For S3, it is seen that TB affects the most. This could be due to TB in the utilization of SI; if there are numerous TBs, the project would fail, negatively impacting S3. SBs also have a considerable impact on S3, while it is evident that there is no considerable impact from LSPB and FB to S3, which can be expected as the end-users do not need to consider the LSPB and FB in executing a project, as do the public sector and private sector.

6.3. Recommended Strategies and Enhancing Factors for Improving PPPs in Delivering SI Development Projects in Developed Countries

Table 15 presents the summary of the findings for recommended strategies and enhancing factors impacting on the adoption and success of PPP in SI developments in a developed country. It can be seen that all the measurement items in the model influence the constructs significantly, which shows the validity of the measurement items of the barriers identified in this research. The bold ranks in Table 15 present the significant constructs for S1, S2, and S3.
Under the recommended strategies and enhancing factors, for S1, it can be seen that TREF and SRF are more significant in helping to achieve success. For example, with the periodic high-level reviews and remedial actions throughout the whole project delivery process, defining minimum functional needs with requisite technical specifications and well-structured, equitable, and enforceable contracts, there is a higher chance for the PPP projects to be successful, which affects S1. SRFs have the second most significant influence on S1, which states the importance of engaging citizens in the projects in developed countries. When it comes to S2, LREF is the most important constructor to consider. This is due to the fact that the private sector places a greater emphasis on legal considerations. This has been seen in the analysis of barriers and benefits, and enablers as well. Other than LREF, FREF also affects S2. SREF is the most significant construct affecting S3, while FREF and SRF also considerably affect S3.

7. Conclusions

The significance of PPP in SI projects in developed countries was identified and explored with an emphasis on the way forward for mutual benefits. Even though many of the governments of developed countries have their own funding to develop SI, PPP was identified as a suitable procurement strategy to deliver SI for developed countries as well. This is because of pressing needs for specialized technological advancements and complex interdisciplinary Research and Development exercises in developing SI. Moreover, it was evident that many developed countries have identified PPP as a preferred solution for optimum risk management. However, there are unsuccessful PPP projects as well. Therefore, it is important to explore and evaluate the factors affecting the success of PPP in delivering SI. It is clear that the findings of this study are fruitful and important for the construction project management literature, as well as the construction industry at large.
The significant factors, which affect the success of PPP in SI development projects, were determined through PLS-SEM analysis. The ‘political and legal’ category was identified as the most influencing category of benefits and enablers impacting on the private sector participants. The findings highlight the importance of a suitable independent legal background and infrastructure in the host country, for the satisfaction of the private sector partners. A stable and suitable legal system that encourages PPP in the host country could attract more investors for the developments. While the private sector can be encouraged to involve PPP for developing SI through ‘political and legal’ benefits and enablers, the public sector would be interested in the technical ‘benefits and enablers’, as well as the social ‘benefits and enablers’ since they need to provide a service to society. This is because PPP brings the technological know-how required in developing and managing SI and also enhances services to the public. The final deliverables would then also have a bigger impact on the satisfaction of end-users. Hence, the end-users are also interested in the legal background and the political background of the country, which affect the adoption of PPP in SI projects in developed countries. Social barriers were identified as the most significant barrier for the government and the public sector to involve in PPP projects to deliver SI. However, through the findings, it is clear that the involvement of the private sector is limited or retarded by legal and sociopolitical barriers. There also are technical barriers, which should be overcome for end-user satisfaction, as they are the ones who will use the SI. Therefore, the importance of capacity building of the end-users is identified as crucial.
These insights, which were indicated and explained by the quantitative significance for each measurement item and the constructs in the discussion section, respectively, contribute to the development of the theoretical concepts underlying the application of PPP in SI and also to the existing literature. Moreover, for construction industry policy-makers and the project/construction management subsector, these findings provide a solid basis to avoid complications in PPP procured SI development projects and arm the parties with some useful pointers on how remedial actions may be planned and prioritized according to the ranking results derived through this study. The models for recommended strategies and enhancing factors could be used subsequent to the project initiation. These would help to enhance the outcomes; hence, they would increase the success rate of PPP in delivering SI in developed countries. The findings of this study provide a solid basis for understanding how these diverse factors interact in these projects—in turn, helping to plan and deliver more successful SI projects with PPP inputs in a developed country.
Despite the valuable knowledge derived from the comprehensive literature review and expert interviews, a limitation of this study is that the questionnaire survey data collected were from 100 respondents in 10 developed countries. Further, applicability of the identified factors may differ to some extent based on the financial, legal, technical, and social factors available in the host country and based on the type of developing SI. Hence, further research could be conducted by expanding the number of respondents and the number of data collection countries. Moreover, case studies based on this model can be carried out so as to develop more effective country-specific implementation strategies in this area. Further, case studies based on these developed models could be conducted on specific SI developments, so as to develop a set of Smart-Infrastructure-type-specific-based decision-making platforms.

Author Contributions

Conceptualization, N.S.J., D.W.M.C. and M.M.K.; methodology, N.S.J.; software, N.S.J.; validation, D.W.M.C. and M.M.K.; formal analysis, N.S.J.; investigation, N.S.J., D.W.M.C. and M.M.K.; resources, N.S.J., D.W.M.C. and M.M.K.; data curation, N.S.J., D.W.M.C. and M.M.K.; writing—original draft preparation, N.S.J.; writing—review and editing, N.S.J., D.W.M.C. and M.M.K.; visualization, N.S.J.; supervision, D.W.M.C. and M.M.K.; project administration, D.W.M.C. and M.M.K.; funding acquisition, N.S.J., D.W.M.C. and M.M.K. All authors have read and agreed to the published version of the manuscript.

Funding

This research study was fully supported through funding of the full-time PhD research studentship under the auspice of the Department of Building and Real Estate, The Hong Kong Polytechnic University, Hong Kong. The current study was accomplished as part of a PhD research programme.

Institutional Review Board Statement

The study was conducted in accordance with the approval by the Departmental Research Committee, Department of Building and Real Estate, The Hong Kong Polytechnic University (Approval Code: HSEARS20191213003, Approval Date: 14 December 2019).

Informed Consent Statement

Informed consent was obtained from all subjects involved in the study.

Data Availability Statement

Not applicable.

Conflicts of Interest

The authors declare no conflict of interest.

References

  1. Singh, J. The Impact of Social Infrastructure and Physical Infrastructure on Economic Growth in Punjab, India. J. Asian Afr. Stud. 2021, 1–16. [Google Scholar] [CrossRef]
  2. Fishman, T.D.; Flynn, M. Using Public-Private Partnerships to Advance Smart Cities Part Two: Funding and Financing Smart Cities Series. 2018. Available online: https://www2.deloitte.com/content/dam/Deloitte/global/Documents/Public-Sector/gx-ps-public-private-partnerships-smart-cities-funding-finance.pdf (accessed on 3 February 2022).
  3. Jayasena, N.S.; Chan, D.W.M.; Kumaraswamy, M.M. A systematic literature review and analysis towards developing PPP models for delivering smart infrastructure. Built Environ. Proj. Asset Manag. 2021, 11, 121–137. [Google Scholar] [CrossRef]
  4. Jayasena, N.S.; Waidyasekara, K.G.A.S.; Mallawaarachchi, H.; Peiris, S. Ensuring engagement of stakeholders in smart city projects: Case study in Sri Lanka. J. Urban Plan. Dev. 2021, 147, 05021045. [Google Scholar] [CrossRef]
  5. Morimoto, R. Estimating the benefits of effectively and proactively maintaining infrastructure with the innovative Smart Infrastructure sensor system. Socio-Econ. Plan. Sci. 2010, 44, 247–257. [Google Scholar] [CrossRef]
  6. Milenković, M.; Rašić, M.; Vojković, G. Using public private partnership models in smart cities-proposal for Croatia. In Proceedings of the 2017 40th International Convention on Information and Communication Technology, Electronics and Microelectronics (MIPRO), Opatija, Croatia, 22–26 May 2017; pp. 1412–1417. [Google Scholar]
  7. Marsal-Llacuna, M.L.; Colomer-Llinàs, J.; Meléndez-Frigola, J. Lessons in urban monitoring taken from sustainable and livable cities to better address the Smart Cities initiative. Technol. Forecast. Soc. Chang. 2015, 90, 611–622. [Google Scholar] [CrossRef]
  8. Rice, J.; Martin, N. Smart infrastructure technologies: Crowdsourcing future development and benefits for Australian communities. Technol. Forecast. Soc. Chang. 2020, 153, 119256. [Google Scholar] [CrossRef]
  9. Hoult, N.; Bennett, P.J.; Stoianov, I.; Fidler, P.; Maksimović, Č.; Middleton, C.; Soga, K. Wireless sensor networks: Creating smart infrastructure. Civ. Eng. 2009, 162, 136–143. [Google Scholar] [CrossRef]
  10. Smith, K. The Inconvenient Truth about Smart Cities. 2017. Available online: https://blogs.scientificamerican.com/observations/the-inconvenient-truth-about-smart-cities (accessed on 15 March 2021).
  11. Darko, A.; Chan, A.P.C.; Yang, Y.; Shan, M.; He, B.J.; Gou, Z. Influences of barriers, drivers, and promotion strategies on green building technologies adoption in developing countries: The Ghanaian case. J. Clean. Prod. 2018, 200, 687–703. [Google Scholar] [CrossRef]
  12. Liu, J.; Love, P.E.; Davis, P.R.; Smith, J.; Regan, M. Conceptual framework for the performance measurement of public-private partnerships. J. Infrastruct. Syst. 2015, 21, 04014023. [Google Scholar] [CrossRef]
  13. Yuan, J.; Zeng, A.Y.; Skibniewski, M.J.; Li, Q. Selection of performance objectives and key performance indicators in public–private partnership projects to achieve value for money. Constr. Manag. Econ. 2009, 27, 253–270. [Google Scholar] [CrossRef]
  14. Liu, J.; Love, P.E.; Smith, J.; Regan, M.; Davis, P.R. Life cycle critical success factors for public-private partnership infrastructure projects. J. Manag. Eng. 2015, 31, 04014073. [Google Scholar] [CrossRef]
  15. Mladenovic, G.; Vajdic, N.; Wündsch, B.; Temeljotov-Salaj, A. Use of key performance indicators for PPP transport projects to meet stakeholders’ performance objectives. Built Environ. Proj. Asset Manag. 2013, 3, 228–249. [Google Scholar] [CrossRef]
  16. Jayasena, N.S.; Chan, D.W.M.; Kumaraswamy, M.M.; Saka, A.B. Applicability of public-private partnerships in smart infrastructure development: The case of Hong Kong. Int. J. Constr. Manag. 2022, 1–13. [Google Scholar] [CrossRef]
  17. Pellicer, S.; Santa, G.; Bleda, A.L.; Maestre, R.; Jara, A.J.; Skarmeta, A.G. A global perspective of smart cities: A survey. In Proceedings of the 2013 Seventh International Conference on Innovative Mobile and Internet Services in Ubiquitous Computing, Taichung, Taiwan, 3–5 July 2013; pp. 439–444. [Google Scholar]
  18. Estevez, E.; Lopes, N.; Janowski, T. Smart Sustainable Cities: Reconnaissance Study; United Nations University Operating Unit on Policy-Driven Electronic Governance: Guimarães, Portugal, 2016; Available online: https://unu.edu/projects/smart-cities-for-sustainable-development.html#outline (accessed on 10 October 2021).
  19. Tan, S.Y.; Taeihagh, A. Smart city governance in developing countries: A systematic literature review. Sustainability 2020, 12, 899. [Google Scholar] [CrossRef] [Green Version]
  20. Selim, A.M.; Yousef, P.H.; Hagag, M.R. Smart infrastructure by (PPPs) within the concept of smart cities to achieve sustainable development. Int. J. Crit. Infrastruct. 2018, 14, 182–198. [Google Scholar] [CrossRef]
  21. Mutambisi, T.; Chavunduka, C. Stocktaking Frameworks for the Planning and Development of Smart Cities. In Sustainable and Smart Spatial Planning in Africa; CRC Press: Boca Raton, FL, USA, 2022; pp. 11–24. [Google Scholar]
  22. Broo, D.G.; Bravo-Haro, M.; Schooling, J. Design and implementation of a smart infrastructure digital twin. Autom. Constr. 2022, 136, 104171. [Google Scholar] [CrossRef]
  23. Quasim, M.T.; Khan, M.A.; Algarni, F.; Alshahrani, M.M. Fundamentals of smart cities. In Smart Cities: A Data Analytics Perspective; Springer: Cham, Switzerland, 2021; pp. 3–16. [Google Scholar]
  24. Hodge, G.; Greve, C.; Boardman, A. Public-private partnerships: The way they were and what they can become. Aust. J. Public Adm. 2017, 76, 273–282. [Google Scholar] [CrossRef]
  25. Pianezzi, D.; Mori, Y.; Uddin, S. Public–private partnership in a smart city: A curious case in Japan. Int. Rev. Adm. Sci. 2021, 1–16. [Google Scholar] [CrossRef]
  26. Manville, C.; Cochrane, G.; Cave, J.; Millard, J.; Pederson, J.K.; Thaarup, R.K.; Liebe, A.; Wissner, M.; Massink, R.A.; Kotterink, B. Mapping Smart Cities in the EU. 2014. Available online: https://www.europarl.europa.eu/RegData/etudes/etudes/join/2014/507480/IPOL-ITRE_ET(2014)507480_EN.pdf (accessed on 3 November 2021).
  27. Selim, A.M.; ElGohary, A.S. Public–private partnerships (PPPs) in smart infrastructure projects: The role of stakeholders. HBRC J. 2020, 16, 317–333. [Google Scholar] [CrossRef]
  28. Ha, N.T.; Fujiwara, T. Option-games on infrastructure investment in Vietnam: Focused on Smart City project. In Proceedings of the PICMET’14 Conference: Portland International Center for Management of Engineering and Technology, Infrastructure and Service Integration, Kanazawa, Japan, 27–31 July 2014; pp. 250–257. [Google Scholar]
  29. Neirotti, P.; De Marco, A.; Cagliano, A.C.; Mangano, G.; Scorrano, F. Current trends in Smart City initiatives: Some stylised facts. Cities 2014, 38, 25–36. [Google Scholar] [CrossRef] [Green Version]
  30. Stratigea, A.; Papadopoulou, C.A.; Panagiotopoulou, M. Tools and technologies for planning the development of smart cities. J. Urban Technol. 2015, 22, 43–62. [Google Scholar] [CrossRef]
  31. Cardullo, P.; Kitchin, R. Smart urbanism and smart citizenship: The neoliberal logic of ‘citizen-focused’ smart cities in Europe. Environ. Plan. C Politics Space 2019, 37, 813–830. [Google Scholar] [CrossRef] [Green Version]
  32. Sharma, M.; Bindal, A. Public-private partnership. Int. J. Res. 2014, 1, 1270–1274. [Google Scholar]
  33. Nam, T.; Pardo, T.A. Conceptualizing smart city with dimensions of technology, people, and institutions. In Proceedings of the 12th Annual International Digital Government Research Conference: Digital Government Innovation in Challenging Times, New York, NY, USA, 12–15 June 2011; pp. 282–291. [Google Scholar]
  34. Samuelsen, K.M.; Dayton, C.M. Latent class analysis. In The Reviewer’s Guide to Quantitative Methods in the Social Sciences; Routledge: Abingdon, UK, 2018; pp. 164–177. [Google Scholar]
  35. Ng, T.S.T.; Wong, Y.M.; Wong, J.M.W. A structural equation model of feasibility evaluation and project success for public–private partnerships in Hong Kong. IEEE Trans. Eng. Manag. 2010, 57, 310–322. [Google Scholar] [CrossRef] [Green Version]
  36. Amaratunga, D.; Baldry, D.; Sarshar, M.; Newton, R. Quantitative and qualitative research in the built environment: Application of “mixed” research approach. Work Study 2002, 51, 17–31. [Google Scholar] [CrossRef]
  37. Zhang, X.; Shen, L.; Wu, Y. Green strategy for gaining competitive advantage in housing development: A China study. J. Clean. Prod. 2011, 19, 157–167. [Google Scholar] [CrossRef]
  38. Ahmadabadi, A.A.; Heravi, G. The effect of critical success factors on project success in Public-Private Partnership projects: A case study of highway projects in Iran. Transp. Policy 2019, 73, 152–161. [Google Scholar] [CrossRef]
  39. Mao, C.; Shen, Q.; Pan, W.; Ye, K. Major barriers to off-site construction: The developer’s perspective in China. J. Manag. Eng. 2015, 31, 04014043. [Google Scholar] [CrossRef]
  40. Sekaran, U.; Bougie, R. Research Methods for Business: A Skill Building Approach; John Wiley & Sons: Hoboken, NJ, USA, 2016. [Google Scholar]
  41. Müller, R.; Turner, J.R. Matching the project manager’s leadership style to project type. Int. J. Proj. Manag. 2007, 25, 21–32. [Google Scholar] [CrossRef]
  42. Liu, J.; Xie, Q.; Xia, B.; Bridge, A.J. Impact of design risk on the performance of design-build projects. J. Constr. Eng. Manag. 2017, 143, 04017010. [Google Scholar] [CrossRef]
  43. Ott, R.L.; Longnecker, M. An Introduction to Statistical Methods and Data Analysis; Brooks/Cole: Belmont, CA, USA, 2010. [Google Scholar]
  44. Hair, J.F.; Ringle, C.M.; Sarstedt, M. PLS-SEM: Indeed a silver bullet. J. Mark. Theory Pract. 2011, 19, 139–152. [Google Scholar] [CrossRef]
  45. Kock, N.; Hadaya, P. Minimum sample size estimation in PLS-SEM: The inverse square root and gamma-exponential methods. Inf. Syst. J. 2018, 28, 227–261. [Google Scholar] [CrossRef]
  46. Goodhue, D.L.; Lewis, W.; Thompson, R. Does PLS have advantages for small sample size or non-normal data? MIS Q. 2012, 36, 981–1001. [Google Scholar] [CrossRef] [Green Version]
  47. Ozorhon, B.; Arditi, D.; Dikmen, I.; Birgonul, M.T. Toward a multidimensional performance measure for international joint ventures in construction. J. Constr. Eng. Manag. 2011, 137, 403–411. [Google Scholar] [CrossRef]
  48. Xiong, B.; Skitmore, M.; Xia, B. A critical review of structural equation modeling applications in construction research. Autom. Constr. 2015, 49, 59–70. [Google Scholar] [CrossRef] [Green Version]
  49. Ullman, J.B. Reviewing the basics and moving forward. J. Pers. Assess 2006, 87, 35–50. [Google Scholar] [CrossRef]
  50. Kline, R.B. Principles and Practice of Structural Equation Modeling; Guilford Publications: New York, NY, USA, 2015. [Google Scholar]
  51. Cho, K.; Hong, T.; Hyun, C. Effect of project characteristics on project performance in construction projects based on structural equation model. Expert Syst. Appl. 2009, 36, 10461–10470. [Google Scholar] [CrossRef]
  52. Ekanayake, E.M.A.C.; Shen, G.; Kumaraswamy, M.M.; Owusu, E.K.; Xue, J. Capabilities to withstand vulnerabilities and boost resilience in industrialized construction supply chains: A Hong Kong study. Eng. Constr. Archit. Manag. 2021, in press. [CrossRef]
  53. Hon, C.K.H.; Chan, A.P.C.; Yam, M.C.H. Relationships between safety climate and safety performance of building repair, maintenance, minor alteration, and addition (RMAA) works. Saf. Sci. 2014, 65, 10–19. [Google Scholar] [CrossRef] [Green Version]
  54. Seo, H.C.; Lee, Y.S.; Kim, J.J.; Jee, N.Y. Analyzing safety behaviors of temporary construction workers using structural equation modelling. Saf. Sci. 2015, 77, 160–168. [Google Scholar] [CrossRef]
  55. Zahoor, H.; Chan, A.P.C.; Utama, W.P.; Gao, R.; Memon, S.A. Determinants of safety climate for building projects: SEM-based cross-validation study. J. Constr. Eng. Manag. 2017, 143, 05017005. [Google Scholar] [CrossRef]
  56. Hair, J.F.; Sarstedt, M.; Hopkins, L.; Kuppelwieser, V.G. Partial least squares structural equation modeling (PLS-SEM): An emerging tool in business research. Eur. Bus. Rev. 2014, 26, 106–121. [Google Scholar] [CrossRef]
  57. Amora, J.T. Convergent validity assessment in PLS-SEM: A loadings-driven approach. Data Anal. Perspect. J. 2021, 2, 1–6. [Google Scholar]
  58. Nunnally, J.C. Psychometric Theory, 2nd ed.; McGraw-Hill: New York, NY, USA, 1978. [Google Scholar]
  59. Aibunu, A.A.; Al-Lawati, A. Using PLS-SEM Technique to Model Construction Organization’s Willingness to Participate in e-bidding. Autom. Constr. 2010, 19, 714–724. [Google Scholar] [CrossRef]
Figure 1. Hypotheses testing framework of the research study.
Figure 1. Hypotheses testing framework of the research study.
Sustainability 14 06421 g001
Figure 2. PLS-SEM-based structural model for benefits and enablers.
Figure 2. PLS-SEM-based structural model for benefits and enablers.
Sustainability 14 06421 g002

Figure 3. PLS-SEM-based structural model for barriers.
Figure 3. PLS-SEM-based structural model for barriers.
Sustainability 14 06421 g003
Figure 4. PLS-SEM-based structural model for recommended strategies and enhancing factors.
Figure 4. PLS-SEM-based structural model for recommended strategies and enhancing factors.
Sustainability 14 06421 g004
Table 1. Factors affecting the success of PPP in delivering SI.
Table 1. Factors affecting the success of PPP in delivering SI.
Factors Affecting the Success of PPP in Delivering SILiterature Source
Statutory/Regulatory provisions to supplement government resources in PPP[20]
Supportive legal framework[3,16,20]
‘PPP-friendly’ (favorable) policies[3,16]
Political influences and instability of collaboration commitments to the private sector[27]
Unstable governments or frequent political shifts[27]
High cost of development of SI[3,20,27]
Restrictive and/or complex financial infrastructure[28]
Uneven and inefficient risk allocation of PPP projects[3,16,29]
Lack of local and foreign investors in delivering SI[3]
Need of advanced technological capacities and/or adaptability for SI[3,16,20]
Higher construction risk if using smart technologies and PPP approaches[3]
Public/community support[30,31]
Understanding and acceptability of PPP delivery modalities by the general public[3,20]
Lack of knowledge and competencies of both the public and private parties[3,20,32,33]
Multistakeholder coordination complexities[3,20]
Table 2. Constructs and measurement items.
Table 2. Constructs and measurement items.
Constructs for Benefits and EnablersCodeMeasurement Items
1.‘Political and Legal’ (PLBE)PLBE 1Clear government objectives
PLBE 2Favorable investment climate
PLBE 3Supportive legal framework
PLBE 4Flexible existing regulations and procurement guidelines
PLBE 5‘PPP-friendly’(favorable) policies
PLBE 6Statutory/Regulatory provisions to supplement Government resources in PPP in delivering SI development projects
PLBE 7Clear and proactive PPP guidelines
PLBE 8Desire to have public sector administration cost reductions
2.‘Financial and Economic’ (FEBE)FEBE 1Sound economic policies
FEBE 2High cost of SI development
FEBE 3Tax benefits
FEBE 4Independent competitive tendering
FEBE 5High potential for financial investments
3.‘Technical’ (TBE)TBE 1Efficient PPP project management
TBE 2Private sector innovativeness in smart technologies
TBE 3Drivers to upgrade and/or adapt technological capacities
TBE 4Previously used PPP frameworks/management models
TBE 5Drivers to increase “value for money” from SI services through more-efficient, lower-cost, and/or reliable services
4.‘Social’ (SBE)SBE 1Societal needs/‘demand’ for Smart Infrastructure
SBE 2Public/community support
SBE 3General public’s understanding and acceptability of PPP delivery methods
SBE 4Ensuring proper knowledge transfer from the private partner to the public partner
SBE 5Drivers to create more local job opportunities
Constructs for BarriersCodeMeasurement Items
1.‘Financial and Economic’ (FB)FB 1Restrictive and/or complex financial structure
FB 2Currency rate fluctuations
FB 3Unavailability of investor-friendly tax conditions
FB 4Tariff changes
FB 5Uneven and inefficient risk allocation of PPP projects
FB 6Lack of adequate local and foreign investors with financial capacities to fund SI
2.‘Legal and Sociopolitical’ (LSPB)LSPB 1Weak/inconsistent legal PPP framework
LSPB 2Unavailability/lack of relevant policies
LSPB 3Political influences and instability in selecting and administering private sector collaborations
LSPB 4Lack of government support for private sector collaboration
LSPB 5Inconsistent administrative systems
LSPB 6Dishonest/unethical practices and corruption
LSPB 7Barriers to transferring ownership/management control of the assets and/or repatriating funds
LSPB 8Lack of confidence of the government in private sector collaborators
LSPB 9Frequent political/policy shifts affecting SI development and operations
LSPB 10Lack of accountability in governance
LSPB 11Lack of mechanisms to attract long-term finance from private sources
LSPB 12Less competition due to high tendering costs
3.‘Social’ (SB)SB 1Lack of related knowledge and competencies of the various stakeholders
SB 2Citizens’ general reluctance to accept private sector involvement
SB 3Public opposition due to perceptions of risks of involving private sector in using PPP (rather than only Government) in SI development
SB 4Inconsistency between the interests of citizens and private investors
SB 5Privacy concerns (e.g., the need to maintain confidentiality of personal information)
SB 6Unawareness due to absence of well-defined benefits in SI that would improve citizens’ quality of life
SB 7Multi-stakeholder coordination complexities
SB 8Lack of a PPP-conducive national culture
SB 9Lack of private sectors’ consideration on sustainable construction and development
4.‘Technical’ (TB)TB 1Unclear scope of work
TB 2Higher construction risk of using smart technologies
TB 3Difficulties in evaluating dissimilar PPP Proposals/Tenders and their potential impacts
TB 4Complex decision making process due to excessive variables and scenarios involved in smart-infrastructure projects
TB 5Lack of ‘intellectual property rights’ protection
TB 6Lack of critical resources available to the private parties
TB 7Security shortfalls (against ‘hacking’/sabotage) and resilience of some smart systems
TB 8Inefficient provisions in facility operation and maintenance
TB 9Lack of reliable support-infrastructure
Constructs for Recommended Strategies and Enhancing FactorsCodeMeasurement Items
1.‘Stakeholder’ Related (SREF)SREF 1Appropriate equitable risk allocation and sharing
SREF 2Clarity of roles, responsibilities, and potential rewards among contracting parties
SREF 3Effective stakeholder management
SREF 4Strong support from local banks and other relevant bodies
2.‘Legal and Sociopolitical’ Related (LREF)LREF 1Stable and consistent laws, regulations, and policies
LREF 2Proactive national policy for PPP in SI development
LREF 3Proactive ‘PPP and SI’-friendly laws and regulations
LREF 4Protection mechanisms against political volatility
LREF 5High transparency of the procurement process
LREF 6Extensive vendor and end-user engagement in designing the appropriate PPP structure
LREF 7Encouraging competitive bidding from private participants with innovative alternative smart solutions
LREF 8Ensuring project continuity and end-user benefits through a long-term commitment
LREF 9Enabling public and/or private sectors’ equity stakes in innovative PPP SI projects
3.‘Technical’ Related (TREF)TREF 1Defining minimum functional needs with requisite technical specifications
TREF 2Well-structured, equitable, and enforceable contracts
TREF 3Highly transparent contracting process
TREF 4Periodic high-level reviews and remedial actions throughout the whole project delivery process
TREF 5Mechanisms for faster project implementations
TREF 6Moving from silo-based to collaborative team working
4.‘Social’ Related (SRF)SRF 1Effective frequent engagement with end-users and the general public
SRF 2Community capacity building
SRF 3Citizen centric decision making process
SRF 4Ensuring more tangible benefits for the general public
5.‘Financial’ Related (FREF)FREF 1Proactive facilitation of capital and finance
FREF 2Proactive addressing of the private sector’s financial priorities and concerns
Table 3. Respondent profiles.
Table 3. Respondent profiles.
DemographicsCategoryNumber of ResponsesPercentage
ProfessionEngineer4242%
Surveyor1616%
Researcher1818%
Project Manager1212%
Architect1212%
Sector typePublic Sector3535%
Private Sector5858%
Both Sectors77%
Years of professional experienceAbove 15 years1919%
10–15 years4242%
5–10 years3333%
Less than 5 years66%
Country/RegionHong Kong2929%
Switzerland1111%
Australia1313%
United Kingdom99%
Canada44%
Netherlands22%
New Zealand77%
United States99%
Singapore77%
Oman99%
Table 4. Constructs’ reliability and validity measures of the benefits and enablers model.
Table 4. Constructs’ reliability and validity measures of the benefits and enablers model.
ConstructMeasurement Item CodeFactor LoadingCronbach’s AlphaRho_AComposite ReliabilityAVE
FEBEFEBE 10.8850.7790.8080.8580.604
FEBE 20.727----
FEBE 40.653----
FEBE 50.824----
PLBEPLBE 10.8790.9500.9510.9580.740
PLBE 20.892----
PLBE 30.824----
PLBE 40.885----
PLBE 50.851----
PLBE 60.863----
PLBE 70.901----
PLBE 80.783----
SBESBE 10.8920.8310.8370.8870.664
SBE 20.802----
SBE 30.784----
SBE 40.775----
TBETBE 10.8820.8080.8270.8690.573
TBE 20.617----
TBE 30.789----
TBE 40.697----
TBE 50.773----
Table 5. Discriminant validity of the constructs of the benefits and enablers model.
Table 5. Discriminant validity of the constructs of the benefits and enablers model.
Measurement Item CodeFEBEPLBES1S2S3SBETBE
FEBE0.777------
PLBE0.7230.860-----
S10.6400.6861.000----
S20.5400.8070.5611.000---
S3−0.628−0.749−0.569−0.5221.000--
SBE0.7380.7510.7010.576−0.5690.815-
TBE0.7340.7840.7700.557−0.6430.8700.757
Table 6. Bootstrapping results for the benefits and enablers model.
Table 6. Bootstrapping results for the benefits and enablers model.
PathsStandard Deviationt-Valuep-Value
FEBE—S10.0971.0190.308
FEBE—S20.0910.5450.586
FEBE—S30.0873.8120.000
PLBE—S10.1221.3910.164
PLBE—S20.1307.3940.000
PLBE—S30.1593.4910.000
SBE—S10.1370.2740.784
SBE—S20.1221.0080.313
SBE—S30.1351.8840.060
TBE—S10.1353.9440.000
TBE—S20.1751.5120.131
TBE—S30.2120.8770.380
Table 7. Constructs’ reliability and validity measures of the barriers model.
Table 7. Constructs’ reliability and validity measures of the barriers model.
ConstructMeasurement Item CodeFactor LoadingCronbach’s AlphaRho_AComposite ReliabilityAVE
FBFB 10.7470.8210.8490.8700.530
FB 20.775----
FB 30.728----
FB 40.691----
FB 50.572----
FB 60.828----
LSPBLSPB 10.7650.9400.9450.9490.611
LSPB 20.862----
LSPB 30.832----
LSPB 40.680----
LSPB 50.820----
LSPB 60.731----
LSPB 70.811----
LSPB 80.810----
LSPB 90.772----
LSPB 100.841----
LSPB 110.856----
LSPB 120.538----
SBSB 10.7650.8990.9050.9190.561
SB 20.829----
SB 30.858----
SB 40.686----
SB 50.807----
SB 60.535----
SB 70.805----
SB 80.707----
SB 90.694----
TBTB 10.7960.9160.9170.9300.599
TB 20.831----
TB 30.824----
TB 40.643----
TB 50.766----
TB 60.778----
TB 70.774----
TB 80.767----
TB 90.771----
Table 8. Discriminant validity of the constructs of the barriers model.
Table 8. Discriminant validity of the constructs of the barriers model.
Measurement Item CodeFBLSPBS1S2S3SBTB
FB0.728------
LSPB0.6160.782-----
S10.5420.6281.000----
S20.5990.8190.5831.000---
S3−0.224−0.581−0.345−0.4681.000--
SB0.8030.6530.7610.647−0.1940.749-
TB0.5060.8830.6430.752−0.7280.5700.774
Table 9. Bootstrapping results for the barriers model.
Table 9. Bootstrapping results for the barriers model.
PathsStandard Deviationt-Valuep-Value
FB—S10.1102.0760.038
FB—S20.0980.6300.528
FB—S30.0970.8650.387
LSPB—S10.1190.6630.507
LSPB—S20.1433.8650.000
LSPB—S30.1840.5270.599
SB—S10.1107.0660.000
SB—S20.1221.2580.208
SB—S30.1412.6270.009
TB—S10.1113.4600.001
TB—S20.1421.0250.305
TB—S30.1059.3810.000
Table 10. Constructs’ reliability and validity measures of the recommended strategies and enhancing factors model.
Table 10. Constructs’ reliability and validity measures of the recommended strategies and enhancing factors model.
ConstructMeasurement Item CodeFactor LoadingCronbach’s AlphaRho_AComposite ReliabilityAVE
FREFFREF 10.9330.8690.8770.9380.884
FREF 20.947----
LREFLREF 10.7160.8670.8750.8950.489
LREF 20.816----
LREF 30.791----
LREF 40.620----
LREF 50.578----
LREF 60.665----
LREF 70.758----
LREF 80.705----
LREF 90.606----
SREFSREF 10.8660.8360.8420.8910.672
SREF 20.862----
SREF 30.750----
SREF 40.796----
SRFSRF 10.8420.8770.8840.9160.731
SRF 20.829
SRF 30.919----
SRF 40.826----
TREFTREF 10.6720.8380.8420.8810.554
TREF 20.755----
TREF 30.825----
TREF 40.723----
TREF 50.722----
TREF 60.760----
Table 11. Discriminant validity of the constructs of the recommended strategies and enhancing factors model.
Table 11. Discriminant validity of the constructs of the recommended strategies and enhancing factors model.
Measurement Item CodeFREFLREFS1S2S3SREFSRFTREF
FREF0.940------
LREF0.6410.700-----
S10.5460.6431.000----
S20.6250.8110.5631.000---
S3−0.700−0.571−0.497−0.5781.000--
SREF0.6550.8030.5770.712−0.7570.820-
SRF0.5070.7640.6390.638−0.4180.6840.855
TREF0.6070.7320.7450.638−0.5460.7270.6800.744
Table 12. Bootstrapping results for the recommended strategies and enhancing factors model.
Table 12. Bootstrapping results for the recommended strategies and enhancing factors model.
PathsStandard Deviationt-Valuep-Value
FREF—S10.0731.7350.083
FREF—S20.0692.1690.030
FREF—S30.0567.2010.000
LREF—S10.1360.8030.422
LREF—S20.1244.9000.000
LREF—S30.1131.0390.299
SREF—S10.1480.8890.374
SREF—S20.0981.0670.286
SREF—S30.0917.8740.000
SRF—S10.0742.8950.004
SRF—S20.0620.2450.806
SRF—S30.0892.0060.045
TREF—S10.1084.9690.000
TREF—S20.0750.2080.835
TREF—S30.1060.1340.894
Table 13. Summary of the findings for benefits and enablers.
Table 13. Summary of the findings for benefits and enablers.
Benefits and EnablersConstructRank for the Impact
S1S2S3
Sustainability 14 06421 i001PLBE2 (1.391)1 (7.394)2 (3.491)
Sustainability 14 06421 i002FEBE3 (1.019)4 (0.545)1 (3.812)
Sustainability 14 06421 i003TBE1 (3.944)2 (1.512)4 (0.877)
Sustainability 14 06421 i004SBE4 (0.274)3 (1.008)3 (1.884)
Table 14. Summary of the findings for barriers.
Table 14. Summary of the findings for barriers.
BarriersConstructRank for the Impact
S1S2S3
Sustainability 14 06421 i005FB3 (2.076)4 (0.630)3 (0.865)

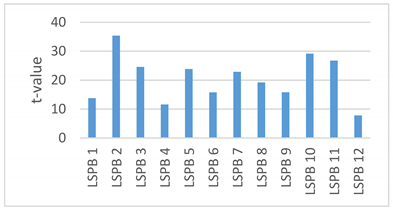

Sustainability 14 06421 i006LSPB4 (0.663)1 (3.865)4 (0.527)
Sustainability 14 06421 i007SB1 (7.066)2 (1.258)2 (2.627)
Sustainability 14 06421 i008TB2 (3.460)3 (1.025)1 (9.381)
Table 15. Summary of the findings for recommended strategies and enhancing factors.
Table 15. Summary of the findings for recommended strategies and enhancing factors.
Recommended Strategies and Enhancing FactorsConstructRank for the Impact
S1S2S3
Sustainability 14 06421 i009SREF4 (0.889)3 (1.067)1 (7.874)
Sustainability 14 06421 i010LREF5 (0.803)1 (4.900)4 (1.039)
Sustainability 14 06421 i011TREF1 (4.969)5 (0.208)5 (0.134)
Sustainability 14 06421 i012SRF2 (2.895)4 (0.245)3 (2.006)
Sustainability 14 06421 i013FREF3 (1.735)2 (2.169)2 (7.201)
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations.

Share and Cite

MDPI and ACS Style

Jayasena, N.S.; Chan, D.W.M.; Kumaraswamy, M.M. Is Public–Private Partnership (PPP) a Preferred Strategy for Procuring Smart Infrastructure in Developed Countries: An Empirical Study of the Perceived Benefits, Barriers and Recommended Strategies. Sustainability 2022, 14, 6421. https://doi.org/10.3390/su14116421

AMA Style

Jayasena NS, Chan DWM, Kumaraswamy MM. Is Public–Private Partnership (PPP) a Preferred Strategy for Procuring Smart Infrastructure in Developed Countries: An Empirical Study of the Perceived Benefits, Barriers and Recommended Strategies. Sustainability. 2022; 14(11):6421. https://doi.org/10.3390/su14116421

Chicago/Turabian Style

Jayasena, Nimesha Sahani, Daniel W. M. Chan, and Mohan M. Kumaraswamy. 2022. "Is Public–Private Partnership (PPP) a Preferred Strategy for Procuring Smart Infrastructure in Developed Countries: An Empirical Study of the Perceived Benefits, Barriers and Recommended Strategies" Sustainability 14, no. 11: 6421. https://doi.org/10.3390/su14116421

APA Style

Jayasena, N. S., Chan, D. W. M., & Kumaraswamy, M. M. (2022). Is Public–Private Partnership (PPP) a Preferred Strategy for Procuring Smart Infrastructure in Developed Countries: An Empirical Study of the Perceived Benefits, Barriers and Recommended Strategies. Sustainability, 14(11), 6421. https://doi.org/10.3390/su14116421

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
