1. Introduction
Scholars identified several causes for companies to commit to sustainability, on the one hand increasing public pressure and on the other the perception that sustainability is a means of long-term competitive advantage [
1]. Therefore, most organizations have integrated sustainability in their strategy; however, there are deficiencies to measure sustainability performance in a comprehensive and aggregate way [
2]. The question of how to manage sustainability has been discussed for years, and scholars have argued about how economic sustainability can be assessed (e.g., reference [
3]).
In this discourse, it is acknowledged that sustainability is not only related to environmental protection. For the sustainability construct, several aspects are of equal relevance: social, ecologic, and economic dimensions of sustainability. Focusing on economic sustainability (ES), the decisions of today shall allow the achievement of economic goals, but they also will allow the achievement of economic goals in the future. In the debate about ES, researchers identify a life cycle cost (LCC) perspective as being useful to assess and measure sustainability (e.g., reference [
4]).
LCC typically aims to assess all costs related to a product or project over its whole life cycle. In that sense LCC acknowledges that often the operating costs exceed initial purchase prices by several times. As such, it would be a sustainable choice to buy a product with a higher price today if lower operating costs can be achieved in the future. Life cycles are widely considered in the discourse about sustainability in general, or for specific applications, such as toys or even circular economies [
5,
6,
7]. Generally, it is no surprise that cost information and cost structures are seen as appropriate indicators for ES (e.g., reference [
8]).
However, even in times of digitalization, the availability of appropriate information about sustainability is still an issue [
9]; however, Adams et al., (2014) [
10] found that modern information systems provide an opportunity to incorporate measures aligned with sustainability outcomes. Therefore, this work does not question if LCC is appropriate to measure sustainability, but rather, how the measured LCC information is processed and used in decision making.
The majority of papers linked to the topic do not consider how the information is processed [
11,
12,
13]. They calculate or assess sustainability with LCC and then assume this will directly lead to sustainable behavior [
14,
15,
16,
17]. However, decision makers need reliable information and they want to be convinced. Then they decide on their evaluation and perception of the presented data. Therefore, the overarching research aim is to understand how LCC information support management decisions that impact ES. It is assumed that LCC is able to assess ES and provide appropriate information to decision makers.
As such, this research refers to organizational information processing theory (OIPT) to examine how LCC might be an important information processing capability that can improve economic sustainability. This object of analysis is embedded in the context of organizational buying behavior theory (OBB), which manifests in buying center (BC) procurement decisions. To the best of our knowledge, this work is one of very few that merges both theories. If information is processed correctly in a BC, this would lead to a procurement decision with positive effects on ES (see

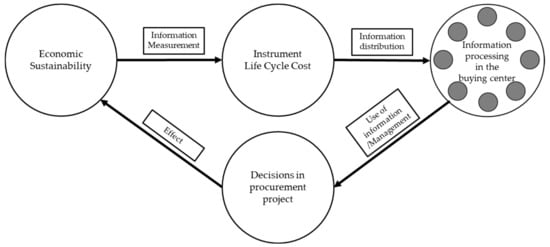

Figure 1). The focus in the information processing lies on information measurement, distribution, and use for decision making; effects are only briefly considered. Overall, this research wants to acquire deeper insights into how LCC information is gathered, processed, and used for decision making.
For this purpose, this research uses an inductive approach. Empirical cases are investigated in a qualitative way to obtain insights into how and why ES LCC information is processed. The qualitative case study approach follows the methodological guidelines of Yin (2017) [
18] and investigates eight cases. The cases provide original insights, namely that the implementation of the sustainability approach is not limited to single institutions [
19]. Rather, it has a strong influence on whole supply chains with all involved institutions, e.g., suppliers [
20]. Therefore, the focus of the cases is on the BC and its members procurement decisions, because these decisions will have an impact on upstream supply markets. In particular, this research focuses on public institutions, because they act in several important roles related to sustainability. Glas et al. (2018) [
21] refers to the “policy maker and legislator”, “leader and pioneer”, as well as the “sensitive consumer”. As such, public organizations, and their assessment of ES by LCC methods and information processing, seem to be a relevant unit of analysis.
Following the research aim and the unit of analysis, the following questions are addressed:
RQ1: Which LCC information is gathered and reported?
RQ2: Which Buying Center member needs which LCC information, and at what time?
RQ3: Which decisions made by the buying center are influenced by LCC information?
The remainder of the paper is structured as follows: The next section presents the background of ES LCC and its relevance for procurement decisions. It also provides insights into OIPT and OBB. In
Section 3, the case methodology is presented. This is followed by the analysis and findings in
Section 4. The findings are discussed in
Section 5. Finally, this article concludes by noting limitations and providing an outlook for future research.

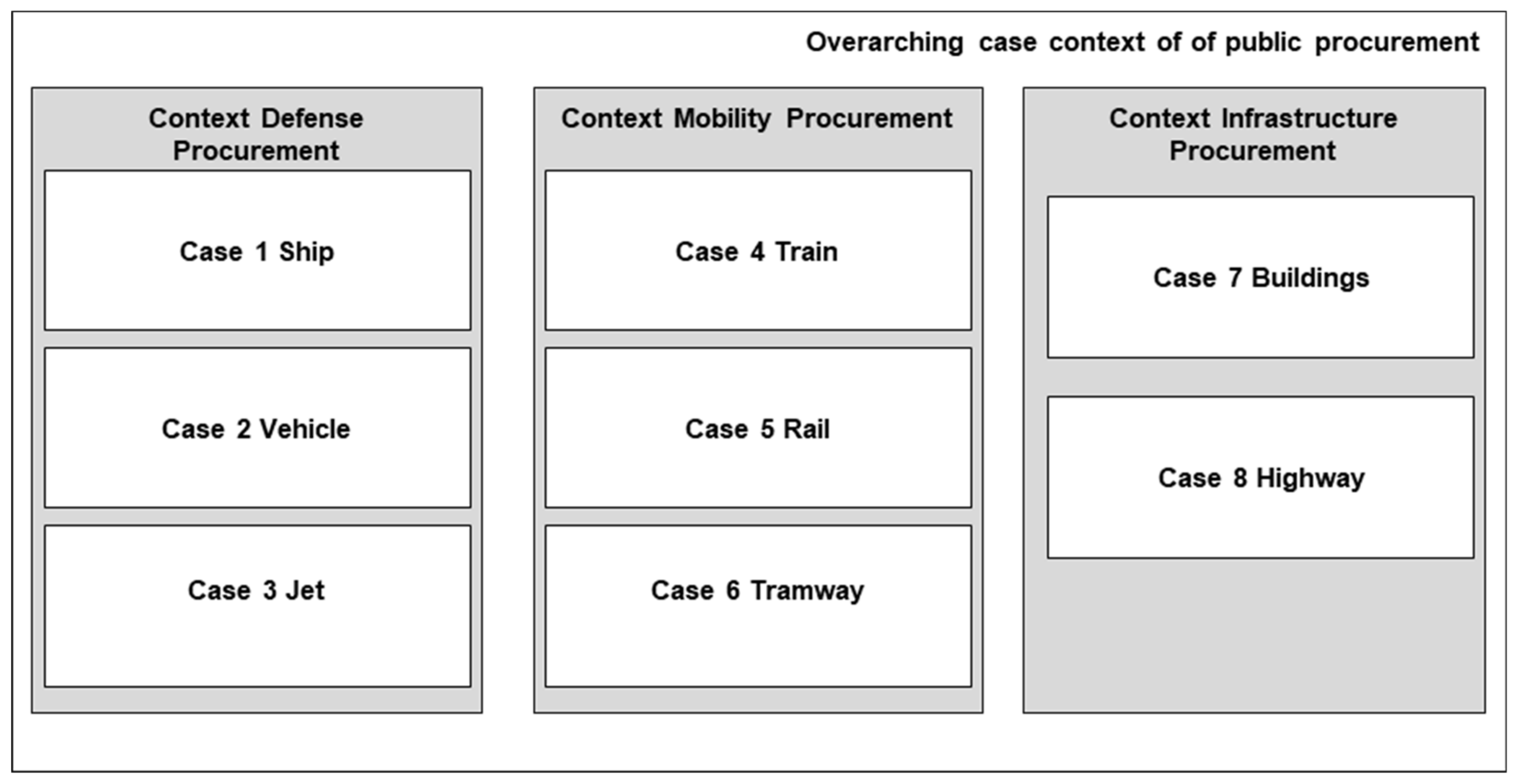

4. Case Description and Analysis Results
In the following section the results of the multiple case study are presented. First, we briefly report on the overarching public procurement context of the cases (
Section 4.1). Then, the cases are presented in clusters of defense (
Section 4.2), mobility (
Section 4.3), and infrastructure (
Section 4.4). The case findings are consolidated in a cross-case analysis (
Section 4.5).
4.1. Public Procurement Case Context and ES LCC
The need to carry out profitability studies in the public sector due to national legal regulations has already been mentioned. In addition, however, there are other (legal) framework conditions for the use of LCC in the cases that are embedded in the context of the EU public procurement.
First, we point to the Europe 2020 strategy for smart, sustainable, and inclusive growth-taking, in which the European Commission has highlighted LCC for public tenders [
77]. In the context of sustainable public procurement, LCC is valued as an important element to expand the paradigm of the single purchase price. With the 2014/24/EU directive, which had to be transposed into national law, external effects, e.g., environmental impacts, can now also be considered in the LCC calculation [
78]. Therefore, the case context brings a situation in which sustainability, as well as LCC, is relevant.
Second, it is worth mentioning that the methodology for using LCC is still at the discretion of the contracting authority, although methodology guidelines are prescribed, e.g., for road vehicles [
79]. The use of LCC in public procurement is currently still optional, but will become mandatory if a methodology is available from the European Commission [
80,
81]. This means that we expect the cases to have their own approach to process information about ES LCC.
Besides this, it is worth mentioning that the cases are all embedded in the context of EU public procurement. However, if the findings provide insights as to why and how ES LCC is helpful, then public procurement in other legal contexts may also profit from this research.
4.2. Defense Cases
Defense procurement projects are often accompanied by high procurement costs and long utilization phases of the considered products and systems. The utilization phase of a military system usually takes 30 years or longer. Approximately 70% of the total life cycle costs of military systems are attributable to the utilization phase, which makes it reasonable to consider the total life cycle costs of the systems [
82]. However, around 80% of the life cycle costs are already defined in the design and development phase of military systems. Therefore, the optimization of ES should happen as early as possible, i.e., in the procurement decision-making phase. It is remarkable that procurement decisions in defense of course follow a military, but also an industrial policy logic, while optimization of ES is a relevant but not dominant objective for many members of the BC. The BC in the defense cases is mainly established by a committee named the “integrated project team”, to which different members and actors from the armed forces contribute (planning, budget, and logistics, etc.).
Case 1 Ship: This case is about the procurement of multi-purpose frigates for the German Navy. The procurement volume for the planned four units amount to around EUR 5.3 billion, and includes the design, construction, and delivery of the ships. An option for the procurement of two further units has been included, as the Navy’s procurement requirement has been assessed at six units. The interviewee was the head of the buying center.
In view of the defined arms budgets for the armed forces in general, and the navy in particular, the expectation was that no significant increases can be expected in the coming years. This means that the available budgets must be used optimally and invested sensibly in the long term. Therefore, ES was a leading goal for the BC. However, the interview revealed that the problem was to obtain suitable ES LCC information and to communicate it to specific members of the BC: “With regard to ES LCC, three factors are particularly important: 1. cost transparency, 2. forecasting, 3. answering questions, especially from the political and parliamentary sphere”.
Referring to information needs, the BC was aware that ES LCC information is important as a basis for reporting in the political parliamentary arena, since it was necessary to obtain approval for the procurement of new ships from the highest political level. From an information capabilities point of view, the BC used LCC as the central tool for supporting the procurement decision. In-house specialists for cost analysis and external consultants were tasked to execute and evaluate LCC computations. However, there was also the need to be open for additional information processing capabilities from the supplier side. So, the BC defined LCC as an award criterion. The bidders were obliged to carry out an LCC forecast for their ship designs and attached this information as a basis for their bid calculations. The amount of the total LCC has been evaluated by the BC using an evaluation matrix. In other words, parts of the information processing happened at the supplier side. Finally, the information fit was assessed. Here, the different BC members had to be provided with differently detailed ES LCC information at different times during the decision-making process. While the project management level had to have very detailed LCC information about each subsystem installed on the ship, the political level was supplied with LCC information at the overall system level. The interview assessed this as a robust and feasible way to inform the BC members. Besides this, it was appreciated by the interviewee that the detailed LCC documentation supported cost transparency and the identification of critical cost drivers. “The initial cost estimate of the project was rated as very good. Furthermore, it enabled a detailed cost determination and created the necessary cost transparency”.
The following aspects summarize ES LCC information processing in the BC of the case:
- -
ES LCC as a relevant information requirement in order to keep open the possibility to procure not only four but even six units of the ship in the face of restricted budgets;
- -
Development of a ship and cost model as central information processing capabilities with the help of internal and external parties and the contribution of supplier information processing capabilities with their LCC calculations following award criteria;
- -
Consideration of ES LCC was reviewed by the German Government Accounting Office, and ES LCC has been regularly reported across different management levels. Stepwise increase in details about ES LCC information depending on stakeholders is assessed as a positive strategy for information processing.
Case 2 Vehicle: This case is about the procurement of infantry fighting vehicles for the German army. About 350 vehicles are already delivered to the army. Up to 220 more vehicles should be procured. The procurement volume for the new units amounts to around EUR 5.3 billion. The interviewee was the head of the project and head of the buying center. Because of the high complexity of the acquisition project, hundreds of stakeholders were involved in the project. These stakeholders have been drawn together for the project from numerous specialist departments within the procurement organization. Each stakeholder has been involved in the BC because of their specific expertise. For example, various technical or legal departments have been involved. However, the interview was focused on core stakeholders of the BC with relation to ES LCC information.
Due to the further development of technical solutions in vehicle development, there was a need to upgrade the vehicles already delivered. As the planned upgrade was very expensive, several ES LCC information requests from BC members exist in that area. There was the need to clarify if the upgrades of the vehicles made sense or if the procurement of additional vehicles was more advantageousness. In addition to that, an ES LCC information request about the utilization costs for the vehicles exists. In the long term, the utilization costs of the fleet are decisive for the total budget required for the project. Therefore, the ES LCC estimation for the existing fleet was important for the BC. LCC information was not available for the project at that time, although the system was already in use. As this kind of information was not available at the very beginning of the procurement project, the BC requested this information in order to find a proper procurement decision for the upgrade problem.
“An LCC analysis would have been clearly advantageous at this point, as the costs of use and the required budget could have been forecast at an early stage using the data from the LCCM.”
In order to obtain the necessary ES LCC information, there was a need for a fast LCC estimation. Since the project had no experience with LCC estimation at that time, but wanted to use it as a decision support tool in the long term, an external company was contracted to develop a database-driven LCC estimation. The development of the database has been performed in close collaboration between the procurement project, the in-house cost competence center (CCC), and the external company. The LCC estimation database was able to collect all costs associated with the project. The LCCs are reported on the level of different cost elements, a simulation helps to estimate the LCC in the future, and cost driver identification is possible.
Concerning the information fit, the BC, with the help of this database, was able to cover different information requests. While the project management level is able to generate very detailed LCC information about each subsystem installed in the vehicle, the political level can be supplied with LCC information at the overall system level. The interviewee assessed this as a robust and feasible way to inform the BC members. Besides this, it was appreciated by the interviewee that the detailed LCC documentation supported cost transparency and the identification of critical cost drivers.
“The project intends to use the results of the LCCM […] for the preparation of reports and for more precise forecasts.”
The following aspects summarize ES LCC information processing in the BC of the case:
- -
The information request for a short-term ES LCC estimation could not be met by own capabilities;
- -
The BC’s procurement decision should be based on reliable ES LCC forecasts;
- -
The development of an LCC database seemed to be a good solution for informing BC members.
Case 3 Jet: This case describes the procurement for multi-role fighter jets. The current plan is to procure 38 additional aircraft. The procurement volume was around EUR 5.5 billion. The interview was conducted with the head of the project, the head of commercial project management, and the project manager who was responsible for the LCC estimation. The head of the project was the head of the BC.
Due to a lack of cost transparency within the project, the German Government Accounting Office (GGAO) had been instructed to collect LCC information in order to acquire an overview of the current financial situation. Without the necessary cost transparency, it would not be an option for the GGAO to support investments of the fleet in the future (e.g., upgrades). The GGAO plays a very special role here, as decision makers at the political level, in particular, take the GGAO’s findings and recommendations into account in their decision-making processes, for example, when approving budgets. Therefore, the primary objective was to identify all cost elements associated with the project for the transparency of future budget planning.
“LCC information is needed to refine cost estimates to justify necessary budgets (on a parliamentary level).”
Referring to this, the task of the BC was to obtain a clear overview of the current spending situation. In order to be able to procure the necessary support from the GGAO, and therefore from the highest political level, it was absolutely important to collect the cost information in a structured and consistent way. From an information capabilities point of view, the BC used the LCC logic as the central tool for collecting all cost information from the jet. The collected LCC information was also the basis to estimate the utilization costs of the jet in the future.
First of all, it can be stated that the already-existing project team did not have the resources, skills, and abilities to conduct their own LCC estimation. Therefore, an external service provider was assigned to develop a unified concept for capturing the jet’s LCC. For the collection of the LCC information, the existing specifications for the collection of LCC in the MoD have been used. This was intended to enable a uniform collecting and reporting of the results. The focus of the LCC capture was clearly on creating cost transparency in the project. The amount of the individual cost elements was initially of secondary importance.
A particular challenge was the cross-project collecting and systematization of the LCC, since numerous other projects provided input for the jet project. This included, for example, the procurement of radio or radar equipment, as each is coordinated and implemented in a separate project, but after realization they merged into the overarching jet project. The creation of cross-project cost transparency was also intended to enable the identification of cost drivers in order to create the possibility of strategic and thus economically beneficial fleet management.
Similar to the project described above, the contracted company developed an LCC database, which enabled a cross-project LCC estimation. The LCC estimation database helped to collect all costs associated with the main project on the cost element level described in the MoD manual. A forecast of future costs is not possible yet, but is currently being developed in order to obtain relevant information about the necessary budget for the fleet operation.
Concerning the information fit, the BC was able to cover the information requests from the GGAO and the political level. The project leader was able to obtain information about cost drivers on the system or subsystem level. This, in turn, helped to compare cost drivers with other nations and to see if they have identified similar cost drivers. This enables the use of the LCC in the sense of ES LCC information.
“The main objective is to ensure the required availability of the weapon system (to provide as many jets as possible ready for deployment) at the most economical conditions—in the long-run.”
The following aspects summarize ES LCC information processing in the BC of the case:
- -
Creation of cost transparency was the main driver of the LCC estimation;
- -
Development of resources and skills for LCC information processing during the project;
- -
Support from an external company as an additional information processing capability;
- -
The development of an LCC database seemed to be a good solution for informing BC members.
4.3. Mobility Cases
The provision of local and long-distance public transport services is one task of the public sector. In order to be able to provide these mobility services, there is a great need for appropriate vehicles. The demand includes, for example, trains for long-distance traffic, as well as streetcars for urban traffic. Regardless of long-distance or regional transport, these vehicles have common features. All trains usually have long service cycles. A period of 30 years or more is not uncommon for trains and streetcars. High procurement costs also go hand in hand with the acquisition of new trains and railroads. Due to the long utilization cycles, there are also high costs for the operation of trains and streetcars that have to be borne by the operator of the mobility services. However, there is a need for high availability in order to operate the fleet in an economic way. The fleet sizes must also be optimally planned so that no unnecessary trains are procured and operated. This results in a complex optimization problem between actual demand for transport line capacity, reliability, and availability of the fleet, and the associated procurement and utilization costs. The presented case studies of the mobility cluster address the above-mentioned challenges by processing LCC information.
Case 4 Train: The case is about the procurement of trains for long-distance passenger transport in Germany. There are plans to buy up to 300 trains, with a procurement volume around EUR 5.5 billion, which includes the design, construction, and the delivery of the trains. From the very beginning, a purchase commitment of 130 trains had been agreed, which can be extended to up to 300 trains if required. The interview was held with the head of the project, the head of commercial management, and the head of technical solutions. The head of the project also had the role of the head of the BC.
The procurement of the new train fleet was aimed at the gradual replacement and standardization of the existing train fleet. As a result, three different train types have been replaced by the new train as part of the procurement project. While train type 1 has been in service for almost 40 years, train type 2 has been in service for about 20 years, and train type 3 has been in service for 15 years. Due to the high average age of the train fleet, it was assumed in the run-up to the procurement planning that the maintenance expenses for the currently operating trains alone would increase by 8.2% per year. In this respect, it has been anticipated that the costs of operating the train fleet will rise more sharply in the future, making it more difficult to operate the fleet economically.
Regarding the information needs of the BC, it was clear that the procurement of a new generation of trains would affect the business for the next 30 years. In order to obtain the approval for buying new trains, many different LCC information requests had to be met. In addition to the realization of the technical requirements for the new trains, the information requirements focused primarily on the costs in the utilization phase. These costs shall be considered for making the procurement decision. An ES LCC estimation was therefore planned for the project.
“It is important that LCC is recorded as accurately as possible in the early project phase, as this is where the influence of LCC appears to be greatest. This plays an important role in resource planning.”
From an information capabilities point of view, the BC used LCC as the central tool for supporting the procurement decision. The core requirements for the new trains had been firmly defined in advance by the project. With the help of this specification, the possibility of a price-based evaluation of the performance requirements has been achieved. A particular challenge was the development of a suitable CBS, as this had not yet been defined at the start of the work. With the help of an ES LCC estimation, the main cost drivers in the utilization phase of the train fleet could be identified and also used as an evaluation criterion for the award procedure. The BC defined LCC as an award criterion. Electricity consumption, personnel expenses, maintenance expenses, and cleaning expenses have been identified as the main cost drivers. In order to be able to estimate the LCC of the different train designs, a utilization profile of the trains was developed and given to the bidders. Based on this utilization profile, the evaluation of the proposals (with a strong focus on the cost drivers) was conducted. In this way, the cost drivers could already be considered in the train design and the overall concept could be developed as cost-optimally as possible. In order to be able to secure the LCC forecast from the bidders, it was planned from the beginning to contract the main cost drivers with the bidders. This created an incentive for bidders to provide the most detailed and accurate LCC estimation possible. The information fit was assessed by the BC by comparing the different train designs and offers. An external consulting firm was retained to review the bids and evaluate compliance with the technical requirements in conjunction with the designated LCC. The ES LCC information was then used to select the most economically sustainable offer. This information, in turn, has been used as the basis for obtaining commitments throughout the organization. The following aspects summarize ES LCC information processing in the BC of the case:
- -
Establishment of fixed performance requirements for the fleet as a target for suppliers;
- -
Identification of the main cost drivers;
- -
Definition of LCC as an award criterion;
- -
Development of a train-utilization profile as a common basis for bid evaluation (legal certainty);
- -
Support from external third parties for validation of the LCC from the suppliers.
Case 5 Rail: This case is about the procurement of new trains for local passenger transport in Germany. The plans were to buy 82 trains, with a procurement volume around EUR 1.7 billion, including the construction, delivery, and maintenance services for the trains. The interview was held with the head of the project and the head of commercial management. The head of the project also had the role of the head of the BC. The peculiarity in this project is the composition of the BC. Since the procurement of the new trains is embedded in an overall project with the simultaneous procurement of new rail infrastructure, a political representative of the government is represented in the BC. At the same time, the trains are being procured on behalf of municipal transport associations, which are also members of the BC.
The fact that the procurement of the new trains was not carried out by the municipal transport associations themselves had economic reasons. By bundling the procurement requirements, the federal state hoped to obtain improved purchasing conditions and significantly better conditions during the trains’ utilization phase. Therefore, detailed ES LCC information was very important for the BC and the procurement decision. In order to obtain an economically advantageous procurement decision, the BC was obliged to collect the appropriate ES LCC information at a suitable time, and to report the information with the necessary details to the several members of the BC.
“For the procurement decision, three aspects were of particular importance to the BC: acquisition price, monthly availability fee, and energy consumption for 30 years.”
From an information capabilities point of view, the BC used LCC as the central tool for supporting the procurement decision. Numerous technical, as well as monetary requirements, have been defined for the procurement of the train fleet in order to be able to meet the needs of the public buying authority. The consideration of LCC estimations as an evaluation tool has not been considered from the beginning of the project. Rather, the focus has been placed on aspects such as compatibility, reliability, sustainability, or comfort for the passengers. In the course of the project, the LCC estimations became more and more important, because an economic evaluation of the previously defined criteria with the instruments used so far was not possible in a sufficient way. The information requests from the BC could not be answered. In particular, it was not possible to adequately assess sustainability targets. Therefore, the implementation of LCC has been enforced.
In addition to the LCC, availability was defined as one of the main focal points for the procurement project. To this end, an availability contract was concluded with the manufacturer in which the 100% availability of the train fleet was stipulated in order to be able to adhere to the planned train schedule. Availability is thus a key performance indicator that influences the required overall size of the train fleet. The fleet size, in turn, has a direct influence on the overall LCC. On the one hand, due to the procurement costs and on the other hand due to the operating costs.
The technical information was then merged with the associated price/cost information by evaluating the bids. In addition to the prices for the new trains, the bidders also provided information in their bids on the planned costs for the operating phase. Therefore, the information fit could be achieved. The following aspects summarize the ES LCC information processing in the BC of the case:
- -
Establishment of fixed performance requirements for the fleet as a target for suppliers;
- -
Identification of the main cost drivers;
- -
Definition of LCC as an award criterion;
- -
Development of a train-operation profile as a basis for bid evaluation (legal certainty).
Case 6 Tramway: This case is about the procurement of new trains for local passenger transport. The plans were to buy 119 trains, with a procurement volume around EUR 562 million. The procurement volume also includes necessary maintenance services. The contract period for the maintenance services covers a total of 24 years. There is also the option for procuring a further 37 trains on the same terms, as agreed in the main contract, if the current demand forecast for train capacity is insufficient. The interviewee was the head of the project who was also the head of the BC.
In addition to the technical requirements, high economic demands were placed on the train project. The BC therefore had to take these requirements into account from the outset, as it was not considered possible to provide additional budgets. In addition, the consideration of LCC has been driven by the fact that the maintenance costs of the procured vehicles increased enormously after a moderate phase at the beginning of usage phase. During the first 2 years of use, guarantees with suppliers were firmly anchored within the procurement contracts and maintenance costs were intensively monitored. The effort and costs required for maintenance services were relatively low during this phase. However, these costs increased massively when the warranty commitments expired. The consideration of LCC estimations was therefore a goal for the BC from the beginning.
“One of the main objectives was to reduce vehicle maintenance costs and increase fleet reliability throughout the life cycle.”
From an information capabilities point of view, the BC used LCC as the central tool for estimating the fleet costs in the utilization phase. Besides the technical requirements for the fleet, it was a requirement of the procurement authority that the necessary maintenance measures should take place in the company’s own workshops and by its own personnel, but under the supervision of the manufacturer. Therefore, LCC estimation was performed in two steps. While the manufacturers had to calculate LCC for their trains, the LCC estimation for the personnel and infrastructure components were provided by the procurement authority. For this purpose, experience values from past projects were used for the most part.
This means that the profitability analysis was no longer limited to the actual procurement project, but was also extended to overarching areas. The fact that the maintenance services were carried out by the company’s own personnel was mainly due to the fact that the employees are employed by the city and cannot be released. Therefore, the different information needs of the BC members could be met. While the city was interested in integrating the existing staff in addition to the economic procurement of the trains, the procurement project was primarily interested in an ES operation of the fleet.
The information fit was assessed by the presentation of the LCC estimations on different levels. The LCC had a strong focus on costs for maintenance personal and infrastructure at the political level and LCC estimations for procuring new trains and the costs in the operating phase were prioritized at the project level.
The following aspects summarize ES LCC information processing in the BC of the case:
- -
Procurement of new trains and maintenance contract for 24 years at the same time;
- -
Consideration of own maintenance infrastructure and personnel in LCC estimation;
- -
The focus of the LCC estimation is on the control of maintenance and repair measures, as these have been identified as the main cost drivers.
4.4. Infrastructure Cases
In order to be able to guarantee the provision of services to citizens, there is a need for suitable infrastructure. This infrastructure, such as office buildings and city halls, but also schools or kindergartens, must be procured and operated by the public-sector clients. The same applies to road and rail infrastructure. Here, the public buyer is responsible for construction and maintenance as well. When looking at road infrastructure, as well as building infrastructure, it becomes clear that both types of infrastructure have commonalities. The procurement of infrastructure is associated with high procurement costs, the life cycles have a length of 50 years or more, and the costs for operation and maintenance are high. Therefore, public authorities are looking for tools and concepts that support long-term sustainable decision making. It can be stated that methods such as LCC estimations are used more frequently to improve the overall economic viability of different alternative solutions. Furthermore, the public sector is often faced with scarce funding. As demands for new buildings and road infrastructures increase, backlogs are emerging that necessitates better funding management. All this relates to the ES LCC topic.
Case 7 Buildings: The case is about the procurement of new building infrastructure for public organizations. This case does not consider a specific procurement object, but shows how LCC estimations can be considered in the evaluation of infrastructure procurement projects. The interview was held with the head of a task force who advise local and municipal public clients on the procurement of building infrastructure. In this role, the interviewee is regularly member of a BC as head of commercial management.
According to the interviewee, strict budgetary constraints regularly present a starting point for procurement authorities. It is therefore important to keep the costs associated with procurement and operation low and predictable. For an economic evaluation of the procurement decision, LCC is therefore regularly used as an evaluation criterion for the infrastructure sector. The information requirements refer on the one hand to the procurement costs and the questions of when and in what amount the budget is available.
In the majority of cases to which the interviewee responded, an existing property is available but requires extensive modernization. Then, the question is whether the existing building should be completely modernized or replaced by a new building. In addition, information is requested if a combination of several building projects into one project is possible and beneficial (community center). At the same time, solutions for operating the infrastructure should be included the decision-making process. This can either be performed by the public sector client itself or outsourced to an external supplier. Actors are tasked with processing all of the cost information of the different alternatives.
The information requirements are defined by the BC before the tendering process begins. Requirements include, for example, the planned type of use, an assumed utilization profile for the property, or information about the planned lifecycle. All requirements are then published in the call for tenders. The bidders are required to submit their bids including the required LCC estimations. Since the LCC is defined as an award criterion, an evaluation of the costs is based on the LCC.
The information fit is regularly fulfilled with the evaluation of the offers, when all LCC information and the corresponding solution proposals are available. Thus, a cost evaluation can be performed. Main cost drivers are identified and evaluated by the BC members.
“The use of LCC has led to an increase in economic efficiency, as aspects such as energy consumption are now included in the overall evaluation, which accounts for a high proportion of the total costs.”
The following aspects summarize ES LCC information processing in the BC of the case:
- -
Defined LCC as an award criterion for alternative solutions;
- -
Development of a utilization profile as a common basis for bid evaluation (legal certainty);
- -
Utilization cycles between 15 and 30 years.
Case 8 Highway: This case is about the procurement of new, and the sustainment of existing, highways in Germany. This case does not consider a specific procurement case, but shows how LCC estimations are considered in the evaluation of highway infrastructure procurement and sustainment projects. The interview was held with the head of commercial management. In this role, the interviewee is regularly responsible for the commercial evaluation of procurement projects and, in addition to that, is a member of BCs. The structures of the BCs are typically quite heterogeneous, which has a direct impact on the information requirements of the members.
While the members of the political level are primarily interested in the availability of the road infrastructure, the members of the project level are primarily interested in the most economically advantageous realization of the infrastructure projects. Using ES LCC seems to be an appropriate solution to meet both goals.
“LCC and LCCM are evaluated as target-oriented concepts for the procurement of complex capital goods (in particular transport infrastructure and goods for building construction).”
ES LCC is suited to inform the political level, because the development and evaluation of solutions for the achievement of the availability requirements takes place with the help of monetary considerations. Thus, for example, it can be justified that an initially more expensive procurement solution can be economically more meaningful if fewer maintenance measures are necessary in the utilization phase. This can be the case, for example, if high-quality road pavement is used that requires less maintenance. This has a direct impact on maintenance costs and the availability values of the road. The provision of information to the political level is of particular importance, because here the budget approval for the procurement projects takes place.
In order to be able to carry out this type of information processing, a wide range of expertise in conducting host liability investigations has been built up within the organization. With the help of these studies, different implementation solutions can be compared with each other without consulting external support. Usually, no additional ES LCC information capability will be required by the BC. All information requests will be satisfied by internal resources.
LCC is defined as an award criterion, so that bids are evaluated and awarded on the basis of LCC knowledge and the bidders are requested to specify the LCC of their proposed solutions. Considering empirical data from past projects, and based on the results of the economic feasibility study, the bid evaluation is then carried out. During this step in the process, the information fit is assessed. The political level is typically informed on an aggregated level. The information of the project team is very detailed. The interviewee states that it may not be possible to cover all information needs. One cause is that past data is not available because there is no electronic database for storing and evaluating this project and cost data.
“However, numerous opportunities for a successful application of LCC are seen, e.g., extensive historical data, innovative contract concepts, suitable competitive structures, qualification of decision makers, and the development and maintenance of a usage database, as well as a suitable legal and cultural framework, but capabilities are not always given.”
The interview assessed, that using the ES LCC approach significantly helped to inform different stakeholders in the process, as well as the members of the BC, in order to reach the procurement goals. The following aspects summarize ES LCC information processing in the BC of the case:
- -
Extensive know-how for the execution of economic efficiency studies available in-house;
- -
ES LCC information as a basis for informing Parliament to achieve budget releases;
- -
Use of historical ES LCC data for project/tender evaluation;
- -
Instrument for the selection decision of the most economical solution.
4.5. Cross-Case Analysis
In fact, the observed eight cases are very specific with regard to their procurement object and their wider effects on the public sector and society. From an ES LCC perspective, they are quite close to each other, because they are projects about costly and complex investment goods with long life cycles. Therefore, procurement objects are, at a first glance, heterogenous, but homogenous in their cost, time, and complexity characteristics. Therefore, we are able to execute a comparison analysis along the key constructs of OIPT (see
Table 1).
Generally, we can observe throughout all the cases that ES LCC information processing is also quite homogenous, or at least more homogenous, as one might expect. The granularity of the information requirements usually go deeper than the system to subsystem or main cost driver level. Required information aims to lever transparency and to enable the identification of critical cost drivers. Furthermore, BCs typically lack, or have limited, ES LCC capability, but are supported by centralized and more specialized LCC departments or receive external (consultancy) support. Tooling in terms of software is available on the market in a wide variety of products. Finally, BCs perceive their ES LCC information as sufficient, but lack experience from other or previous projects to really evaluate their own work (lack of benchmark). ES LCC is sufficient to support the comparison of alternatives (in development phases), to evaluate suppliers by tender/award criteria, to plan and budget strategic assets, and finally to contract suppliers with LCC cost lines. Generally, the cases all show that they use ES information for their procurement decision making.
5. Discussion and Implications
This research analyzes how sustainability could be assessed with the means of a cost-benefit analysis and focuses on LCC as an instrument and the economic dimension of sustainability. The work merges theory from OIPT with OBB in order to better understand how the information processing of an ES LCC can result in better procurement decisions. A remarkable point is that ES LCC information is usually based on estimations, which makes the data biased by forecasting errors. For the procurement decision, this means that an offer must be chosen under ES LCC uncertainty (see decision theory, e.g., reference [
83]). Therefore, it is important to know how members of the BC assess and process ES LCC information [
84]. Within the BC, more or less informed participants might influence the decision, as well as BC participants who have varying levels of understanding of ES LCC information [
85].
This study is able to show that managerial practice in the cases considers ES LCC as a relevant information requirement. Furthermore, the LCC bears the potential to become a kind of standard to assess ES, because the LCC information requirements in almost every case were quite similar. The information requirements do not stop at LCC for the overall system, but usually go deeper into subsystem levels. The reasons for carrying out LCC estimations are also comparable in all cases: they mainly serve to create cost transparency in the investigated projects [
35,
86]. Besides this, each project contributes to experience building and long-term learning. Finally, LCC information is required in order to support the evaluation of offers. By doing so, LCC information guides the contracting authority to choose the most economically advantageous offer; here that means the most ES solution [
42].
It is also interesting to observe which ES LCC information processing capabilities exist in the BC [
87]. These capabilities vary greatly. In some cases, the projects are obliged by the regulations of the procurement authority to record LCC. Thus, LCC is executed by specific departments while the BC of the project has no capability of its own. In other cases, know-how is available within the BC. For example, the German Defense Procurement Authority has its own CCC that supports the LCC estimation. However, such a central department is not equipped for the permanent support of a multitude of projects. This is why we observe a stepwise approach: First, we see BCs with their own ES LCC capabilities. Then, there are BCs that are supported by in-house, specialized LCC-capable departments. Third, there is often external (consultancy) support if capabilities are not sufficient [
12]. However, we could observe that all cases had a structured process for conducting LCC estimations, even if the processes differed according to the project under consideration. In all cases, capabilities for considering ES LCC were in place (internal or external). Even if these were in some cases bottlenecks and required external support, the BC was able to obtain and process ES LCC information.
Lastly, we refer to the information processing fit assessment. Here, we observe that ES LCC information is supporting procurement as tender/award criteria, for comparison of alternatives, for budget planning, and strategic asset management, as well as for contractual fixation and incentive systems [
42,
88]. As such, we can positively interpret this aspect as a good balance between information requirement and information capability, because ES LCC information is appropriately processed. However, there are cases in which BC participants claim that a better validation of ES LCC estimations would be helpful. The capability to access other and previous project data is mentioned in this context [
89]. For example, in the case of Highway AG, information from past projects is available, which is used for an evaluation (analogy method). However, the use of this data is not easily possible because there is no standardized solution for storing and processing the data. In the defense sector, the number of available reference projects is limited. A practical recommendation coming from Case 2 is to build up a database as a tool for collecting, evaluating, and assessing ES LCC information. These findings are consistent with, among others, the studies of Korpi and Ala-Risku (2008) [
35].
For the initial RQ, we are able to state that for assessing ES, the tool of LCC is appropriate and, due to its implementation in practice, already a mature instrument. Referring to RQ1, we observe that BCs not only require an ES LCC analysis on a system level, but also on a subsystem or cost driver level. As such, the key information requirement is a fine-grained ES LCC information structure. Referring to RQ2, the cases indicate that there is a stepwise information demand. We could identify that BC members with high decision power (e.g., decider, Parliament, and strategic management) required, or received, aggregated ES LCC information in order to manage procurement decisions at a higher and aggregated level. Other members of the BC (influencer, buyer) aim to have utmost transparency, at least to subsystem level, in order to consider all technical and cost requirements. These findings can also be supported by additional sources besides the cases. In the defense sector, for example, it was possible to evaluate additional documents containing ES LCC information for top management and the political level. This information is highly condensed in the evaluated documents and only partially reproduced. The comprehensive creation of cost transparency at the level of the main cost elements is thus not achieved. This makes an evaluation at the strategic level more difficult and supports decision making in procurement only to a limited extent.
We were not able to fully assess how gatekeepers (e.g., specialized LCC departments or external LCC consultancies) use their ability to share or not to share ES LCC information and how this is influencing the BC. Uncertainty about forecast bias might cause reluctancy to share information, while on the other hand, BC participants called for permanent ES LCC information. Therefore, we observe indications for potential misalignments or information asymmetries within a BC if information processing is not governed correctly. Finally, we refer to RQ3 and can state that ES LCC is not a “white elephant”, but had impact on procurement as tender/award criteria, for the comparison of alternatives, for budget planning, and strategic asset management, as well as for contractual fixation and incentive systems. This is a positive signal, because then ES is considered in the procurement decision. As a practical implication, this would call for building up ES LCC capabilities, at least when procuring high-value investment goods with long life cycles. Propositions and recommendations for action in relation to IPT and OBB/BC can be derived from previously discussed findings (see
Table 2).
Finally, we want to state that politics and society call for the achievement of a higher level of sustainability. The cases show that LCC is an instrument that operationalizes this high-level goal into specific cost figures and fine-grained CBS. This helps to consider not only social or ecological sustainability goals but also addresses hitherto insufficiently regarded economic sustainability goals. The use of LCC as award criteria is clearly stipulated by procurement legislation. In addition, public contracting authorities can create the managerial conditions to be able to apply ES LCC as a strategic management tool. To this end, they must, for example, build up the skills and capabilities of purchasers so that they are able to use ES LCC as an evaluation and decision-making tool.
Furthermore, prerequisites must be created for market participants so that they can perform a calculation of LCC. To this end, for example, the calculation methods and evaluation criteria must be made known to potential bidders by the contracting authorities.
In the cases, different possibilities for creating the framework conditions have been presented.
