Article

A Dynamic Scheduling Model for Underground Metal Mines under Equipment Failure Conditions

School of Resources and Safety Engineering, Central South University, Changsha 410083, China
*
Author to whom correspondence should be addressed.
Sustainability 2023, 15(9), 7306; https://doi.org/10.3390/su15097306
Submission received: 13 March 2023 / Revised: 18 April 2023 / Accepted: 27 April 2023 / Published: 27 April 2023
(This article belongs to the Special Issue Advances in Intelligent and Sustainable Mining)

Abstract

:
Equipment failure is a common problem in mining operations, resulting in significant delays and reductions in production efficiency. To address this problem, this paper proposes a dynamic scheduling model for underground metal mines under equipment failure conditions. The model aims to minimize the impact of equipment failures on production operations while avoiding extensive equipment changes. A case study of the southeastern mining area of the Chambishi Copper Mine is presented to demonstrate the effectiveness of the proposed model. The initial plan was generated using the multi-equipment task assignment model for the horizontal stripe pre-cut mining method. After equipment breakdown, the proposed model was used to reschedule the initial plan. Then, a comparative analysis was carried out. The results show that the proposed model effectively reduces the impact of equipment failures on production operations and improves overall mining execution at a low management cost. In general, the proposed model can assist schedulers in allocating equipment, coping with the disturbing effects of equipment failure, and improving mine production efficiency.

1. Introduction

Underground mine scheduling is complex and challenging, and it involves coordinating different equipment and tasks to achieve optimal production outcomes [1]. To maximize production, mine operators must develop a scheduling plan that minimizes operation time and increases the utilization of available equipment. The scheduling of underground mining activities is influenced by a range of factors, including the availability of equipment, geological conditions, and safety considerations. The efficient scheduling of mining requires the use of advanced optimization techniques to develop optimal schedules that minimize operational costs while maximizing productivity [2,3].
The scheduling optimization of intelligent mining equipment in underground metal mines is a flexible production problem that involves generating different scheduling plans by integrating various combinations of multiple stopes, processes, and equipment under complex temporal and spatial constraints. The solution to this problem requires an intelligent optimization algorithm to identify the optimal initial scheduling plan [4,5,6]. Research on intelligent mining equipment scheduling optimization in underground metal mines is critical to achieving high-efficiency, real-time operation, reliability, stability, and flexibility in mine production scheduling. This problem exhibits several characteristics, such as complexity, dispersion, parallelism, multiple constraints, multiple resources, and multi-target coordination, making it a strong NP-hard (nondeterministic polynomial) problem [7,8].
In the actual production processes of the mine, the production environment is challenging, and the working procedures are complex and discrete. The working equipment is difficult to coordinate, and the workplaces are scattered, which often results in a long production cycle. Furthermore, dynamic events such as equipment failures, rock collapses, and ore pass blockages occur frequently [9,10,11,12]. Due to the highly dynamic and complex production environment, the actual production process tends to deviate from the initial scheduling plan gradually, reducing the feasibility of the initial scheduling plan. Therefore, it is crucial to adjust the initial scheduling plan to prevent production interruptions or delays and to quickly respond to dynamic events to minimize their impacts [13].
The dynamic scheduling of underground mining equipment aims to reduce the deviation from actual progress by adjusting the initial scheduling plan, ensuring scheduling stability, responding promptly to dynamic events, and optimizing equipment operation. Consequently, research on the dynamic scheduling of underground mining equipment under dynamic events has become a hot topic in production scheduling research field.
Several researchers have made significant contributions to the field of the dynamic scheduling of underground mining equipment. Song et al. [14] developed a decision support tool for underground mining equipment that assists miners in quickly reassigning equipment to cope with dynamic events such as roadway blockages and equipment failures. Hou et al. [15] built a dynamic scheduling optimization model for underground mining equipment that considers the uncertain operation time of mining equipment, which facilitates the rapid readjustment of scheduling plans. Hammami et al. [16] studied the dynamic scheduling of mining equipment in underground mines, considering dynamic events such as equipment failure, production interruption, and equipment movement. Åstrand et al. [17] proposed an underground mining equipment scheduling model based on constraint programming, considering dynamic events such as production interruptions and delays. They also considered equipment movement time and proposed a simple neighborhood search strategy with a fixed neighborhood size based on constraint programming to study the scheduling problem of mining equipment in underground mines [18]. In addition, they also put forward a large neighborhood search strategy, based on constraint programming, that dynamically adjusts the size of the neighborhood to study the scheduling problem of mining equipment in underground mines, enabling the quick adjustment of the scheduling plan [19]. Feng et al. [20] proposed a rescheduling optimization model of underground mine transportation equipment, considering equipment failure and adopting the wolf colony algorithm to optimize the solution.
In summary, few research studies have been conducted on the dynamic scheduling problem of mining equipment in underground mines. Most studies have focused on how to generate new rescheduling plans after various dynamic events occur, but they lack a specific analysis of dynamic events. Each type of dynamic event has its own dynamic characteristics, such as the duration, severity and frequency. The dynamic scheduling characteristics determine the dynamic scheduling mechanism and method, and they generate different scheduling plans. In addition, previous studies have seldom considered deviations between rescheduling plans and initial scheduling plans in combination with equipment changes, and they have not been able to effectively evaluate the stability, real-time adaptiveness, and robustness of dynamic scheduling.
At present, workshop dynamic scheduling has matured. Li et al. [21] considered five types of workshop dynamic events, studying the dynamic scheduling problem of flow shops, with the minimization of the maximum completion time and instability as the optimization goals, using the DTLBO algorithm to optimize the solution, which greatly improves the robustness, stability, and real-time performance of scheduling. Peng et al. [22] considered three kinds of dynamic events simultaneously, studying the dynamic scheduling problem of hybrid flow shops and using the MSVND algorithm to optimize the solution with the goals of minimizing the maximum completion time and system instability. Ma et al. [23] proposed a dynamic scheduling optimization method for multiple production-line workshops. The optimization goal was to minimize the deviation between the rescheduling plan and the initial scheduling plan, and the genetic algorithm was used as the solution generator. The results show that the method effectively solves the dynamic scheduling problem of multiple production-line workshops.
For underground mining, we must urgently analyze the characteristics of dynamic events, study the dynamic scheduling mechanism and dynamic scheduling method, consider the deviation between the rescheduling plan and the initial scheduling plan, consider the change cost of mining equipment, and improve the stability, real-time robustness, and adaptability of dynamic scheduling.
In the present research study, the dynamic characteristics of dynamic events (mining equipment failures) were considered. The direct application of the available methods to underground mines has certain limitations [24]. However, through the analysis of the dynamic scheduling driving mechanism and method, we found it possible to solve this problem via the reconfiguration of dynamic scheduling mechanisms and methods. Therefore, we constructed a dynamic scheduling model to verify the dynamic scheduling process. Consequently, we reconstructed a dynamic scheduling process for underground mining, and then we constructed a dynamic scheduling model to verify it. The optimization objective of the model considers the deviation between the rescheduled plan and the initial plan, as well as the frequency of equipment changes. The optimization results are objective, avoiding the subjective errors of traditional manual decision making. The original contribution of this paper is to propose a dynamic scheduling process and to construct a rescheduling optimization model for underground mines under equipment failure conditions, and the optimization results can provide decision support for schedulers, which provides a new perspective on mine scheduling in intelligent mines.

2. Dynamic Scheduling Process

2.1. Dynamic Scheduling Characteristics

The operating environment of underground mining equipment is dynamic, featuring discrete operating locations, complex and harsh environments, and various operating processes. Equipment failures can disrupt production and cause delays. Dynamic scheduling characteristics mainly involve the type of the equipment failure, the failure frequency, a severity assessment, the reasons for failure, the repair location, and the repair time.
The type of equipment failure can be classified as either an internal reason or an external reason. Internal reasons for failures mainly include damage caused by fatigue due to long operation times. External reasons for failures mainly include abnormal damage caused by harsh operating environments. A detailed analysis of reasons for failure is shown in Table 1.
Equipment failures can be divided into low-frequency, medium-frequency, and high-frequency failures, based the frequency of occurrence. When the frequency of equipment failure is in (A, B), we call it a low-frequency failure. When the frequency is in (B, C), we call it an intermediate-frequency failure. Otherwise, we call it a high-frequency failure. Here, the values of A, B, and C need to be determined according to the experience portrayed in the actual mining data.
In terms of severity, equipment failures can be classified as Class I, Class II, Class III, or Class IV. If the equipment failure causes a particularly significant delay and a particularly significant economic loss, it is considered a Class I failure. If the equipment failure causes a major delay and a major economic loss, it is considered a Class II failure. If the equipment failure, causes a large delay and a large economic loss, it is considered a Class III failure. If the equipment failure causes a small delay and a small economic loss, it is considered a Class IV failure.
The severity of the failure can affect the equipment repair time. When a Class III or IV failure occurs, the repair time is usually short. However, when a Class I or II failure occurs, the repair time is usually long, and this can cause significant production delays. Based on repair time, equipment failure can be categorized as either short-term or long-term failure. The maintenance location for the equipment is influenced by the above factors, and it can be classified as on-site maintenance or off-site maintenance. The various types of failures have been classified based on the five dimensions, and we analyzed the coupling relationships between them, as shown in Figure 1. The higher the severity of the failure, the lower the frequency of the failure, and the longer the repair time. Therefore, the repair time is negatively correlated with the failure frequency, and it is positively correlated with the failure severity. It is necessary to send equipment with long repair times to the maintenance point for long-term maintenance. For equipment with short repair times, short-term, on-site maintenance can be carried out directly.

2.2. Dynamic Scheduling Mechanisms

The dynamic scheduling mechanisms are primarily aimed at determining when to initiate adjustments to the initial scheduling plan. These mechanisms are categorized into three types: event-driven, interval-driven, and hybrid-driven mechanisms [25,26].
For low-frequency, long-term, complex failures, an event-driven mechanism is employed. These failures have a significant impact on the production schedule, and the immediate readjustment of the initial scheduling plan is required. To avoid production interruptions or major delays, the operating site uses other available equipment, as shown in Figure 2. The event-driven mechanism can respond to equipment failure events in real-time, and it has high real-time performance, but it has poor stability.
For high-frequency, short-term, simple failures, a cycled, interval-driven mechanism is employed. These types of failures occur more frequently, but they usually have less of an impact. Frequent rescheduling would not be conducive to effective management. Therefore, the scheduling plan is readjusted at regular intervals, as shown in Figure 3. The cycled, interval-driven mechanism cannot respond to equipment failure events in real-time, but it has high stability.
For medium-frequency, short-term failures, a hybrid-driven mechanism is employed. This mechanism integrates event-driven and interval-driven mechanisms. The initial scheduling plan is first adjusted at intervals using the interval-driven mechanism. If a failure with serious consequences occurs during the interval, the event-driven mechanism is immediately applied, as shown in Figure 4. The hybrid-driven mechanism not only retains the real-time performance of the event-driven mechanism, but it also ensures the stability of the cycled, interval-driven mechanism.

2.3. Dynamic Scheduling Methods

Dynamic scheduling methods play a critical role in adjusting initial scheduling plans, with complete adjustment, partial adjustment, and backward adjustment being the primary approaches [27]. Figure 5 depicts an initial scheduling plan that includes the stope process, equipment type, specific individuals, and process intervals.
The complete adjustment method involves re-adjusting all unexecuted tasks at all locations when equipment failure occurs. It identifies the interrupted tasks due to the equipment failure and unstarted tasks, optimally adjusts the equipment involved, and forms a rescheduling plan. This method is effective in reducing the impacts of interruptions or significant delays and in quickly responding to equipment failures, but it requires extensive schedule adjustments and multiple changes. As shown in Figure 6, a scaling rig broke down at a certain time in Stope 3, and the dotted line indicates the initial scheduling plan, which was adjusted to fit the task deadlines.
In contrast, the partial adjustment method only re-adjusts unexecuted tasks at limited locations. By identifying the interrupted tasks due to equipment failure and all other unstarted tasks, it delineates the minimum number of stopes to be adjusted, and it makes optimal adjustments within that area to obtain the rescheduled plan, as shown in Figure 7. When the failure occurred, Block 3 and the adjacent Block 4 were adjusted, and the other locations remained unchanged. While this method requires fewer equipment changes than the fully adjusted method, it sacrifices some operating time.
The backward adjustment method defers equipment repair time for global tasks without changing the order of tasks or executors. The task execution equipment remains unchanged, and all processes that have not started are moved backward without changing the equipment arrangement, as shown in Figure 8. All tasks in each stope are delayed for a certain amount of time to maintain the initial order when equipment failure occurs. However, since blasting in mines usually occurs at a fixed time, the backward adjustment method requires a delay in the blast and ventilation process, and it is not applicable to mine scheduling.

2.4. Process Reconfiguration

The advantages and disadvantages of dynamic scheduling mechanisms and methods are summarized in Table 2 and Table 3. The hybrid-driven mechanism has been found to have high real-time performance and scheduling stability. The comprehensive, complete adjustment method and the partial adjustment method have been shown to maintain equipment stability while ensuring the robustness, flexibility, and time stability of scheduling. However, the backward adjustment method is not applicable to mine scheduling as it requires a delay in the blasting and ventilation process, which occurs at a fixed time.
Mine scheduling is a shift-cycle process, which requires the cycled, interval-driven mechanism. However, major events can disrupt the initial plan, and the scheduling department must respond in a timely manner; thus, only the event-driven mechanism can satisfy this condition. The appropriate mechanism for mine scheduling was determined to be a hybrid-driven mechanism.
Mine scheduling adjustments are complex, and making limited adjustments of a partial scope will not likely achieve the desired results. However, since the adjustment of large equipment is costly, we also do not want to make too many equipment changes, which is a contradiction. In addition, blasting and ventilation in mines need to be time-fixed, so backward adjustment cannot be used. For this reason, it is necessary to construct a new method for minimizing equipment changes while maximizing scheduling, which we call the hybrid adjustment method for underground mines.
Figure 9 illustrates that, when the initial scheduling plan is established, its dynamic scheduling characteristics are evaluated, and the appropriate dynamic scheduling mechanism is selected. The dynamic scheduling method is then applied to adjust the plan, and the algorithm is utilized to optimize the solution and create an optimal rescheduling plan.
To meet multiple requirements at the same time and to improve the stability, real-time robustness, and agility of scheduling, it is necessary to reconfigure the existing rescheduling mechanisms and methods in combination with the mine characteristics. This process is based on the hybrid-driven scheduling mechanism, partial adjustment method, and complete adjustment method, and it aims to reduce the deviation of the new scheduling plan from the initial one and to reduce the number of equipment changes. In summary, we propose a dynamic scheduling process based on the characteristics, mechanisms, and methods of dynamic scheduling.

3. Dynamic Scheduling Modeling

3.1. Description of the Problem

The dynamic scheduling problem for intelligent mining equipment in underground metal mines is an extension of the flexible production scheduling problem. Underground metal mines are categorized into areas, strips, and blocks based on spatial fineness and mine design, with the block being the smallest operational recovery unit. Each block requires multiple processes, and each process can require multiple mining equipment types with specific quantities and work efficiencies. The processes and corresponding equipment of multiple blocks are arranged in a rational manner to form the initial plan. However, equipment failures can occur, requiring the dynamic scheduling mechanism to activate, rescheduling the process and the corresponding equipment to reduce negative impacts and avoid serious lags, large production fluctuations, and efficiency reductions.
Based on the idea of a dynamic scheduling process as described in Section 2.4, we constructed the corresponding dynamic scheduling model. Due to the problem’s complexity, the following assumptions were made to simplify the model and reduce computation:
(1) The available equipment was limited, and no backup was set. When a single piece of equipment failed, other available equipment was selected for the current task.
(2) Equipment reverted to the repair state immediately after a failure and could not function during the process, but it could be reselected after repair.
(3) Only one piece of equipment failed at a given moment. The rescheduling interval began at the failure moment, and the repair time was known.
(4) After equipment failure, ongoing tasks were interrupted. The completed part was excluded from optimization as a given fact, and the unfinished part was considered a new task.

3.2. Mathematical Model

3.2.1. Symbol Definition

The indices and set definitions are shown in Table 4.
The decision variables are defined as shown in Table 5.

3.2.2. Objective Function

The objective function aims to:
(1) Minimize the deviation between the ending time of the rescheduled plan and the ending time of the initial plan.
m i n ( i = 1 I k = 1 K n = 1 N m = 1 6 T E i k n m u T E i k n m h )
(2) Minimize the frequency of equipment changes.
min i = 1 I k = 1 K n = 1 N m = 1 6 M l i k n m , m 3

3.2.3. Equivalence Relations

The rescheduled plan uses replacement equipment when the process starting time is related to the failure starting time, the process ending time of the replacement equipment in another block operation, and the movement time between blocks.
T S i k n m u = T F i k n m h + T E i f x m u + T M i k n u i f x u
The process ending time for the rescheduled plan is related to the process starting time, equipment movement time, and blast and ventilation time.
T E i k n m u = T S i k n m u + T W i k n m u

3.2.4. Constraints

Constraint 1: The rescheduled plan should strictly follow the blasting and ventilation constraint. Operations in violation of regulations cannot be allowed, even if progress needs to be made up. When blasting and ventilation occurs, all processes must be suspended, and the operation must be started after the blasting and ventilation are complete.
T E i k n m u T S i k n m u + B l s i k n m × T v e n , i k n + T W i k n m u , m 3
Constraint 2: The rescheduled plan should follow the process sequence of the initial plan. That is, the starting time of the next process should lag behind the ending time of the previous process.
T S i k n m + 1 T E i k n m
Constraint 3: The rescheduled plan should follow the mining sequence of the initial plan. That is, the starting time of the next ore block should lag behind the ending time of the previous ore block.
T S i k n + 1 T E i k n

3.3. Model Solving

In this study, we used a genetic algorithm to solve the dynamic scheduling problem of intelligent mining equipment for underground metal mines. The main process is shown in Figure 10.
(1) Encoding and Decoding
For chromosome encoding, we adopted a two-layer coding method [28]. The first layer, Part A, includes block mining information, while the second layer, Part B, includes available equipment information. The scheduling plan consists of both Part A and Part B, as shown in Figure 11.
(2) Population initialization
After equipment failure, the state of the mining system changes, and mining parameters require re-initialization. This includes removing completed processes, blocks, and failed equipment. Multiple chromosomes are then randomly generated according to the coding rules to form the initial population.
(3) Genetic Evolution
Genetic evolution includes selection, crossover, and mutation.
Selection generates the next generation of populations by calculating the objective value based on the chromosome and generating the fitness value. Then, better individuals are selected based on their fitness value to generate the offspring population. Nondominated sorting helps to select individuals closer to the optimal value of the target in the case of multiple objectives, but it will reduce the diversity of the population and fall into the local optimal solution. Adding the Monte Carlo method is an effective way to mitigate this shortcoming. In this study, we used nondominated sorting and the Monte Carlo method for selection.
Crossover recombines parental genes to create offspring with inherited traits. Uniform crossover can better search the solution space, maintain good information exchange, and make progeny generations more diverse. With long chromosomes, such as those here, uniform crossover can ensure the adequacy of evolution. In this study, we used the uniform crossover method to create a large variety of individuals.
Mutation introduces population diversity through genetic mutations to avoid entrapment in local optimal solutions. Because the total number of processes was fixed, insertion mutation was not applicable here. Therefore, we used swap mutation to swap gene positions in the block priority coding and to change the block priorities, or to swap gene positions in the equipment selection coding and change the equipment selection, so as to improve the sample diversity.
(4) Termination Criterion
We determined whether the set maximum number of iterations was reached. If not, we continued the selection, crossover, and mutation operations until it was reached.
(5) Output Results
Finally, we decoded the optimal chromosome individuals into a rescheduling plan.

4. Case Study

This paper presents a case study of the southeastern mining area of the Chambishi Copper Mine. The multi-equipment task assignment model and GA algorithm [29,30,31,32] were used to generate an initial plan, which was then rescheduled based on the proposed model to analyze the interference and countermeasures of equipment failure.

4.1. Initial Plan and Basic Data

The zone consisted of eight stopes, and the initial plan, shown in Figure 12, was part of the optimal plan created by a multi-equipment task assignment model for the horizontal stripe pre-cut mining method [24].
The main technical parameters of the mining equipment, including the horizontal hole drilling rig, medium–deep hole drilling rig, charging rig, scaling rig, LHD, and bolter, are listed in Table 6.

4.2. The Rescheduled Plan

The initial plan was invalidated due to equipment failure and had to be rescheduled. Specifically, a horizontal hole drilling rig in a stope broke down at 5:00, and the repair time was 12.25 h. The algorithm parameters used were as follows: population size: 800; number of iterations: 400; crossover probability: 0.2; and variance probability: 0.1. The simulation was run on an Intel(R) Core(TM) i7-8550U CPU, 16 GB RAM, Python 3.7 @ Anaconda 3. After the iteration of the genetic algorithm, the optimal solution was obtained with 79 h and 11 equipment changes as objectives, as shown in Figure 13. The rescheduled Gantt chart is shown in Figure 14, and a comparison between the initial and rescheduled plans is presented in Figure 15. Delays occurred at five stopes in the rescheduled plan, with delays generally ranging from 10 to 20 h.

4.3. Discussion

To analyze the effectiveness of the proposed algorithm, a comparative analysis was carried out. The control group included the execution results of the initial plan under equipment failure. Specifically, after the equipment failure, it was still executed according to the initial equipment allocation and stope priority, and the execution result of the initial plan was obtained. The comparison with the initial plan, the execution result of the initial plan, and the execution result of the rescheduled plan are shown in Table 7.
The comparison results show that the dynamic scheduling model proposed in this paper accomplished an improvement in overall mining execution at the cost of making 11 equipment changes. The execution result of the initial plan was significantly worse than the rescheduled plan. The rescheduled plan is less different from the initial plan, which avoided problems such as lags and production interruptions caused by equipment failures.
The proposed dynamic scheduling model effectively reduced the impact of equipment failure on production operations, while avoiding the disadvantages of traditional complete rescheduling with extensive equipment changes. This enabled the realization of rescheduling with low management costs by reducing the frequency of equipment adjustments. The model can reduce the adverse effects of equipment failure; ensure the stability, robustness, and agility of scheduling; effectively assist schedulers to allocate equipment; cope with the disturbing effects of equipment failure; and improve mine production efficiency.

5. Conclusions

In conclusion, this paper proposed a dynamic scheduling model to analyze the interference of equipment failure in the southeastern mining area of the Chambishi Copper Mine. The proposed model effectively reduced the impact of equipment failure on production operations while avoiding the disadvantages of traditional complete rescheduling with extensive equipment changes. The results showed that the rescheduling plan accomplished an improvement in overall mining execution at the cost of making 11 equipment changes, while the execution result of the initial plan was significantly worse than the rescheduled plan. The proposed model can reduce the adverse effects of equipment failures; ensure the stability, robustness, and agility of scheduling; and effectively assist schedulers to allocate equipment, cope with the disturbing effects of equipment failure, and improve mine production efficiency. Overall, this study provides valuable insights for mine scheduling and equipment management. After equipment failure, the initial scheduling plan is quickly adjusted, and the generated rescheduling plan is fed back to the scheduling center to assist decision makers in scheduling and reducing the interfering effect of equipment failure on production operations. This study provides a new perspective on mine production scheduling, and it can be applied to other similar mining operations.
However, we have only completed the preliminary algorithm design and simulation verification, and there is still a certain distance to implementation. It is necessary to develop a scheduling management platform to assist personnel in decision making and efficiently managing equipment. Future research will focus on the dynamic scheduling problem in the case of the simultaneous occurrence of multiple dynamic events and improve the adaptability of the model to cope with real mining environments. In addition, future research should focus on equipment operation and maintenance management, combine equipment operation and maintenance data, carry out pre-scheduling research on mining equipment, set up fault redundancy space in advance, and reduce the impact of fault interference at the source.

Author Contributions

S.T. participated in data analysis and in the design of the study, drafted the manuscript, and carried out the statistical analyses; S.F. and S.H. collected field data; L.W. and M.J. conceived of the study, designed the study, coordinated the study, and helped draft the manuscript. All authors have read and agreed to the published version of the manuscript.

Funding

This work was supported by the National Key Research and Development Program of China (2022YFC2904105) and the Fundamental Research Funds for the Central Universities of Central South University (2021zzts0284).

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Data Availability Statement

Not applicable.

Acknowledgments

We thank the reviewers for their comments and suggestions for improving the quality of the paper.

Conflicts of Interest

The authors declare no conflict of interest.

References

  1. Chimunhu, P.; Topal, E.; Ajak, A.D.; Asad, W. A Review of Machine Learning Applications for Underground Mine Planning and Scheduling. Resour. Policy 2022, 77, 102693. [Google Scholar] [CrossRef]
  2. Liu, S.Q.; Kozan, E.; Masoud, M.; Li, D.; Luo, K. Multi-Stage Mine Production Timetabling with Optimising the Sizes of Mining Operations: An Application of Parallel-Machine Flow Shop Scheduling with Lot Streaming. Ann. Oper. Res. 2022. [Google Scholar] [CrossRef]
  3. Bao, Y.; Wang, Y.; Zhao, L.; Zhang, A. Optimization Production Scheduling of Underground Backfilling Mining Based on NSGA-II. Min. Metall. Explor. 2022, 39, 1521–1536. [Google Scholar] [CrossRef]
  4. Seifi, C.; Schulze, M.; Zimmermann, J. A Two-Stage Solution Approach for a Shift Scheduling Problem with a Simultaneous Assignment of Machines and Workers. In Mining Goes Digital; CRC Press: London, UK, 2019; pp. 377–385. [Google Scholar]
  5. Campeau, L.-P.; Gamache, M.; Martinelli, R. Integrated Optimisation of Short- and Medium-Term Planning in Underground Mines. Int. J. Min. Reclam. Environ. 2022, 36, 235–253. [Google Scholar] [CrossRef]
  6. Schulze, M.; Rieck, J.; Seifi, C.; Zimmermann, J. Machine Scheduling in Underground Mining: An Application in the Potash Industry. OR Spectr. 2016, 38, 365–403. [Google Scholar] [CrossRef]
  7. Wang, H.; Tenorio, V.; Li, G.; Hou, J.; Hu, N. Optimization of Trackless Equipment Scheduling in Underground Mines Using Genetic Algorithms. Min. Metall. Explor. 2020, 37, 1531–1544. [Google Scholar] [CrossRef]
  8. Lindh, E.; Olsson, K. Scheduling of an Underground Mine by Combining Logic-Based Benders Decomposition and a Constructive Heuristic; Department of Mathematics, Linköping University: Linköping, Sweden, 2021. [Google Scholar]
  9. Galvin, J. Critical Role of Risk Management in Ground Engineering and Opportunities for Improvement. Int. J. Min. Sci. Technol. 2017, 27, 725–731. [Google Scholar] [CrossRef]
  10. Gul, M.; Ak, M.F.; Guneri, A.F. Pythagorean Fuzzy VIKOR-Based Approach for Safety Risk Assessment in Mine Industry. J. Saf. Res. 2019, 69, 135–153. [Google Scholar] [CrossRef]
  11. Jakkula, B.; Mandela, G.R.; Murthy, C.S.N. Reliability Block Diagram (RBD) and Fault Tree Analysis (FTA) Approaches for Estimation of System Reliability and Availability—A Case Study. Int. J. Qual. Reliab. Manag. 2020, 38, 682–703. [Google Scholar] [CrossRef]
  12. Odeyar, P.; Apel, D.B.; Hall, R.; Zon, B.; Skrzypkowski, K. A Review of Reliability and Fault Analysis Methods for Heavy Equipment and Their Components Used in Mining. Energies 2022, 15, 6263. [Google Scholar] [CrossRef]
  13. Framinan, J.M.; Fernandez-Viagas, V.; Perez-Gonzalez, P. Using Real-Time Information to Reschedule Jobs in a Flowshop with Variable Processing Times. Comput. Ind. Eng. 2019, 129, 113–125. [Google Scholar] [CrossRef]
  14. Song, Z.; Schunnesson, H.; Rinne, M.; Sturgul, J. Intelligent Scheduling for Underground Mobile Mining Equipment. PLoS ONE 2015, 10, e0131003. [Google Scholar] [CrossRef] [PubMed]
  15. Hou, J.; Li, G.; Wang, H.; Hu, N. Genetic Algorithm to Simultaneously Optimise Stope Sequencing and Equipment Dispatching in Underground Short-Term Mine Planning under Time Uncertainty. Int. J. Min. Reclam. Environ. 2020, 34, 307–325. [Google Scholar] [CrossRef]
  16. Hammami, N.E.H.; Jaoua, A.; Layeb, S.B. Equipment Dispatching Problem for Underground Mine Under Stochastic Working Times. In Computational Logistics; Mes, M., Lalla-Ruiz, E., Voß, S., Eds.; Lecture Notes in Computer Science; Springer International Publishing: Cham, Switzerland, 2021; Volume 13004, pp. 429–441. [Google Scholar]
  17. Åstrand, M.; Johansson, M.; Zanarini, A. Fleet Scheduling in Underground Mines Using Constraint Programming. In Integration of Constraint Programming, Artificial Intelligence, and Operations Research; van Hoeve, W.-J., Ed.; Lecture Notes in Computer Science; Springer International Publishing: Cham, Switzerland, 2018; Volume 10848, pp. 605–613. [Google Scholar]
  18. Åstrand, M.; Johansson, M.; Zanarini, A. Underground Mine Scheduling of Mobile Machines Using Constraint Programming and Large Neighborhood Search. Comput. Oper. Res. 2020, 123, 105036. [Google Scholar] [CrossRef]
  19. Åstrand, M.; Johansson, M.; Feyzmahdavian, H.R. Short-Term Scheduling of Production Fleets in Underground Mines Using CP-Based LNS. In Integration of Constraint Programming, Artificial Intelligence, and Operations Research; Stuckey, P.J., Ed.; Lecture Notes in Computer Science; Springer International Publishing: Cham, Switzerland, 2021; Volume 12735, pp. 365–382. [Google Scholar]
  20. Li, N.; Feng, S.; Lei, T.; Ye, H.; Wang, Q.; Wang, L.; Jia, M. Rescheduling Plan Optimization of Underground Mine Haulage Equipment Based on Random Breakdown Simulation. Sustainability 2022, 14, 3448. [Google Scholar] [CrossRef]
  21. Li, J.; Pan, Q.; Mao, K. A Discrete Teaching-Learning-Based Optimisation Algorithm for Realistic Flowshop Rescheduling Problems. Eng. Appl. Artif. Intell. 2015, 37, 279–292. [Google Scholar] [CrossRef]
  22. Peng, K.; Pan, Q.-K.; Gao, L.; Li, X.; Das, S.; Zhang, B. A Multi-Start Variable Neighbourhood Descent Algorithm for Hybrid Flowshop Rescheduling. Swarm Evol. Comput. 2019, 45, 92–112. [Google Scholar] [CrossRef]
  23. Ma, Z.; Yang, Z.; Liu, S.; Wu, S. Optimized Rescheduling of Multiple Production Lines for Flowshop Production of Reinforced Precast Concrete Components. Autom. Constr. 2018, 95, 86–97. [Google Scholar] [CrossRef]
  24. Tu, S.; Jia, M.; Wang, L.; Feng, S.; Huang, S. A Multi-Equipment Task Assignment Model for the Horizontal Stripe Pre-Cut Mining Method. Sustainability 2022, 14, 16379. [Google Scholar] [CrossRef]
  25. Zhang, B.; Pan, Q.; Meng, L.; Zhang, X.; Jiang, X. A Decomposition-Based Multi-Objective Evolutionary Algorithm for Hybrid Flowshop Rescheduling Problem with Consistent Sublots. Int. J. Prod. Res. 2023, 61, 1013–1038. [Google Scholar] [CrossRef]
  26. Chen, C.; Li, Y.; Cao, G.; Zhang, J. Research on Dynamic Scheduling Model of Plant Protection UAV Based on Levy Simulated Annealing Algorithm. Sustainability 2023, 15, 1772. [Google Scholar] [CrossRef]
  27. An, Y.; Chen, X.; Gao, K.; Zhang, L.; Li, Y.; Zhao, Z. A Hybrid Multi-Objective Evolutionary Algorithm for Solving an Adaptive Flexible Job-Shop Rescheduling Problem with Real-Time Order Acceptance and Condition-Based Preventive Maintenance. Expert Syst. Appl. 2023, 212, 118711. [Google Scholar] [CrossRef]
  28. Wen, X.; Lian, X.; Qian, Y.; Zhang, Y.; Wang, H.; Li, H. Dynamic Scheduling Method for Integrated Process Planning and Scheduling Problem with Machine Fault. Robot. Comput.-Integr. Manuf. 2022, 77, 102334. [Google Scholar] [CrossRef]
  29. Gu, Z.-M.; Wang, G.-G. Improving NSGA-III Algorithms with Information Feedback Models for Large-Scale Many-Objective Optimization. Future Gener. Comput. Syst. 2020, 107, 49–69. [Google Scholar] [CrossRef]
  30. Li, S.; Zhang, M.; Wang, N.; Cao, R.; Zhang, Z.; Ji, Y.; Li, H.; Wang, H. Intelligent Scheduling Method for Multi-Machine Cooperative Operation Based on NSGA-III and Improved Ant Colony Algorithm. Comput. Electron. Agric. 2023, 204, 107532. [Google Scholar] [CrossRef]
  31. Hou, Y.; Wu, N.; Li, Z.; Zhang, Y.; Qu, T.; Zhu, Q. Many-Objective Optimization for Scheduling of Crude Oil Operations Based on NSGA-III with Consideration of Energy Efficiency. Swarm Evol. Comput. 2020, 57, 100714. [Google Scholar] [CrossRef]
  32. Liu, Y.; You, K.; Jiang, Y.; Wu, Z.; Liu, Z.; Peng, G.; Zhou, C. Multi-Objective Optimal Scheduling of Automated Construction Equipment Using Non-Dominated Sorting Genetic Algorithm (NSGA-III). Autom. Constr. 2022, 143, 104587. [Google Scholar] [CrossRef]

Figure 1. The coupling relationship between dynamic scheduling characteristic.
Figure 1. The coupling relationship between dynamic scheduling characteristic.
Sustainability 15 07306 g001
Figure 2. Event-driven mechanism.
Figure 2. Event-driven mechanism.
Sustainability 15 07306 g002

Figure 3. Cycled interval-driven mechanism.
Figure 3. Cycled interval-driven mechanism.
Sustainability 15 07306 g003

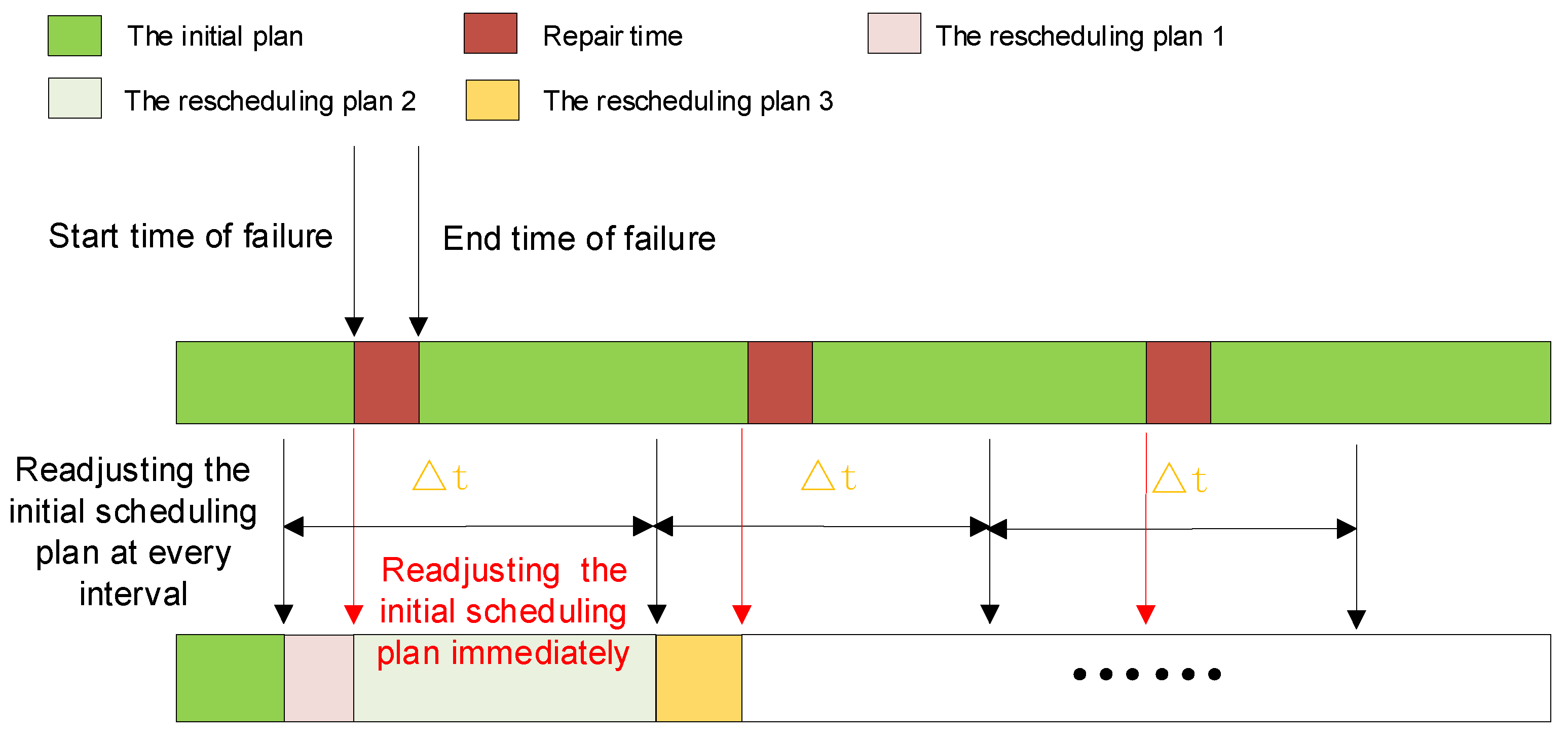

Figure 4. Hybrid-driven mechanism.
Figure 4. Hybrid-driven mechanism.
Sustainability 15 07306 g004

Figure 5. The initial scheduling plan.
Figure 5. The initial scheduling plan.
Sustainability 15 07306 g005
Figure 6. The complete adjustment method.
Figure 6. The complete adjustment method.
Sustainability 15 07306 g006

Figure 7. The partial adjustment method.
Figure 7. The partial adjustment method.
Sustainability 15 07306 g007

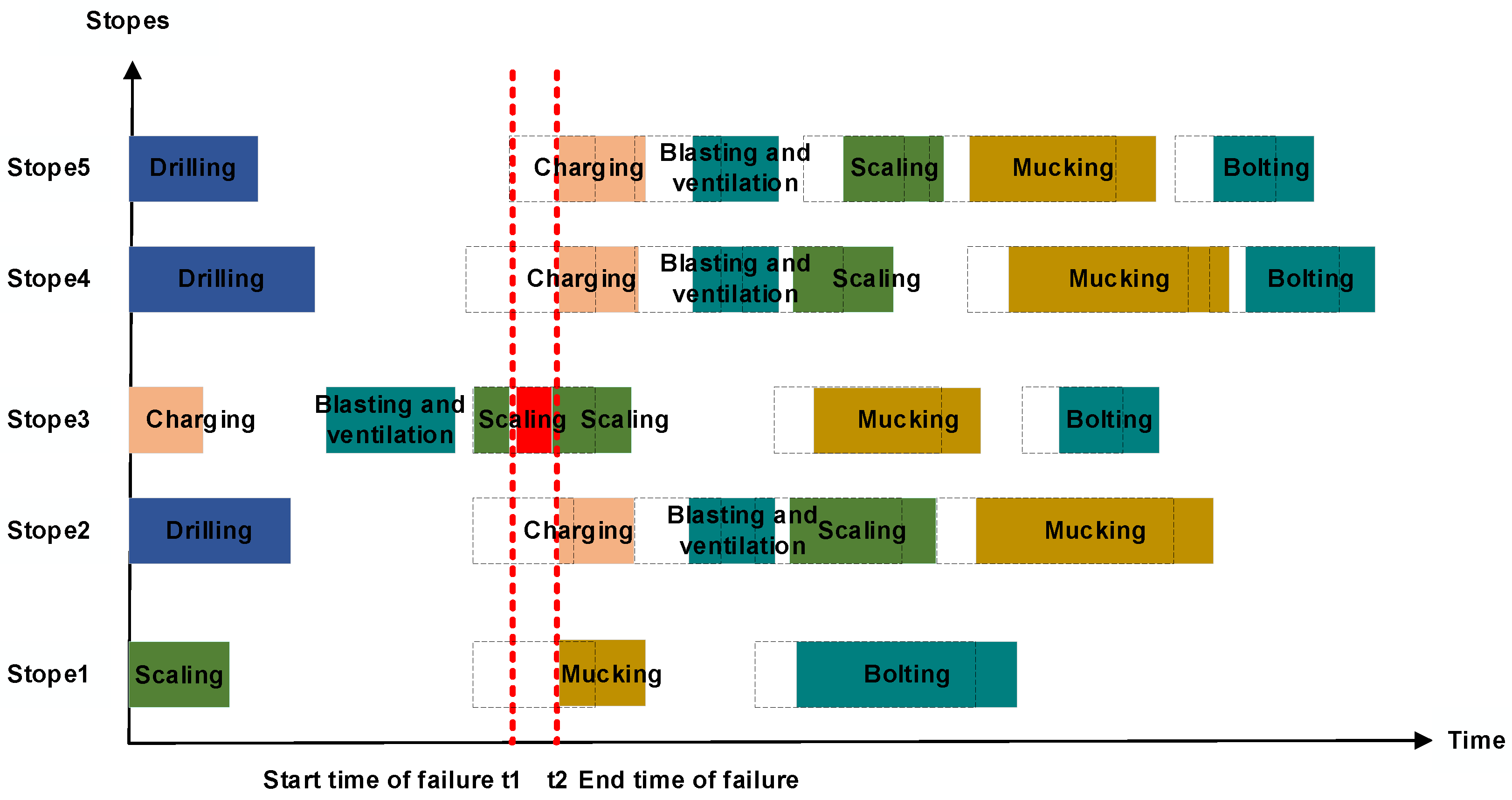

Figure 8. The backward adjustment method.
Figure 8. The backward adjustment method.
Sustainability 15 07306 g008

Figure 9. The dynamic scheduling process.
Figure 9. The dynamic scheduling process.
Sustainability 15 07306 g009
Figure 10. The main process of model solving.
Figure 10. The main process of model solving.
Sustainability 15 07306 g010

Figure 11. Two-layer coding method: (a) Part A: block priorities code; (b) Part B: equipment selections code; (c) Encoding and decoding of chromosome.
Figure 11. Two-layer coding method: (a) Part A: block priorities code; (b) Part B: equipment selections code; (c) Encoding and decoding of chromosome.
Sustainability 15 07306 g011

Figure 12. The initial scheduling plan.
Figure 12. The initial scheduling plan.
Sustainability 15 07306 g012
Figure 13. The iteration process of the genetic algorithm.
Figure 13. The iteration process of the genetic algorithm.
Sustainability 15 07306 g013
Figure 14. The rescheduled plan.
Figure 14. The rescheduled plan.
Sustainability 15 07306 g014

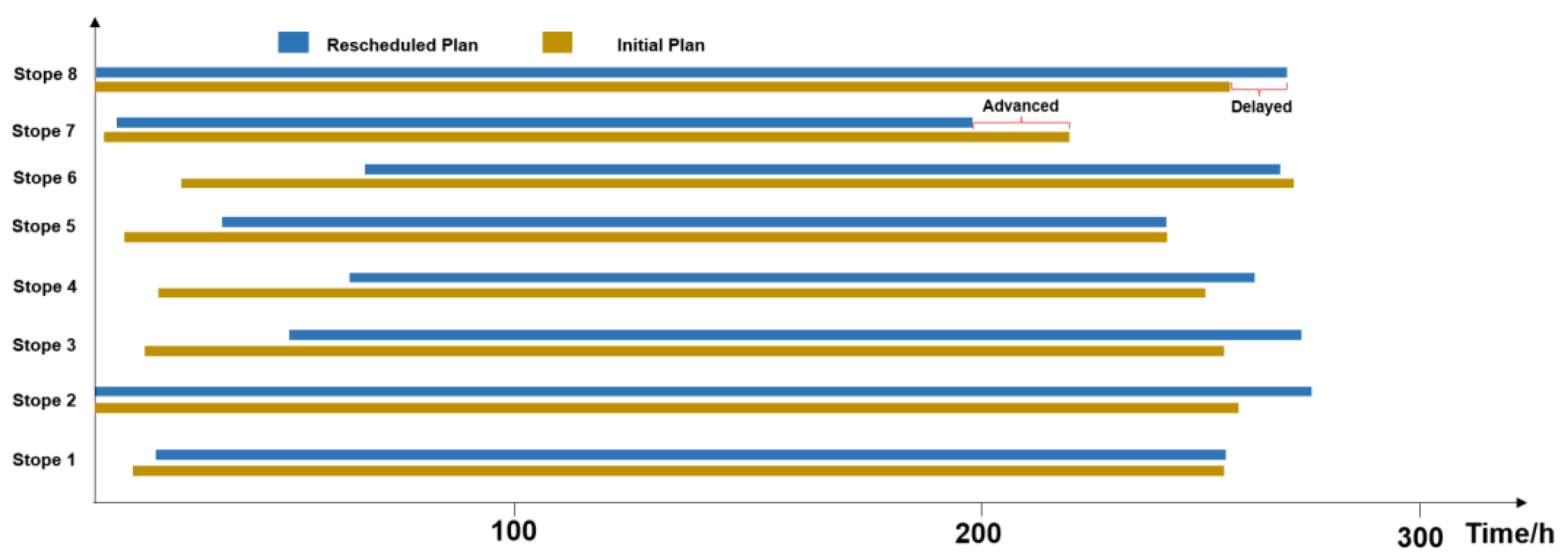

Figure 15. Comparison between the initial and rescheduled plans.
Figure 15. Comparison between the initial and rescheduled plans.
Sustainability 15 07306 g015
Table 1. Reasons for failures of underground mining equipment.
Table 1. Reasons for failures of underground mining equipment.
EquipmentFailure ReasonFailure Type
Drilling rigThe components of the drilling rig have not been maintained or replaced for a long time.Internal failure
Drill pipe damage caused by drilling hard rock or the abnormal operation of a drilling rig caused by a high-temperature and high-humidity environment.External failure
Charging rigThe charging quality of the charging rig is not up to the standard due to an unstable and insufficient charging quantity that cannot meet the requirements of subsequent blasting operations.Internal failure
The charging rig cannot work normally due to the deformation of the borehole, or the charging operation is abnormal due to the high-temperature and high-humidity environment.External failure
Scaling rigThe components of the scaling rig have not been maintained or replaced for a long time.Internal failure
The falling pumice caused damage to the mechanical arm of the scaling rig.External failure
LHDThe components of the LHD have not been maintained or replaced for a long time.Internal failure
The high-temperature and high-humidity environment led to the abnormal loading operation of the LHD.External failure
BolterThe components have not been maintained or replaced for a long time, the anchor rod is broken, the air leg is jammed, and the positioning is inaccurate, resulting in abnormal support operation.Internal failure
The high-temperature and high-humidity environment led to abnormal support operation.External failure
Table 2. Advantages and disadvantages of the dynamic scheduling mechanism.
Table 2. Advantages and disadvantages of the dynamic scheduling mechanism.
Dynamic Scheduling MechanismAdvantagesDisadvantages
Event-drivenResponds to events quickly;
High real-time performance.
Poor in scheduling stability.
Cycled, interval-drivenHigh stability.Poor in real-time scheduling.
Hybrid-drivenResponds to events quickly;
High stability.
Complex in management
Table 3. Advantages and disadvantages of dynamic scheduling methods.
Table 3. Advantages and disadvantages of dynamic scheduling methods.
Dynamic Scheduling MethodsAdvantagesDisadvantages
Complete adjustmentHigh robustness;
High flexibility;
High completion time stability.
High equipment change cost.
Partial adjustmentLow equipment change cost;
High equipment stability.
Low robustness.
Backward adjustmentHigh equipment stability.Low robustness;
Low flexibility;
Low time stability.
Table 4. Indices and sets.
Table 4. Indices and sets.
NameMeaning
ASet of areas, A = {A1, A2…, Ai}, i 1 , I
BiSet of stripes, Bi = {Bi1, Bi2, …, Bik}, i 1 , I , k 1 , K , k f
CikSet of all blocks, Cik = {Cik1, Cik2, …, Cikn}, i 1 , I , k 1 , K , n 1 , N , n x
MSet of equipment, M = {M1, M2, …, Mh}, h 1 , H , h u
JSet of processes, J = {J1, J2, …, Jm}, m 1,6 , J1 = 1 (Drilling), J2 = 2 (Charging), J3 = 3 (Blasting and ventilation), J4 = 4 (Scaling), J5 = 5 (Mucking), J6 = 6 (Bolting)
Table 5. Decision variables.
Table 5. Decision variables.
NameMeaning
TFiknmhIn the initial plan, the starting time of Mh failure of Jm in Cikn, h, m 3
TEiknmhIn the initial plan, the ending time of Mh of Jm in Cikn, h, m 3
TEifxmuIn the initial plan, the ending time of Mu of Jm in Cifx, h, m 3
TSiknmuIn the rescheduled plan, the starting time of Mu of Jm in Cikn, h, m 3
TWiknmuIn the rescheduled plan, the operation time of Mu of Jm in Cikn, h, m 3
TEiknmuIn the rescheduled plan, the ending time of Mu of Jm in Cikn, h, m 3
M l i k n m If the equipment selection of Jm in Cikn changes, the value is 1; otherwise, it is 0, m 3
T v e n , i k n Blasting and ventilation time in Cikn
T M i k n u i f x u Time of movement between Cifx and Cikn with Mu, h
B l s i k n m Number of blasting and ventilation process for Jm in Cikn, m 3
Table 6. Main technical parameters of mining equipment.
Table 6. Main technical parameters of mining equipment.
EquipmentTaskOperational EfficiencyNumber
Horizontal drilling rigDrilling horizontal holes40 m/h4
Downward drilling rigDrilling vertical holes30 m/h2
Charging rigDrilling holes for charging with explosives90 m/h3
Scaling rigExposed roof area scaling for removing loosely attached rock10 m2/h1
LHDOre mucking1500 t·m/h4
BolterAnchor support for reinforcing surrounding rock mass10 anchors/h3
Table 7. The comparison with the initial plan, the execution result of the initial plan, and the execution result of the rescheduled plan.
Table 7. The comparison with the initial plan, the execution result of the initial plan, and the execution result of the rescheduled plan.
NameThe Initial PlanThe Execution Result of the Initial PlanThe Execution Result of the Rescheduled PlanImprovement
(%)
Completion time (h)2553122848.97
The total time deviation (h)01837956.83
The frequency of equipment changes0011— —
Total block interval (h)33764742035.09
Total process interval (h)63894369126.72
Ore grade fluctuation0.040.830.4249.40
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Tu, S.; Jia, M.; Wang, L.; Feng, S.; Huang, S. A Dynamic Scheduling Model for Underground Metal Mines under Equipment Failure Conditions. Sustainability 2023, 15, 7306. https://doi.org/10.3390/su15097306

AMA Style

Tu S, Jia M, Wang L, Feng S, Huang S. A Dynamic Scheduling Model for Underground Metal Mines under Equipment Failure Conditions. Sustainability. 2023; 15(9):7306. https://doi.org/10.3390/su15097306

Chicago/Turabian Style

Tu, Siyu, Mingtao Jia, Liguan Wang, Shuzhao Feng, and Shuang Huang. 2023. "A Dynamic Scheduling Model for Underground Metal Mines under Equipment Failure Conditions" Sustainability 15, no. 9: 7306. https://doi.org/10.3390/su15097306

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
