Article

Barriers to Sustainable Building Project Performance in Developing Countries: A Case of Ghana and the Kingdom of Saudi Arabia

1
Civil Engineering Department, College of Engineering, Shaqra University, Al-Dawadmi 11911, Saudi Arabia
2
Department of Civil Engineering, Faculty of Engineering, Dr. Hilla Limann Technical University, Wa P.O. Box 553, Ghana
3
Department of Architecture and Building Sciences, College of Architecture and Planning, King Saud University, Riyadh 11421, Saudi Arabia
4
Department of Civil Engineering, Horus University, New Damietta 7952567, Egypt
*
Author to whom correspondence should be addressed.
Sustainability 2025, 17(8), 3539; https://doi.org/10.3390/su17083539
Submission received: 27 January 2025 / Revised: 28 February 2025 / Accepted: 11 April 2025 / Published: 15 April 2025
(This article belongs to the Topic Sustainable Building Development and Promotion)

Abstract

:
The global building and construction industry faces increasing challenges related to efficiency, performance, and sustainability, which significantly impact project success, particularly in developing economies. The timely and successful completion of building and construction projects is crucial for economic development; however, various barriers hinder effective project execution. This study identifies and empirically analyzes the critical barriers affecting building and construction project performance in two developing countries with distinct economic profiles, Ghana and the Kingdom of Saudi Arabia (KSA). A comprehensive literature review and expert interviews identified fourteen key barriers to project performance, ensuring clarity and technical relevance. Using an empirical questionnaire survey targeting experienced professionals, including contractors, clients, and consultants, the study employed the Relative Importance Index (RII) and Spearman’s correlation analysis to rank and examine the interrelationships between these barriers. The findings reveal that poor communication (RII = 0.831, ranked 1st), project cost and schedule constraints (RII = 0.806, ranked 2nd), and inadequate monitoring and evaluation (RII = 0.786, ranked 3rd) are the most significant barriers to project success in both contexts. These challenges align with global sustainability concerns, particularly Sustainable Development Goal (SDG) 9 (Industry, Innovation, and Infrastructure) and SDG 11 (Sustainable Cities and Communities), which emphasize resilient infrastructure and sustainable urban development. The study highlights the crucial role of decision makers, regulatory frameworks, and financial planning in overcoming these barriers and enhancing project outcomes. By addressing these constraints, the study provides actionable insights for policymakers, project managers, and industry stakeholders to improve project execution efficiency and foster sustainable building and construction practices. Future research should explore adaptive mitigation strategies and technological innovations that enhance project delivery efficiency in developing economies.

1. Introduction

The building and construction industry plays a pivotal role in the economic development of nations, serving as a foundation for infrastructure, including buildings, roads, and bridges [1]. The economic growth of a country is closely linked to its infrastructural advancements, making the efficient execution of building and construction projects a key factor in national development. A typical building construction project involves multiple stakeholders, various phases of work, and public- and private-sector contributions. The successful execution of building and construction projects depends on multiple interrelated factors influencing overall project efficiency, quality, and sustainability. These factors include financial management, stakeholder coordination, regulatory frameworks, workforce productivity, and risk mitigation strategies [2,3]. Understanding and addressing these elements is essential for improving project performance and minimizing delays, cost overruns, and inefficiencies.
Singh and Sharma [4] identified six key factors influencing building and construction project success: financial stability, stakeholder coordination, regulatory compliance, workforce competency, contractor efficiency, and external influences. Financial constraints are a significant barrier to project success, particularly in developing economies with limited access to funding [5]. Late payments, insufficient financial reserves, and poor cash-flow management have been identified as key contributors to project delays [6]. Yap et al. [7] emphasize that economic instability can exacerbate these issues, leading to underfunded projects, cost escalations, and contractor insolvency. Moreover, resource allocation, including material procurement and equipment availability, is crucial in determining project timelines and quality [8]. Successful project completion relies heavily on effective stakeholder collaboration. Poor communication between contractors, clients, consultants, and regulatory bodies often leads to misunderstandings, misaligned project goals, and construction errors [9]. Porras et al. [10] found that strong inter-stakeholder relationships facilitate better decision making, smoother workflows, and enhanced project oversight. Additionally, stakeholder involvement in early project planning has been shown to mitigate risks and improve execution [11].
Regulatory compliance ensures building and construction projects’ safety, quality, and environmental sustainability [12]. However, many developing countries’ inefficient permitting processes, procedural delays, and weak enforcement mechanisms hinder project progress [13]. Al-Suliman [14] highlighted that complex administrative procedures and inconsistent policy implementation contribute to project delays in Saudi Arabia. Similarly, Ghana’s lack of stringent building-code enforcement has resulted in substandard construction practices and safety violations [15]. A skilled workforce is also essential to project success [16]. Bamfo-Agyei et al. [17] assert that enhanced labor productivity leads to higher profitability, better project outcomes, and increased competitiveness. However, many construction industries, especially in low-income countries, suffer from labor shortages, lack of specialized training, and insufficient safety awareness [18]. Vocational training programs and investment in skill development are necessary to improve workforce efficiency and project quality [19].
Risk management strategies, including proactive safety measures, environmental impact assessments, and resilience planning, are critical for long-term project sustainability [20]. Moazami et al. [21] note that climate change and extreme weather conditions pose significant risks to building and construction projects, necessitating adaptive design and material choices. Similarly, Rady et al. [22] stress the importance of comprehensive monitoring and evaluation frameworks to track project performance and ensure adherence to quality standards.
This study addresses the limited research on barriers affecting building and construction project performance in developing economies, particularly in Ghana and KSA. The lack of comparative, country-specific analysis has led to inefficiencies in project execution, cost overruns, and delays, influencing economic growth and sustainable development. Given the construction sector’s crucial role in Gross Domestic Product (GDP), employment, and infrastructure expansion, understanding these barriers is essential for improving project management, regulatory frameworks, and financial planning. This study fills a gap in the literature by identifying and ranking the key barriers through empirical analysis, offering insights for policymakers, industry professionals, and researchers. The findings provide targeted recommendations to enhance project execution efficiency while contributing to the broader discourse on sustainable construction in developing economies.
The selection of Saudi Arabia and Ghana as case studies is based on their distinct economic and construction industry profiles, which provide a comparative perspective on the challenges hindering building project performance. Saudi Arabia, the largest economy in the Middle East, has a construction sector experiencing rapid growth, primarily driven by the Vision 2030 initiative [23]. This initiative aims to diversify the economy and invest heavily in infrastructure development. Despite these advancements, the Saudi construction industry faces persistent challenges, including cost overruns, regulatory inefficiencies, skilled labor shortages, and bureaucratic delays [23].
Conversely, Ghana is a lower-income developing country, and the construction sector is a crucial contributor to economic growth [24]. However, Ghana’s construction industry encounters significant obstacles, including inadequate funding, inefficient project management, weak enforcement of building regulations, and a lack of skilled labor. Moreover, the country’s economic instability and fluctuating exchange rates exacerbate financial constraints in construction projects [24]. By analyzing these two contrasting economies, one represents a high-income, resource-abundant country with regulatory complexity and a developing country with financial and institutional challenges. This study aims to better understand how different economic, regulatory, and cultural contexts influence construction project performance.
The paper is constructed into six sections. The first section is the former introduction to the building and construction project performance. The second is a thorough literature review to extract the main barriers hindering building project performance in developing countries. The third is the Materials and Methods section, which describes how the study is applied and data gathered. The results, analysis, and discussion sections follow, where the data are analyzed and insights are developed. The final section is the Conclusions section, which provides general findings and potential development recommendations.

2. Literature Review

The performance of building and construction projects is evaluated based on key performance indicators (KPIs) such as time, cost, quality, and stakeholder satisfaction. Successful project execution requires the efficient integration of financial, technical, and managerial resources to meet project objectives [15]. However, external factors, including economic conditions, regulatory frameworks, and environmental constraints, significantly impact project outcomes [25]. In developing economies, delays and cost overruns are prevalent due to inadequate planning, inefficient monitoring, and a lack of skilled labor [21]. Addressing these challenges necessitates understanding critical barriers that hinder project performance, which are discussed in the following sections. The present study aims to compare the performance of building and construction projects between Ghana and KSA by extracting the main barriers hindering the projects’ performance from the literature and determining which factors are the most important according to the professionals and practitioners of the industry in each country.

2.1. The Building and Construction Industry in KSA

The Kingdom of Saudi Arabia boasts the largest economy in the Middle East and ranks the eighteenth largest globally [26]. A permanent and founding member of the Organization of the Petroleum Exporting Countries (OPEC), Saudi Arabia also holds membership within the G20 forum as one of the world’s largest economies [27]. Saudi Arabia’s building and construction industry is a key driver of economic growth, bolstered by Vision 2030, which prioritizes infrastructure expansion through megaprojects. Despite its rapid growth, previous research highlights persistent challenges, including regulatory inefficiencies, financial constraints, labor shortages, and project delays. Al-Suliman [14] identified procedural delays and inconsistent regulatory enforcement as major obstacles slowing down project approvals in KSA. Similarly, Hijazi [28] emphasized the impact of funding delays and fluctuating oil prices, which affect financial stability and project continuity. The heavy reliance on foreign labor has also created challenges, as Carlgren et al. [29] found that Saudization policies aimed at increasing local workforce participation have led to skill shortages and project inefficiencies.
In addition to labor and financial constraints, project management inefficiencies remain critical. Rady et al. [22] examined risk management practices and found that poor safety compliance and ineffective monitoring frameworks contribute to delays and cost overruns. Pour Rahimian et al. [25] explored the adoption of Building Information Modeling (BIM) in KSA and found that limited digital literacy, resistance to change, and inadequate training have hindered the implementation of innovative construction technologies. Furthermore, Gonzalez-Porras et al. [10] highlighted how poor stakeholder coordination and communication breakdowns negatively affect large-scale projects, especially those involving international firms.
Research suggests that regulatory reforms, improved financial strategies, workforce development programs, and enhanced technology integration are viable solutions to these challenges. Al-Suliman [14] advocated for streamlined permit approval processes and better regulatory enforcement to minimize delays. GlobalData [30] emphasized the role of public–private partnerships (PPPs) in mitigating financial risks and reducing project funding gaps. Additionally, Hijazi [28] recommended expanding vocational training programs to enhance workforce competency, while Pour Rahimian et al. [25] suggested promoting BIM adoption and AI-driven project management to improve efficiency. Addressing these barriers is essential for sustainable growth and successful project execution in Saudi Arabia’s construction sector.

2.2. The Building and Construction Industry in Ghana

On the other hand, Ghana is a low-income country with decelerated GDP growth from 3.8% in 2022 to 2.9% in 2023 due to macroeconomic instability and external factors [31]. Ghana’s construction industry is a vital contributor to economic development, accounting for approximately 7.2% of the country’s GDP [31]. Despite its importance, the sector faces persistent challenges, including funding shortages, weak regulatory enforcement, labor inefficiencies, and project delays [15,24]. Bamfo-Agyei et al. [17] highlighted that limited access to credit, high loan interest rates, and financial mismanagement significantly affect project completion rates. Similarly, Rady et al. [22] found that inefficient procurement processes and inconsistent government funding for public projects have led to frequent cost overruns and contractor disputes. Furthermore, Ghana’s inadequate enforcement of building codes and lack of regulatory oversight have resulted in substandard construction quality and safety concerns [28].
Workforce-related challenges also hinder project performance, as Ghana’s construction sector suffers from a shortage of skilled labor and insufficient vocational training programs. Kissi et al. [15] found that a lack of continuous professional development opportunities for workers contributes to low productivity and poor workmanship. Additionally, Pour Rahimian et al. [25] emphasized that limited adoption of modern construction technologies, such as BIM and automation, has slowed efficiency improvements in Ghana’s construction projects. Stakeholder coordination also presents a significant challenge, as Gonzalez-Porras et al. [10] observed that miscommunication and unclear project roles between contractors, consultants, and government agencies frequently result in project delays and disputes.
Previous research has recommended policy reforms, increased investment in workforce training, and enhanced technological integration to address these challenges. Hijazi [28] suggested that each government should strengthen regulatory enforcement to improve safety and compliance with building standards. Bamfo-Agyei et al. [17] advocated for financial interventions to support contractors facing liquidity issues, such as low-interest construction loans and government-backed funding schemes. Additionally, Pour Rahimian et al. [25] recommended promoting digital construction management tools to improve project efficiency, while Rady et al. [22] emphasized the importance of monitoring and evaluation frameworks to track progress and ensure quality control. Implementing these measures is essential to enhancing Ghana’s construction sector and mitigating long-standing industry barriers.
Although Saudi Arabia’s construction market size is far more extensive than Ghana’s, the construction industry contributes significantly to both countries’ economies. Thus, the results of this study could be extrapolated to have significance in other high-come and low-income countries, as the construction industries of Saudi Arabia and Ghana are representative of the construction industries in high- and low-income countries, respectively.

2.3. Key Barriers Affecting Construction Project Success

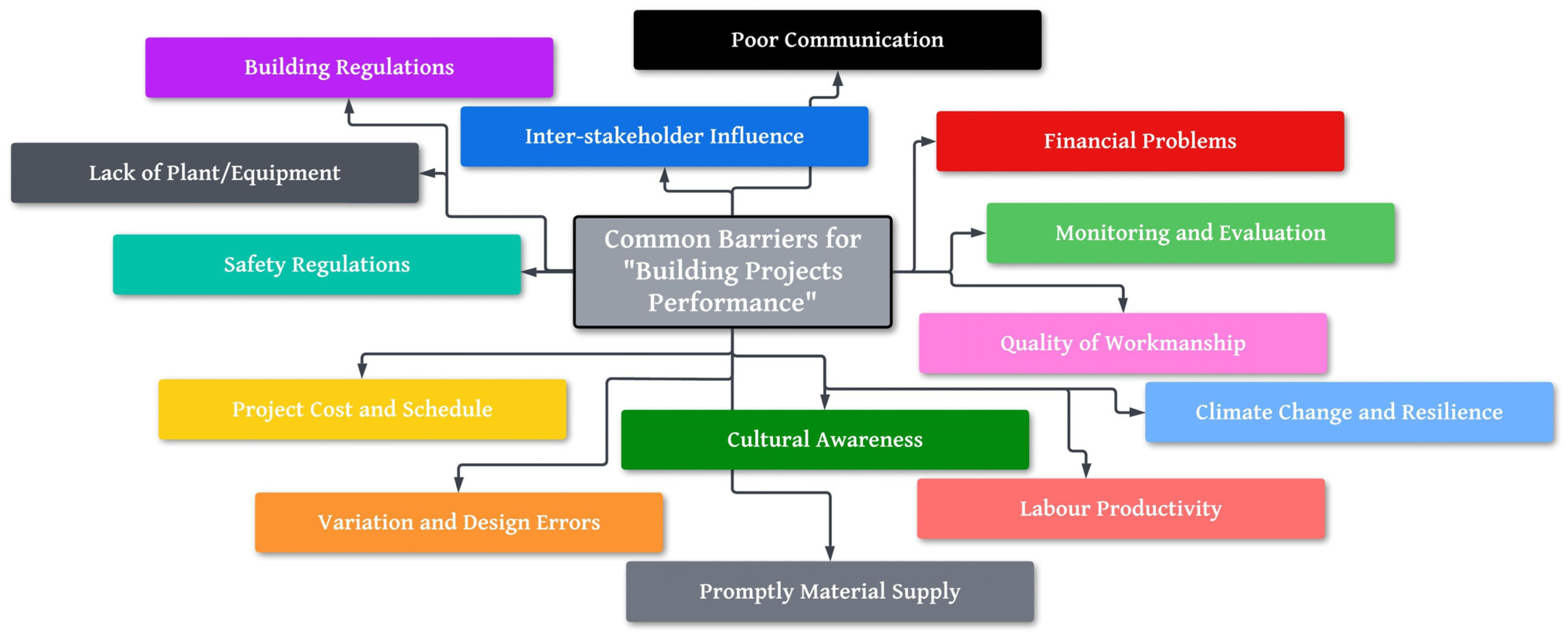

From a thorough review of the literature, fourteen factors have been identified as important to the success of building projects with no specific order of importance, as shown in Figure 1. These barriers were well documented and applied within the research framework during 2024 to explore research published in journals, books, and studies on building project performance. The organization of the literature review was based upon two criteria: the journal is indexed in databases such as the Science Citation Index and Engineering Index Compendex database, and the topics are related to building project performance. The literature then enables the investigation of the barriers to building project performance in KSA and Ghana.
Table 1 presents a comprehensive mapping of the extracted barriers that hinder project performance in the building and construction sector. The barriers identified range from external factors such as climate-change resilience (B1) to internal project management challenges like financial problems (B9) and poor communication (B8). Each barrier is supported by multiple references, indicating the depth of research conducted on these issues. Table 2 contains a classification of project performance barriers in building and construction projects, categorized into project management, human and organizational factors, financial constraints, regulatory compliance, and design issues. This structured approach facilitates a clearer understanding of the critical challenges affecting project success and informs targeted mitigation strategies.

3. Materials and Methods

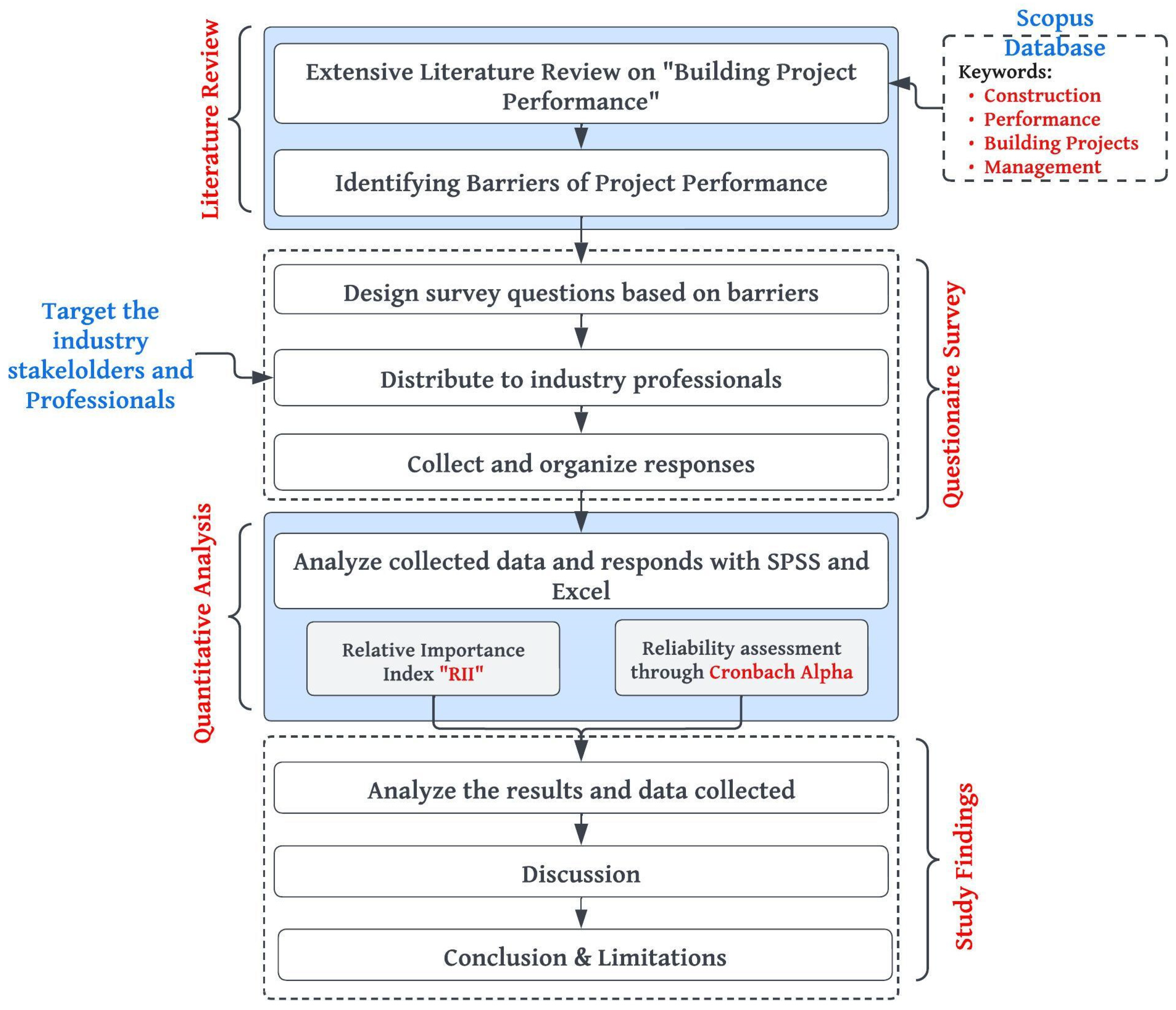

The study investigates and identifies the barriers affecting the performance of building and construction projects in developing countries, using Ghana and KSA as case studies. A quantitative approach was adopted, which started with a comprehensive literature review, a structured questionnaire survey, and statistical data analysis. Figure 2 outlines the sequence of the research process to maintain transparency on how the research was conducted.

3.1. Literature Review Method

A systematic literature review was conducted to identify key barriers to construction project performance. Fourteen (14) barriers were extracted from previous studies and categorized based on their relevance and frequency in the literature (Table 1). Given the criticality of these barriers, a Relative Importance Index (RII) ranking was performed to prioritize them for decision making. The literature further highlights recurring challenges in construction projects, such as cost overruns, delays, and inadequate planning, emphasizing the need for an empirical investigation into these barriers within the case-study countries.

3.2. Questionnaire Survey

A structured questionnaire survey was conducted among construction professionals in Ghana and KSA to assess the identified barriers empirically (Appendix A). The questionnaire aimed to capture professional perspectives on the barriers affecting the successful execution of building and construction projects. To ensure a structured and comprehensive approach, the questionnaire was divided into three main sections: (1) Respondent Demographics, (2) Identification and Ranking of Barriers, and (3) Additional Insights on Project Challenges.

3.2.1. Questionnaire Design

The survey consisted of twenty-five questions, including five demographic questions that collected data on respondents’ roles, years of experience, education levels, and sector involvement to assess their relevance to the study; fourteen barrier assessment questions utilizing a five-point Likert scale; and six open-ended questions designed to capture additional insights on specific challenges and propose potential mitigation strategies beyond the predefined barriers.

3.2.2. Pre-Survey Validation

A two-stage validation process was conducted before full-scale distribution: an expert review, where a pilot test was conducted with 15 industry experts to refine the questionnaire to ensure clarity of technical terms and contextual relevance [86], and finalization, where, based on expert feedback, the finalized questionnaire was structured using a five-point Likert scale, allowing respondents to rank the severity of each barrier from (1) Strongly Disagree to (5) Strongly Agree [87].

3.2.3. Survey Distribution and Data Collection

The study employed a purposive sampling approach, targeting professionals with direct experience in construction project planning, execution, and management. The inclusion criteria required participants to have at least five years of industry experience and hold roles as contractors, consultants, or clients in the construction sector. The questionnaire was distributed via Google Forms to targeted professionals in both countries using a convenience sampling approach [88]. Participants provided insights on their perceptions of the barriers within their organizational and project contexts. Table 3 presents an overview of the survey responses:
The final dataset comprised 98 valid responses, representing 85% of returned surveys and 65% of distributed questionnaires. This response rate is significantly higher than that of similar studies conducted in Saudi Arabia, which typically achieve around 35% response rates [89,90]. The sample size was adequate for statistical analysis, including RII calculations and Spearman’s correlation analysis.

3.3. Data Reliability and Validity

To assess the reliability and internal consistency of the collected data, Cronbach’s alpha coefficient (α) was calculated. A minimum reliability threshold of 0.70 is generally considered acceptable [91]. In this study, the Cronbach’s alpha coefficient for the 14 barriers was 0.82, indicating strong reliability and credibility for further statistical analysis.

3.4. Relative Important Index (RII)

The Relative Importance Index (RII) quantifies and prioritizes the barriers affecting construction project performance. This method is widely applied in construction research to evaluate the significance of different factors [87,92]. The RII was calculated using Equation (1):
RII = ∑ (a.x)∗100/5
where
a = constant (weight) 1−5, x = n/N, n = Frequency of responses, and N = Number of responses.
This ranking enabled a structured comparison of the barriers, providing valuable insights for policymakers and industry professionals.

4. Results

The data collected from respondents provide insights into the perceived challenges in the construction industry. The findings highlight key barriers affecting project success, focusing on efficiency, performance, and sustainability. Given the dynamic nature of construction projects and increasing competition, ensuring project success is crucial, particularly in developing countries such as KSA and Ghana, where infrastructure development is a national priority.

4.1. Participants Demographic

The study surveyed professionals and stakeholders in the construction industry to capture a holistic view of the challenges encountered. Table 4 presents a breakdown of respondents and includes key variables such as organizational role (contractor, consultant, client), years of experience (categorized as 5–10, 11–15, 16–20, and over 20 years), educational qualifications (diploma, bachelor’s, master’s, Ph.D.), and sectoral involvement (infrastructure, residential, commercial, utilities). These demographic details offer valuable insights into the professional background of respondents and their perspectives on construction industry challenges.
The distribution includes contractors, consultants, and clients, reflecting the diversity of roles in the industry. Respondents’ experience ranges from 5 to over 20 years, ensuring a balanced dataset capturing perspectives from seasoned professionals and emerging practitioners. Regarding educational attainment, most respondents (44.8%) hold a bachelor’s degree, followed by 33.6% with a master’s degree. Only 8.4% had a Ph.D., while 13.2% possessed a diploma. This suggests that the industry comprises professionals with undergraduate qualifications, which may indicate a need for more advanced training and education in construction management and emerging technologies.
The sectoral distribution of respondents indicates that 46.9% are engaged in infrastructure projects, making it the most represented sector. This is followed by 24.4% in residential construction, 18.3% in commercial projects, and 10.4% in utilities. The high concentration of professionals in infrastructure projects aligns with national development priorities, particularly in rapidly growing economies such as KSA and Ghana, where large-scale public works and transportation projects are central to economic progress. Conversely, the lower representation in the utility sector may suggest challenges related to investment, policy constraints, or the complexity of integrating modern technologies into service delivery.

4.2. Relative Importance Index (RII) Analysis of the Barriers

The RII method was employed to rank the barriers affecting construction projects in KSA and Ghana, providing a comparative perspective on the key challenges encountered in both regions. Table 5 presents these rankings, highlighting similarities and distinctions between the two contexts. “Poor communication” emerged as the most significant barrier in KSA, while it ranked second in Ghana, underscoring its critical role in project execution and stakeholder coordination. Conversely, “Project cost and schedule constraints” was ranked as the most pressing issue in Ghana, whereas it placed fourth in KSA, reflecting the financial limitations that pose a more substantial challenge in Ghana’s economic environment. Additionally, “Variation and error in design” was ranked as the second-highest barrier in KSA, emphasizing the considerable impact of design deficiencies on construction project outcomes.
As shown in Table 6, the combined ranking of barriers provides a broader perspective by averaging the RII scores from both countries. “Poor communication” (RII = 0.831) emerged as the most significant barrier overall, reinforcing its role in project inefficiencies and potential delays. “Project cost and schedule constraints” (RII = 0.806) ranked as the second-highest issue, highlighting the pervasive financial challenges influencing project feasibility. The third most critical factor was “Monitoring and evaluation of projects” (RII = 0.786), underlining the necessity of effective oversight mechanisms to ensure regulatory compliance, quality assurance, and timely project delivery.

4.3. Correlation Analysis for the Barriers

Spearman’s correlation analysis was conducted to examine the relationships among barriers and identify significant associations between key factors influencing construction project success. The results in Table 7 reveal strong positive correlations between several barriers, highlighting the interdependencies that affect project performance.
The most pronounced correlation was observed between “Monitoring and evaluation of projects” (B4) and “Building regulations” (B12), with a coefficient of r = 0.97 (p < 0.001). Similarly, “Monitoring and evaluation of projects” (B4) and “Safety regulations” (B13) exhibited a strong correlation of r = 0.908 (p < 0.001), emphasizing the role of oversight mechanisms in maintaining workplace safety and minimizing accidents.
On the other hand, the weakest relationship was found between “Cultural awareness” (B3) and “Variation and error in design” (B14), with a correlation of r = 0.018, indicating a negligible association. This suggests that cultural factors have a minimal influence on design-related challenges in construction projects, likely because technical and regulatory aspects play a more dominant role in determining design quality.

5. Analysis and Discussion

5.1. Barriers Hindering Building Project Performance in KSA

The most prominent challenge identified by respondents in Saudi Arabia is poor communication (B8), with an RII value of 0.829, indicating a lack of effective coordination among stakeholders. This barrier significantly influences project efficiency, leading to misunderstandings, misaligned expectations, and potential delays. These findings align with previous studies [15,92,93,94,95], emphasizing that ineffective communication results in unclear project objectives and stakeholder conflicts. A lack of structured communication channels within construction organizations or among shareholders contributes to resource mismanagement and overall project failure [13,87,89]. To mitigate this, it is essential to establish comprehensive communication protocols, mandatory employee training programs, and structured feedback mechanisms to improve clarity and coordination in project execution.
Beyond communication issues, respondents identified variation and error in design (B14) as another critical barrier. The inconsistent application of design standards and frequent modifications lead to cost overruns and construction delays. This finding highlights the need for enhanced design-validation processes, standardized protocols, and the integration of digital tools such as BIM to reduce errors and streamline the design process. Automated design validation and real-time stakeholder feedback mechanisms can minimize rework and enhance project efficiency. Monitoring and evaluating projects (B4) also ranked among the top barriers, emphasizing the necessity of leadership commitment to project oversight and risk management.

5.2. Barriers Hindering Building Project Performance in Ghana

In Ghana, project cost and schedule constraints (B2) were ranked as the most significant barrier (RII = 0.844), reflecting construction firms’ financial constraints and resource-allocation challenges. This is consistent with previous research [96,97,98], highlighting the impact of budget fluctuations, material price volatility, and limited access to credit on project feasibility. Poor financial planning often leads to disruptions in cash flow, procurement delays, and the ineffectiveness of workforce deployment. Addressing this challenge requires improved budget forecasting, risk mitigation strategies, and increased government–private-sector collaboration to ensure steady project funding.
Poor communication (B8), variation and error in design (B14), and financial problems (B9) were also ranked highly, reinforcing the importance of structured communication channels, rigorous design validation, and robust financial management. The ranking of these barriers underscores the challenges in coordination among stakeholders, inconsistent adherence to project designs, and the economic volatility that influences resource availability.
Unlike Saudi Arabia, where labor productivity ranked as a minor concern, labor productivity (B7) in Ghana was considered a more significant factor than previously reported in similar studies. While this study ranked it lower than other barriers, previous research [16,99] suggests that higher workforce efficiency increases profitability, competitiveness, and improved project outcomes in labor-intensive construction environments. This implies that while Ghana has developed strategies to optimize worker performance, additional workforce training and incentives could improve productivity.

5.3. Comparison of Findings Between KSA and Ghana

A comparative analysis of construction project barriers in KSA and Ghana reveals common challenges and distinct differences shaped by economic, structural, and technological factors. While both countries experience significant issues related to poor communication (B8), cost and schedule constraints (B2), and inadequate monitoring and evaluation (B4), the underlying causes and mitigation strategies vary based on industry maturity, financial stability, and workforce dynamics.
Across both KSA and Ghana, poor communication (B8) consistently ranks among the most critical barriers. Ineffective stakeholder coordination leads to misunderstandings, delays, and inefficient project execution. In KSA, communication challenges are often linked to complex procedural structures and multi-layered project management hierarchies. In contrast, in Ghana, fragmented communication stems from a lack of standardized reporting frameworks and limited digital collaboration tools. Implementing centralized communication platforms, real-time reporting mechanisms, and stakeholder engagement initiatives can significantly improve project coordination in both contexts.
Similarly, cost and schedule constraints (B2) emerged as a significant barrier in both countries, but with differing underlying causes. In KSA, financial challenges are primarily driven by budget misallocations, regulatory inefficiencies, and cost overruns in large-scale projects. In Ghana, economic instability, fluctuating material prices, and restricted access to credit create significant project financing obstacles [97,98]. Addressing these constraints requires flexible cost-estimation models, financial risk mitigation strategies, and improved procurement planning to ensure project viability.
Monitoring and evaluation (B4) ranked as a high-impact barrier in both nations, underscoring the need for stronger regulatory oversight and performance-tracking mechanisms. In KSA, extensive regulatory requirements often delay project approvals, whereas in Ghana, insufficient monitoring frameworks result in poor compliance and inconsistent project assessments. Strengthening compliance audits, integrating digital project-tracking tools, and enforcing regulatory adherence can enhance monitoring effectiveness in both regions.
While labor productivity (B7) ranked last in both countries, the reasons for this vary. In KSA, the reliance on modern machinery reduces the impact of workforce inefficiencies, whereas in Ghana, labor productivity improvements have been actively pursued to enhance overall project success. This suggests that automation and digital integration play a more significant role in KSA, while Ghana still benefits from refining workforce strategies.

5.4. Correlation Analysis Findings

Another crucial finding is the significant correlation between “Monitoring and evaluation of projects” and “Building and safety regulations” (r = 0.97 and r = 0.908, respectively). This strong association demonstrates that projects with rigorous oversight frameworks tend to comply better with legal and safety standards. This highlights the importance of developing structured project-monitoring systems integrating performance analytics and compliance tracking. Government agencies and building and construction firms should strengthen inspection protocols and adopt real-time data collection tools to ensure safety and quality standards adherence.
Interestingly, cultural awareness ranked among the least significant barriers, suggesting that cross-cultural differences do not significantly hinder project execution in KSA and Ghana. However, this may not hold for international collaboration projects where diverse stakeholder expectations and communication styles could influence project outcomes. Cultural competency training and cross-border project management strategies can enhance collaboration. These findings reinforce the importance of strategic interventions to overcome barriers in construction projects. By implementing data-driven solutions, project stakeholders can enhance project efficiency, reduce delays, and support sustainable development in KSA and Ghana.

5.5. Strategic Recommendations

A comprehensive, multi-faceted strategy is required to effectively address the identified barriers in the construction industries of KSA and Ghana. These recommendations focus on improving stakeholder communication, financial planning, project monitoring, and technological integration, ensuring sustainable and efficient project execution.
One of the primary strategies for mitigating project inefficiencies is enhancing stakeholder communication. Establishing centralized communication platforms and structured reporting frameworks can help minimize misunderstandings and delays. Effective communication ensures that all project participants remain aligned with objectives, reducing conflicts and improving coordination. Implementing real-time collaboration tools, regular stakeholder meetings, and transparent documentation practices can streamline communication processes and foster greater project efficiency [100,101,102,103,104,105].
Optimizing financial and procurement strategies is critical, particularly for mitigating cost overruns and delays. Adopting value-based procurement models, which assess contractors based on expertise, past performance, and efficiency rather than cost alone, can significantly enhance project delivery outcomes. Additionally, incorporating collaborative contracting and strategic supplier partnerships can mitigate supply-chain disruptions and facilitate the timely procurement of materials and resources. These strategies are particularly vital in Ghana, where financial constraints and schedule limitations pose significant challenges to project feasibility [106,107].
Enhancing project monitoring and evaluation is essential for ensuring construction quality, adherence to timelines, and regulatory compliance. Developing comprehensive training programs focused on quality control, leadership development, and continuous professional education can equip industry professionals with the necessary skills to oversee project execution effectively. Additionally, visible leadership commitment to quality initiatives fosters a culture of accountability and continuous improvement. Establishing robust performance-tracking tools, conducting regular audits, and strengthening compliance assessments will enhance project oversight and reduce risks associated with mismanagement and regulatory inefficiencies [107,108,109].
Integrating digital construction technologies can significantly mitigate risks associated with design errors, resource misallocation, and inefficient project execution. Adopting BIM, real-time project-monitoring systems and automation tools can enhance accuracy in design validation, cost estimation, and risk mitigation. In KSA, automation plays a pivotal role in improving efficiency, whereas in Ghana, investing in mechanization and workforce training in digital tools can enhance productivity. Implementing data-driven decision-making processes and predictive analytics will optimize project planning and reduce uncertainties.
Table 8 compares key barriers and mitigation strategies, reinforcing the need for country-specific yet adaptable solutions. By addressing these critical barriers through structured intervention strategies, the construction industries in KSA and Ghana can enhance sustainability, resilience, and overall project efficiency, ultimately contributing to national economic growth and infrastructure advancement.

6. Conclusions

This study provides a significant theoretical contribution to building and construction management by empirically identifying and analyzing the key barriers hindering project success in developing countries, particularly Ghana and KSA. This study:
Utilized Relative Importance Index (RII) analysis and Spearman’s correlation to offer a structured, data-driven approach to ranking and understanding the interrelationships between these barriers.
Extended the existing literature by demonstrating that poor communication (B8), project cost and schedule constraints (B2), and inadequate monitoring and evaluation (B4) are universally critical barriers in both economic contexts.
Contributed to construction project optimization theories by emphasizing the role of stakeholder collaboration, regulatory frameworks, and financial planning in enhancing project success
From a practical perspective, the findings offer valuable insights for construction practitioners, policymakers, and industry stakeholders as the research:
Highlighted the importance of structured stakeholder engagement, improved financial planning, and regulatory oversight in overcoming significant construction barriers.
Proposed practical strategies such as:
  • Implementing centralized communication platforms to enhance coordination and reduce misunderstandings.
  • Adopting value-based procurement models to optimize contractor selection and resource allocation.
  • Enhancing project-monitoring systems to ensure regulatory compliance and timely execution.
Encouraged continued collaboration, innovation, and policy improvements to achieve greater sustainability, resilience, and efficiency in the building industries of KSA and Ghana.
Supported national economic development by fostering better construction practices and improved infrastructure project outcomes.
Improved planning and compliance reduce waste; optimize energy use, and lower environmental impact. Additionally, better communication and stakeholder collaboration enhance labor productivity, equitable infrastructure access, and overall community well-being. By overcoming these barriers, KSA and Ghana’s construction sectors can achieve greater efficiency, resilience, and sustainability in urban development and infrastructure.
Despite its contributions, this study focuses exclusively on Ghana and KSA, limiting the generalizability of findings to other developing countries with different regulatory and economic environments. Additionally, while the study utilized RII analysis and correlation measures, it did not incorporate longitudinal data to assess how these barriers evolve. Future studies should aim to expand the geographical scope of this research by examining similar barriers in other developing countries across Africa, the Middle East, and Asia to enhance the external validity of the findings. Additionally, incorporating longitudinal studies can provide deeper insights into how construction barriers evolve and how mitigation strategies influences project performance in the long run. Moreover, further research should explore the intersection of construction project management with sustainability and digital innovation, particularly the adoption of BIM, automation, and AI-driven project-monitoring tools. Lastly, assessing the impact of economic fluctuations and policy reforms on project execution would provide a more comprehensive understanding of how financial and regulatory changes influence construction industry dynamics.

Author Contributions

Conceptualization, A.A.-O., M.S. and M.A.; Data curation, A.A.-O., P.A.B. and M.A.; Investigation, P.A.B.; Software, A.A.-O. and M.S.; Supervision, A.A. and P.A.B.; Writing—original draft, A.A.-O. and M.A.; Writing—review and editing, A.A., M.S. and P.A.B. All authors have read and agreed to the published version of the manuscript.

Funding

This research received no external funding.

Institutional Review Board Statement

An ethical review has been waived for this study. The key points are outlined below: 1. Purpose of the Questionnaire: The primary objective of the questionnaire is to gather professional insights and opinions related to barriers encountered in building projects only. 2. No Human Research Involvement: This study does not involve human subjects as defined by the IRB. The research does not engage in any intervention, experimentation, or manipulation of participants, which are typical criteria for human research oversight. 3. Anonymity and Privacy: The data collected through the questionnaire is entirely anonymized. No identifiable private information, such as names or personal details, is requested or recorded, ensuring the privacy and confidentiality of all participants. 4. Focus on Professional Expertise: The research emphasizes the professional expertise of respondents rather than personal behaviors or health outcomes. As such, it does not fit within the traditional framework of human-subject research. In conclusion, this questionnaire serves solely to collect data about building projects, without involving human research nor personal data as defined by regulatory standards.

Informed Consent Statement

Informed consent was obtained from all subjects involved in the study. Participants were informed that all data were treated as confidential and will be used for aca-demic purposes and recorded anonymously.

Data Availability Statement

The original contributions presented in this study are included in the article. Further inquiries can be directed to the corresponding authors.

Acknowledgments

The researchers are grateful to all the study participants.

Conflicts of Interest

The authors declare no conflicts of interest.

Appendix A. Survey Questionnaire Used to Collect the Data

  • Dear participants
As part of this research, our aim is to investigate barriers that hinder the success of Building Projects within the context of the developing countries Ghana and Saudi Arabia.
  • Section A. Background Information
  1. What is your job title?
    a. Project Manager
    b. Architect
    c. Quality Control
    d. Other (Specify)
      …………………………………………………….
  2. How many years of experience do you have?
    a. Less than 5 years
    b. 5 to 10 years
    c. 10 to 15 years
    d. 15 than 20 years
    e. More than 20 years
  3. What is the highest level of education?
    a. Diploma
    b. Bachelor Degree
    c. Master Degree
    d. Doctorate Degree
  4. What is the main role of your organisation?
    a. Main contractor
    b. Subcontractor
    c. Designer
    d. Developer
    e. End user
    f. Government
    g. Financial institution
    h. Consultant
    i. Other (specify)
      ………………………………………………………..
  5. Which country are you working in?
    a. Kingdom of Saudi Arabia
    b. Ghana
  6. Which sector do you mainly work in?
    a. Residential
    b. Commercial
    c. Infrastructure
    d. Others
      …………………………………………….

  • Section B:
Previous studies have identified factors that affect the success of construction projects (listed below). Please identify how strongly you agree or strongly disagree that the following factors hinder success of building performance.
CodeBARRIERS(1) Strongly Disagree (2) Disagree(3) Neutral(4) Agree(5) Strongly Agree
B1Climate-change resilience
B2Project cost and schedule
B3Culture awareness
B4Monitoring and evaluation of projects
B5Prompt material supply
B6Inter-stakeholder influence
B7Labor productivity
B8Poor communication
B9Financial problems
B10Lack of plant/equipment
B11Quality of workmanship
B12Building regulations
B13Safety regulations
B14Variation and error in design
Thank you for your participation.

References

  1. Razzaq, A.; Ajaz, T.; Li, J.C.; Irfan, M.; Suksatan, W. Investigating the asymmetric linkages between infrastructure development, green innovation, and consumption-based material footprint: Novel empirical estimations from highly resource-consuming economies. Resour. Policy 2021, 74, 102302. [Google Scholar] [CrossRef]
  2. Vrchota, J.; Řehoř, P.; Maříková, M.; Pech, M. Critical Success Factors of the Project Management in Relation to Industry 4.0 for Sustainability of Projects. Sustainability 2020, 13, 281. [Google Scholar] [CrossRef]
  3. Abbasnejad, B.; Nepal, M.P.; Ahankoob, A.; Nasirian, A.; Drogemuller, R. Building Information Modelling (BIM) adoption and implementation enablers in AEC firms: A systematic literature review. Archit. Eng. Des. Manag. 2021, 17, 411–433. [Google Scholar] [CrossRef]
  4. Singh, M.; Sharma, S.K. Critical Success Factors in Construction Projects. Int. J. Recent Technol. Eng. 2020, 8, 1799–1804. [Google Scholar] [CrossRef]
  5. Halawa, W.S.; Abdelalim, A.M.K.; Elrashed, I.A. Financial evaluation program for construction projects at the pre-investment phase in developing countries: A case study. Int. J. Proj. Manag. 2013, 31, 912–923. [Google Scholar] [CrossRef]
  6. Abdul-Rahman, H.; Takim, R.; Min, W.S. Financial-related causes contributing to project delays. J. Retail. Leis. Prop. 2009, 8, 225–238. [Google Scholar] [CrossRef]
  7. Yap, J.B.H.; Goay, P.L.; Woon, Y.B.; Skitmore, M. Revisiting critical delay factors for construction: Analysing projects in Malaysia. Alex. Eng. J. 2021, 60, 1717–1729. [Google Scholar] [CrossRef]
  8. Roshdi, F.R.; Ismail, K.; Lop, N.; Ab Wahab, L. Cost Overruns in Engineering Procurement Construction (EPC) Fabrication Oil and Gas Megaprojects in Malaysia: The Issues of Resource Allocation (5M). Int. J. Acad. Res. Bus. Soc. Sci. 2023, 13, 2627–2641. [Google Scholar] [CrossRef]
  9. Rehan, A.; Thorpe, D.; Heravi, A. Project success factors for leadership practices and communication: Challenges in the construction sector. Int. J. Manag. Proj. Bus. 2024, 17, 562–590. [Google Scholar] [CrossRef]
  10. Porras, L.G.; Heikkinen, A.; Kujala, J. Understanding stakeholder influence: Lessons from a controversial megaproject. Int. J. Hum. Resour. Dev. Manag. 2021, 21, 191. [Google Scholar] [CrossRef]
  11. Narum, K.B.; Engebø, A.; Lædre, O.; Torp, O. Collaborative Project Delivery With Early Contractor Involvement and Target Cost. In Proceedings of the 30th Annual Conference of the International Group for Lean Construction (IGLC), Edmonton, AB, Canada, 25–31 July 2022; pp. 984–995. [Google Scholar]
  12. Ibim, A.A.; Chijioke, A.K. Quality Control Compliance as an Environmental Response to Sustainability in the Nigerian Construction Industry. Asian Rev. Environ. Earth Sci. 2022, 9, 18–22. [Google Scholar] [CrossRef]
  13. Nyaga, B.; Hagir, H.; Alowo, R. An Investigation on Construction Project Development Planning Delays in South Africa. Buildings 2024, 14, 2963. [Google Scholar] [CrossRef]
  14. Alsuliman, J.A. Causes of delay in Saudi public construction projects. Alex. Eng. J. 2019, 58, 801–808. [Google Scholar] [CrossRef]
  15. Kissi, E.; Agyekum, K.; Baiden, B.K.; Tannor, R.A.; Asamoah, G.E.; Andam, E.T. Impact of project monitoring and evaluation practices on construction project success criteria in Ghana. Built Environ. Proj. Asset Manag. 2019, 9, 364–382. [Google Scholar] [CrossRef]
  16. Hussain, S.; Xuetong, W.; Hussain, T. Impact of Skilled and Unskilled Labor on Project Performance Using Structural Equation Modeling Approach. Sage Open 2020, 10, 2158244020914590. [Google Scholar] [CrossRef]
  17. Bamfo-Agyei, E.; Thwala, D.W.; Aigbavboa, C. Performance Improvement of Construction Workers to Achieve Better Productivity for Labour-Intensive Works. Buildings 2022, 12, 1593. [Google Scholar] [CrossRef]
  18. Akomah, B.B.; Ahinaquah, L.K.; Mustapha, Z. Skilled Labour Shortage in the Building Construction Industry Within the Central Region. Balt. J. Real Estate Econ. Constr. Manag. 2020, 8, 83–92. [Google Scholar] [CrossRef]
  19. Skiba, R. Promotion of Vocational Education and Training Career Pathways in the Australian Construction Industry. Int. J. Innov. Educ. Res. 2020, 8, 393–399. [Google Scholar] [CrossRef]
  20. Bizon-Gorecka, J.; Gorecki, J. Risk Management in Construction Project: Taking Sustainability into Account. In IOP Conference Series: Materials Science and Engineering; IPO Publishing: Bristol, UK, 2019; Volume 471, p. 112069. [Google Scholar] [CrossRef]
  21. Moazami, A.; Nik, V.M.; Carlucci, S.; Geving, S. Impacts of future weather data typology on building energy performance—Investigating long-term patterns of climate change and extreme weather conditions. Appl. Energy 2019, 238, 696–720. [Google Scholar] [CrossRef]
  22. Rady, M.; Kineber, A.F.; Hamed, M.M.; Daoud, A.O. Partial Least Squares Structural Equation Modeling of Constraint Factors Affecting Project Performance in the Egyptian Building Industry. Mathematics 2023, 11, 497. [Google Scholar] [CrossRef]
  23. Alenazi, E.; Adamu, Z.; Al-Otaibi, A. Exploring the Nature and Impact of Client-Related Delays on Contemporary Saudi Construction Projects. Buildings 2022, 12, 880. [Google Scholar] [CrossRef]
  24. Ofori, P.A.; Twumasi-Ampofo, K.; Danquah, J.A.; Osei-Tutu, E.; Osei-Tutu, S. Investigating Challenges in Financing Contractors for Public Sector Projects in Ghana. J. Build. Constr. Plan. Res. 2017, 5, 58–70. [Google Scholar] [CrossRef]
  25. Pour Rahimian, F.; Seyedzadeh, S.; Oliver, S.; Rodriguez, S.; Dawood, N. On-demand monitoring of construction projects through a game-like hybrid application of BIM and machine learning. Autom. Constr. 2020, 110, 103012. [Google Scholar] [CrossRef]
  26. AlGhamdi, A. Saudi Arabia Energy Report; King Abdullah Petroleum Studies and Research Center: Riyadh, Saudi Arabia, 2020. [Google Scholar] [CrossRef]
  27. Organization of the Petroleum Exporting Countries. Organization of the Petroleum Exporting Countries; OPEC: Vienna, Austria, 2020. [Google Scholar]
  28. Hijazi, R.A. Factors Hindering Quality Performance in Construction Projects: An Empirical Study. J. Manag. Res. 2021, 13, 70. [Google Scholar] [CrossRef]
  29. Carlgren, L.; BenMahmoud-Jouini, S. When cultures collide: What can we learn from frictions in the implementation of design thinking? J. Prod. Innov. Manag. 2022, 39, 44–65. [Google Scholar] [CrossRef]
  30. GlobalData. Future of Construction in the Middle East and Africa—Report Bundle (7 Reports); GlobalData UK Ltd.: London, UK, 2023; Available online: https://www.globaldata.com/store/report/future-of-construction-in-mea-bundle/ (accessed on 9 October 2023).
  31. African Development Bank. Ghana Economic Outlook; African Development Bank: Abidjan, Ivory Coast, 2023; Available online: https://www.afdb.org/en/countries/west-africa/ghana/ghana-economic-outlook (accessed on 9 October 2023).
  32. Rajkovich, N.B.; Okour, Y. Climate Change Resilience Strategies for the Building Sector: Examining Existing Domains of Resilience Utilized by Design Professionals. Sustainability 2019, 11, 2888. [Google Scholar] [CrossRef]
  33. Kalogeraki, M.; Antoniou, F. Current research trends into the effect of climate change on civil engineering infrastructures: A bibliometric review. In IOP Conference Series: Materials Science and Engineering; IPO Publishing: Bristol, UK, 2022; Volume 1123, p. 012037. [Google Scholar] [CrossRef]
  34. Hurlimann, A.C.; Warren-Myers, G.; Browne, G.R. Is the Australian construction industry prepared for climate change? Build. Environ. 2019, 153, 128–137. [Google Scholar] [CrossRef]
  35. Oruc, S.; Dikbas, H.A.; Gumus, B.; Yucel, I. The Impact of Climate Change on Construction Activity Performance. Buildings 2024, 14, 372. [Google Scholar] [CrossRef]
  36. Flyvbjerg, B.; Skamris Holm, M.K.; Buhl, S.L. How common and how large are cost overruns in transport infrastructure projects? Transp. Rev. 2003, 23, 71–88. [Google Scholar] [CrossRef]
  37. Amini, S.; Rezvani, A.; Tabassi, M.; Malek Sadati, S.S. Causes of cost overruns in building construction projects in Asian countries; Iran as a case study. Eng. Constr. Archit. Manag. 2023, 30, 2739–2766. [Google Scholar] [CrossRef]
  38. Dosumu, O.S.; Aigbavboa, C.O. Impact of Design Errors on Variation Cost of Selected Building Project in Nigeria. Procedia Eng. 2017, 196, 847–856. [Google Scholar] [CrossRef]
  39. Begum, R.A.; Siwar, C.; Pereira, J.J.; Jaafar, A.H. A benefit–cost analysis on the economic feasibility of construction waste minimisation: The case of Malaysia. Resour. Conserv. Recycl. 2006, 48, 86–98. [Google Scholar] [CrossRef]
  40. Ochieng, E.G.; Price, A.D.F. Managing cross-cultural communication in multicultural construction project teams: The case of Kenya and UK. Int. J. Proj. Manag. 2010, 28, 449–460. [Google Scholar] [CrossRef]
  41. Barthorpe, S.; Duncan, R.; Miller, C. The pluralistic facets of culture and its impact on construction. Prop. Manag. 2000, 18, 335–351. [Google Scholar] [CrossRef]
  42. Chevrier, S. Cross-cultural management in multinational project groups. J. World Bus. 2003, 38, 141–149. [Google Scholar] [CrossRef]
  43. Ika, L.A.; Diallo, A.; Thuillier, D. Critical success factors for World Bank projects: An empirical investigation. Int. J. Proj. Manag. 2012, 30, 105–116. [Google Scholar] [CrossRef]
  44. Yamin, M.; Sim, A.K.S. Critical success factors for international development projects in Maldives: Project teams’ perspective. Int. J. Manag. Proj. Bus. 2016, 9, 481–504. [Google Scholar] [CrossRef]
  45. Eilar, D.K. Noise monitoring, control, and compliance practices at several construction sites in Southern California. J. Acoust. Soc. Am. 2000, 108 (Suppl. S5), 2525. [Google Scholar] [CrossRef]
  46. Sitota, B.; Quezon, E.T.; Ararsa, W. Assessment on Materials Quality Control Implementation of Building Construction Projects and Workmanship: A Case Study of Ambo University. SSRN Electron. J. 2021, 15, 3901438. [Google Scholar] [CrossRef]
  47. Eze, E.C.; Ugulu, R.A.; Onyeagam, O.P.; Adegboyega, A.A. Determinants of sustainable building materials (SBM) selection on construction projects. Int. J. Constr. Supply Chain. Manag. 2021, 11, 166–194. [Google Scholar] [CrossRef]
  48. Ahmeti, E.; Kruja, A.D. Challenges and Perspectives of Supply Chain Management in Emerging Markets: A Case Study Approach. In Advances in Logistics, Operations, and Management Science; Dwivedi, A., Alshamrani, M.S., Eds.; IGI Global: Hershey, PA, USA, 2020; pp. 132–146. ISBN 978-1-79982-867-9. [Google Scholar]
  49. Qian, Y.; Yu, X.-A.; Shen, Z.; Song, M. Complexity analysis and control of game behavior of subjects in green building materials supply chain considering technology subsidies. Expert Syst. Appl. 2023, 214, 119052. [Google Scholar] [CrossRef]
  50. McDermotti, P.; Khalfan, M. Achieving Supply Chain Integration within Construction Industry. Constr. Econ. Build. 2012, 6, 44–54. [Google Scholar] [CrossRef]
  51. Aaltonen, K.; Kujala, J. A project lifecycle perspective on stakeholder influence strategies in global projects. Scand. J. Manag. 2010, 26, 381–397. [Google Scholar] [CrossRef]
  52. Sedhom, I.; Khodeir, L.M.; Fathy, F. Investigating current practices for achieving effective participation of stakeholders in Facilities Management. Ain Shams Eng. J. 2023, 14, 102099. [Google Scholar] [CrossRef]
  53. Zou, P.; Zhang, G. Managing risks in construction projects: Life cycle and stakeholder perspectives. Int. J. Constr. Manag. 2010, 9, 61–77. [Google Scholar] [CrossRef]
  54. Toan, N.Q.; Van Tam, N.; Diep, T.N.; Anh, P.X. Adoption of Building Information Modeling in the Construction Project Life Cycle: Benefits for Stakeholders. Archit. Eng. 2022, 7, 56–71. [Google Scholar] [CrossRef]
  55. Manoharan, K.; Dissanayake, P.; Pathirana, C.; Deegahawature, D.; Silva, R. A systematic evaluation on the competencies of construction supervisors in productivity and performance improvement practices—Sri Lankan perspective. Smart Sustain. Built Environ. 2024, 13, 960–988. [Google Scholar] [CrossRef]
  56. Fashina, A.A.; Omar, M.A.; Sheikh, A.A.; Fakunle, F.F. Exploring the significant factors that influence delays in construction projects in Hargeisa. Heliyon 2021, 7, e06826. [Google Scholar] [CrossRef]
  57. Sanni-Anibire, M.O.; Mohamad Zin, R.; Olatunji, S.O. Causes of delay in the global construction industry: A meta analytical review. Int. J. Constr. Manag. 2022, 22, 1395–1407. [Google Scholar] [CrossRef]
  58. Dainty, A.; Moore, D.; Murray, M. Communication in Construction: Theory and Practice; Routledge: Abingdon, UK, 2007; ISBN 978-0-203-35864-1. [Google Scholar]
  59. Cheng, M.-Y.; Hoang, N.-D. Evaluating contractor financial status using a hybrid fuzzy instance based classifier: Case study in the construction industry. IEEE Trans. Eng. Manag. 2015, 62, 184–192. [Google Scholar] [CrossRef]
  60. Elghaish, F.; Abrishami, S.; Hosseini, M.R. Integrated project delivery with blockchain: An automated financial system. Autom. Constr. 2020, 114, 103182. [Google Scholar] [CrossRef]
  61. Elghaish, F.; Pour Rahimian, F.; Hosseini, M.R.; Edwards, D.; Shelbourn, M. Financial management of construction projects: Hyperledger fabric and chaincode solutions. Autom. Constr. 2022, 137, 104185. [Google Scholar] [CrossRef]
  62. Ibrahim, R.; Harby, A.A.; Nashwan, M.S.; Elhakeem, A. Financial Contract Administration in Construction via Cryptocurrency Blockchain and Smart Contract: A Proof of Concept. Buildings 2022, 12, 1072. [Google Scholar] [CrossRef]
  63. Chandra, S.S.; Sepasgozar, S.M.E.; Kumar, V.R.P.; Singh, A.K.; Krishnaraj, L.; Awuzie, B.O. Assessing Factors Affecting Construction Equipment Productivity Using Structural Equation Modeling. Buildings 2023, 13, 502. [Google Scholar] [CrossRef]
  64. Santoso, D.S.; Gallage, P.G.M.P. Critical factors affecting the performance of large construction projects in developing countries: A case study of Sri Lanka. J. Eng. Des. Technol. 2019, 18, 531–556. [Google Scholar] [CrossRef]
  65. Arashpour, M.; Kamat, V.; Heidarpour, A.; Hosseini, M.R.; Gill, P. Computer vision for anatomical analysis of equipment in civil infrastructure projects: Theorizing the development of regression-based deep neural networks. Autom. Constr. 2022, 137, 104193. [Google Scholar] [CrossRef]
  66. Kwon, N.; Song, K.; Lee, H.-S.; Kim, J.; Park, M. Construction Noise Risk Assessment Model Focusing on Construction Equipment. J. Constr. Eng. Manag. 2018, 144, 04018034. [Google Scholar] [CrossRef]
  67. Yin, G.; Ding, J.; Tiyip, T.; Amuti, T.; Meng, X.; Wang, J.; Cai, S.; Tian, Y.; Yang, M.; Wu, H. Environment Noise Caused by Equipment in Construction Sites in Developing Countries. J. Residuals Sci. Technol. 2017, 14, 191. [Google Scholar]
  68. Sepasgozar, S.M.E.; Davis, S.; Loosemore, M.; Bernold, L. An investigation of modern building equipment technology adoption in the Australian construction industry. Eng. Constr. Archit. Manag. 2018, 25, 1075–1091. [Google Scholar] [CrossRef]
  69. Roberts, D.; Golparvar-Fard, M. End-to-end vision-based detection, tracking and activity analysis of earthmoving equipment filmed at ground level. Autom. Constr. 2019, 105, 102811. [Google Scholar] [CrossRef]
  70. Azmi, N.A.; Sweis, G.; Sweis, R.; Sammour, F. Exploring Blockchain-enabled smart contracts technology implementation within ready-mixed concrete plants industry in Saudi Arabia. Int. J. Constr. Manag. 2023, 23, 2400–2408. [Google Scholar] [CrossRef]
  71. Yildiz, A.E.; Dikmen, I.; Birgonul, M.T.; Ercoskun, K.; Alten, S. A knowledge-based risk mapping tool for cost estimation of international construction projects. Autom. Constr. 2014, 43, 144–155. [Google Scholar] [CrossRef]
  72. Odhiambo, O.W.; Cheruiyot, C.; Winja, M.M.O. Impact of Regulatory Framework on Performance of Building Construction Processes In Kenya. A Case Study of Murang’a County. Int. J. Eng. Res. Technol. 2022, 11. [Google Scholar] [CrossRef]
  73. Ahmed Ali, K.; Ahmad, M.I.; Yusup, Y. Issues, Impacts, and Mitigations of Carbon Dioxide Emissions in the Building Sector. Sustainability 2020, 12, 7427. [Google Scholar] [CrossRef]
  74. He, Q.; Wang, Z.; Wang, G.; Zuo, J.; Wu, G.; Liu, B. To be green or not to be: How environmental regulations shape contractor greenwashing behaviors in construction projects. Sustain. Cities Soc. 2020, 63, 102462. [Google Scholar] [CrossRef]
  75. Parveen, R. Artificial intelligence in construction industry: Legal issues and regulatory challenges. Int. J. Civ. Eng. Technol. 2018, 9, 957–962. [Google Scholar]
  76. Khalid, U.; Sagoo, A.; Benachir, M. Safety Management System (SMS) framework development—Mitigating the critical safety factors affecting Health and Safety performance in construction projects. Saf. Sci. 2021, 143, 105402. [Google Scholar] [CrossRef]
  77. Okpala, I.; Nnaji, C.; Karakhan, A.A. Utilizing Emerging Technologies for Construction Safety Risk Mitigation. Pract. Period. Struct. Des. Constr. 2020, 25, 04020002. [Google Scholar] [CrossRef]
  78. Ahmadisheykhsarmast, S.; Aminbakhsh, S.; Sonmez, R.; Uysal, F. A transformative solution for construction safety: Blockchain-based system for accident information management. J. Ind. Inf. Integr. 2023, 35, 100491. [Google Scholar] [CrossRef]
  79. O’Neill, C.; Gopaldasani, V.; Coman, R. Factors that influence the effective use of safe work method statements for high-risk construction work in Australia—A literature review. Saf. Sci. 2022, 147, 105628. [Google Scholar] [CrossRef]
  80. Hwang, S.; Choi, M. Integrative building safety evaluation to mitigate disaster risks: A case study on public-use buildings in Seoul. J. Asian Archit. Build. Eng. 2024, 1–15. [Google Scholar] [CrossRef]
  81. Guan, L.; Abbasi, A.; Ryan, M.J. Analyzing green building project risk interdependencies using Interpretive Structural Modeling. J. Clean. Prod. 2020, 256, 120372. [Google Scholar] [CrossRef]
  82. Altwassi, E.J.; Aysu, E.; Ercoskun, K.; Abu Raed, A. From Design to Management: Exploring BIM’s Role across Project Lifecycles, Dimensions, Data, and Uses, with Emphasis on Facility Management. Buildings 2024, 14, 611. [Google Scholar] [CrossRef]
  83. He, R.; Li, M.; Gan, V.J.L.; Ma, J. BIM-enabled computerized design and digital fabrication of industrialized buildings: A case study. J. Clean. Prod. 2021, 278, 123505. [Google Scholar] [CrossRef]
  84. Gunhan, S. Factors Affecting International Contractors’ Performance in the 21st Century. Pract. Period. Struct. Des. Constr. 2020, 25, 05020011. [Google Scholar] [CrossRef]
  85. Caetano, I.; Santos, L.; Leitão, A. Computational design in architecture: Defining parametric, generative, and algorithmic design. Front. Archit. Res. 2020, 9, 287–300. [Google Scholar] [CrossRef]
  86. Taherdoost, H. A Review on Risk Management in Information Systems: Risk Policy, Control and Fraud Detection. Electronics 2021, 10, 3065. [Google Scholar] [CrossRef]
  87. Alotaibi, A.; Edum-Fotwe, F.; Price, A.D.F. Critical Barriers to Social Responsibility Implementation within Mega-Construction Projects: The Case of the Kingdom of Saudi Arabia. Sustainability 2019, 11, 1755. [Google Scholar] [CrossRef]
  88. Yap, J.B.H.; Chow, I.N.; Shavarebi, K. Criticality of Construction Industry Problems in Developing Countries: Analyzing Malaysian Projects. J. Manage. Eng. 2019, 35, 04019020. [Google Scholar] [CrossRef]
  89. Al-Sedairy, S.T. A change management model for Saudi construction industry. Int. J. Proj. Manag. 2001, 19, 161–169. [Google Scholar] [CrossRef]
  90. Assaf, S.A.; Al-Hejji, S. Causes of delay in large construction projects. Int. J. Proj. Manag. 2006, 24, 349–357. [Google Scholar] [CrossRef]
  91. George, D.; Mallery, P. SPSS for Windows Step-by-Step: A Simple Guide and Reference, Version 14.0, 7th ed.; Pearson: London, UK, 2011; Available online: https://www.amazon.com/SPSS-Windows-Step-Step-Reference/dp/0205515851 (accessed on 25 November 2024).
  92. Al-Otaibi, A.; Bowan, P.A.; Abdel Daiem, M.M.; Said, N.; Ebohon, J.O.; Alabdullatief, A.; Al-Enazi, E.; Watts, G. Identifying the Barriers to Sustainable Management of Construction and Demolition Waste in Developed and Developing Countries. Sustainability 2022, 14, 7532. [Google Scholar] [CrossRef]
  93. Mahamid, I. Factors contributing to poor performance in construction projects: Studies of Saudi Arabia. Aust. J. Multi-Discip. Eng. 2016, 12, 27–38. [Google Scholar] [CrossRef]
  94. Ikediashi, D.I.; Ansa, O.A.; Ujene, A.O.; Akoh, S.R. Barriers to BIM for facilities management adoption in Nigeria: A multivariate analysis. Int. J. Build. Pathol. Adapt. 2022. [Google Scholar] [CrossRef]
  95. Mathar, H.; Assaf, S.; Hassanain, M.A.; Abdallah, A.; Sayed, A.M.Z. Critical success factors for large building construction projects: Perception of consultants and contractors. Built Environ. Proj. Asset Manag. 2020, 10, 349–367. [Google Scholar] [CrossRef]
  96. Alragabah, Y.A.; Ahmed, M. Impact assessment of critical success factors (CSFs) in public construction projects of Saudi Arabia. Front. Eng. Built Environ. 2024, 4, 184–195. [Google Scholar] [CrossRef]
  97. Osei-Kyei, R.; Chan, A.P.C. Comparative Analysis of the Success Criteria for Public–Private Partnership Projects in Ghana and Hong Kong. Proj. Manag. J. 2017, 48, 80–92. [Google Scholar] [CrossRef]
  98. Nguyen, T.A.; Chovichien, V. A Practical List of Criteria For Evaluating Construction Project Success in Developing Countries. ASEAN Eng. J. 2013, 3, 21–41. [Google Scholar] [CrossRef]
  99. Gunduz, M.; Yahya, A.M.A. Analysis of project success factors in construction industry. Technol. Econ. Dev. Econ. 2015, 24, 67–80. [Google Scholar] [CrossRef]
  100. Adinyira, E.; Botchway, E.; Kwofie, T.E. Determining Critical Project Success Criteria for Public Housing Building Projects (PHBPS) in Ghana. Eng. Manag. Res. 2012, 1, 122. [Google Scholar] [CrossRef]
  101. Alshihri, S.; Al-Gahtani, K.; Almohsen, A. Risk Factors That Lead to Time and Cost Overruns of Building Projects in Saudi Arabia. Buildings 2022, 12, 902. [Google Scholar] [CrossRef]
  102. Giri, O.P. Perception-Based Assessment of the Factors Causing Delays in Construction Projects. Engineering 2023, 15, 431–445. [Google Scholar] [CrossRef]
  103. Ahmed, A.M.; Sayed, W.; Asran, A.; Nosier, I. Identifying barriers to the implementation and development of sustainable construction. Int. J. Constr. Manag. 2023, 23, 1277–1288. [Google Scholar] [CrossRef]
  104. Almarri, K.; Abu-Hijleh, B. Critical Success Factors for Public Private Partnerships in the UAE Construction Industry—A Comparative Analysis between the UAE and the UK. J. Eng. Proj. Prod. Manag. 2017, 7, 21–32. [Google Scholar] [CrossRef]
  105. Alashwal, A.M.; Fareed, N.F.; Al-obaidi, K.M. Determining Success Criteria and Success Factors for International Construction Projects for Malaysian Contractors. Constr. Econ. Build. 2017, 17, 62–80. [Google Scholar] [CrossRef]
  106. Muhammad, Z.; Johar, F. Critical success factors of public–private partnership projects: A comparative analysis of the housing sector between Malaysia and Nigeria. Int. J. Constr. Manag. 2019, 19, 257–269. [Google Scholar] [CrossRef]
  107. Pheng Low, S.; Gao, S.; Lin Tay, W. Comparative study of project management and critical success factors of greening new and existing buildings in Singapore. Struct. Surv. 2014, 32, 413–433. [Google Scholar] [CrossRef]
  108. Al-Tmeemy, S.M.H.M.; Abdul-Rahman, H.; Harun, Z. Future criteria for success of building projects in Malaysia. Int. J. Proj. Manag. 2011, 29, 337–348. [Google Scholar] [CrossRef]
  109. Duy Nguyen, L.; Ogunlana, S.O.; Thi Xuan Lan, D. A study on project success factors in large construction projects in Vietnam. Eng. Constr. Archit. Manag. 2004, 11, 404–413. [Google Scholar] [CrossRef]
Figure 1. Main common barriers to building and construction project performance.
Figure 1. Main common barriers to building and construction project performance.
Sustainability 17 03539 g001
Figure 2. Research process.
Figure 2. Research process.
Sustainability 17 03539 g002
Table 1. Project performance barriers mapped against key references.
Table 1. Project performance barriers mapped against key references.
CodeBarrierSource(s)
B1Climate-change resilience[21,32,33,34,35]
B2Project cost and schedule[7,8,11,14,36,37,38,39]
B3Cultural awareness[29,40,41,42]
B4Monitoring and evaluation of projects[15,25,43,44,45]
B5Prompt material supply[46,47,48,49,50]
B6Inter-stakeholder influence[10,22,51,52,53,54]
B7Labor productivity[16,17,55]
B8Poor communication[7,9,37,40,56,57,58]
B9Financial problems[6,7,59,60,61,62]
B10Lack of plant/equipment[63,64,65,66,67,68,69,70]
B11Quality of workmanship[28,46,71]
B12Building regulations[72,73,74,75]
B13Safety regulations[76,77,78,79,80]
B14Variation and error in design[38,81,82,83,84,85]
Table 2. Project performance barriers in building and construction projects.
Table 2. Project performance barriers in building and construction projects.
CodeBarrierDescription
Project Management and Planning Issues
B2Project cost and scheduleCost overruns and schedule delays arise from poor budgeting, inaccurate forecasting, and inefficient project management practices [37,56].
B4Monitoring and evaluation of projectsEffective monitoring and evaluation are critical to project success, ensuring adherence to timelines, objectives, work quality, and budgets [25].
B5Prompt material supplyTimely procurement and supply of construction materials are crucial, as materials account for approximately 60% of the total project budget [46].
B10Lack of plant/equipmentInsufficient equipment availability reduces productivity and project inefficiencies [63,64].
Human and Organizational Factors
B3Cultural awarenessCultural differences influence communication, work ethics, and decision making, impacting project collaboration and stakeholder engagement.
B6Inter-stakeholder influenceStakeholder involvement contributes to project success by leveraging industry expertise, past experiences, and decision-making insights [10,22].
B7Labor productivityWorker productivity is key to construction success, affecting profitability, competitiveness, and project timelines [17].
B8Poor communicationCommunication failures lead to project delays, misunderstandings, and lack of awareness, impacting project outcomes [37,56,57].
Financial and Economic Constraints
B9Financial problemsCash-flow issues, late payments, and unstable financial markets cause project delays and disruptions [7].
Regulatory and Safety Compliance
B12Building regulationsRegulations ensure safety and structural integrity but can delay projects if compliance is not met [72,73].
B13Safety regulationsEnforcing safety protocols reduces onsite accidents, improves worker productivity, and enhances project efficiency [76,77].
Design and Construction Issues
B1Climate-change resilienceClimate change impacts construction projects by affecting material durability, site conditions, and resource availability, requiring adaptive strategies to mitigate risks.
B11Quality of workmanshipPoor workmanship affects building durability, serviceability, and aesthetics, increasing maintenance costs and project risk [28].
B14Variation and error in designErrors in architectural design contribute to cost overruns, safety risks, and project delays, with variations accounting for up to 36% of budget increases [26,81].
Table 3. Responses to the questionnaire survey.
Table 3. Responses to the questionnaire survey.
NoMain InformationNumberPercent (%)Comments
1Distributed150100
2Received11577
3Accepted9865Ghana: 50, KSA: 48
4Excluded1711Incomplete or invalid responses
Table 4. Respondents’ characteristics.
Table 4. Respondents’ characteristics.
Respondents’ CharacteristicsFrequency (n = 98)Percentage
Type of organization
Contractor2929.7%
Consultant4343.8%
Client2626.5%
Working Experience
5–10 years3737.9%
10–15 years2020.4%
15–20 years1717.3%
More than 20 years2424.4%
Education
Diploma1313.2%
Bachelor4444.8%
Master3333.6%
Ph.D.88.4%
Type of Sector
Infrastructure4646.9%
Commercial Building1818.3%
Residential2424.4%
Utility1010.4%
Table 5. Relative Importance Index (RII) for both countries with ranking.
Table 5. Relative Importance Index (RII) for both countries with ranking.
CodeBarrierKSAGhana
RIIRanking RIIRanking
B1Climate-change resilience0.69290.7367
B2Project cost and schedule0.76740.8441
B3Cultural awareness0.675100.62411
B4Monitoring and evaluation of projects0.78330.7885
B5Prompt material supply0.72970.7726
B6Inter-stakeholder influence0.76740.7924
B7Labor productivity0.617130.612
B8Poor communication0.82910.8322
B9Financial problems0.74650.8123
B10Lack of plant/equipment0.71780.785
B11Quality of workmanship0.74260.7885
B12Building regulations0.642110.7169
B13Safety regulations0.621120.70810
B14Variation and error in design0.79220.7248
Table 6. Relative Importance Index (RII) for both countries combined.
Table 6. Relative Importance Index (RII) for both countries combined.
CodeBarrierRIIRank
B1Climate-change resilience0.7149
B2Project cost and schedule0.8062
B3Cultural awareness0.64912
B4Monitoring and evaluation of projects0.7863
B5Prompt material supply0.7517
B6Inter-stakeholder influence0.7804
B7Labor productivity0.60813
B8Poor communication0.8311
B9Financial problems0.7804
B10Lack of plant/equipment0.7498
B11Quality of workmanship0.7655
B12Building regulations0.68010
B13Safety regulations0.66511
B14Variation and error in design0.7576
Table 7. Spearman’s correlation analysis for the 14 identified barriers.
Table 7. Spearman’s correlation analysis for the 14 identified barriers.
Barriers B1B2B3B4B5B6B7B8B9B10B11B12B13B14
B1—Climate-change resilienceCorr10.281 **0.221 *0.1640.1910.1610.276 **0.1160.205 *0.217 *0.1320.1070.271 **0.179
p-value.0.0050.0290.1060.0590.1130.0060.2560.0430.0320.1950.2920.0070.077
B2—Project cost and scheduleCorr0.281 **10.223 *0.209 *0.350 **0.250 *0.211 *0.1850.291 **0.262 **0.208 *0.1690.202 *0.162
p-value0.005.0.0270.039<0.0010.0130.0370.0680.0040.0090.040.0970.0470.11
B3—Cultural awarenessCorr0.221 *0.223 *10.224 *0.1720.1360.297 **0.0820.220 *0.1020.150.303 **0.1910.239 *
p-value0.0290.027.0.0260.0910.1820.0030.4220.030.3160.1410.0020.060.018
B4—Monitoring and evaluation of projectsCorr0.1640.209 *0.224 *10.455 **0.424 **0.240 *0.330 **0.0590.378 **0.327 **0.004−0.0120.439 **
p-value0.1060.0390.026.<0.001<0.0010.017<0.0010.565<0.0010.0010.970.908<0.001
B5—Prompt material supplyCorr0.1910.350 **0.1720.455 **10.434 **0.445 **0.328 **0.327 **0.420 **.449 **0.1580.0450.372 **
p-value0.059<0.0010.091<0.001.<0.001<0.001<0.0010.001<0.001<.0010.1210.66<0.001
B6—Inter-stakeholder influenceCorr0.1610.250 *0.1360.424 **0.434 **10.297 **0.500 **0.254 *0.293 **0.352 **0.018−0.0870.423 **
p-value0.1130.0130.182<0.001<0.001.0.003<0.0010.0120.003<0.0010.860.397<0.001
B7—Labor productivityCorr0.276 **0.211 *0.297 **0.240 *0.445 **0.297 **10.241 *0.308 **0.342**0.275 **0.328 **0.250 *0.354 **
p-value0.0060.0370.0030.017<0.0010.003.0.0170.002<.0010.006<0.0010.013<0.001
B8—Poor communicationCorr0.1160.1850.0820.330 **0.328 **0.500 **0.241 *10.341 **0.365 **0.341 **0.1120.0930.288 **
p-value0.2560.0680.422<0.001<0.001<0.0010.017.<0.001<0.001<0.0010.2720.3610.004
B9—Financial problemsCorr0.205 *0.291 **0.220 *0.0590.327 **0.254 *0.308 **0.341 **10.296 **0.1960.261 **0.140.146
p-value0.0430.0040.030.5650.0010.0120.002<0.001.0.0030.0530.010.170.153
B10—Lack of plant/equipmentCorr0.217 *0.262 **0.1020.378 **0.420 **0.293 **0.342 **0.365 **0.296 **10.411 **0.1550.0850.277 **
p-value0.0320.0090.316<.001<0.0010.003<0.001<.0010.003.<0.0010.1290.4080.006
B11—Quality of workmanshipCorr0.1320.208 *0.150.327 **0.449 **0.352 **0.275 **0.341 **0.1960.411 **10.02−0.1590.295 **
p-value0.1950.040.1410.001<0.001<.0010.006<.0010.053<0.001.0.8480.1180.003
B12—Building regulationsCorr0.1070.1690.303 **0.0040.1580.0180.328 **0.1120.261 **0.1550.0210.603 **0.246*
p-value0.2920.0970.0020.970.1210.86<0.0010.2720.010.1290.848.<0.0010.015
B13—Safety regulationsCorr0.271 **0.202 *0.191−0.0120.045−0.0870.250 *0.0930.140.085−0.1590.603 **1−0.04
p-value0.0070.0470.060.9080.660.3970.0130.3610.170.4080.118<0.001.0.696
B14—Variation and error in designCorr0.1790.1620.239 *0.439 **0.372 **0.423 **0.354 **0.288 **0.1460.277 **0.295 **0.246 *−0.041
p-value0.0770.110.018<0.001<0.001<0.001<0.0010.0040.1530.0060.0030.0150.696.
* Correlation is significant at the 0.05 level (2-tailed); ** Correlation is significant at the 0.01 level (2-tailed).
Table 8. Comparative analysis of key barriers.
Table 8. Comparative analysis of key barriers.
BarrierRanking in KSARanking in GhanaContextual Factors Influencing the RankingsProposed Mitigation Strategies
Poor communication (B8)1st2ndPoor communication is a dominant issue in both countries, often due to a lack of structured coordination, stakeholder misalignment, and inefficient reporting mechanisms.Implement centralized project communication platforms, stakeholder engagement frameworks, and standardized documentation practices.
Project cost and schedule constraints (B2)4th1stIt is more severe in Ghana due to economic instability, fluctuating material costs, and financing challenges. KSA benefits from more substantial financial infrastructure but still faces budgeting challenges.Develop flexible cost-estimation models, risk management frameworks, and contingency planning for cost control.
Variation and error in design (B14)2nd8thFrequent design modifications and evolving regulatory standards in KSA contribute to a high ranking. Ghana’s ranking is lower, likely due to more straightforward project scopes.Implement BIM, automated design validation, and real-time stakeholder feedback mechanisms.
Monitoring and evaluation of projects (B4)3rd5thStrong regulatory oversight in KSA increases the importance of monitoring, while in Ghana, resource limitations hinder evaluation effectiveness.Strengthen real-time performance tracking systems, compliance audits, and standardized reporting mechanisms.
Financial problems (B9)5th3rdGhana faces more significant financial constraints due to limited access to credit and high borrowing costs, whereas KSA has better financial backing but still faces cash-flow issues.Promote public–private partnerships (PPPs), improve payment schedules, and establish financial risk management strategies.
Lack of plant/equipment (B10)8th5thThis is more significant in Ghana due to limited resources and reliance on imported machinery. KSA has better infrastructure but still experiences procurement delays.Strengthen local supply chains, introduce leasing options for equipment, and improve procurement planning.
Building regulations (B12)11th9thGhana faces enforcement issues, while KSA’s complex regulatory environment causes administrative delays.Streamline regulatory approval processes, improve policy enforcement, and enhance training for compliance officers.
Labor productivity (B7)13th12thLabor-intensive projects in Ghana rely more on manual work, whereas KSA’s construction industry is more mechanized.Invest in worker training programs, integrate automation where
feasible, and improve site management practices.
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Al-Otaibi, A.; Bowan, P.A.; Alabdullatief, A.; Albaiz, M.; Salah, M. Barriers to Sustainable Building Project Performance in Developing Countries: A Case of Ghana and the Kingdom of Saudi Arabia. Sustainability 2025, 17, 3539. https://doi.org/10.3390/su17083539

AMA Style

Al-Otaibi A, Bowan PA, Alabdullatief A, Albaiz M, Salah M. Barriers to Sustainable Building Project Performance in Developing Countries: A Case of Ghana and the Kingdom of Saudi Arabia. Sustainability. 2025; 17(8):3539. https://doi.org/10.3390/su17083539

Chicago/Turabian Style

Al-Otaibi, Ali, Patrick Aaniamenga Bowan, Aasem Alabdullatief, Majd Albaiz, and Mona Salah. 2025. "Barriers to Sustainable Building Project Performance in Developing Countries: A Case of Ghana and the Kingdom of Saudi Arabia" Sustainability 17, no. 8: 3539. https://doi.org/10.3390/su17083539

APA Style

Al-Otaibi, A., Bowan, P. A., Alabdullatief, A., Albaiz, M., & Salah, M. (2025). Barriers to Sustainable Building Project Performance in Developing Countries: A Case of Ghana and the Kingdom of Saudi Arabia. Sustainability, 17(8), 3539. https://doi.org/10.3390/su17083539

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
