A Case Study of a Negotiated Tender within a Small-to-Medium Construction Contractor: Modelling Project Cost Variance
Abstract
:1. Introduction

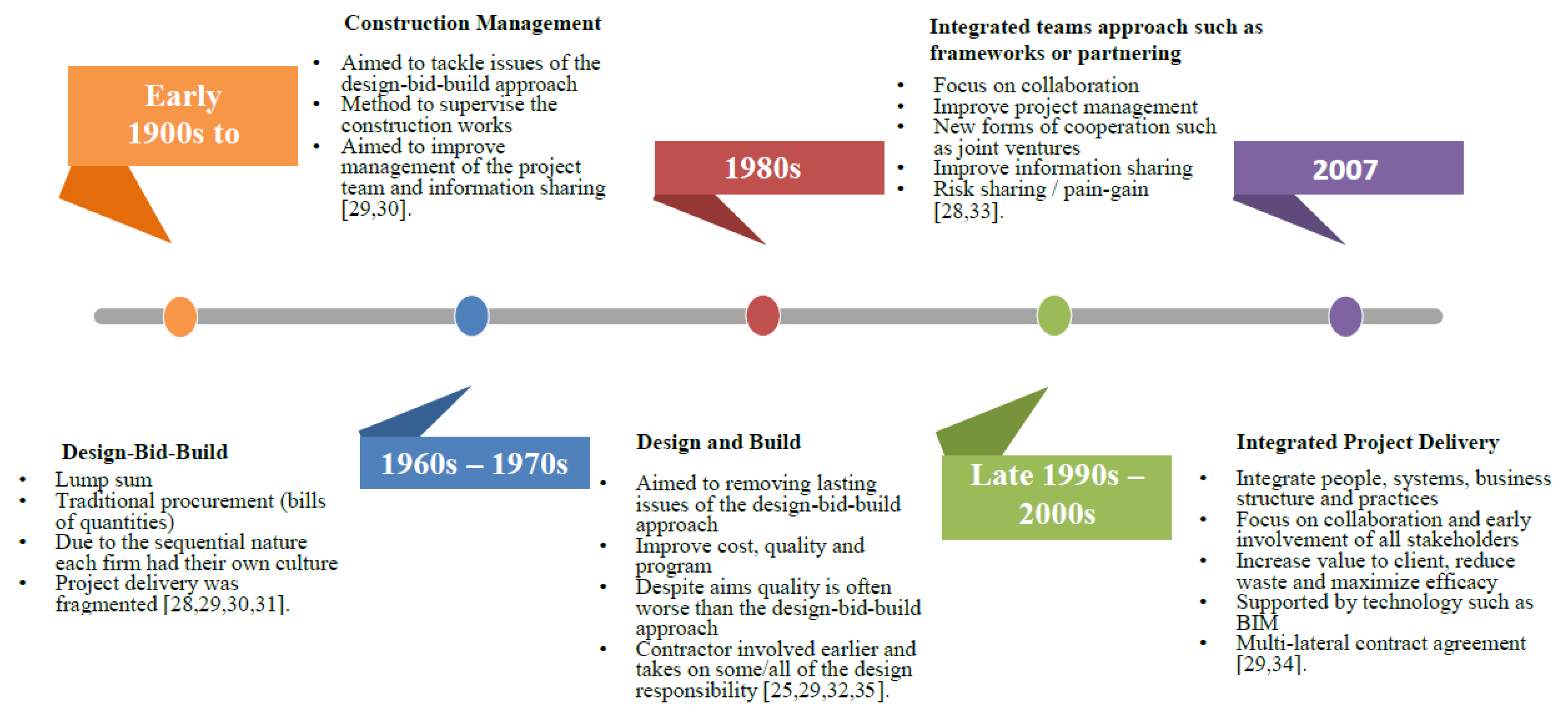

2. Procurement and Tendering in the UK Construction Industry: A Review
3. Preferred Tendering and Procurement Routes
4. Strategic Pricing Pre-Contract and Change Orders Post-Contract
5. The Need for Change

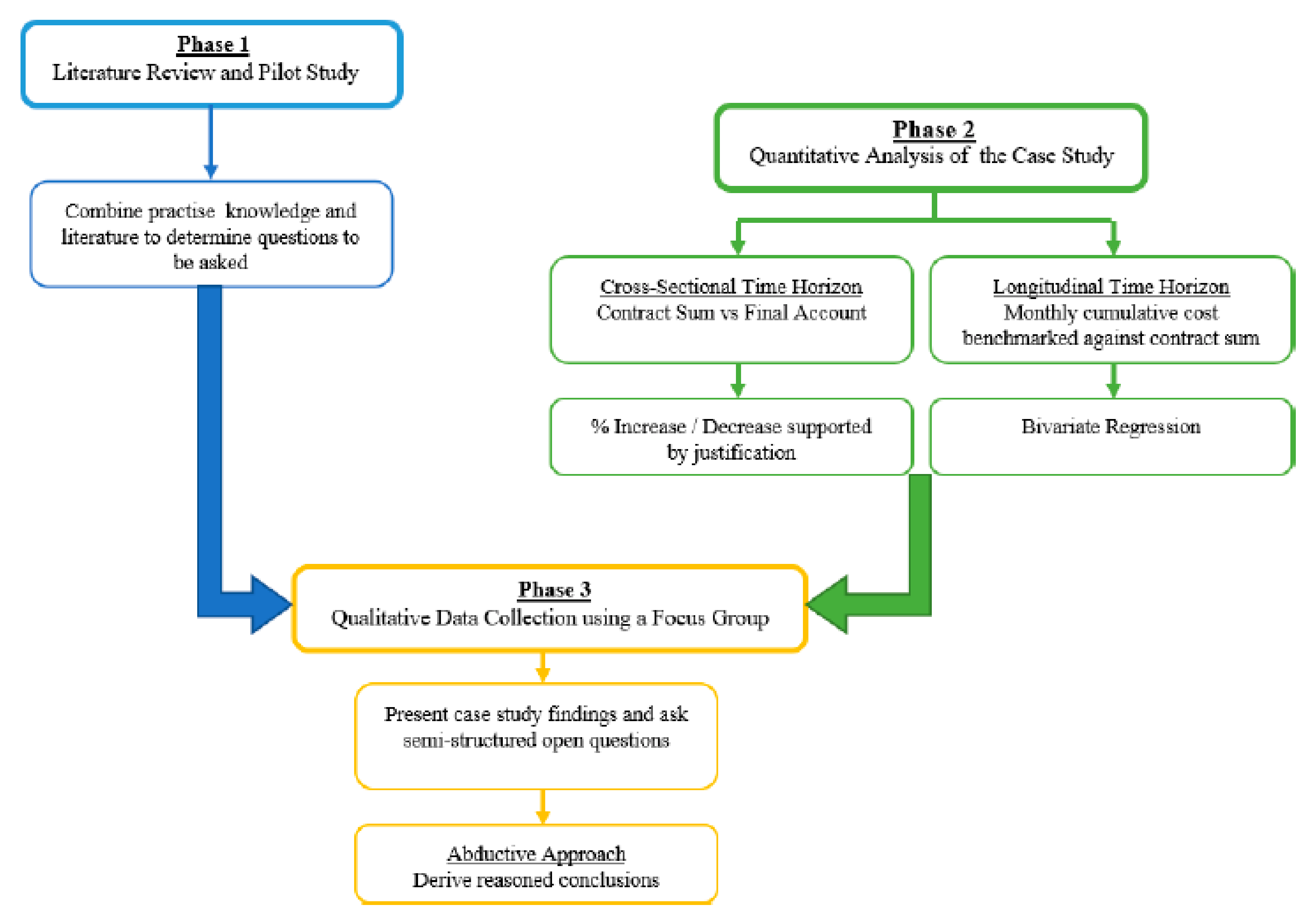

6. Research Methodology
7. Analysis
7.1. Cross-Sectional Time Horizon (Based on Table 3)
7.2. Cross-Sectional Time Horizon (Based on Table 4)
7.3. Longitudinal Time Horizon (Based on Table 3)
7.4. Longitudinal Time Horizon (Based on Table 4)
8. Focus Group Discussion
9. Discussion
10. Conclusions
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Conflicts of Interest
References
- RICS. Procure and Contract: Different Project Types Mean Different Contract Strategies. 2019. Available online: https://bit.ly/3usWgts (accessed on 29 June 2020).
- Sarhan, S.; Pasquire, C.; King, A.; Manu, E. Institutional waste within the UK construction procurement context: A conceptual framework. Eng. Proj. Organ. J. 2018, 8, 36–64. [Google Scholar]
- RIBA. RIBA Plan of Work 2020 Overview, London, RIBA. 2020. Available online: https://bit.ly/3wC6NEB (accessed on 26 October 2020).
- RIBA. RIBA Plan of Works 2013 Overview: RIBA. 2013. Available online: https://bit.ly/2Q7YbVs (accessed on 26 October 2020).
- Nibbelink, J.; Sutrisna, M.; Zaman, A. Unlocking the potential of early contractor involvement in reducing design risks in commercial building refurbishment projects–A Western Australian perspective. Archit. Eng. Des. Manag. 2017, 13, 439–456. [Google Scholar]
- Towey, D. Construction Quantity Surveying a Practical Guide for the Contractor’s QS, 1st ed.; Wiley-Blackwell: Chichester, UK; Hoboken, NJ, USA, 2012; ISBN 978-0-470-65942-7. [Google Scholar]
- Uff, J.F.; Clayton, C.R.I. Role and Responsibility in Site Investigation; Construction Industry Research and Information Association (CIRIA): London, UK, 1991; pp. 1–48. ISBN 978-0860173212. [Google Scholar]
- Laryea, S.; Hughes, W. Commercial reviews in the tender process of contractors. Eng. Constr. Archit. Manag. 2009, 16, 558–572. [Google Scholar] [CrossRef]
- Jaśkowski, P.; Czarnigowska, A. Contractor’s bid pricing strategy: A model with correlation among competitors’ prices. Open Eng. 2019, 9, 159–166. [Google Scholar] [CrossRef]
- Wong, C.; Holt, G.; Cooper, P. Lowest price or value? Investigation of UK construction clients’ tender selection process. Constr. Manag. Econ. 2000, 18, 767–774. [Google Scholar] [CrossRef]
- Orstavik, F.; Dainty, A.; Abbott, C. Construction Innovation, 1st ed.; John Wiley & Sons: Chichester, UK; Hoboken, NJ, USA, 2015; p. 65. ISBN 978-1-118-65553-5. [Google Scholar]
- Wong, C.; Holt, G.; Harris, P. Multi-criteria selection or lowest price? Investigation of UK construction clients’ tender evaluation preferences. Eng. Constr. Archit. Manag. 2001, 8, 257–271. [Google Scholar] [CrossRef]
- Apfelbaum, A. Construction Cost Management: Cost Engineering, Cost Controls & Controlled Bidding, 2nd ed.; Authorhouse: Bloomington, IN, USA, 2013; pp. 160–161. ISBN 9781420871418. [Google Scholar]
- Kodikara, G.W.; Thorpe, A.; McCaffer, R. The use of bills of quantities in building contractor organizations. Constr. Manag. Econ. 1993, 11, 261–269. [Google Scholar] [CrossRef]
- Hatush, Z.; Skitmore, M. Criteria for contractor selection. Constr. Manag. Econ. 2010, 15, 19–38. [Google Scholar] [CrossRef] [Green Version]
- Katar, I.; Howeidy, D. Effective construction utilizing design-build vs. design-bid-build methods; 5-feature appraisal (time-drawings-calendar-communication-changes). Int. J. Civil. Eng. Technol. 2018, 9, 921. [Google Scholar]
- Fong, P.; Choi, S. Final contractor selection using the analytical hierarchy process. Constr. Manag. Econ. 2010, 18, 547–557. [Google Scholar] [CrossRef]
- JCT. Tendering Practise Note 2017; Thomson Reuters (Professional) UK Ltd.: London, UK, 2017; p. 10. [Google Scholar]
- Igwe, U.; Mohamed, S.; Azwarie, M.; Paulson Eberechukwu, N. Recent developments in construction post contract cost control systems. J. Comput. Theor. Nanosci. 2020, 17, 1236–1241. [Google Scholar] [CrossRef]
- Auditor General for Scotland. Management of the Holyrood Building Project. Audit Scotland. 2004. Available online: https://bit.ly/39Xa6g2 (accessed on 26 October 2020).
- Department for Transport. Completing Crossrail, London, Comptroller and Auditor General. 2019. Available online: https://bit.ly/3s5ckzW (accessed on 26 October 2020).
- Department for Culture Media and Sport. London 2012 Olympic and Paralympic Games Annual Report January. London, DCMS. 2009. Available online: https://bit.ly/3cYVWNi (accessed on 26 October 2020).
- Jennings, W. Why costs overrun: Risk, optimism and uncertainty in budgeting for the London 2012 Olympic Games. Constr. Manag. Econ. 2012, 9, 455–462. [Google Scholar] [CrossRef]
- RICS. Tendering Strategies. 2014. Available online: https://bit.ly/3wDNTgG (accessed on 18 October 2020).
- Ahamad, N.; Binti Mazlan, A.; Zin, R.; Tukirin, S. Construction Procurement in Industrialised Building System. IOP Conf. Ser. Mater. Sci. Eng. 2020, 849, 012072. [Google Scholar] [CrossRef]
- Smith, A. Estimating, Tendering and Bidding for Construction Work. 2017. Available online: https://bit.ly/39Sqr5m (accessed on 18 October 2020).
- Jelodar, M.; Yiu, T.; Wilkinson, S. A conceptualisation of relationship quality in construction procurement. Int. J. Proj. Manag. 2016, 34, 997–1011. [Google Scholar] [CrossRef]
- Oyegoke, A.; Dickinson, M.; Khalfan, M.; McDermott, P.; Rowlinson, S. Construction project procurement routes: An in-depth critique. Int. J. Manag. Proj. Bus. 2009, 2, 338–354. [Google Scholar] [CrossRef]
- Viana, M.; Hadikusumo, B.; Mohammad, M.; Kahvandi, Z. Integrated project delivery (IPD): An updated review and analysis case study. J. Eng. Proj. Prod. Manag. 2020, 10, 147–161. [Google Scholar] [CrossRef]
- Davidson, J.; Fowler, J.; Pantazis, C.; Sannino, M.; Walker, J.; Sheikhkhoshkar, M.; Rahimian, F.P. Integration of VR with BIM to facilitate real-time creation of bill of quantities during the design phase: A proof of concept study. Front. Eng. Manag. 2020, 7, 396–403. [Google Scholar] [CrossRef] [Green Version]
- Chappell, D. Professional Practise for Architects and Project Managers, 1st ed.; Wiley Blackwell: Oxford, UK; Hoboken, NJ, USA, 2019; pp. 183–185. ISBN 9781119540090. [Google Scholar]
- Lee, J.H.; Zhou, Y.; Ashuri, B. Key Challenges to design professional liability in the design-build environment. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2020, 12, 04520031. [Google Scholar]
- Ma, G.F.; Jia, J.Y.; Jiang, S.; Wu, Z.J. Incentives and contract design for knowledge sharing in construction joint ventures. Autom. Constr. 2020, 119, 103343. [Google Scholar]
- AIA California Council. Integrated Project Delivery: A Guide, Version 1. American Institute of Architects. 2007. Available online: https://bit.ly/3dKa6RE (accessed on 19 October 2020).
- NBS. National Construction Contracts and Law Survey: NBS. 2015. Available online: https://bit.ly/3s6qYqB (accessed on 26 October 2020).
- NBS. National Construction Contracts and Law Survey: NBS. 2012. Available online: https://bit.ly/2Q2sddf (accessed on 26 October 2020).
- NBS. National Construction Contracts and Law Survey: NBS. 2018. Available online: https://bit.ly/3wEEN3f (accessed on 26 October 2020).
- Aje, I.O.; Oladinrin, O.; Nwaole, A.N.C. Factors influencing success rates of contractors in competitive bidding for construction works in South-East Nigeria. J. Constr. Dev. Ctries. 2016, 21, 19–23. [Google Scholar] [CrossRef]
- Naoum, S.G.; Egbu, C. Modern selection criteria for procurement methods in construction. A state-of the-art literature review and a survey. Int. J. Manag. Proj. Bus. 2016, 9, 309–336. [Google Scholar] [CrossRef]
- Eriksson, P.E.; Pesämaa, O. Modelling procurement effects on cooperation. Constr. Manag. Econ. 2007, 25, 893–901. [Google Scholar] [CrossRef] [Green Version]
- Hamza, N.; Greenwood, D. The impact of procurement methods on delivering environmentally sensitive buildings. In Proceedings of the Boyd, D (Ed) 23rd Annual ARCOM Conference, Belfast, UK, 3–5 September 2007; pp. 723–732. [Google Scholar]
- Shafik, M.; Martin, P. The impact of procurement methods on the Scottish housebuilding industry. In Proceedings of the Boyd, D (Ed) Procs 22nd Annual ARCOM Conference, Birmingham, UK, 4–6 September 2006; pp. 81–90. [Google Scholar]
- Morledge, R.; Smith, A. Building Procurement, 2nd ed.; Wiley-Blackwell: Chichester, UK, 2013; ISBN 978-0-470-67243-3. [Google Scholar]
- Okada, R.; Simons, A.; Sattineni, A. Owner-requested changes in the design and construction of government healthcare facilities. Procedia Eng. 2017, 196, 592–606. [Google Scholar] [CrossRef]
- Collins, W.; Parrish, K. The need for integrated project delivery in the public sector. In Proceedings of the 2014 Construction Research Congress, Atlanta, GA, USA, 19–21 May 2014; pp. 719–728. [Google Scholar]
- Ibbs, W.; Nguyen, L.; Lee, S. Quantified impacts of project change. J. Prof. Issues Eng. Educ. Pract. 2007, 133, 45–52. [Google Scholar] [CrossRef]
- Nuaimi, A.; Taha, R.; Al Mohsin, M.; Al-Harthi, A. Causes, effects, benefits, and remedies of change orders on public construction proects in Oman. J. Constr. Eng. Manag. 2010, 136, 615–622. [Google Scholar]
- Günhan, S.; Arditi, D.; Doyle, J. Avoiding change orders in public school construction. J. Prof. Issues Eng. Educ. Pract. 2007, 133, 67–73. [Google Scholar] [CrossRef]
- Smith, J.; Edwards, D.J.; Martek, I.; Chileshe, N.; Hayhow, S.; Roberts, C.J. The antecedents of construction project change: An analysis of design and build procurement application. J. Eng. Des. Technol. 2021. [Google Scholar] [CrossRef]
- Willers, N. Project Leadership: RIBA Plan of Work 2013 Guide RIBA, 1st ed.; RIBA Publishing: London, UK, 2014; ISBN 978-1-8594-6551-6. [Google Scholar]
- Stasis, A.; Whyte, J.; Dentten, R. A critical examination of change control processes. Procedia CIRP 2013, 11, 177–182. [Google Scholar] [CrossRef] [Green Version]
- Ostime, N. RIBA Job Book, 9th ed.; RIBA Publishing: London, UK, 2019; pp. 10–12. ISBN 978-1-85946-496-0. [Google Scholar]
- Foxell, S. Starting a Practice Plan of Work, 2nd ed.; RIBA Publishing: London, UK, 2015; ISBN 978-1-85946-580-6. [Google Scholar]
- Sinclair, D. RIBA Plan of Work 2013 Guide Design Management, 1st ed.; RIBA Publishing: London, UK, 2014; ISBN 978-1-85946-550-9. [Google Scholar]
- Holden, P. A Practical Guide to the RIBA Plan of Work 2013 Stages 4, 5 and 6, 1st ed.; RIBA Publishing: London, UK, 2015; ISBN 978-1-85946-572-1. [Google Scholar]
- Forcada, N.; Macarulla, M.; Gangolells, M.; Casals, M. Handover defects: Comparison of construction and post-handover housing defects. Build. Res. Inf. 2015, 44, 279–288. [Google Scholar] [CrossRef] [Green Version]
- Lock, D. Project Management in Construction; Routledge Taylor & Francis Group: Oxfordshire, UK, 2016. [Google Scholar]
- Forcada, N.; Gangolells, M.; Casals, M.; Macarulla, M. Factors affecting rework costs in construction. J. Constr. Eng. Manag. 2017, 143, 04017032. [Google Scholar] [CrossRef] [Green Version]
- Safapour, E.; Kermanshachi, S. Identifying early indicators of manageable rework causes and selecting mitigating best practices for construction. J. Manag. Eng. 2019, 35, 04018060. [Google Scholar] [CrossRef]
- Love, P.; Smith, J.; Ackermann, F.; Irani, Z.; Teo, P. The costs of rework: Insights from construction and opportunities for learning. Prod. Plan. Control. 2018, 29, 1082–1095. [Google Scholar] [CrossRef]
- Taylor, T.; Uddin, M.; Goodrum, P.; McCoy, A.; Shan, Y. Change orders and lessons learned: Knowledge from statistical analyses of engineering change orders on Kentucky highway projects. J. Constr. Eng. Manag. 2012, 138, 1360–1369. [Google Scholar] [CrossRef]
- Love, P.; Edwards, D.; Smith, J. Rework causation: Emergent theoretical insights and implications for research. J. Constr. Eng. Manag. 2016, 142, 1943. [Google Scholar] [CrossRef]
- Shahparvari, M.; Fong, D. The review of rework causes and costs in housing construction supply chain. In Proceedings of the 26th Annual Conference of the International Group for Lean Construction, Chennai, India, 16–22 June 2018. [Google Scholar]
- Love, P.; Curtin, J. Creating a mindfulness to learn from errors: Enablers of rework containment and reduction in construction. Dev. Built Environ. 2020, 1. [Google Scholar] [CrossRef]
- Ismail, N.A.A.; Idris, N.H.; Ramli, H.; Sahamir, S.R.; Rooshdi, R.R.R.M. Sustainable BIM-based cost estimating for quantity surveyors. Chem. Eng. Trans. 2018, 63, 235–240. [Google Scholar]
- Love, P. Influence of project type and procurement method on rework costs in building construction projects. J. Constr. Eng. Manag. 2002, 128, 18–29. [Google Scholar] [CrossRef] [Green Version]
- Ashworth, A.; Hogg, K.; Higgs, C. Willis’s Practice and Procedure for the Quantity Surveyor, 13th ed.; John Wiley & Sons: Hoboken, NJ, USA, 2013; ISBN 978-0-470-67219-8. [Google Scholar]
- Lo, W.; Lin, C.; Yan, M. Contractor’s opportunistic bidding behavior and equilibrium price level in the construction market. J. Constr. Eng.Manag. 2007, 133, 409–416. [Google Scholar] [CrossRef]
- Hwang, B.; Thomas, S.; Haas, C.; Caldas, C. Measuring the impact of rework on construction cost performance. J. Constr. Eng. Manag. 2009, 135, 187–198. [Google Scholar] [CrossRef]
- Fayek, A.; Dissanayake, M.; Campero, O. Developing a standard methodology for measuring and classifying construction field rework. Can. J. Civil Eng. 2004, 31, 1077–1089. [Google Scholar] [CrossRef]
- Oyewobi, L.; Oke, A.; Ganiyu, B.; Shittu, A.; Isa, R.; Nwokobia, L. The effect of project types on the occurrence of rework in expanding economy. J. Civil Eng. Constr. Tech. 2011, 2, 119–124. [Google Scholar]
- Perkins, R. Sources of changes in design-build contracts for a governmental owner. J. Constr. Eng. Manag. 2007, 135, 2148–2153. [Google Scholar]
- JCT. DB 2016 Design and Build. Contract 2016; Sweet & Maxwell: London, UK, 2016; pp. 34–56. [Google Scholar]
- Martin, D. Evaluating the evolution of construction management students’ conflict management styles as a result of andragogical methods. In Proceedings of the 2020 ASEE Virtual Annual Conference Content Access Proceedings, Ellensburg, WA, USA, 7 July 2002; pp. 1–19. [Google Scholar] [CrossRef]
- Ma, Z.; Zhang, D.; Li, J. A dedicated collaboration platform for integrated project delivery. Autom. Constr. 2018, 86, 199–209. [Google Scholar] [CrossRef]
- Durdyev, S.; Hosseini, M.; Martek, I.; Ismail, S.; Arashpour, M. Barriers to the use of integrated project delivery (IPD): A quantified model for Malaysia. Eng. Constr. Archit. Manag. 2019, 27, 186–204. [Google Scholar] [CrossRef]
- Briscoe, G.; Dainty, A. Construction supply chain integration: An elusive goal? Supply Chain Manag. Int. J. 2005, 10, 319–326. [Google Scholar] [CrossRef]
- Harper, C.; Molenaar, K.; Cannon, J. Measuring constructs of relational contracting in construction projects: The owner’s perspective. J. Constr. Eng. Manag. 2016, 142, 1–11. [Google Scholar] [CrossRef]
- Papadonikolaki, E.; Wamelink, H. Inter- and intra-organizational conditions for supply chain integration with BIM. Build. Res. Inf. 2017, 45, 649–664. [Google Scholar] [CrossRef]
- Kibert, C.J. Sustainable Construction: Green Building Design and Delivery; John Wiley & Sons: Hoboken, NJ, USA, 2016; ISBN 978-1-119-05517-4. [Google Scholar]
- Kahvandi, Z.; Saghatforoush, E.; ZareRavasan, A.; Preece, C. Integrated project delivery implementation challenges in the construction industry. Civil. Eng. J. 2019, 5, 1672–1683. [Google Scholar] [CrossRef]
- Ghassemi, R.; Becerik-Gerber, B. Transitioning to integrated project delivery: Potential barriers and lessons learned. Lean Constr. J. 2011, 32–52. [Google Scholar]
- Kent, D.; Becerik-Gerber, B. Understanding construction industry experience and attitudes toward integrated project delivery. J. Constr. Eng. Manag. 2010, 136, 815–825. [Google Scholar] [CrossRef]
- Cohen, J. Integrated Project Delivery: Case Studies. The American Institute of Architects. 2010. Available online: https://bit.ly/3uz6gkV (accessed on 26 October 2020).
- Townes, T.; Franz, B.; Leicht, R.M. A case study of IPD delivery team selection. In Proceedings of the 2015 Engineering Project Organization Conference, Edinburgh, UK, 3–4 September 2015; pp. 1–16. [Google Scholar]
- Piroozfar, P.; Farr, E.; Zadeh, A.; Timoteo Inacio, S.; Kilgallon, S.; Jin, R. Facilitating Building Information Modelling (BIM) using integrated project delivery (IPD): A UK perspective. J. Build. Eng. 2019, 26, 100907. [Google Scholar] [CrossRef]
- Newman, C.; Edwards, D.; Martek, I.; Lai, J.; Thwala, W.D.; Rillie, I. Industry 4.0 deployment in the construction industry: A bibliometric literature review and UK-based case study. Smart Sustain. Built Environ. 2020. ahead-of-print. [Google Scholar] [CrossRef]
- Kim, Y.; Rezquallah, K.; Lee, H.; Angeley, J. Integrated project delivery in public projects: Limitations and opportunity. In Proceedings of the 24th Annual Conference of the Int’l. Group for Lean Construction, Boston, MA, USA, 24 July 2016; pp. 93–102. [Google Scholar]
- Franz, B.; Leicht, R.; Molenaar, K.; Messner, J. Impact of team integration and group cohesion on project delivery performance. J. Constr. Eng. Manag. 2017, 143, 04016088. [Google Scholar] [CrossRef]
- Raisbeck, P.; Millie, R.; Maher, A. Assessing integrated project delivery: A comparative analysis of IPD and alliance contracting procurement routes. In Proceedings of the 26th Annual ARCOM Conference, Leeds, UK, 6–8 September 2010; pp. 1019–1028. [Google Scholar]
- Zhang, L.; Cheng, J.; anf Fan, W. Party selection for integrated project delivery based on interorganizational transactive memory system. J. Constr. Eng. Manag. 2016, 142, 04015089. [Google Scholar] [CrossRef]
- Kahvandi, Z.; Saghatforoush, E.; Mahoud, M.; Preece, C. Analysis of the barriers to the implementation of integrated project delivery (IPD): A meta-synthesis approach. journal of engineering. Proj. Prod. Manag. 2019, 9, 2–11. [Google Scholar] [CrossRef] [Green Version]
- Gomez, S.; Naderpajouh, N.; Ballard, G.; Hastak, M.; Weidner, T.J.; Barriga, P. Implications of the integrated project delivery research in practice. In Proceedings of the Construction Research Congress, New Orleans, LA, USA, 2–4 April 2018; pp. 86–96. [Google Scholar]
- Kahvandi, Z.; Saghatforoush, E.; Zare Ravasan, A.; Mansouri, T. An FCM-based dynamic modelling of integrated project delivery implementation challenges in construction projects. Lean Constr. J. 2018, 87, 63–87. [Google Scholar]
- Greenwald, N. Transforming a Fractured Industry: Employing Adr Techniques to Improve Collaboration in the Construction Industry. NYSBA—N. Y. Dispute Resolution Lawyer 2016, 9, 35–36. Available online: https://bit.ly/3fRgvwP (accessed on 26 October 2020).
- Zeng, T.; Deschênes, J.; Durif, F. Eco-design packaging: An epistemological analysis and transformative research agenda. J. Clean. Prod. 2020, 276, 123361. [Google Scholar] [CrossRef]
- Spellacy, J.; Edwards, D.J.; Roberts, C.J.; Hayhow, S.; Shelbourn, M. An investigation into the role of the quantity surveyor in the value management workshop process. J. Eng. Des. Technol. 2020, 19, 423–445. [Google Scholar] [CrossRef]
- Brandao, R.; Edwards, D.J.; Hossieni, M.R.; André, M.S.; Alcebiades, M. A reverse supply chain conceptual model for construction and demolition waste. Waste Manag. Res. 2021. [Google Scholar] [CrossRef]
- Kelly, L.; Cordeiro, M. Three principles of pragmatism for research on organizational processes. Methodol. Innov. 2020, 13, 1–10. [Google Scholar] [CrossRef]
- Kelemen, M.; Rumens, N. Pragmatism and heterodoxy in organization research. Int. J. Organ. Anal. 2012, 20, 5–12. [Google Scholar] [CrossRef]
- Riaz, Z.; Edwards, D.J.; Thorpe, A. SightSafety: A hybrid information and communication technology system for reducing vehicle/pedestrian collisions. Autom. Constr. 2006, 15, 719–728. [Google Scholar] [CrossRef]
- Akinlolu, M.; Haupt, T.C.; Edwards, D.J.; Simpeh, F. A bibliometric review of the status and emerging trends in construction safety management technologies. Int. J. Constr. Manag. 2020, 1–13. [Google Scholar] [CrossRef]
- Darko, A.; Chan, A.; Edwards, D.J.; Reza Hosseini, M.; Ameyaw, E. A scientometric analysis of artificial intelligence research in the construction industry. Autom. Constr. 2020, 112, 103081. [Google Scholar] [CrossRef]
- Roberts, C.J.; Pärn, E.A.; Edwards, D.J.; Aigbavboa, C. Digitalising asset management: Concomitant benefits and persistent challenges. Int. J. Build. Pathol. Adapt. 2018, 36, 152–173. [Google Scholar] [CrossRef]
- Al-Saeed, Y.; Edwards, D.; Scaysbrook, S. Automating construction manufacturing procedures using BIM digital objects (BDOs): Case study of knowledge transfer partnership project in UK. Constr. Innov. 2020, 20, 345–377. [Google Scholar] [CrossRef]
- Kaushik, V.; Walsh, C. Pragmatism as a research paradigm and its implications for social work research. Soc. Sci. 2019, 8, 255. [Google Scholar] [CrossRef]
- Ahmed, H.; Edwards, D.J.; Lai, J.H.K.; Roberts, C.; Debrah, C.; Owusu-Manu, D.G.; Thwala, W.D. Post occupancy evaluation of school refurbishment projects: Multiple case study in the UK. Buildings 2021, 11, 169. [Google Scholar] [CrossRef]
- Siu, K.W.M.; Xiao, J.X. Public facility design for sustainability: Participatory action research on household recycling in Hong Kong. Action Res. 2017, 18, 448–468. [Google Scholar] [CrossRef]
- Perera, G.; Tennakoon, T.; Kulatunga, U.; Jayasena, H.; Wijewickrama, M. Selecting suitable procurement system for steel building construction. Built Environ. Proj. Asset Manag. 2020. [Google Scholar] [CrossRef]
- Makarfi Ibrahim, Y.; Kaka, A.; Aouad, G.; Kagioglou, M. Framework for a generic work breakdown structure for building projects. Constr. Innov. 2009, 9, 388–405. [Google Scholar] [CrossRef]
- Dougherty, C. Introduction to Econometrics, 4th ed.; Oxford University Press: Oxford, UK, 2011; pp. 83–97. ISBN 978-0-19-956708-9. [Google Scholar]
- Love, P.; Holt, G.; Shen, L.; Li, H.; Irani, Z. Using systems dynamics to better understand change and rework in construction project management systems. Int. J. Proj. Manag. 2020, 20, 425–436. [Google Scholar] [CrossRef]
Source of Change | Description of the Source | Reference |
---|---|---|
Design errors | Oversights, mistakes, and inaccuracies in the design information that forms part of the contract documents. Resulting in revisions of the drawings therefore allowing the contractor to claim for the cost of the additional works. | [44,58,59,60,61,62]. |
Design omissions | Design information lacking sufficient information to allow the full extent of the project to be costed. Therefore, adding in the omissions at a later date is supplemented by cost increases. | [44,58,59,60,61,62]. |
Client-driven | Changes requested/variation enquiries by the client that affect the time cost or quality of the project. Any change request provides the contractor an opportunity to revalue the item of works and submit a revised cost. | [44,58,59,60,61,62]. |
Changes to the scope of works | Changes to the contract documents i.e., contractor qualifications, clarifications or omissions resulting in additional work on top of the contractual works. This can include re-introducing items that had been excluded by the contractor or changes to design to allow the work to be physically carried out due to an oversight of the complexity and buildability during the design phase for example. | [58,59,60,61,62,63]. |
Design inconsistencies | Discrepancies in the contract documents i.e., fundamental differences between the architects and structural engineers drawing. This links to changes the scope of works as it is dependent on the contractor’s clarifications as to what the costing was based on. | [58]. |
Managerial factors | Changes resulting from failings of the client’s team. Including but not limited to:
| [58,59,60,63,64]. |
Unforeseen conditions | The ‘unknown-unknowns’—Things that cannot be foreseen or accounted for i.e., force majeure or regulatory changes. | [44,59,61] |
Participant | Position in Business | Years of Experience in Industry | Years of Experience in Current Position | Highest Qualification |
---|---|---|---|---|
A | Managing Director | 35+ | 13 as MD and 7 prior to that as a regional director | MCIOB |
B | Commercial Manager | 23 | 3 | BSc |
C | Site Manager | 32 | 20 | CIOB (Level 4) and SMSTS |
APPLIC ATION | FINAL ACCOUNT | ||||||||||||||||
---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
DESCRIPTION | CONTRACT | 1 | 2 | 3 | 4 | 5 | 6 | 7 | 8 | 9 | 10 | 11 | 12 | 13 | 14 | APPLICATION | AGREED |
SUM | |||||||||||||||||
ESTIMATED | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | |
COST | |||||||||||||||||
Prelims: Fixed | £12,215.00 | £648.00 | £810.00 | £810.00 | £810.00 | £1092.00 | £1092.00 | £5730.75 | £7277.00 | £7277.00 | £7277.00 | £7737.00 | £9060.00 | £9060.00 | £11,706.00 | £12,215.00 | £12,215.00 |

Prelims: Time Related | £29,628.37 | £2370.27 | £4740.54 | £7407.09 | £9777.36 | £12,443.92 | £14,814.19 | £17,283.22 | £19,752.25 | £22,221.28 | £24,690.31 | £27,159.34 | £29,628.37 | £29,628.37 | £33,906.37 | £33,906.37 | £29,628.37 |
Prelims: adjustment to final | |||||||||||||||||
account | −£509.00 | −£509.00 | |||||||||||||||
0. Facilitating works | £3742.00 | £3167.00 | £3217.00 | £3217.00 | £3217.00 | £3517.00 | £3517.00 | £3517.00 | £3517.00 | £3517.00 | £3517.00 | £3517.00 | £3742.00 | £3742.00 | £3742.00 | £3742.00 | £3742.00 |
1. Substructure | £30,729.93 | £6878.00 | £15,900.41 | £25,559.56 | £28,579.56 | £28,253.03 | £28,253.03 | £28,253.03 | £25,290.17 | £25,290.17 | £25,290.17 | £25,290.17 | £25,290.17 | £25,290.17 | £25,946.92 | £25,805.00 | £25,245.00 |
2.1 Structural Frame | £1500.00 | £0.00 | £900.00 | £1350.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 |
2.3 Roof Structure | £30,388.57 | £1426.50 | £1426.50 | £2853.00 | £5940.47 | £10,720.47 | £15,220.47 | £21,369.11 | £29,197.46 | £30,669.76 | £30,669.76 | £30,669.76 | £30,669.76 | £30,669.76 | £30,669.76 | £30,670.57 | £30,670.57 |
2.5 External Walls | £15,756.71 | £0.00 | £0.00 | £0.00 | £6684.60 | £13,845.86 | £14,209.61 | £15,271.71 | £15,271.71 | £15,271.71 | £15,271.71 | £15,654.96 | £15,654.96 | £15,654.96 | £15,654.96 | £15,894.71 | £15,894.71 |
2.6 Windows & External Doors | £27,994.00 | £0.00 | £0.00 | £559.88 | £0.00 | −£199.80 | £2039.72 | £2039.72 | £14,467.36 | £17,534.83 | £29,134.53 | £29,134.53 | £29,134.53 | £29,134.53 | £29,134.53 | £29,142.00 | £29,142.00 |
2.7 Internal Walls & Partitions | £22,386.10 | £0.00 | £0.00 | £0.00 | £232.16 | £232.16 | £348.24 | £348.24 | £1246.80 | £11,772.41 | £19,611.67 | £22,085.77 | £22,031.29 | £22,031.29 | £22,031.29 | £22,166.10 | £22,166.10 |
2.8 Internal Doors (Joinery) | £2159.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £50.00 | £901.97 | £1736.97 | £1756.97 | £1756.97 | £1756.97 | £2560.00 | £2560.00 |
3.1 Wall Finishes | £5850.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £670.00 | £670.00 | £1715.00 | £4150.34 | £4485.34 | £4485.34 | £4485.34 | £4610.00 | £4610.00 |
3.2 Floor Finishes | £1310.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £220.00 | £0.00 | £1060.00 | £1060.00 | £1280.00 | £1280.00 | £1280.00 | £1280.00 |
3.3 Ceiling Finishes | £11,237.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £1978.00 | £3956.00 | £6923.00 | £10,167.50 | £10,662.00 | £10,662.00 | £10,662.00 | £10,662.00 | £10,662.00 | £10,662.00 |
4. FF&E | £400.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £200.00 | £400.00 | £524.30 | £524.30 | £650.00 | £650.00 |
5.1 M&E | £54,859.00 | £272.80 | £272.80 | £272.80 | £272.80 | £272.80 | £272.80 | £272.80 | £16,367.70 | £27,279.50 | £38,191.30 | £54,481.00 | £57,208.95 | £57,698.69 | £57,698.69 | £58,492.00 | £58,492.00 |
5.11 Lightning Protection | £500.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 |
5.14 BWIC | £1000.00 | £0.00 | £0.00 | £0.00 | £0.00 | £250.00 | £250.00 | £250.00 | £200.00 | £500.00 | £750.00 | £1000.00 | £1000.00 | £1000.00 | £1000.00 | £1000.00 | £1000.00 |
8.2 Roads, Paths, Paving’s & | |||||||||||||||||
Surfacing’s | £8760.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £70.00 | £2577.50 | £8670.00 | £9130.00 | £9130.00 |
8.3 Soft Landscaping | £500.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £1336.20 | £1480.50 | £2301.00 | £2301.00 |
8.4 Fencing, Railings & Walls | £80.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £1406.19 | £1406.19 | £1486.19 | £1486.19 | £1486.19 | £1744.00 | £1744.00 |
8.6 External Drainage | £9593.00 | £0.00 | £6143.75 | £6143.75 | £6143.75 | £7396.20 | £7396.20 | £7396.20 | £7396.20 | £7396.20 | £7396.20 | £7396.20 | £7396.20 | £8420.70 | £10,040.70 | £10,043.00 | £10,043.00 |
8.7 External Services | £3825.00 | £0.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2950.00 | £3825.00 | £3825.00 | £3825.00 | £3825.00 |
Additional Work 1: Extent | |||||||||||||||||
Building by 450 mm | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £656.06 | £1180.90 | £1180.90 | £2361.80 | £2361.80 | £2361.80 | £2361.80 | £2624.23 | £2624.23 | £2624.23 | £2639.00 | £2639.00 |
Additional Work 2: Patio, shed | |||||||||||||||||
base and supplies to outdoor | |||||||||||||||||
kitchen | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £3362.14 | £12,103.72 | £13,179.60 | £13,655.00 | £13,655.00 |
Additional Works 3: Outdoor | |||||||||||||||||
kitchen | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £4810.00 | £6794.82 | £6972.00 | £6972.00 |
Additional Works 4: Outdoor | |||||||||||||||||
kitchen foundation | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £820.48 | £825.00 | £825.00 |
Additional Works 5: Gravel to | |||||||||||||||||
driveway | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £2230.00 | £2230.00 |
Construction works adjustment | |||||||||||||||||
to final account | £122.81 | £122.81 | |||||||||||||||
OH&P | £20,581.03 | £1107.19 | £2668.95 | £3776.11 | £4899.95 | £6161.60 | £6922.33 | £8144.57 | £11,295.81 | £13,699.01 | £16,666.40 | £18,727.58 | £19,624.44 | £21,296.15 | £22,458.90 | £23,045.52 | £22,682.67 |
Material on site; Aqua panel & anti corrosive stud | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £15,000.00 | £15,000.00 | £7500.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 |
Material on site; paving slabs | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £3043.40 | £3043.40 | £0.00 | £0.00 | £0.00 | £0.00 |
TOTAL | £294,994.71 | £15,869.76 | £38,254.94 | £54,124.18 | £70,232.64 | £88,316.29 | £99,191.48 | £131,710.24 | £176,942.26 | £203,828.67 | £238,693.52 | £271,149.01 | £283,840.94 | £302,598.06 | £323,079.55 | £330,319.08 | £325,118.23 |
APPLICATION | |||||||||||||||
---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
DESCRIPTION | CONTRACT SUM | 1 | 2 | 3 | 4 | 5 | 6 | 7 | 8 | 9 | 10 | 11 | 12 | 13 | 14 |
ESTIMATED COST | TOTAL VALUE | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | TOTAL | |
Prelims: Fixed | £12,215.00 | £648.00 | £810.00 | £810.00 | £810.00 | £1092.00 | £1092.00 | £5730.75 | £7277.00 | £7277.00 | £7277.00 | £7737.00 | £9060.00 | £9060.00 | £11,706.00 |
Prelims: Time Related | £29,628.37 | £2370.27 | £4740.54 | £7407.09 | £9777.36 | £12,443.92 | £14,814.19 | £17,283.22 | £19,752.25 | £22,221.28 | £24,690.31 | £27,159.34 | £29,628.37 | £29,628.37 | £33,906.37 |
Prelims: adjustment to final | |||||||||||||||
account | |||||||||||||||
0. Facilitating works | £3742.00 | £3167.00 | £3217.00 | £3217.00 | £3217.00 | £3517.00 | £3517.00 | £3517.00 | £3517.00 | £3517.00 | £3517.00 | £3517.00 | £3742.00 | £3742.00 | £3742.00 |
1. Substructure | £30,729.93 | £6878.00 | £15,900.41 | £25,559.56 | £28,579.56 | £28,253.03 | £28,253.03 | £28,253.03 | £25,290.17 | £25,290.17 | £25,290.17 | £25,290.17 | £25,290.17 | £25,290.17 | £25,946.92 |
2.1 Structural Frame | £1500.00 | £0.00 | £900.00 | £1350.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 | £1500.00 |
2.3 Roof Structure | £30,388.57 | £1426.50 | £1426.50 | £2853.00 | £5940.47 | £10,720.47 | £15,220.47 | £21,369.11 | £29,197.46 | £30,669.76 | £30,669.76 | £30,669.76 | £30,669.76 | £30,669.76 | £30,669.76 |
2.5 External Walls | £15,756.71 | £0.00 | £0.00 | £0.00 | £6684.60 | £13,845.86 | £14,209.61 | £15,271.71 | £15,271.71 | £15,271.71 | £15,271.71 | £15,654.96 | £15,654.96 | £15,654.96 | £15,654.96 |
2.6 Windows & External Doors | £27,994.00 | £0.00 | £0.00 | £559.88 | £0.00 | −£199.80 | £2039.72 | £2039.72 | £14,467.36 | £17,534.83 | £29,134.53 | £29,134.53 | £29,134.53 | £29,134.53 | £29,134.53 |
2.7 Internal Walls & Partitions | £22,386.10 | £0.00 | £0.00 | £0.00 | £232.16 | £232.16 | £348.24 | £348.24 | £1246.80 | £11,772.41 | £19,611.67 | £22,085.77 | £22,031.29 | £22,031.29 | £22,031.29 |
2.8 Internal Doors (Joinery) | £2159.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £50.00 | £901.97 | £1736.97 | £1756.97 | £1756.97 | £1756.97 |
3.1 Wall Finishes | £5850.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £670.00 | £670.00 | £1715.00 | £4150.34 | £4485.34 | £4485.34 | £4485.34 |
3.2 Floor Finishes | £1310.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £220.00 | £0.00 | £1060.00 | £1060.00 | £1280.00 | £1280.00 |
3.3 Ceiling Finishes | £11,237.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £1978.00 | £3956.00 | £6923.00 | £10,167.50 | £10,662.00 | £10,662.00 | £10,662.00 | £10,662.00 |
4. FF&E | £400.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £200.00 | £400.00 | £524.30 | £524.30 |
5.1 M&E | £54,859.00 | £272.80 | £272.80 | £272.80 | £272.80 | £272.80 | £272.80 | £272.80 | £16,367.70 | £27,279.50 | £38,191.30 | £54,481.00 | £57,208.95 | £57,698.69 | £57,698.69 |
5.11 Lightning Protection | £500.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 |
5.14 BWIC | £1000.00 | £0.00 | £0.00 | £0.00 | £0.00 | £250.00 | £250.00 | £250.00 | £200.00 | £500.00 | £750.00 | £1000.00 | £1000.00 | £1000.00 | £1000.00 |
8.2 Roads, Paths, Paving’s & | |||||||||||||||
Surfacing’s | £8760.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £70.00 | £2577.50 | £8670.00 |
8.3 Soft Landscaping | £500.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £1336.20 | £1480.50 |
8.4 Fencing, Railings & Walls | £80.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £1406.19 | £1406.19 | £1486.19 | £1486.19 | £1486.19 |
8.6 External Drainage | £9593.00 | £0.00 | £6143.75 | £6143.75 | £6143.75 | £7396.20 | £7396.20 | £7396.20 | £7396.20 | £7396.20 | £7396.20 | £7396.20 | £7396.20 | £8420.70 | £10,040.70 |
8.7 External Services | £3825.00 | £0.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2175.00 | £2950.00 | £3825.00 | £3825.00 |
£0.00 | |||||||||||||||
£0.00 | |||||||||||||||
£0.00 | |||||||||||||||
£0.00 | |||||||||||||||
£0.00 | |||||||||||||||
Construction works adjustment | |||||||||||||||
to final account | |||||||||||||||
OH&P | £20,581.03 | £1107.19 | £2668.95 | £3776.11 | £4899.95 | £6161.60 | £6922.33 | £8144.57 | £11,295.81 | £13,699.01 | £16,666.40 | £18,727.58 | £19,624.44 | £21,296.15 | £22,458.90 |
Material on site; Aqua panel & anti corrosive stud | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £15,000.00 | £15,000.00 | £7500.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 |
Material on site; paving slabs | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £0.00 | £3043.40 | £3043.40 | £0.00 | £0.00 |
£294,994.71 | £15,869.76 | £38,254.94 | £54,124.18 | £70,232.64 | £87,660.23 | £98,010.58 | £130,529.34 | £174,580.46 | £201,466.86 | £236,331.71 | £268,787.21 | £277,854.57 | £283,060.12 | £299,660.42 |
Description | Contract Sum | Final Account Agreed | % Error | Reason for Change | ||
---|---|---|---|---|---|---|
Estimated Cost | Actual Cost | Variations | Total | |||
Prelims: Fixed | £12,215 | £12,215 | £− | £12,215 | 0.00% | No change |
Prelims: Time Related | £29,628 | £29,628 | £− | £29,628 | 0.00% | No change (V036. removed from final account |
as agreed) | ||||||
Prelims: adjustment to | £− | −£509 | £− | −£509 | New entry | Arithmetical error |
final account | ||||||
0. Facilitating works | £3742 | £3742 | £− | £3742 | 0.00% | No change |
1. Substructure | £30,730 | £29,100 | −£3855 | £25,245 | −17.85% | V02.Client-driven |
V06.Unforeseen conditions | ||||||
V034.Client-driven/change to scope of works | ||||||
2.1 Structural Frame | £1500 | £1500 | £− | £1500 | 0.00% | No change |
2.3 Roof Structure | £30,389 | £30,389 | £282 | £30,671 | 0.93% | V08.Other-Material availability |
V012.Client Driven | ||||||
V016.Design error/omission | ||||||
2.5 External Walls | £15,757 | £15,757 | £138 | £15,895 | 0.88% | V07.Client-driven |
V09.Design error | ||||||
2.6 Windows & External | £27,994 | £27,994 | £1148 | £29,142 | 4.10% | V05.Design error/omission |
Doors | ||||||
2.7 Internal Walls & | £22,386 | £22,146 | £20 | £22,166 | −0.98% | V010.Design error/omission |
Partitions | V014.Design error | |||||
V020.Change to scope of works | ||||||
2.8 Internal Doors | £2159 | £2159 | £401 | £2560 | 18.57% | V018.Client-driven |
(Joinery) | V019.Change to scope of works | |||||
V022.Client-driven | ||||||
3.1 Wall Finishes | £5850 | £5850 | −£1240 | £4610 | −21.20% | V021. Client-driven |
V025.Client-driven/change to scope of works | ||||||
3.2 Floor Finishes | £1310 | £1060 | £220 | £1280 | −2.29% | V013.Change to scope of work |
3.3 Ceiling Finishes | £11,237 | £10,662 | £− | £10,662 | −5.12% | False ceiling to steam shower Not required |
therefore, value not drawn | ||||||
4. FF&E | £400 | £400 | £250 | £650 | 62.50% | V027.Client-driven |
5.1 M&E | £54,859 | £54,859 | £3633 | £58,492 | 6.62% | V011.Client-driven |
V026.Client-driven | ||||||
V028.Client-driven | ||||||
V029.Design error/omission | ||||||
V030.Client-driven | ||||||
V035.2. Client-driven | ||||||
V037.Design error | ||||||
5.11 Lightning | £500 | £− | £− | £− | −100.00% | Not required therefore value not drawn |
Protection | ||||||
5.14 BWIC | £1000 | £1000 | £− | £1000 | 0.00% | No change |
8.2 Roads, Paths, | £8760 | £8010 | £1120 | £9130 | 4.22% | Construction of new brick bier and capping’s not |
Paving’s & Surfacing’s | required therefore value not drawn | |||||
V031.Client-driven | ||||||
V032.Unforseen conditions | ||||||
V035.3. Client-driven | ||||||
8.3 Soft Landscaping | £500 | £500 | £1801 | £2301 | 360.20% | V023.Other-provisional sum expenditure |
8.4 Fencing, Railings & | £80 | £80 | £1664 | £1744 | 2080.00% | V015.Client-driven |
Walls | V035.1. Client-driven | |||||
8.6 External Drainage | £9593 | £9593 | £450 | £10,043 | 4.69% | V03.Design error |
V04.Design omission | ||||||
8.7 External Services | £3825 | £3825 | £− | £3825 | 0.00% | No change |
Additional Work 1: | £− | £− | £2639 | £2639 | New entry | V01.Client-driven |
Extent Building by | ||||||
450 mm | ||||||
Additional Work 2: | £− | £− | £13,655 | £13,655 | New entry | V017.Client-driven |
Patio, shed base and | V033.Change to scope of work | |||||
supplies to outdoor | ||||||
kitchen | ||||||
Additional Works 3: | £− | £− | £6972 | £6972 | New entry | V024.A. Client-driven |
Outdoor kitchen | ||||||
Additional Works 4: | £− | £− | £825 | £825 | New entry | V024.B. Client-driven |
Outdoor kitchen | ||||||
foundation | ||||||
Additional Works 5: | £− | £− | £2230 | £2230 | New entry | V038.Client-driven |
Gravel to driveway | ||||||
Construction Works: | £− | £123 | £− | £123 | New entry | Arithmetical error |
adjustment to final | ||||||
account | ||||||
OH&P | £20,581 | £20,256 | £2426 | £22,683 | 10.21% | |
TOTAL: | £294,995 | £290,339 | £34,779 | £325,118 | 10.21% | As discussed above |
Description | Contract Sum | Final Account Agreed | % Error | Reasons for Change | ||
---|---|---|---|---|---|---|
Estimated Cost | Actual Cost | Variations | Total | |||
Prelims: Fixed | £12,215 | £12,215 | £− | £12,215 | 0.00% | No change |
Prelims: Time Related | £29,628 | £29,628 | £− | £29,628 | 0.00% | No change (V036. removed from final account as agreed) |
Prelims: adjustment to final | £− | −£509 | £− | −£509 | New entry | Arithmetical error |
account | ||||||
0. Facilitating works | £3742 | £3742 | £− | £3742 | 0.00% | No change |
1. Substructure | £30,730 | £29,100 | −£3855 | £25,245 | −17.85% | V02.Client-driven |
V06.Unforeseen conditions | ||||||
V034.Client-driven/change to scope of works | ||||||
2.1 Structural Frame | £1500 | £1500 | £− | £1500 | 0.00% | No change |
2.3 Roof Structure | £30,389 | £30,389 | £282 | £30,671 | 0.93% | V08.Other-Material availability |
V012.Client Driven | ||||||
V016.Design error/omission | ||||||
2.5 External Walls | £15,757 | £15,757 | £138 | £15,895 | 0.88% | V07.Client-driven |
V09.Design error | ||||||
2.6 Windows & External | £27,994 | £27,994 | £1148 | £29,142 | 4.10% | V05.Design error/omission |
Doors | ||||||
2.7 Internal Walls & | £22,386 | £22,146 | £20 | £22,166 | −0.98% | V010.Design error/omission |
Partitions | V014.Design error | |||||
V020.Change to scope of works | ||||||
2.8 Internal Doors (Joinery) | £2159 | £2159 | £401 | £2560 | 18.57% | V018.Client-driven |
V019.Change to scope of works | ||||||
V022.Client-driven | ||||||
3.1 Wall Finishes | £5850 | £5850 | −£1240 | £4610 | −21.20% | V021. Client-driven |
V025.Client-driven/change to scope of works | ||||||
3.2 Floor Finishes | £1310 | £1060 | £220 | £1280 | −2.29% | V013.Change to scope of work |
3.3 Ceiling Finishes | £11,237 | £10,662 | £− | £10,662 | −5.12% | False ceiling to steam shower Not required therefore value |
not drawn | ||||||
4. FF&E | £400 | £400 | £250 | £650 | 62.50% | V027.Client-driven |
5.1 M&E | £54,859 | £54,859 | £3633 | £58,492 | 6.62% | V011.Client-driven |
V026.Client-driven | ||||||
V028.Client-driven | ||||||
V029.Design error/omission | ||||||
V030.Client-driven | ||||||
V035.2. Client-driven | ||||||
V037.Design error | ||||||
5.11 Lightning Protection | £500 | £− | £− | £− | −100.00% | Not required therefore value not drawn |
5.14 BWIC | £1000 | £1000 | £ - | £1000 | 0.00% | No change |
8.2 Roads, Paths, Paving’s | £8760 | £8010 | £1120 | £9130 | 4.22% | Construction of new brick bier and capping’s not required |
& Surfacing’s | therefore value not drawn | |||||
V031.Client-driven | ||||||
V032.Unforseen conditions | ||||||
V035.3. Client-driven | ||||||
8.3 Soft Landscaping | £500 | £500 | £1801 | £2301 | 360.20% | V023.Change to scope of works |
8.4 Fencing, Railings & | £80 | £80 | £1664 | £1744 | 2080.00% | V015.Client-driven |
Walls | V035.1. Client-driven | |||||
8.6 External Drainage | £9593 | £9593 | £450 | £10,043 | 4.69% | V03.Design error |
V04.Design omission | ||||||
8.7 External Services | £3825 | £3825 | £− | £3825 | 0.00% | No change |
Construction works | £− | £123 | £− | £123 | New entry | Arithmetical error |
adjustment to final account | ||||||
OH&P | £20,581 | £20,256 | £2426 | £22,683 | 10.21% | |
£294,995 | £290,339 | £8458 | £298,797 | 1.29% | As discussed above |
Statistic | Result |
---|---|
Mean Difference | £152 |
Standard Deviation of Difference | £1549 |
Standard Error of Difference | £323 |
½ T alpha 95% Confidence interval | 2.06 |
Lower Confidence Interval | −£487 |
Upper Confidence Interval | £791 |
DESCRIPTION | Contract Sum | Final Account Agreed | % Error | Absolute % Error | Notes | ||
---|---|---|---|---|---|---|---|
Estimated Cost | Actual Cost | Variations £− | Total | ||||
Prelims: Fixed | £12,215 | £12,215 | £0 | £12,215 | 0.00% | 0.00% | |
Prelims: Time Related | £29,628 | £29,628 | £0 | £29,628 | 0.00% | 0.00% | |
0. Facilitating works | £3742 | £3742 | £0 | £3742 | 0.00% | 0.00% | |
2.1 Structural Frame | £1500 | £1500 | £0 | £1500 | 0.00% | 0.00% | |
5.14 BWIC | £1000 | £1000 | £0 | £1000 | 0.00% | 0.00% | |
8.7 External Services | £3825 | £3825 | £0 | £3825 | 0.00% | 0.00% | Q1 |
2.5 External Walls | £15,757 | £15,757 | £138 | £15,895 | 0.88% | 0.88% | |
2.3 Roof Structure | £30,389 | £30,389 | £282 | £30,671 | 0.93% | 0.93% | |
2.7 Internal Walls & Partitions | £22,386 | £22,146 | £20 | £22,166 | −0.98% | 0.98% | |
3.2 Floor Finishes | £1310 | £1060 | £220 | £1280 | −2.29% | 2.29% | |
2.6 Windows & External Doors | £27,994 | £27,994 | £1148 | £29,142 | 4.10% | 4.10% | |
8.2 Roads, Paths, Paving’s & | |||||||
Surfacing’s | £8760 | £8010 | £1120 | £9130 | 4.22% | 4.22% | Mid-Point |
8.6 External Drainage | £9593 | £9593 | £450 | £10,043 | 4.69% | 4.69% | |
3.3 Ceiling Finishes | £11,237 | £10,662 | £0 | £10,662 | −5.12% | 5.12% | |
5.1 M&E | £54,859 | £54,859 | £3633 | £58,492 | 6.62% | 6.62% | |
OH&P | £20,581 | £20,285 | £2426 | £22,712 | 10.35% | 10.35% | |
1. Substructure | £30,730 | £29,100 | −£3855 | £25,245 | −17.85% | 17.85% | |
2.8 Internal Doors (Joinery) | £2159 | £2159 | £401 | £2560 | 18.57% | 18.57% | Q3 |
3.1 Wall Finishes | £5850 | £5850 | −£1240 | £4610 | −21.20% | 21.20% | |
Outlier removed | |||||||
Outlier removed | |||||||
Outlier removed | |||||||
Outlier removed | |||||||
£293,515 | £289,774 | £4743 | £294,517 | 2.93% | 97.80% |
No. | Question | Prompts |
---|---|---|
1 |
|
|
2 |
|
|
3 |
|
|
4 |
|
|
5 |
|
|
6 |
|
|
7 |
|
|
8 |
|
|
9 |
|
|
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations. |
© 2021 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Ellis, J.; Edwards, D.J.; Thwala, W.D.; Ejohwomu, O.; Ameyaw, E.E.; Shelbourn, M. A Case Study of a Negotiated Tender within a Small-to-Medium Construction Contractor: Modelling Project Cost Variance. Buildings 2021, 11, 260. https://doi.org/10.3390/buildings11060260
Ellis J, Edwards DJ, Thwala WD, Ejohwomu O, Ameyaw EE, Shelbourn M. A Case Study of a Negotiated Tender within a Small-to-Medium Construction Contractor: Modelling Project Cost Variance. Buildings. 2021; 11(6):260. https://doi.org/10.3390/buildings11060260
Chicago/Turabian StyleEllis, James, David John Edwards, Wellington Didibhuku Thwala, Obuks Ejohwomu, Ernest Effah Ameyaw, and Mark Shelbourn. 2021. "A Case Study of a Negotiated Tender within a Small-to-Medium Construction Contractor: Modelling Project Cost Variance" Buildings 11, no. 6: 260. https://doi.org/10.3390/buildings11060260
