Exploring Pre-Construction Activities in Infrastructure Projects That Can Benefit from Contractor Involvement
Abstract
:1. Introduction

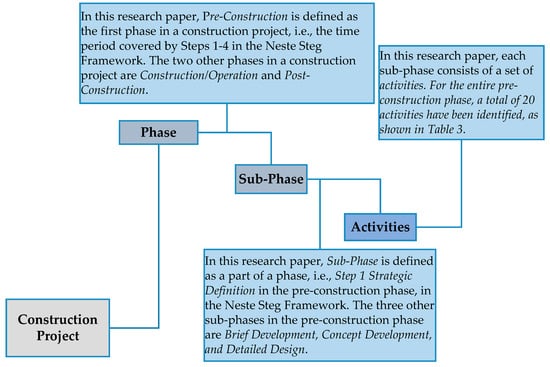

2. Theoretical Background

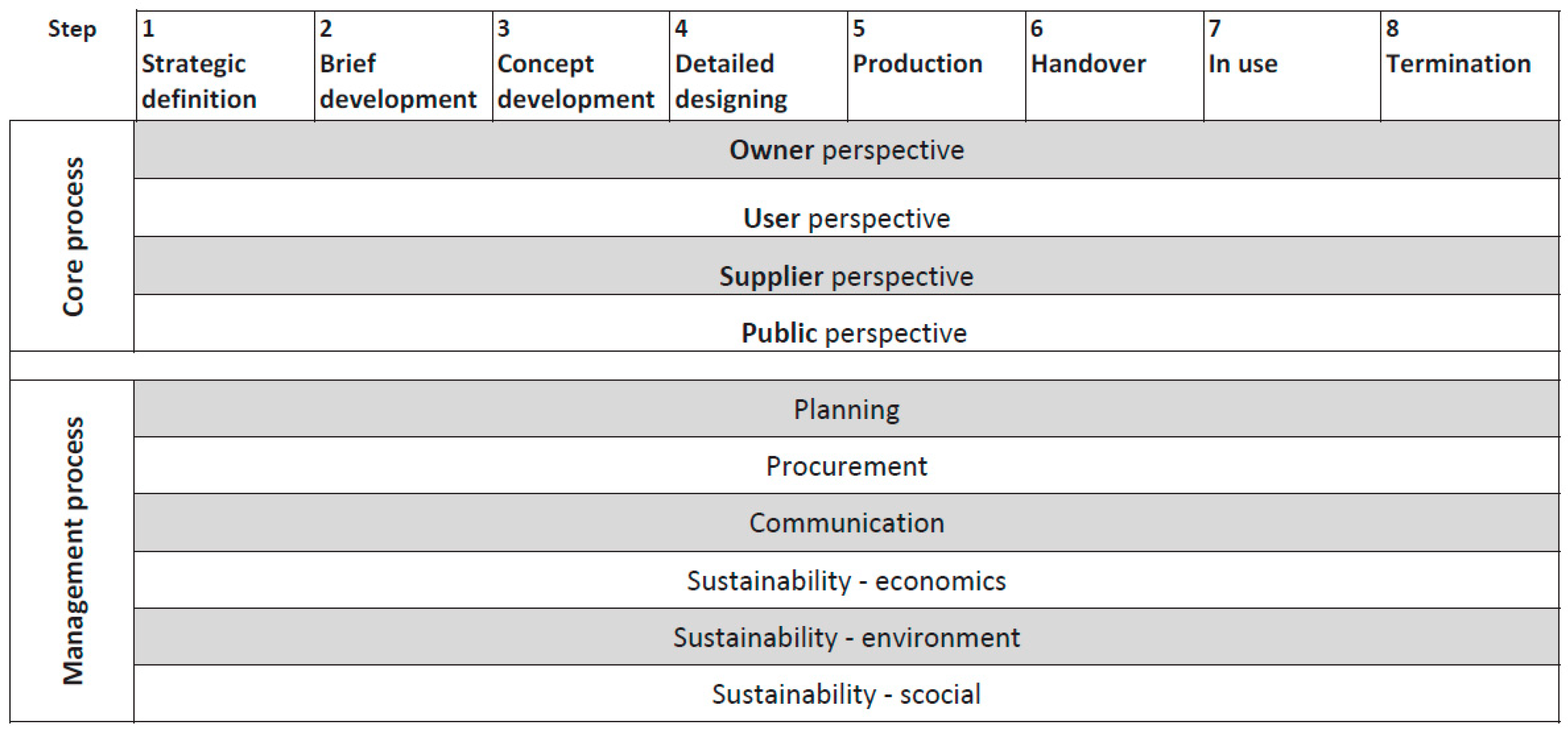

2.1. Construction Project Lifecycle Models and the Pre-Construction Phase in Infrastructure Projects
2.2. Activity-Based Approach to the Pre-Construction Phase—Infrastructure Projects
2.3. Classification of the Pre-Construction Activities in Infrastructure Projects

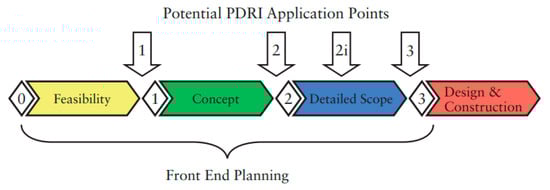

2.4. ECI—Goals and Opportunities in the Pre-Construction Phase

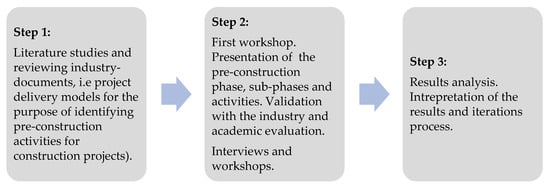

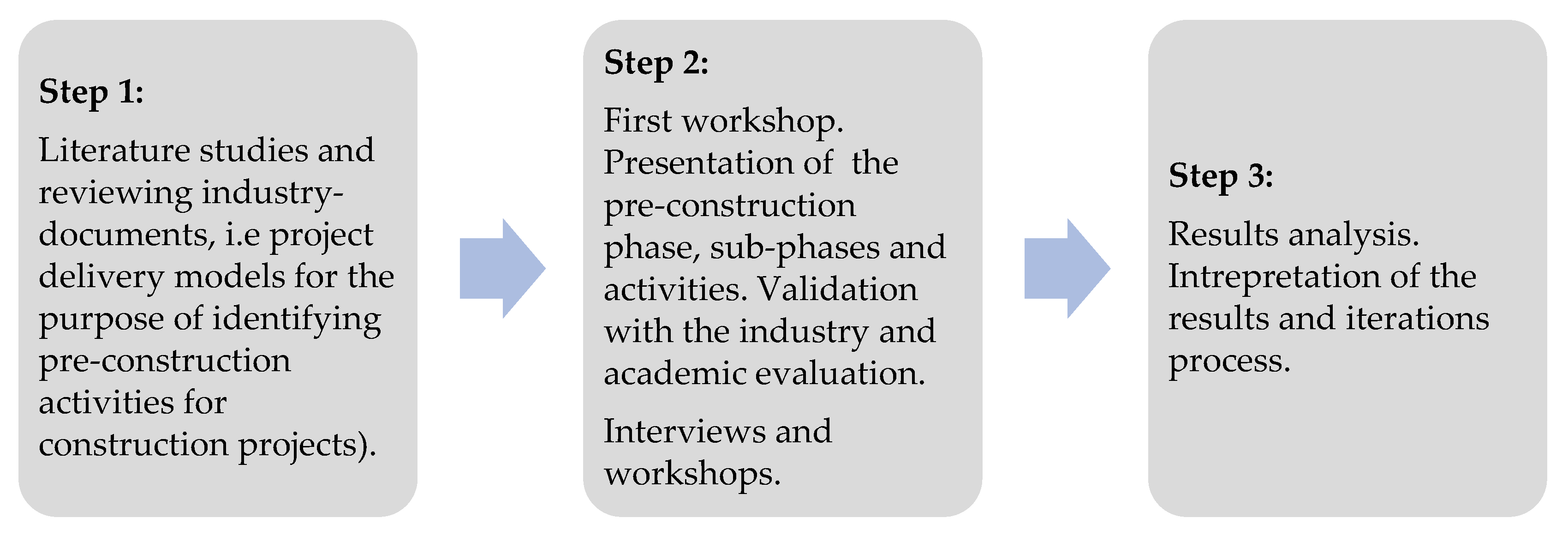

3. Method
3.1. Literature and Document Study
3.2. Interviews
3.3. Workshops
3.4. Data Analysis and Iteration of Results
4. Findings
4.1. Pre-Construction Activities
4.2. Pre-Construction Activities That Benefit from ECI
5. Discussion
5.1. What Are the Main Pre-Construction Activities for Public Infrastructure Projects?
5.2. Which of the Main Pre-Construction Activities Can Benefit the Most from ECI?
6. Conclusions
Contribution
Author Contributions
Funding
Data Availability Statement
Acknowledgments
Conflicts of Interest
References
- Flyvbjerg, B.; Garbuio, M.; Lovallo, D. Delusion and deception in large infrastructure projects: Two models for explaining and preventing executive disaster. Def. AR J. 2017, 24, 583–585. [Google Scholar] [CrossRef]
- Scheepbouwer, E.; Humphries, A.B. Transition in adopting project delivery method with early contractor involvement. Transp. Res. Rec. 2011, 2228, 44–50. [Google Scholar] [CrossRef]
- Gaur, S.; Satyanarayana, D.; Tawalare, A. Stakeholder assessment in construction projects using a CRITIC-TOPSIS approach. Built Environ. Proj. Asset Manag. 2023, 13, 217–237. [Google Scholar] [CrossRef]
- Wondimu, P.A.; Klakegg, O.J.; Lædre, O. Early contractor involvement (ECI): Ways to do it in public projects. J. Public Procure. 2020, 20, 62–87. [Google Scholar] [CrossRef]
- Lappalainen, E.; Uusitalo, P.; Pikas, E.; Seppänen, O.; Peltokorpi, A.; Uusitalo, P.; Reinbold, A.; Menzhinskii, N. Improving Design Quality by Contractor Involvement: An Empirical Study on Effects. Buildings 2022, 12, 1188. [Google Scholar] [CrossRef]
- Wang, R.; Samarasinghe, D.A.S.; Skelton, L.; Rotimi, J.O.B. A study of design change management for infrastructure development projects in New Zealand. Buildings 2022, 12, 1486. [Google Scholar] [CrossRef]
- Rahman, M.M.; Alhassan, A. A contractor’s perception on early contractor involvement. Built Environ. Proj. Asset Manag. 2012, 2, 217–233. [Google Scholar] [CrossRef]
- Rahmani, F.; Khalfan, M.; Maqsood, T. A Conceptual Model for Selecting Early Contractor Involvement (ECI) for a Project. Buildings 2022, 12, 786. [Google Scholar] [CrossRef]
- Rahmani, F. Challenges and opportunities in adopting early contractor involvement (ECI): Client’s perception. Archit. Eng. Des. Manag. 2021, 17, 67–76. [Google Scholar] [CrossRef]
- Wondimu, P.A.; Hosseini, A.; Lohne, J.; Laedre, O. Early contractor involvement approaches in public project procurement. J. Public Procure. 2018, 18, 355–378. [Google Scholar] [CrossRef]
- Memić, N.; Tadayon, A.; Wondimu, P.A.; Lædre, O.; Klakegg, O.J. Which contractor competencies are valuable for the client in the pre-construction phase? Procedia Comput. Sci. 2023, 219, 1901–1908. [Google Scholar] [CrossRef]
- GAO. Preliminary Information on the Timely Completion of Highway Construction Projects; General Accounting Office: Washington, DC, USA, 2002. [Google Scholar]
- Dehghan, R.; Hazini, K.; Ruwanpura, J. Optimization of overlapping activities in the design phase of construction projects. Autom. Constr. 2015, 59, 81–95. [Google Scholar] [CrossRef]
- van der Walt, J.D.; Botha, P.S.; Scheepbouwer, E. When to engage the contractor for pre-construction services in New Zealand. Transp. Res. Rec. 2019, 2673, 562–570. [Google Scholar] [CrossRef]
- Dejan Makovšek, A.B. Procurement Strategy in Major Infrastructure Projects–Piloting a New Approach in Norway; Vol. OECD Public Governance Policy Papers No. 06; OECD: Paris, France, 2021. [Google Scholar]
- Tadayon, A.; Rahmani, F.; Memić, N. A Review of Different Construction Project Lifecycle; Report nr.1; Optimaltid: Prosjekt Norge, Oslo, 2020. [Google Scholar]
- Croce, R.D. Building Resilience—New Strategies for Strengthening Infrastructure Resilience and Maintenance; OECD: Paris, France, 2021. [Google Scholar]
- Knotten, V.; Hosseini, A.; Klakegg, O.J.; Jonny, O. Next step: A new systematic approach to plan and execute AEC projects. In Proceedings of the CIB World Building Congress, Tampere, Finland, 30 May–3 June 2016. [Google Scholar]
- Bygg21. Veileder for Fasenormen Neste Steg- Et Felles Rammeverk for Norske Byggeprosesser. Prosjekt Norge, Oslo. 2015. Available online: https://bygg21.no/wp-content/uploads/2021/03/veileder-for-stegstandard-ver-1.2-med-logoer-201116.pdf (accessed on 23 April 2023).
- Leksikon, S.N. Prosjektmodell (Bygg, Anlegg og Eiendom). 2022. Available online: https://snl.no/prosjektmodell_-_bygg,_anlegg_og_eiendom (accessed on 17 March 2023).
- Waters, T. Innovative Practices to Reduce Delivery Time for Right-of-Way in Project Development; Transportation Research Board: Washington, DC, USA, 2000; Volume 292. [Google Scholar]
- Chang, A.-P.; Chou, C.-C.; Lin, J.-D.; Hsu, C.-Y. Road construction project environmental impact assessment scope definition using Project Definition Rating Index (PDRI). Adv. Mater. Res. 2013, 723, 885–892. [Google Scholar] [CrossRef]

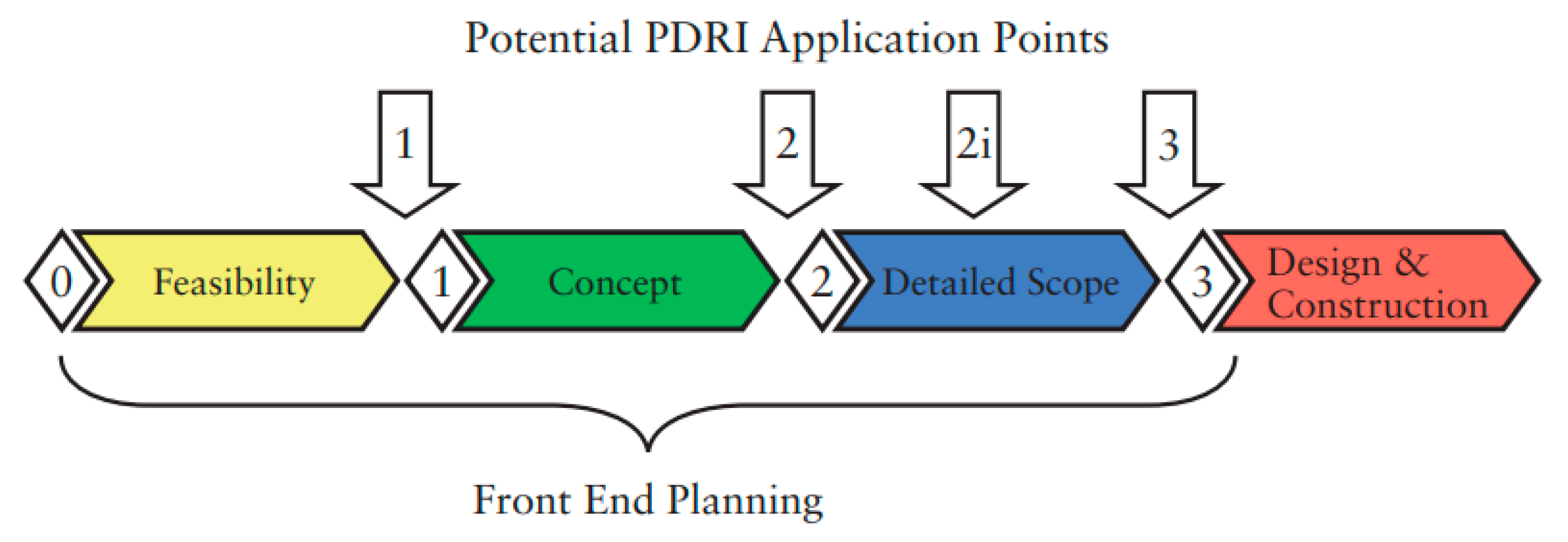

- CII. PDRI Project Definition Rating Index—Infrastructure Projects; Implementation Resource 268-2 (Version 4.0); CII: Austin, TX, USA, 2013. [Google Scholar]
- Safa, M.; Weeks, K.; ELHoubi, A.; Sharma, N.; MacGillivray, S. Construction Strategic Project Readiness Assessment. J. Eng. Proj. Prod. Manag. 2022, 12, 13. [Google Scholar]
- Raza, M.S.; Tayeh, B.A.; Ali, T.H. Owner’s obligations in promoting occupational health and safety in preconstruction of projects: A literature viewpoint. Results Eng. 2022, 16, 100779. [Google Scholar] [CrossRef]
- Järvenpää, A.-T.; Pavlik, A.; Karrbom Gustavsson, T. Contextual communicative competence in multinational infrastructure projects. Buildings 2021, 11, 403. [Google Scholar] [CrossRef]
- Srour, I.M.; Abdul-Malak, M.-A.U.; Yassine, A.A.; Ramadan, M. A methodology for scheduling overlapped design activities based on dependency information. Autom. Constr. 2013, 29, 1–11. [Google Scholar] [CrossRef]
- Gransberg, D.D. A Guidebook for Construction Manager-at-Risk Contracting for Highway Projects; NCHRP Project 10-85; Iowa State University: Ames, IA, USA, 2013. [Google Scholar]
- Al-Reshaid, K.; Kartam, N.; Tewari, N.; Al-Bader, H. A project control process in pre-construction phases: Focus on effective methodology. Eng. Constr. Archit. Manag. 2005, 12, 351–372. [Google Scholar] [CrossRef]
- UN. Transforming Our World: The 2030 Agenda for Sustainable Development; UN: New York, NY, USA, 2015. [Google Scholar]
- Vegdirektoratet. Håndbok R760, Styring av Vegprosjekter; Vegdirektoratet: Oslo, Norway, 2021. [Google Scholar]
- Wu, G.; Qiang, G.; Zuo, J.; Zhao, X.; Chang, R. What are the key indicators of mega sustainable construction projects?—A stakeholder-network perspective. Sustainability 2018, 10, 2939. [Google Scholar] [CrossRef]
- Chinowsky, P.S.; Meredith, J.E. Strategic management in construction. J. Constr. Eng. Manag. 2000, 126, 1–9. [Google Scholar] [CrossRef]
- Ferme, L.; Zuo, J.; Rameezdeen, R. Improving Collaboration among Stakeholders in Green Building Projects: Role of Early Contractor Involvement. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2018, 10, 04518020. [Google Scholar] [CrossRef]
- Sodangi, M. Social sustainability efficacy of construction projects in the pre-construction phase. In Proceedings of the Institution of Civil Engineers: Engineering Sustainability; Thomas Telford Ltd.: London, UK, 2019; Volume 172, pp. 57–67. [Google Scholar]
- Boge, K.; Haddadi, A.; Klakegg, O.J.; Salaj, A.T. Facilitating building projects’ short-term and long-term value creation. Buildings 2021, 11, 332. [Google Scholar] [CrossRef]
- Hjelmbrekke, H.; Lædre, O.; Lohne, J. The need for a project governance body. Int. J. Manag. Proj. Bus. 2014, 7, 661–677. [Google Scholar] [CrossRef]
- Thyssen, M.H.; Emmitt, S.; Bonke, S.; Kirk-Christoffersen, A. Facilitating client value creation in the conceptual design phase of construction projects: A workshop approach. Archit. Eng. Des. Manag. 2010, 6, 18–30. [Google Scholar] [CrossRef]
- Ng, M.S.; Graser, K.; Hall, D.M. Digital fabrication, BIM and early contractor involvement in design in construction projects: A comparative case study. Archit. Eng. Des. Manag. 2023, 19, 39–55. [Google Scholar] [CrossRef]
- NZ. Early Contractor Involvement Construction Procurement Guidelines; Ministry of Business, Innovation and Employment, New Zealand Government: Wellington, New Zealand, 2019. [Google Scholar]
- Abd Hamid, A.B.; Embi, M.R. Review on Application of Building Information Modelling in Interior Design Industry. In Proceedings of the MATEC Web of Conferences, Kuala Lumpur, Malaysia, 7–8 March 2016; Volume 66, p. 3. [Google Scholar]
- Li, Y.; Song, H.; Sang, P.; Chen, P.-H.; Liu, X. Review of Critical Success Factors (CSFs) for green building projects. Build. Environ. 2019, 158, 182–191. [Google Scholar] [CrossRef]
- Hosseini, A.; Wondimu, P.A.; Klakegg, O.J.; Andersen, B.; Laedre, O. Project partnering in the construction industry: Theory vs. practice. Eng. Proj. Organ. J. 2018, 8, 2–24. [Google Scholar]
- Naoum, S.G. Factors influencing labor productivity on construction sites: A state-of-the-art literature review and a survey. Int. J. Product. Perform. Manag. 2016, 65, 401–421. [Google Scholar] [CrossRef]
- Austin, S.A.; Baldwin, A.N.; Steele, J.L. Improving building design through integrated planning and control. Eng. Constr. Archit. Manag. 2002, 9, 249–258. [Google Scholar] [CrossRef]
- Sarbini, N.N.; Abdul Aziz, A.N.; Mazlan, A.N.; Abdul Shukor Lim, N.H.; Rahman, M.F.A. Key Design Issues in the Construction Project: Conceptual and Detailed Design Review Phases. IOP Conf. Ser. Mater. Sci. Eng 2021, 1200, 12028. [Google Scholar] [CrossRef]
- Pradhananga, P.; ElZomor, M.; Gada, G.M. Investigating the Impact of Alternative Technical Concepts for Project Delivery of Accelerated Bridge Construction. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2023, 15, 04522059. [Google Scholar] [CrossRef]
- Botha, P.S.; Scheepbouwer, E. Relationship between Early Contractor Involvement and Financial Performance in the Rebuilding of Infrastructure in Christchurch, New Zealand. Transp. Res. Rec. 2015, 2504, 66–72. [Google Scholar] [CrossRef]
- Rosander, L. Same same but different: Dynamics of a pre-procurement routine and its influence on relational contracting models. Constr. Manag. Econ. 2022, 40, 955–972. [Google Scholar] [CrossRef]
- Mathar, H.; Assaf, S.; Hassanain, M.A.; Abdallah, A.; Sayed, A.M.Z. Critical success factors for large building construction projects: Perception of consultants and contractors. Built Environ. Proj. Asset Manag. 2020, 10, 349–367. [Google Scholar] [CrossRef]
- Creswell, J.W. Research Design: Qualitative, Quantitative, and Mixed Methods Approaches, 3rd ed.; SAGE: Los Angeles, CA, USA, 2009. [Google Scholar]
- Creswell, J.W.; Creswell, J.D. Research Design: Qualitative, Quantitative & Mixed Methods Approaches, 5th ed.; Sage: Los Angeles, CA, USA, 2018. [Google Scholar]
- Blumberg, B.; Cooper, D.; Schindler, P. EBOOK: Business Research Methods; McGraw Hill: New York, NY, USA, 2014. [Google Scholar]
- Sødal, A.H.; Lædre, O.; Svalestuen, F.; Lohne, J. Early contractor involvement: Advantages and disadvantages for the design team. In Proceedings of the 22nd Annual Conference of the International Group for Lean Construction, Oslo, Norway, 25–27 June 2014; pp. 519–531. [Google Scholar]
- Wondimu, P.A. Early Contractor Involvement (ECI) Approaches for Public Project Owners. Ph.D. Thesis, Norwegian University of Science and Technology, Trondheim, Norway, 2019. [Google Scholar]
Interviewee | Organization | Position |
---|---|---|
P1-P6 | Bodø Municipality | Project director (1), Project manager (4), Procurement manager (1) |
P7-P11 | Bane NOR | Project manager (2), Project Director (1), Contract manager (1), Project Planning (1), Control manager (1) |
P12-P16 | Nye Veier (incl. 2 contractors) | Project Planning and control manager (1), Project manager (2), Portfolio controller (1), Project director (1) |
P17-P19 | WSP (consultant) | Project manager (2), Head of Planning (1) |
P20-P22 | NPRA | Project manager (2), Engineering manager (1) |
Group (4) | HENT (contractor) | Head of Project Development (1), Project manager (3) |
Place | The Relevant Outcome of This Study |
---|---|
2 December 2020 TEAMS | The identified set of activities is sufficient for the data collection. It covers all main activities in the pre-construction phase. No need to add more. |
13 October 2021 Oslo | The activity approach should be stepwise, and the activities should be split further as the work progresses. The set of activities is too general. Contractor competence vs. contractor involvement is not the same. BIM is important for activity 18. |
15 December 2021 Trondheim | The need for competency and the dependencies between the activities should decide how we split the general activities. |
24 February 2022 Kristiansand | Soft skills are an issue as they are difficult to measure and control within the different activities. Risk assessment and competency needs should decide how we split activities in the pre-construction phase. Experience with make/buy analysis, i.e., decisions based on economic theories, but it needs a supplement. |
25 May 2022 Oslo | The correct way of splitting activities can show dependencies we were not aware of. Impact on criticality activities. Risk assessment is not sufficient. Uncertainty needs to be moved to cover the entire process in addition to an individual activity. |
5–6 October 2022 Oslo | It is still possible to mitigate risk when proper splitting is performed as it visualizes the dependencies. Sufficient with a set of activities. Too many activities can become messy. |
14 December 2022 Bodø | Difficult to predict all activities when doing refurbishment work. Contractor input is valuable as refurbishment work usually requires upgrading existing structure and there are practical considerations to consider. |

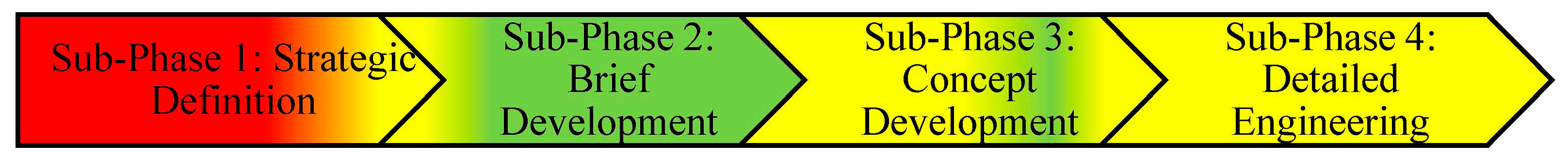

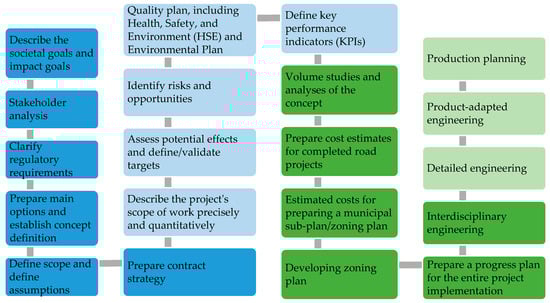

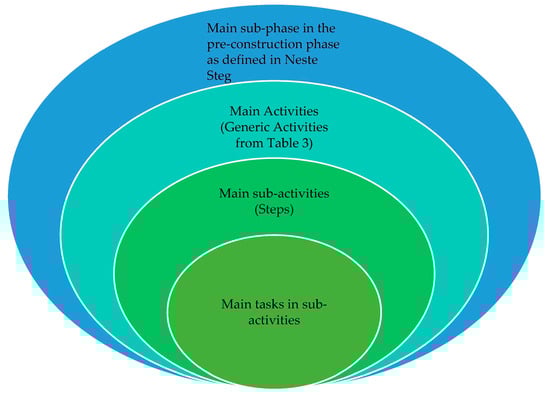

Neste Steg Sub-phase | Number of Identified Activities | Identified Activity (What to Do?) | Activity Description (How to Do It?) | Activity Justification (Why Do It?) |
---|---|---|---|---|

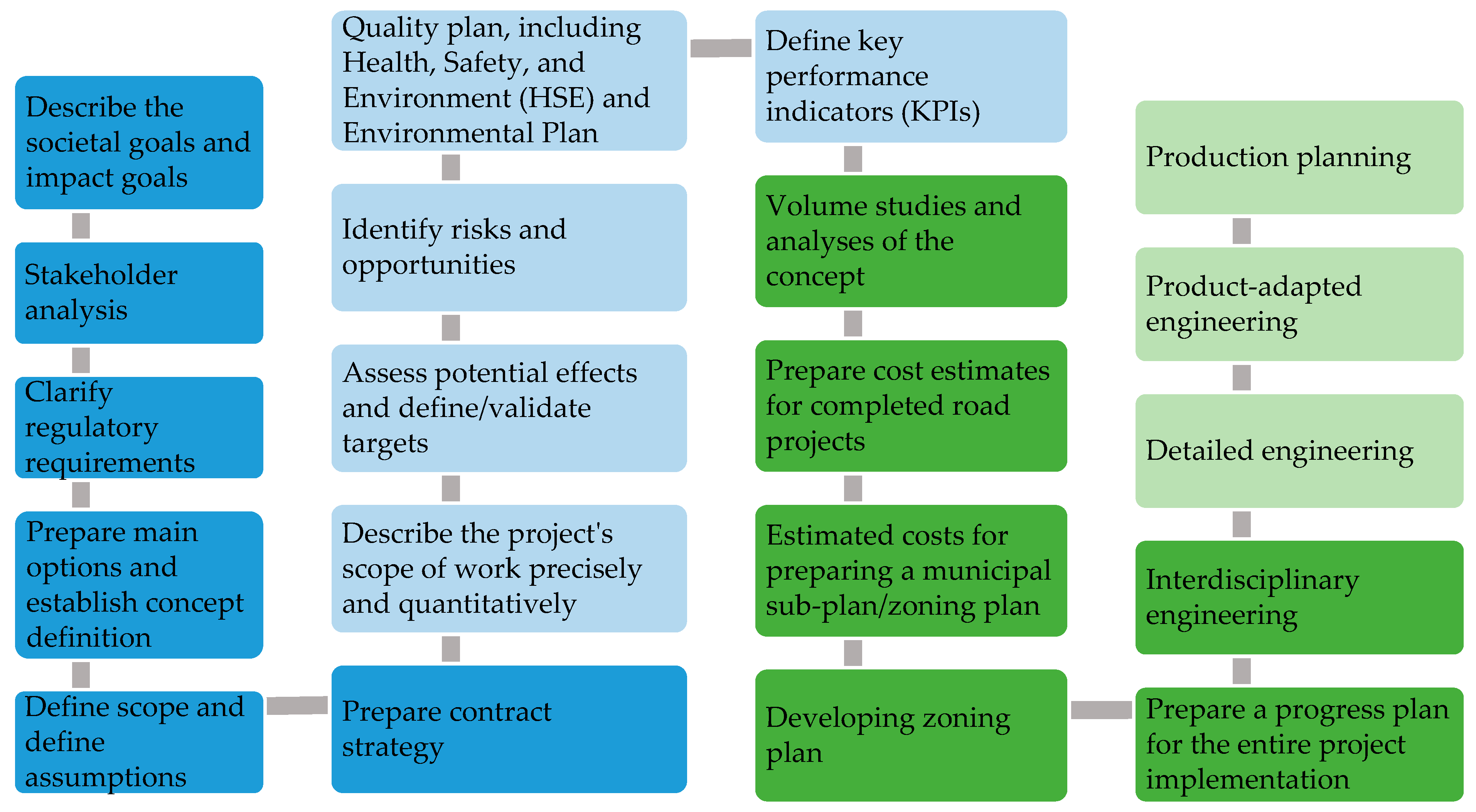

1 | 1 | Describe the societal goals and impact goals | This activity is a basis for decision-making throughout the project. | The activity covers social and community objectives that projects aim to achieve. |
1 | 2 | Stakeholder analysis | This activity is a process where the interests, needs, and impact of different stakeholders are identified and assessed. | Stakeholders are classified according to their level of interest and influence. |
1 | 3 | Clarify regulatory requirements | This activity is used to identify and assess various laws and regulations that apply to the project. | It determines how laws and regulations will impact the project’s cost, schedule, and feasibility. |
1 | 4 | Prepare main options and establish concept definition | This activity covers identifying and evaluating different solutions and construction options for the project. | It aims to evaluate the main options based on the project’s goals and constraints. |
1 | 5 | Define scope and define assumptions | This activity delineates the project boundaries, including key objectives and goals, while also identifying underlying factors that could impact various project elements, like cost, quality, and schedule. | It aims to enable a thorough understanding of the project’s main objectives and potential constraints, fostering a proactive approach to managing unforeseen challenges. |
1 | 6 | Prepare contract strategy | This activity is a process of establishing a plan for developing, negotiating, and executing contracts for a construction project. | The aim is to ensure that the type of contract that will be used for the project is suitable. |
2 | 7 | Detailed scope of work | This activity develops a precise and quantitative description of the project’s scope, focusing on specific tasks and deliverables, including identifying necessary resources and materials. | It aims to facilitate accurate planning and resource allocation, which is paramount in a complex construction landscape, ensuring that the project can meet its objectives without resource constraints. |
2 | 8 | Environmental and stakeholder impact assessment | This activity analyzes the potential effects the project might have on the environment and community, including validating targets and defining strategies to mitigate negative impacts. | It aims to support responsible project development within the industry’s stringent environmental and societal considerations, ensuring that all potential impacts are assessed and mitigated. |
2 | 9 | Identify risks and opportunities | This activity is a process of undertaking a comprehensive uncertainty assessment of the project to pinpoint both potential risks and opportunities and develop strategies for managing uncertainty effectively. | It aims to foster a resilient project management approach, vital in the dynamic construction sector, by early identification and management of risks and leveraging opportunities for better outcomes. |
2 | 10 | Quality plan, including Health, Safety, and Environment (HSE) and environmental plan | This activity is a process of establishing separate plans for HSE and environmental planning in the construction, maintenance, and operation phases. | The goal is to ensure that the projects are completed to a high standard of quality and safety and that they minimize harm to the environment. |
2 | 11 | Define key performance indicators (KPIs) | This activity identifies metrics that are used to measure the performance of a business or organization against specific goals and objectives. | The goal is to use KPIs to track progress and evaluate the success of the project in achieving its goals. |
3 | 12 | Volume studies and analyses of the concept | This activity is a process where the design and technical aspects of the construction project are examined and evaluated. | The purpose is to determine the feasibility of the project and to identify potential issues and constraints that may impact the project’s success. |
3 | 13 | Preliminary cost estimates | This activity creates an initial cost approximation for the project by assessing the scope of work, material requirements, and labor necessities. | It aims to ensure financial feasibility and helps to secure appropriate funding, a critical step within Norway’s prudent fiscal management framework for infrastructure projects |
3 | 14 | Municipal sub-plan/zoning plan cost estimation | This activity develops detailed cost estimates for preparing municipal sub-plans and zoning plans, considering the size and complexity of the designated area. | It allows for accurate budgetary planning in line with local government regulations and guidelines, fostering smooth transitions through the zoning and planning phases, a necessity in the well-regulated construction sector. |
3 | 15 | Developing zoning plan | This activity is a process of creating a plan for the use and development of land within a defined geographic area. | The goal is to regulate land use and development, so it aligns with the overall goals and objectives of the municipality. |
3 | 16 | Prepare a progress plan for the entire project implementation | This activity is a process of creating a comprehensive plan that outlines the steps and milestones that must be achieved to complete the project successfully. | Activity is critical for good project management as it aims to produce a progress plan that shows risky activities, milestones, dependencies, and slack. |
4 | 17 | Interdisciplinary engineering | This activity facilitates the collaboration of various engineering disciplines to integrate diverse expertise in the design and development phases of the project. | It requires the participation of engineers from different specialties to work together as it aims to develop solutions to complex problems. |
4 | 18 | Detailed engineering | This activity is a process of refining the project’s design and developing specific solutions for each aspect of the project. | The goal is to ensure that the design of the project meets the project’s objectives, and constructability and complies with codes and standards. |
4 | 19 | Product-adapted engineering | This activity is a process of customizing or modifying a product to meet specific requirements. | It enhances project efficiency and effectiveness by tailoring engineering solutions to specific project needs, a strategy aligned with the complex yet flexible spirit of infrastructure construction projects. |
4 | 20 | Production planning | This activity is a process of determining what products or services to produce. | It aims to evaluate how much to produce, and when to produce to meet customer demand. |
Top Activities for ECI | Activity Description | Bottom Activities for ECI | Activity Description |
---|---|---|---|
Activity 9 | Identify risks and opportunities | Activity 4 | Preparing main options and establishing concepts definition. |
Activity 16 | Prepare a progress plan for the entire project implementation | Activity 2 | Stakeholder analysis |
Activity 10 | Quality plan, including HSE and environmental plan | Activity 5 | Defining assumptions and defining the scope |
Activity 12 | Volume studies and analyses of concept | Activity 14 | Municipal sub-plan/zoning plan cost estimation |
Activity 7 | Detailed scope of work | Activity 1 | Describing the societal goals and impact goals |
