Risk Identification of Building Construction Projects in Egypt
Abstract
:1. Introduction
2. Materials and Methods
2.1. Data Collection
2.2. Questionnaire Preparation

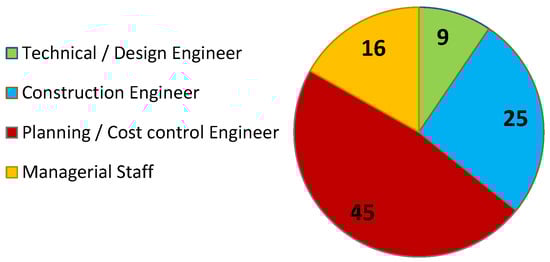

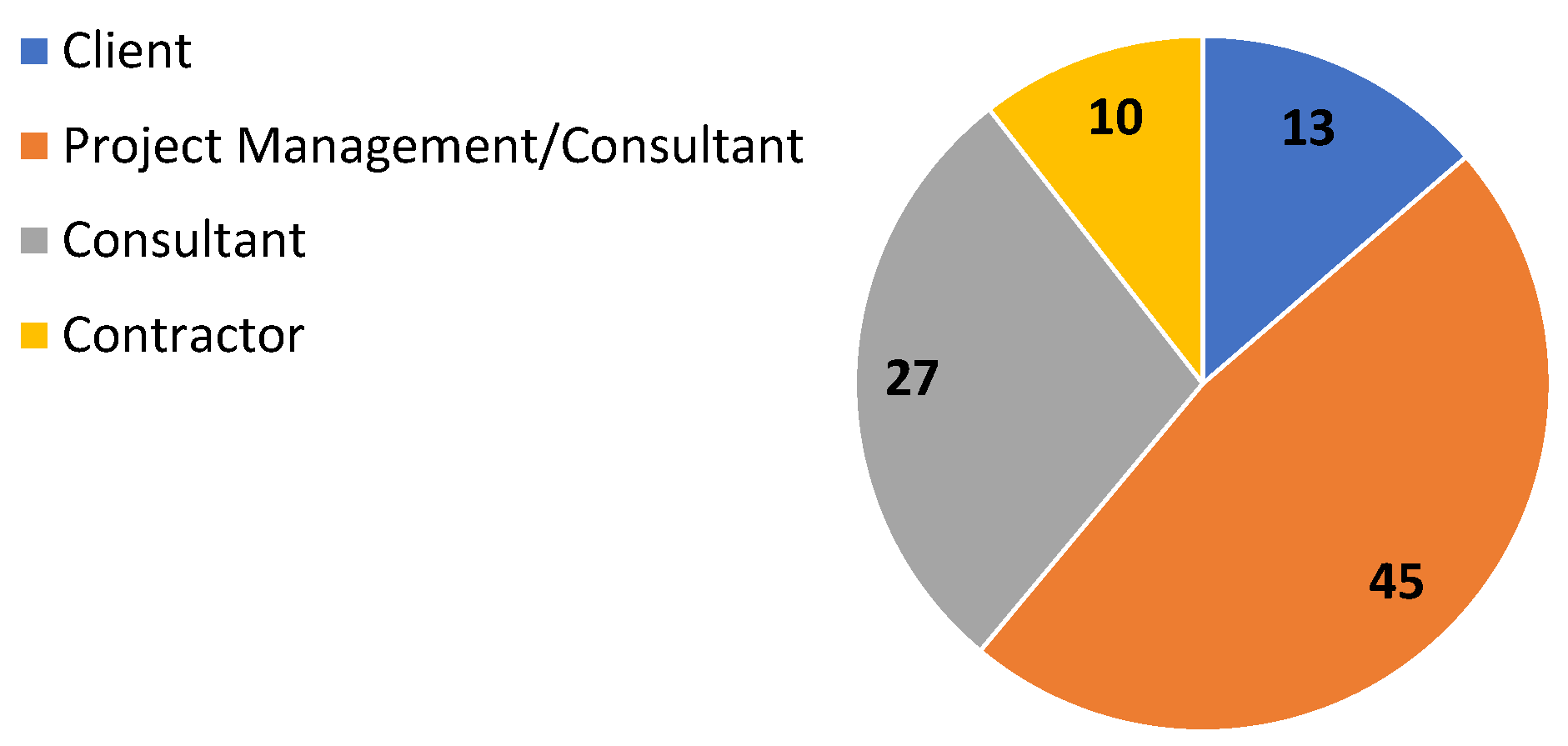

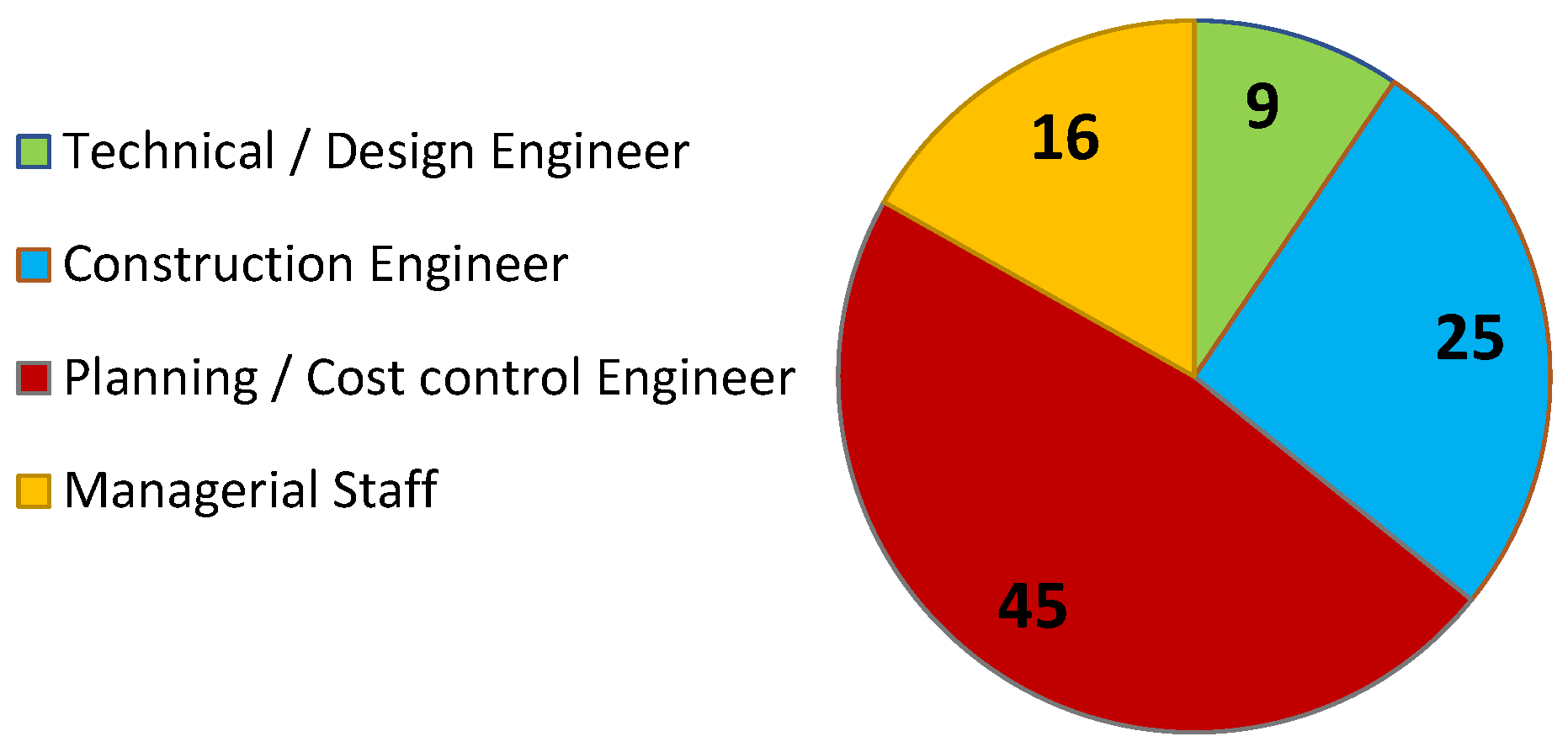

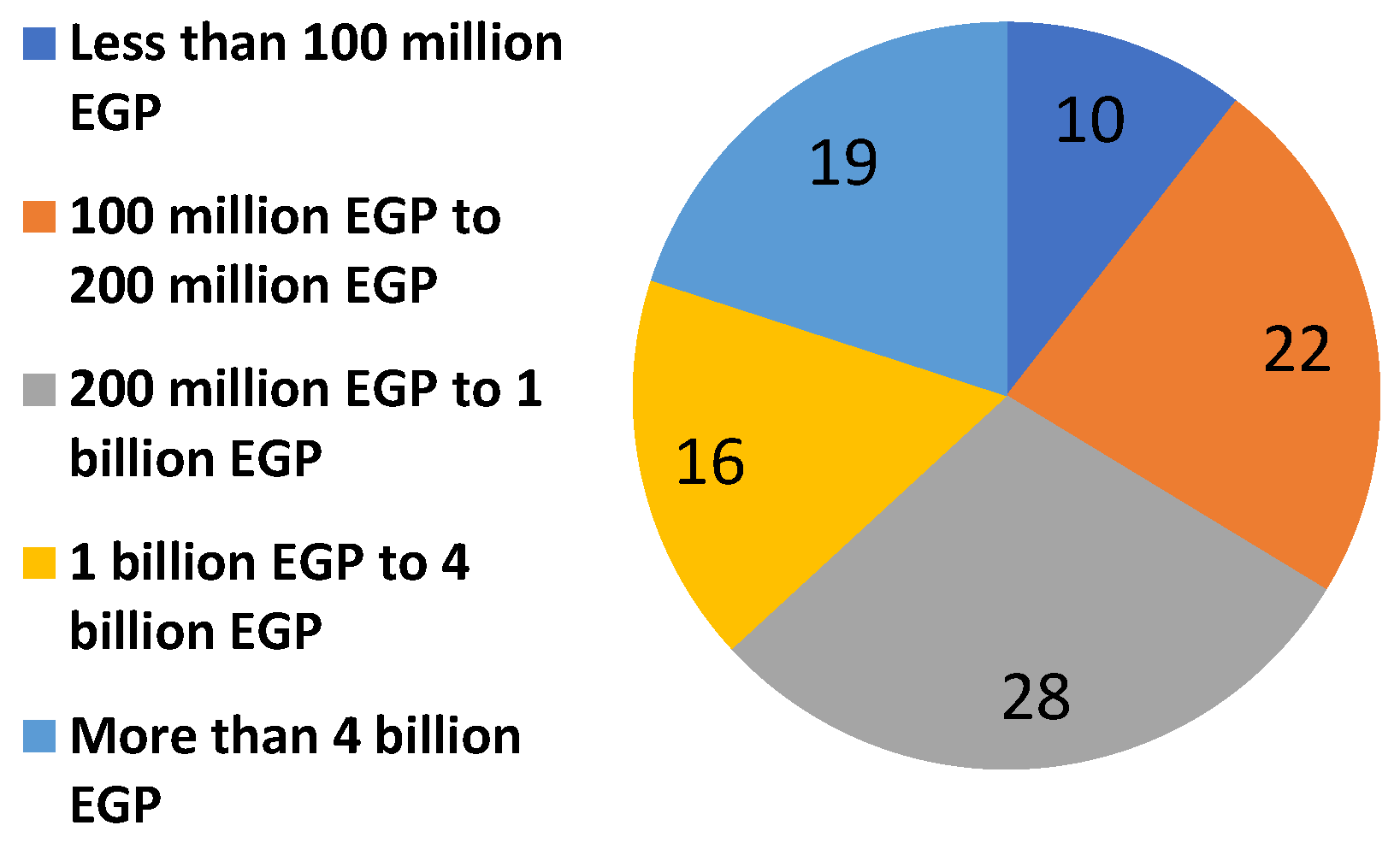

- Section 1 included information about the past experiences of the participants and their companies, such as job title/designation, company size and the number of employees in their companies, the annual estimated budget of their companies’ projects, and their years of experience in the building of construction projects in Egypt.
- Section 3 was related to driving mitigation and corrective actions for the top 10 risk factors on the basis of the structured interviews with expert engineers from the construction industry in Egypt.

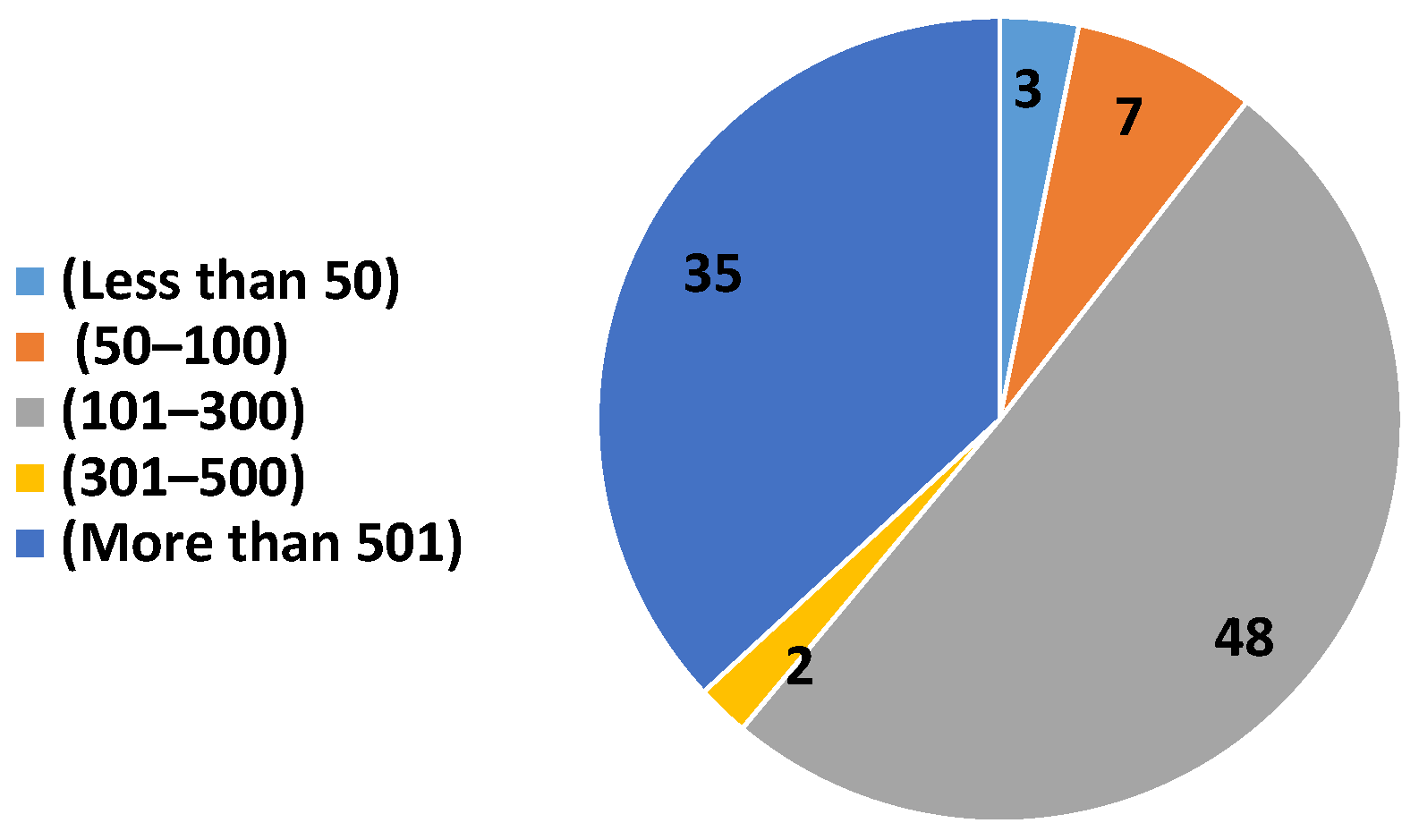

2.3. Questionnaire Distribution
3. Results
- Risk factors related to planning and controlling.
- Risk factors related to execution.
- Risk factors related to regulation.
- Risk factors related to project finance.
- Risk factors related to communication.
- Risk factors related to unforeseen conditions.
- Risk factors related to resources.
4. Discussion
- Funding problems from contractors.
- Material price fluctuations.
- Unrealistic estimated duration for project activities/phases.
- Shortage of construction materials in the market.
- Changing laws, especially those related to importation and exportation of construction materials.
- Currency exchange rate.
- Changes in material types and specifications during construction.

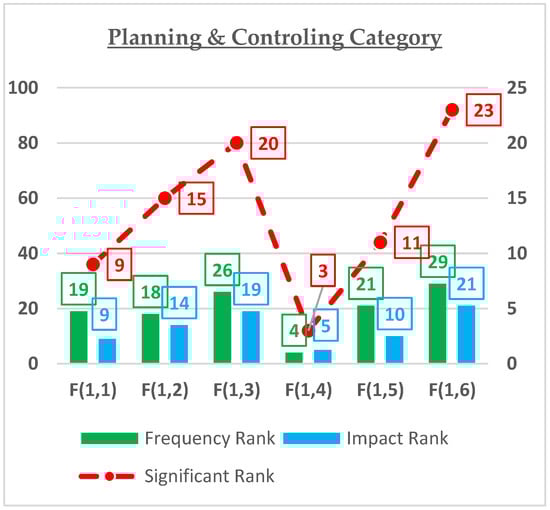

4.1. Planning and Controlling Category
4.2. Execution Category
4.3. Regulation Category
4.4. Finance Category
4.5. Communication Category
4.6. Unforeseen Conditions Category
4.7. Resources Category
5. Conclusions
5.1. Academic and Practical Contributions
5.2. Recommendations for Academic Applications and Practice
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Conflicts of Interest
References
- Abd El-Karim, M.S.B.A.; Mosa El Nawawy, O.A.; Abdel-Alim, A.M. Identification and assessment of risk factors affecting construction projects. HBRC J. 2017, 13, 202–216. [Google Scholar] [CrossRef]
- Kabirifar, K.; Mojtahedi, M. The impact of engineering, procurement and construction (EPC) phases on project performance: A case of large-scale residential construction project. Buildings 2019, 9, 15. [Google Scholar] [CrossRef]
- Schoonwinkel, S.; Fourie, C.J. A risk and cost management analysis for changes during the construction phase of a project. J. S. Afr. Inst. Civ. Eng. 2016, 58, 21–28. [Google Scholar] [CrossRef]
- Edition, P.S. A Guide to the Project Management Body of Knowledge; Project Management Institute: Newtown Square, PA, USA, 2018. [Google Scholar]
- Kassem, M.A.; Khoiry, M.A.; Hamzah, N. Using relative importance index method for developing risk map in oil and gas construction projects. J. Kejuruter. 2020, 32, 441–453. [Google Scholar] [CrossRef] [PubMed]
- Abdel-Monem, M.; Alshaer, K.T.; El-Dash, K. Assessing Risk Factors Affecting the Accuracy of Conceptual Cost Estimation in the Middle East. Buildings 2022, 12, 950. [Google Scholar] [CrossRef]
- Safaeian, M.; Fathollahi-Fard, A.M.; Kabirifar, K.; Yazdani, M.; Shapouri, M. Selecting appropriate risk response strategies considering utility function and budget constraints: A case study of a construction company in Iran. Buildings 2022, 12, 98. [Google Scholar] [CrossRef]
- Habibi Rad, M.; Mojtahedi, M.; Ostwald, M.J. Industry 4.0, disaster risk management and infrastructure resilience: A systematic review and bibliometric analysis. Buildings 2021, 11, 411. [Google Scholar] [CrossRef]
- Bahamid, R.A.; Doh, S.I.; Khoiry, M.A.; Kassem, M.A.; Al-Sharafi, M.A. The Current Risk Management Practices and Knowledge in the Construction Industry. Buildings 2022, 12, 1016. [Google Scholar] [CrossRef]
- Lapidus, A.; Topchiy, D.; Kuzmina, T.; Chapidze, O. Influence of the Construction Risks on the Cost and Duration of a Project. Buildings 2022, 12, 484. [Google Scholar] [CrossRef]
- Pham, D.H.; Ly, D.H.; Tran, N.K.; Ahn, Y.H.; Jang, H. Developing a risk management process for general contractors in the bidding stage for design–build projects in Vietnam. Buildings 2021, 11, 542. [Google Scholar] [CrossRef]
- Elfahham, Y. Estimation and prediction of construction cost index using neural networks, time series, and regression. Alex. Eng. J. 2019, 58, 499–506. [Google Scholar] [CrossRef]
- Guan, L.; Liu, Q.; Abbasi, A.; Ryan, M.J. Developing a comprehensive risk assessment model based on fuzzy Bayesian belief network (FBBN). J. Civ. Eng. Manag. 2020, 26, 614–634. [Google Scholar] [CrossRef]
- Jahan, S.; Khan, K.I.A.; Thaheem, M.J.; Ullah, F.; Alqurashi, M.; Alsulami, B.T. Modeling Profitability-Influencing Risk Factors for Construction Projects: A System Dynamics Approach. Buildings 2022, 12, 701. [Google Scholar] [CrossRef]
- Rogers, H.; Srivastava, M.; Pawar, K.S.; Shah, J. Supply chain risk management in India–practical insights. Int. J. Logist. Res. Appl. 2016, 19, 278–299. [Google Scholar] [CrossRef]
- Malekela, K.N.; Mohamed, J.; Ntiyankunze, S.K.; Mgwatu, M.I. Variations on Forecasted Construction Cash Flows of Building Projects: A Structural Equation Modelling (SEM) Approach. Int. J. Constr. Eng. Manag. 2017, 6, 197–208. [Google Scholar]
- Otali, M.; Odesola, I.A. Effectiveness evaluation of contingency sum as a risk management tool for construction projects in Niger Delta, Nigeria. Ethiop. J. Environ. Stud. Manag. 2014, 7, 588–598. [Google Scholar] [CrossRef]
- Qazi, A.; Quigley, J.; Dickson, A.; Kirytopoulos, K. Project Complexity and Risk Management (ProCRiM): Towards modelling project complexity driven risk paths in construction projects. Int. J. Proj. Manag. 2016, 34, 1183–1198. [Google Scholar] [CrossRef]
- Larsen, J.K.; Shen, G.Q.; Lindhard, S.M.; Brunoe, T.D. Factors affecting schedule delay, cost overrun, and quality level in public construction projects. J. Manag. Eng. 2016, 32, 04015032. [Google Scholar] [CrossRef]
- Gomarn, P.; Pongpeng, J. Causes of construction delay from contractors and suppliers in Thailand’s oil and gas platform projects. MATEC Web Conf. 2018, 192, 02008. [Google Scholar] [CrossRef]
- Abdel-Alim, A.M.; Said, S.O.M. Dynamic labor tracking system in construction project using bim technology. Int. J. Civ. Struct. Eng. Res. 2021, 9, 10–20. [Google Scholar]
- Kumar, V.; Kumar, V.; Rao, Y.V.; Veeramalla, S. Supply Chain Performance influencer in construction domain: A Key factor analysis: Supply Chain Performance influencer. Int. J. Supply Chain. Manag. 2019, 4, 1–7. [Google Scholar]
- Gebrehiwet, T.; Luo, H. Analysis of delay impact on construction project based on RII and correlation coefficient: Empirical study. Procedia Eng. 2017, 196, 366–374. [Google Scholar] [CrossRef]
- Mahmoud, H.; Ahmed, V.; Beheiry, S. Construction cash flow risk index. J. Risk Financ. Manag. 2021, 14, 269. [Google Scholar] [CrossRef]
- Abdelalim, A.M.; El Nawawy, O.A.; Bassiony, M.S. Decision Supporting System for Risk Assessment in Construction Projects: AHP-Simulation Based. IPASJ Int. J. Comput. Sci. (IIJCS) 2016, 4, 22–36. [Google Scholar]
- Rasheed, N.; Shahzad, W.; Khalfan, M.; Rotimi, J.O.B. Risk identification, assessment, and allocation in PPP projects: A systematic review. Buildings 2022, 12, 1109. [Google Scholar] [CrossRef]
- Wang, C.; Tang, Y.; Kassem, M.A.; Ong, H.Y.; Yap, J.B.H.; Ali, K.N. Novel Quality-Embedded Earned Value Performance Analysis Tool for Sustainable Project Portfolio Production. Sustainability 2022, 14, 8174. [Google Scholar] [CrossRef]
- Ullah, S.; Mufti, N.A.; Qaiser Saleem, M.; Hussain, A.; Lodhi, R.N.; Asad, R. Identification of factors affecting risk appetite of organizations in selection of mega construction projects. Buildings 2022, 12, 2. [Google Scholar] [CrossRef]
- Johnson, R.M.; Babu, R.I.I. Time and cost overruns in the UAE construction industry: A critical analysis. Int. J. Constr. Manag. 2020, 20, 402–411. [Google Scholar] [CrossRef]
- Banerjee Chattapadhyay, D.; Putta, J.; Rao, P.R.M. Risk identification, assessments, and prediction for mega construction projects: A risk prediction paradigm based on cross analytical-machine learning model. Buildings 2021, 11, 172. [Google Scholar] [CrossRef]
- Kardes, I.; Ozturk, A.; Cavusgil, S.T.; Cavusgil, E. Managing global megaprojects: Complexity and risk management. Int. Bus. Rev. 2013, 22, 905–917. [Google Scholar] [CrossRef]
- Adeleke, A.Q.; Bahaudin, A.Y.; Kamaruddeen, A.M.; Bamgbade, J.A.; Ali, M.W. An empirical analysis of organizational external factors on construction risk management. Int. J. Supply Chain Manag. 2019, 8, 932. [Google Scholar]
- Karthick, S.; Kermanshachi, S.; Loganathan, K. Impact of Construction Workers’ Physical Health and Respiratory Issues in Hot Weather: A Pilot Study. In Proceedings of the Transportation Consortium of South-Central States (Tran-SET) Conference, San Antonio, TX, USA, 31 August–2 September 2022; pp. 135–145. [Google Scholar]
- Saunders, M.; Lewis, P.; Thornhill, A. Research Methods for Business Students; Pearson Education: London, UK, 2009. [Google Scholar]
- Mwita, K. Factors to consider when choosing data collection methods. Int. J. Res. Bus. Soc. Sci. 2022, 11, 532–538. [Google Scholar] [CrossRef]

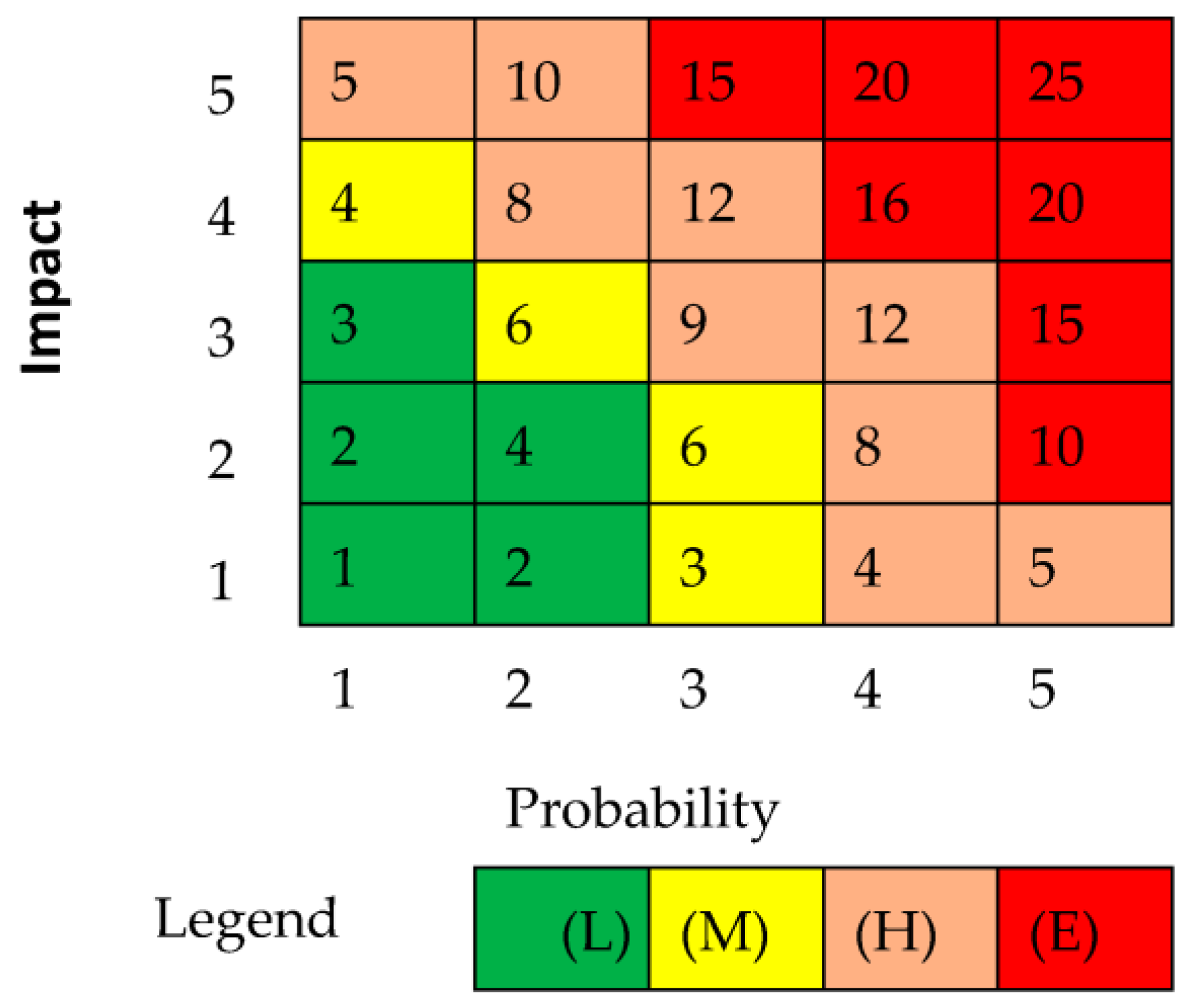

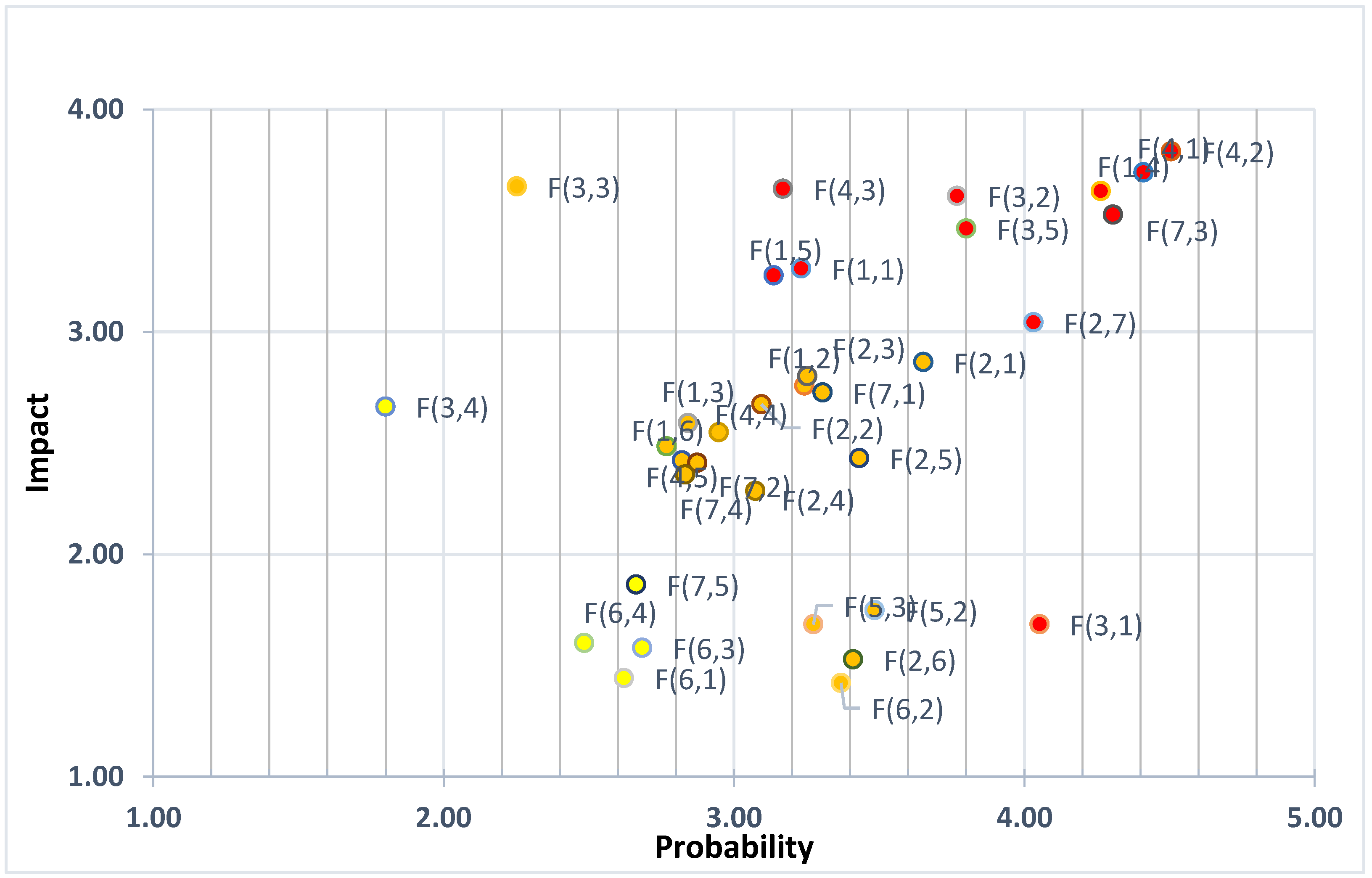

Category | Never | Rarely | Sometimes | Often | Greatly Often |
---|---|---|---|---|---|
Rating | 1 | 2 | 3 | 4 | 5 |
SN | Factor | FI | F | II | IR | SI | SR |
---|---|---|---|---|---|---|---|

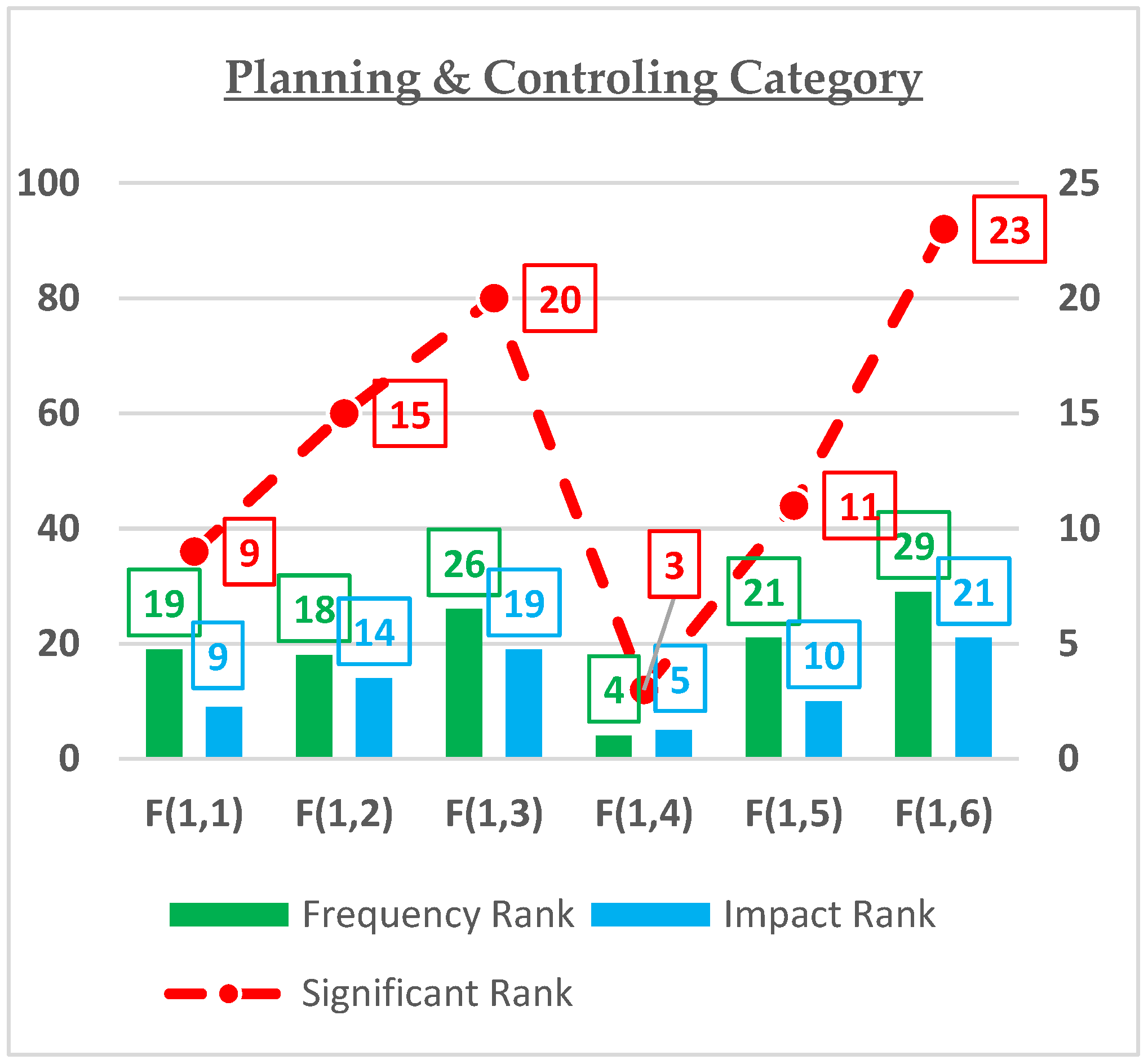

Planning and controlling | |||||||
F(1,1) | Inaccurate site investigations prior to commencing construction | 3.23 | 19 | 3.28 | 9 | 10.61 | 9 |
F(1,2) | Inadequate planning—poor site management | 3.24 | 18 | 2.76 | 14 | 8.94 | 15 |
F(1,3) | Lack of delivering and connecting utilities services (i.e., electricity, water) | 2.84 | 26 | 2.59 | 19 | 7.36 | 20 |
F(1,4) | Unrealistic estimated duration for project activities/phases | 4.26 | 4 | 3.63 | 5 | 15.48 | 3 |
F(1,5) | Delay in delivery of materials | 3.14 | 21 | 3.25 | 10 | 10.20 | 11 |
F(1,6) | Delay in obtaining permits and licenses | 2.77 | 29 | 2.48 | 21 | 6.88 | 23 |

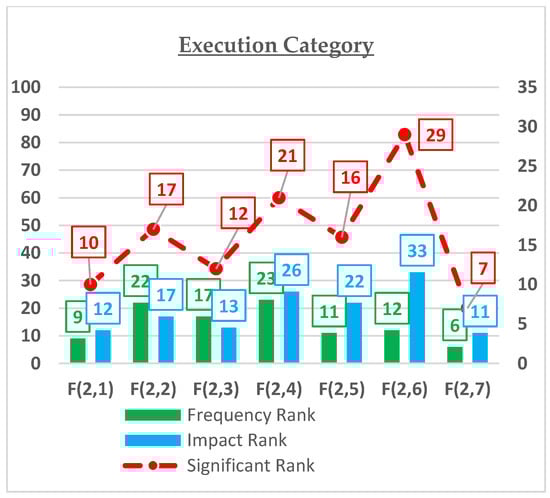

Execution | |||||||
F(2,1) | Changing of scope | 3.65 | 9 | 2.86 | 12 | 10.46 | 10 |
F(2,2) | Delay in approving design documents | 3.09 | 22 | 2.67 | 17 | 8.27 | 17 |
F(2,3) | Delay in performing inspection and testing during the project, excluding final tests | 3.25 | 17 | 2.80 | 13 | 9.11 | 12 |
F(2,4) | Delay in performing final inspection | 3.07 | 23 | 2.28 | 26 | 7.02 | 21 |
F(2,5) | Inappropriate construction methods | 3.43 | 11 | 2.43 | 22 | 8.34 | 16 |
F(2,6) | Lack of quality for the submittals from contractors | 3.41 | 12 | 1.53 | 33 | 5.21 | 29 |
F(2,7) | Changing of material specification in the construction phase | 4.03 | 6 | 3.04 | 11 | 12.26 | 7 |

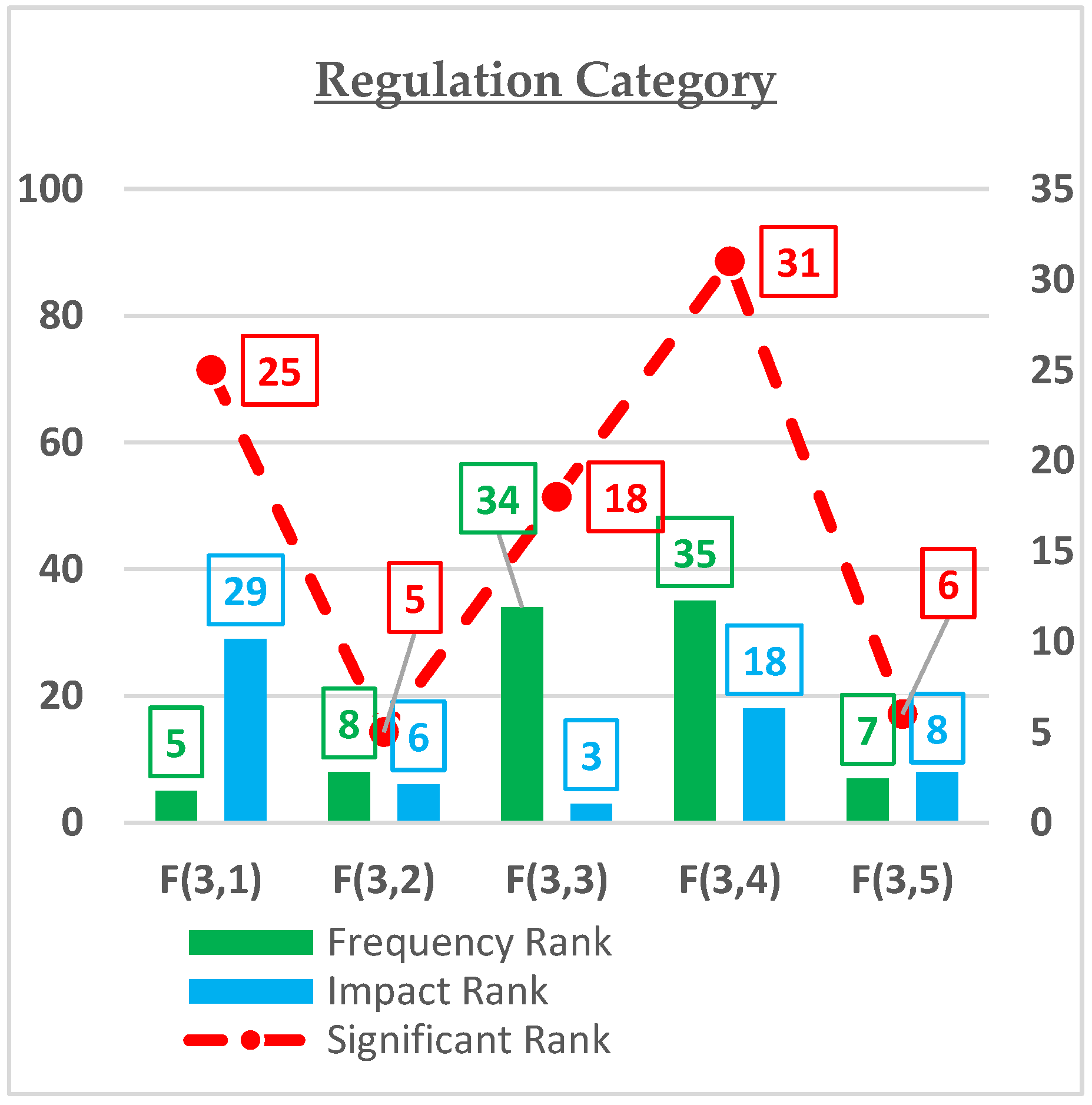

Regulation | |||||||
F(3,1) | Complicated administration process | 4.05 | 5 | 1.68 | 29 | 6.83 | 25 |
F(3,2) | Changing laws, especially those related to the importation and exportation of construction materials | 3.77 | 8 | 3.61 | 6 | 13.61 | 5 |
F(3,3) | Changing government regulations | 2.25 | 34 | 3.65 | 3 | 8.23 | 18 |
F(3,4) | Strong political opposition/hostility | 1.80 | 35 | 2.66 | 18 | 4.79 | 31 |
F(3,5) | Currency exchange rate | 3.80 | 7 | 3.46 | 8 | 13.16 | 6 |

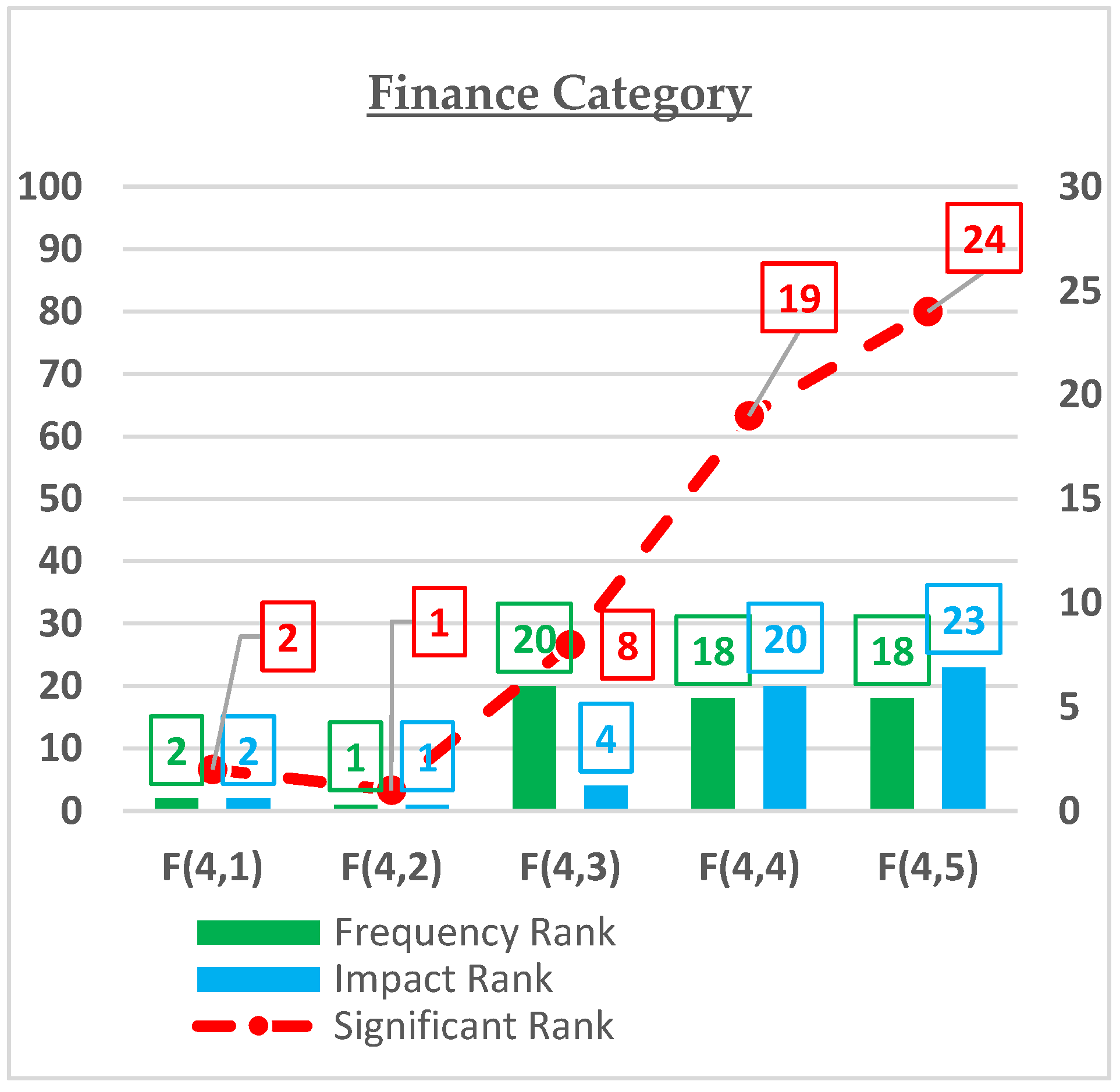

Project finance | |||||||
F(4,1) | Material price fluctuations | 4.41 | 2 | 3.72 | 2 | 16.39 | 2 |
F(4,2) | Funding problems from contractors | 4.51 | 1 | 3.81 | 1 | 17.17 | 1 |
F(4,3) | Delay in the certification of contractor payments | 3.17 | 20 | 3.64 | 4 | 11.54 | 8 |
F(4,4) | Delay in paying staff salaries | 2.95 | 18 | 2.55 | 20 | 7.51 | 19 |
F(4,5) | Delay in the certification of consultant payments | 2.82 | 18 | 2.42 | 23 | 6.83 | 24 |

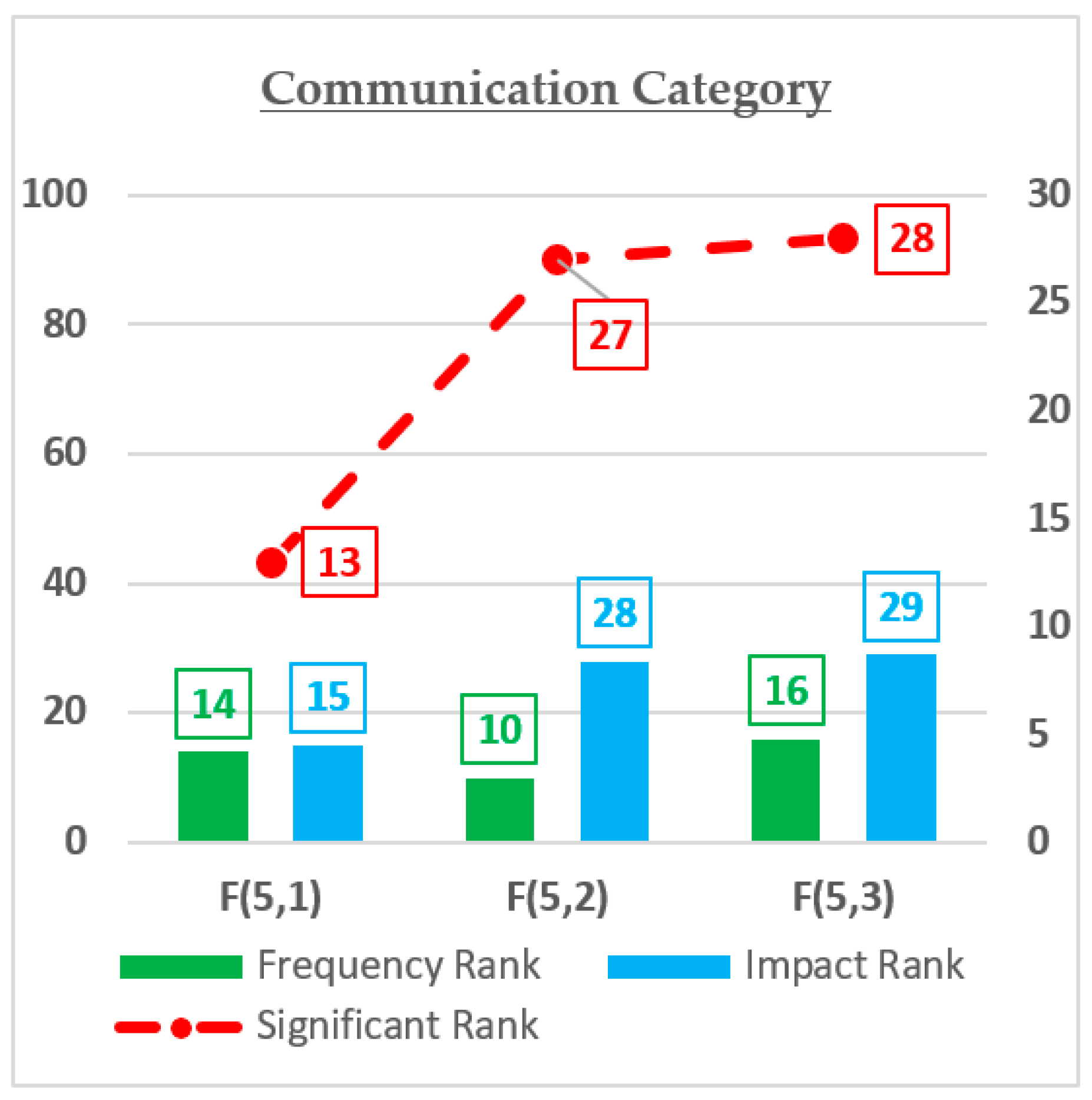

Communication | |||||||
F(5,1) | Poor communication between clients, consultants, and contractors | 3.31 | 14 | 2.73 | 15 | 9.01 | 13 |
F(5,2) | Lack of design requirements | 3.48 | 10 | 1.75 | 28 | 6.09 | 27 |
F(5,3) | Misunderstanding of authorities’ requirements | 3.27 | 16 | 1.68 | 29 | 5.52 | 28 |

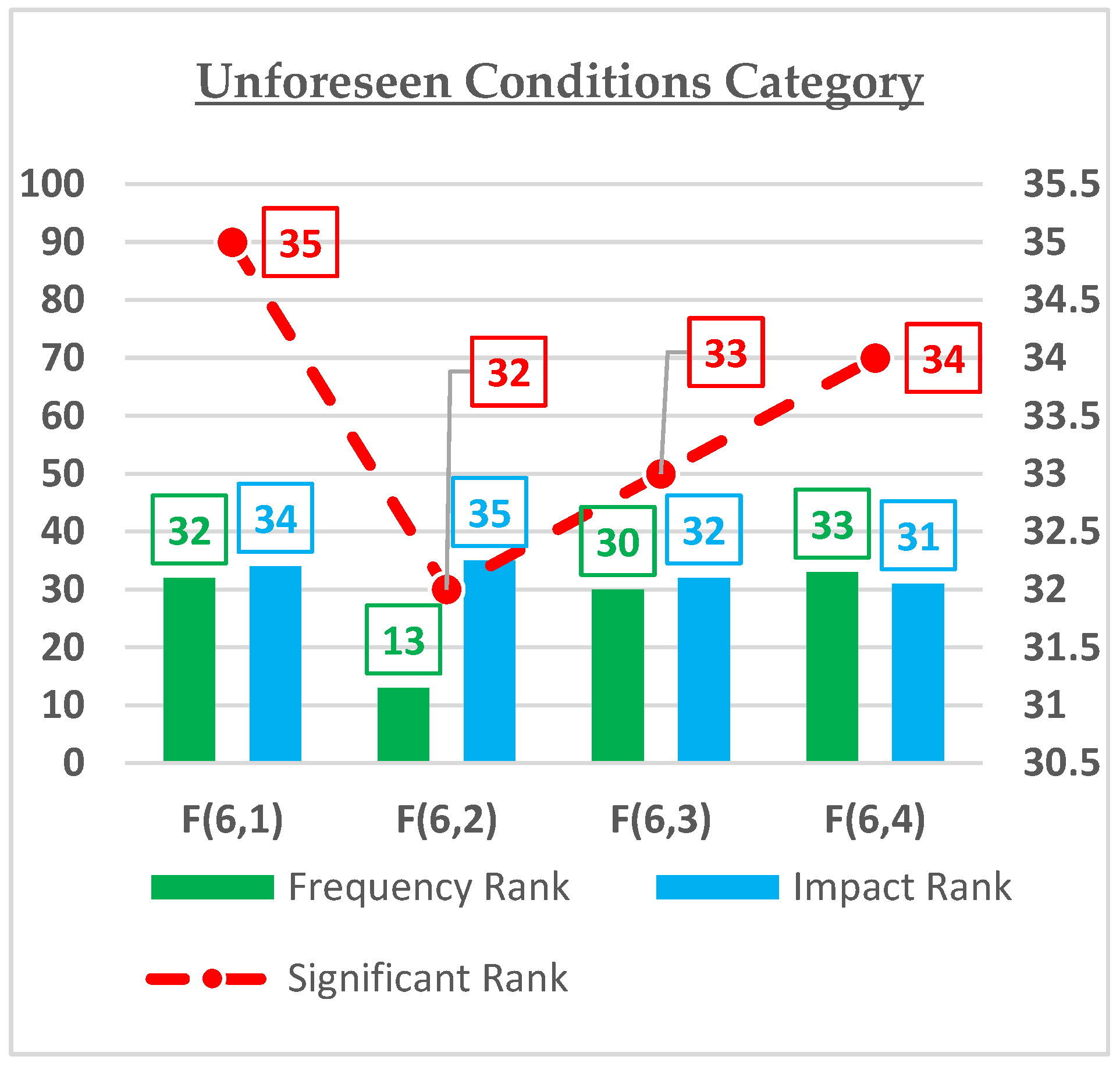

Unforeseen conditions | |||||||
F(6,1) | Accidental condition (HSE, natural disaster, labor dispute) | 2.62 | 32 | 1.44 | 34 | 3.78 | 35 |
F(6,2) | Site conditions (i.e., neighbors’ restrictions, etc.) | 3.37 | 13 | 1.42 | 35 | 4.79 | 32 |
F(6,3) | Bad weather | 2.68 | 30 | 1.58 | 32 | 4.24 | 33 |
F(6,4) | Labor unrest/strikes | 2.48 | 33 | 1.60 | 31 | 3.98 | 34 |

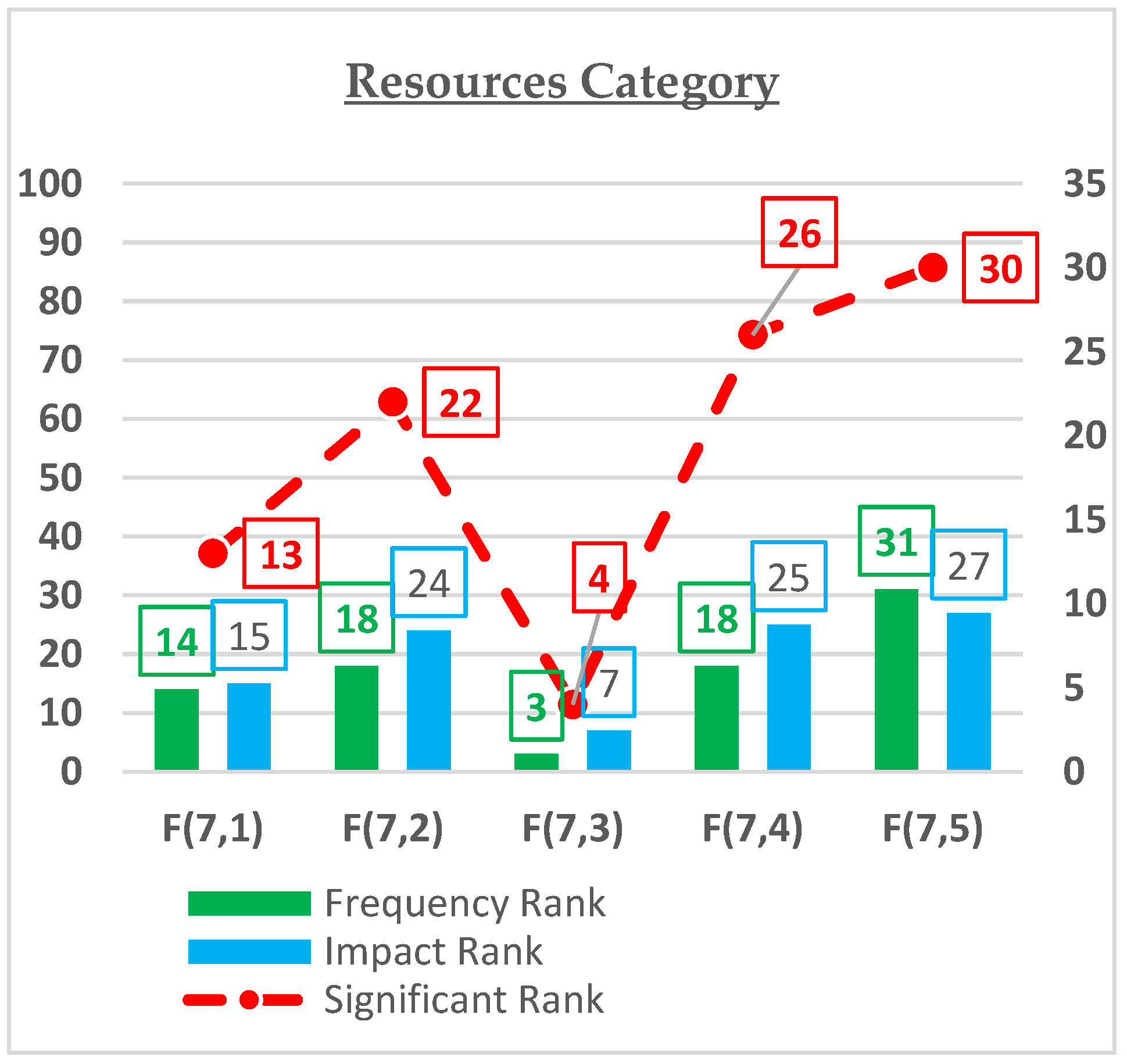

Resources | |||||||
F(7,1) | Availability of skilled labor | 3.31 | 14 | 2.73 | 15 | 9.01 | 13 |
F(7,2) | Availability of equipment | 2.87 | 18 | 2.41 | 24 | 6.93 | 22 |
F(7,3) | Shortage of construction materials in the market | 4.31 | 3 | 3.53 | 7 | 15.18 | 4 |
F(7,4) | Capability of subcontractors/suppliers | 2.83 | 18 | 2.36 | 25 | 6.68 | 26 |
F(7,5) | Possibility of maintaining equipment easily | 2.66 | 31 | 1.86 | 27 | 4.96 | 30 |
