Factors and Areas of PgMO Supporting the Success of the Program Management in the Construction Sector
Abstract
:1. Introduction
- What are the critical success factors for a program that PgMO can influence in the construction sector?
- What areas of PgMO support the success of the program in the construction sector?
- What functions, relative to PgMO-identified areas, support program success in the construction sector?
2. Theoretical Background
2.1. The Significance and Role of Program Management Office in Best Practice Standards
- Tracking measurements and reporting progress against plans;
- Storing originals of all program information and preparing documentation on quality and supervision;
- Supporting the program manager in controlling the program budget and controlling the costs of component projects;
- Monitoring risks and issues;
- Analyzing interfaces and critical dependencies between projects;
- Maintaining a list of stakeholders and their areas of interest;
- Establishing consistent practices and standards coherent with program governance, including all processes;
- Controlling program changes.
- Defining program management processes and procedures that will be used;
- Supporting program-level schedule and budget management;
- Defining quality standards for the program and its components;
- Supporting effective resource management throughout the program;
- Ensuring document and configuration management (knowledge management);
- Providing centralized support for change management and tracking of risks and issues.
- Monitoring, reviewing, and reporting;
- Risk, issue, and change management;
- Finance;
- Commercial (including supplier management);
- Quality assurance;
- Information management (including configuration and asset management);
- Transition management;
- Administration.
2.2. Success Factors of Programs in the Construction Sector

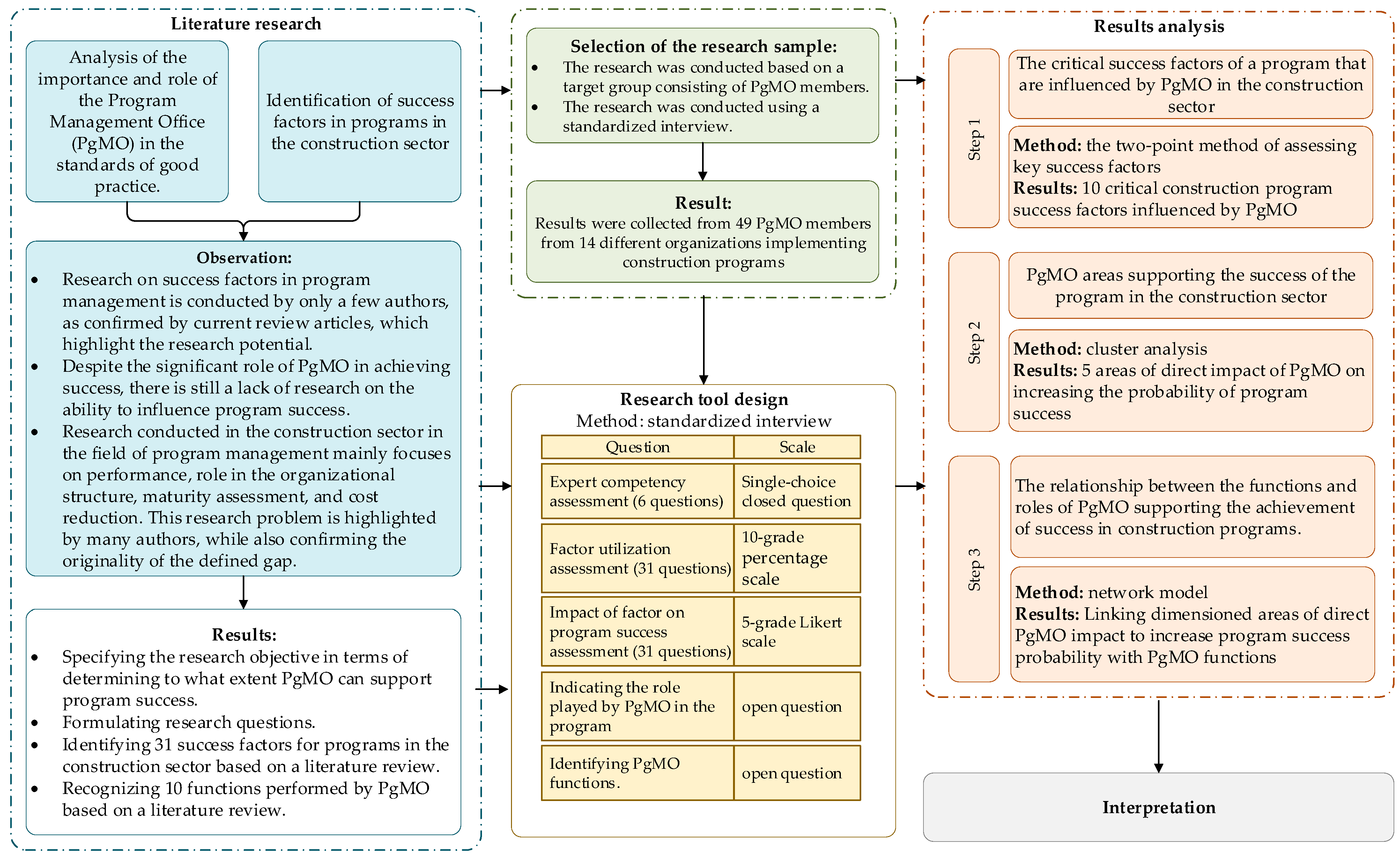

3. Materials and Methods
- What are the critical success factors for a program that PgMO can influence in the construction sector?
- What areas of PgMO support the success of the program in the construction sector?
- What functions, relative to PgMO identified areas, support program success in construction sector?
3.1. Selection of the Research Sample
- kz—the coefficient of the expert’s familiarity with the issue
- ka—the coefficient of argumentation
3.2. Construction of the Interview Questionnaire
- Expert competency assessment (6 questions);
- Factor utilization assessment (31 questions, expressed on a 10-point percentage scale);
- Impact of factors on program success assessment (31 questions, expressed on a 5-point Likert scale);
- Indicating the role played by PgMO in the program;
- Identifying PgMO functions.
4. Results
4.1. The Critical Success Factors of a Program That Are Influenced by PgMO in the Construction Sector
4.2. PgMO Areas Supporting the Success of the Program in the Construction Sector
- identification of the maximum of the measure

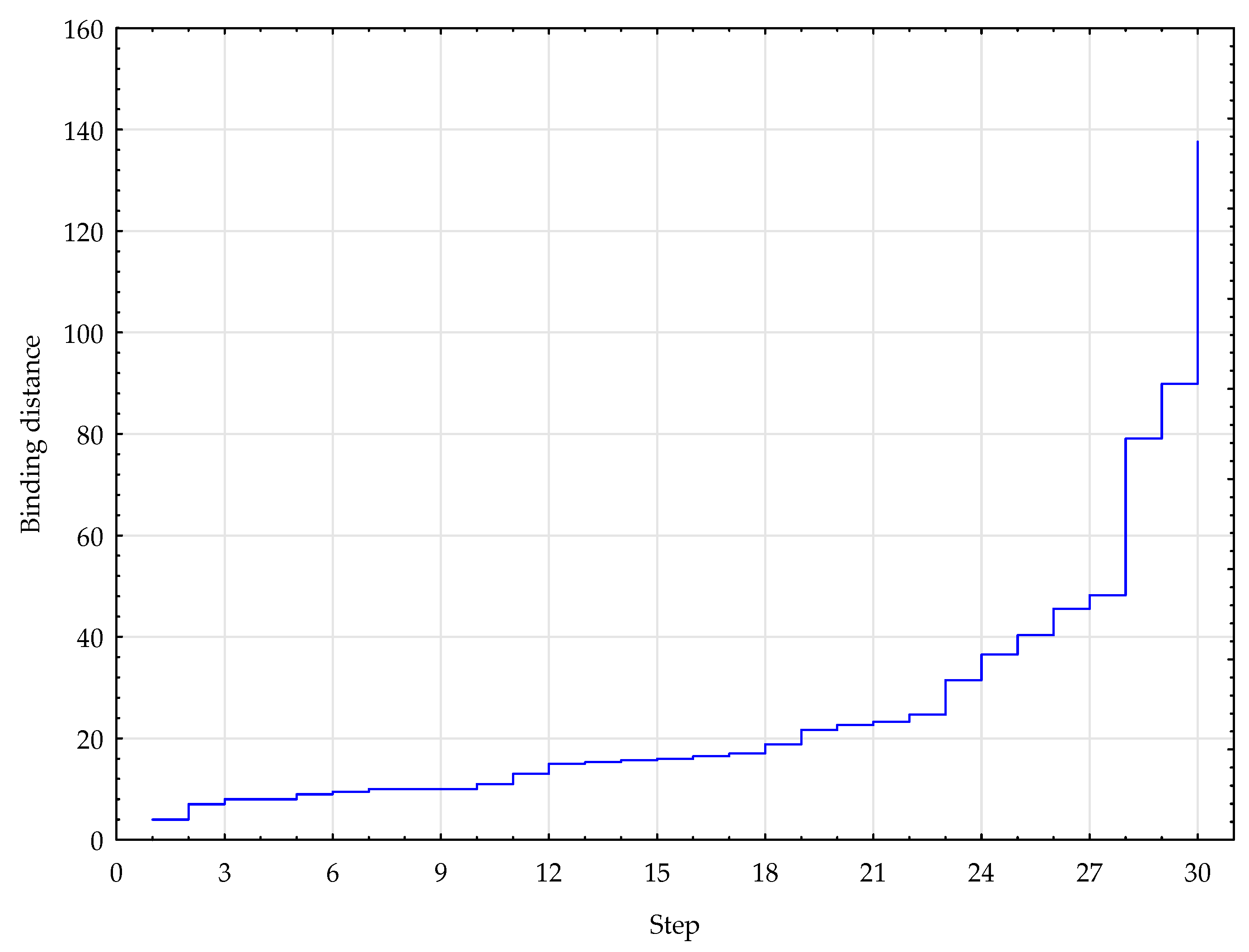

- —the length of the i-th branch of the tree
- Cluster C1 is conditioned by the processes related to maintaining program governance.
- Cluster C2 covers issues related to program initiation.
- Cluster C3 focuses on aspects related to program planning and budgeting.
- Cluster C4 covers processes directly related to engaging program stakeholders and building and maintaining relationships.
- Cluster C5 focuses on managing program requirements and the knowledge arising from program implementation.
4.3. The Relationship between the Functions and Identified Areas of PgMO Supporting the Achievement of Success in Construction Programs
- PgMO supports maintaining program governance (C1) through five functions. However, it should be noted that only two of them (defining program goals and objectives—O1 and ensuring that program risks are identified and managed effectively—O7) have the majority share of connections. The others include only single influences in terms of success factors.
- In the area related to program initiation (C2), the distribution of functions is evenly spread in relation to other areas. Therefore, it can be concluded that the necessary PgMO functions in this area include allocating resources and assigning roles and responsibilities (O3), providing project management guidance and best practices (O4), monitoring program progress and making adjustments as needed (O5), and tracking program finances and ensuring that the program stays within budget (O9).
- Area C3 related to program planning and budgeting shows the smallest share in terms of generated connections. The functions that can support this area (i.e., developing a program plan and schedule (O2), monitoring program progress and adjusting as needed (O5), and tracking program finances and ensuring that the program stays within budget (O9)) have only single connections.
- PgMO support for achieving program success through stakeholder engagement and relationship building (C4) is primarily identified within the function of facilitating communication and collaboration among stakeholders (O6). Additional support impact is highlighted in the case of functions related to allocating resources and assigning roles and responsibilities (O3), providing project management guidance and best practices (O4), and providing oversight and quality assurance for project deliverables (O8).
- The last recognized area related to managing program requirements and the knowledge arising from program implementation (C5) is influenced by five functions. Moreover, in this case, there is one direct connection in the area of program knowledge and information management (O10). The remaining four functions have only a small impact on supporting this area.
5. Discussion
5.1. What Are the Critical Success Factors for a Program That PgMO Can Influence in the Construction Sector?

- Optimal resource allocation.
- Supervision over the program.
- Budgeting the program.
- Stakeholder management.
- Program risk management.
- Program cost management.
- Communication management.
- Resource allocation between projects.
- Program planning.
- Approval of the program plan and its evaluation.
5.2. What Areas of PgMO Support the Success of the Program in the Construction Sector?
5.3. What Functions, Relative to PgMO-Identified Areas, Support Program Success in the Construction Sector?
5.4. Theoretical and Practical Implications
- The functions of defining program goals and objectives and managing program risks have the most significant impact on program governance.
- Program initiation requires an even distribution of PgMO functions, including optimal resource allocation and role assignment, project management guidance, program progress monitoring, and financial tracking.
- The smallest share of connections is related to program planning and budgeting. Only a few functions, such as developing a program plan and schedule, program progress monitoring, and financial tracking, can support this area.
- Stakeholder engagement and relationship building require the PgMO to facilitate communication and collaboration among stakeholders and provide project management guidance and quality assurance.
- Managing program requirements and knowledge arising from program implementation can be supported by functions, such as program knowledge and information management, quality assurance, and program progress monitoring.
6. Conclusions
Funding
Data Availability Statement
Conflicts of Interest
References
- Jia, G.; Chen, Y.; Xue, X.; Chen, J.; Cao, J.; Tang, K. Program management organization maturity integrated model for mega construction programs in China. Int. J. Proj. Manag. 2011, 29, 834–845. [Google Scholar] [CrossRef]
- Yan, H.; Elzarka, H.; Gao, C.; Zhang, F.; Tang, W. Critical success criteria for programs in China: Construction companies’ perspectives. J. Manag. Eng. 2019, 35, 04018048. [Google Scholar] [CrossRef]
- Rawai, N.M.; Fathi, M.S.; Abedi, M. A Review of Project and Programme Management Reference Models for the Construction Industry. J. Constr. Eng. Manag. 2013, 2, 17–20. [Google Scholar]
- Hu, Y.; Chan, A.P.; Le, Y.; Jin, R.Z. From construction megaproject management to complex project management: Bibliographic analysis. J. Manag. Eng. 2015, 31, 04014052. [Google Scholar] [CrossRef]
- Shao, J.; Müller, R.; Turner, J.R. Measuring program success. Proj. Manag. J. 2012, 43, 37–49. [Google Scholar] [CrossRef]
- Martinsuo, M.; Hoverfält, P. Change program management: Toward a capability for managing value-oriented, integrated multi-project change in its context. Int. J. Proj. Manag. 2018, 36, 134–146. [Google Scholar] [CrossRef]
- Frederiksen, N.; Gottlieb, S.C.; Leiringer, R. Organising for infrastructure development programmes: Governing internal logic multiplicity across organisational spaces. Int. J. Proj. Manag. 2021, 39, 223–235. [Google Scholar] [CrossRef]
- Breese, R. Benefits realisation management: Panacea or false dawn? Int. J. Proj. Manag. 2012, 30, 341–351. [Google Scholar] [CrossRef]
- Fernandes, G.; O’Sullivan, D. Benefits management in university-industry collaboration programs. Int. J. Proj. Manag. 2021, 39, 71–84. [Google Scholar] [CrossRef]
- Miterev, M.; Engwall, M.; Jerbrant, A. Exploring program management competences for various program types. Int. J. Proj. Manag. 2016, 34, 545–557. [Google Scholar] [CrossRef]
- Angus, G.Y.; Kittler, M. Matching programme structure to environment: A comparative study of two IS-based change programmes. Int. J. Proj. Manag. 2012, 30, 740–749. [Google Scholar]
- Yan, H.; Yang, Y.; Lei, X.; Ye, Q.; Huang, W.; Gao, C. Regret Theory and Fuzzy-DEMATEL-Based Model for Construction Program Manager Selection in China. Buildings 2023, 13, 838. [Google Scholar] [CrossRef]
- Karamoozian, A.; Wu, D. A hybrid risk prioritization approach in construction projects using failure mode and effective analysis. Eng. Constr. Archit. Manag. 2020, 27, 2661–2686. [Google Scholar] [CrossRef]
- Trzeciak, M.; Jonek-Kowalska, I. Monitoring and control in program management as effectiveness drivers in polish energy sector. Diagnosis and directions of improvement. Energies 2021, 14, 4661. [Google Scholar] [CrossRef]
- Smits, K.; van Marrewijk, A. Chaperoning: Practices of collaboration in the panama canal expansion program. Int. J. Manag. Proj. Bus. 2012, 5, 440–456. [Google Scholar] [CrossRef]
- McGrath, S.K.; Whitty, S.J. What is a program: An examination of terminology in practitioner reference documents. J. Mod. Proj. Manag. 2019, 6, 6–27. [Google Scholar]
- McGrath, S.; Whitty, S.J. The suitability of MSP for engineering infrastructure. J. Mod. Proj. Manag. 2020, 7, 348–368. [Google Scholar]
- Midler, C.; Maniak, R.; de Campigneulles, T. Ambidextrous program management: The case of autonomous mobility. Proj. Manag. J. 2019, 50, 571–586. [Google Scholar] [CrossRef]
- Ritson, G.; Johansen, E.; Osborne, A. Successful programs wanted: Exploring the impact of alignment. Proj. Manag. J. 2012, 43, 21–36. [Google Scholar] [CrossRef]
- Van Buuren, A.; Buijs, J.M.; Teisman, G. Program management and the creative art of coopetition: Dealing with potential tensions and synergies between spatial development projects. Int. J. Proj. Manag. 2010, 28, 672–682. [Google Scholar] [CrossRef]
- Görög, M. Translating single project management knowledge to project programs. Proj. Manag. J. 2011, 42, 17–31. [Google Scholar] [CrossRef]
- Yousri, E.; Sayed, A.E.B.; Farag, M.A.M.; Abdelalim, A.M. Risk Identification of Building Construction Projects in Egypt. Buildings 2023, 13, 1084. [Google Scholar] [CrossRef]
- Al-Khouri, A.M. Program Management Philosophy and the Importance of a PgMO. In Program Management of Technology Endeavours: Lateral Thinking in Large Scale Government Program Management; Al Khouri, A., Ed.; Palgrave Macmillan: London, UK, 2015; pp. 42–86. [Google Scholar]
- Kunkle, J.; Contreras, A.; Abba, W.; Haase, M.; Pells, D.L. The Enterprise Program Management Office: Another Best Practice at the National Nuclear Security Administration. PMWJ 2017, 6, 1–14. [Google Scholar]
- AXELOS. Managing Successful Programmes, 2011 ed.; The Stationery Office: London, UK, 2014. [Google Scholar]
- Trzeciak, M. Research issues in programme management: A systematic review of literature. Sci. J. Sil. Univ. Technol. Ser. Org. Manag. 2022, 2022, 551–567. [Google Scholar]
- Higham, A.A.A. How project management office (PMO) can be established in the Saudi Arabian construction organisations. In Proceedings of the 13th International Postgraduate Research Conference 2017, Salford, UK, 14–15 September 2017; p. 597. [Google Scholar]
- Almansoori, M.T.S.; Rahman, I.A.; Memon, A.H. Correlation between the Management Factors Affecting PMO Implementation in UAE Construction. Int. J. Sustain. Constr. Eng. Technol. 2021, 12, 155–165. [Google Scholar] [CrossRef]
- Silvius, G. The role of the project management office in sustainable project management. Procedia Comput. Sci. 2021, 181, 1066–1076. [Google Scholar] [CrossRef]
- Kiani, S.; Yousefi, V.; Nouri, S.; Khadivi, A.M.; Mehrabanfar, E. Determining the role of project management office in the success of project-based organizations. Mediterr. J. Soc. Sci. 2015, 6, 325. [Google Scholar] [CrossRef]
- Szalay, I.; Kovács, Á.; Sebestyén, Z. Integrated framework for project management office evaluation. Procedia Eng. 2017, 196, 578–584. [Google Scholar] [CrossRef]
- Azevedo Junior, J.A.I.R.; Barroso, A.C.D.O.; Monteiro, C.A. An expedited model to appraise project management office value. Int. J. Dev. Res. 2022, 11, 52699–52704. [Google Scholar]
- Ershadi, M.; Atashfaraz, R. Improvement of project management office performance: An empirical investigation of effective factors in iranian construction industry. Int. J. Ind. Syst. Eng. 2016, 9, 146–164. [Google Scholar]
- Hu, Y.; Chan, A.P.; Le, Y.; Xu, Y.; Shan, M. Developing a program organization performance index for delivering construction megaprojects in China: Fuzzy synthetic evaluation analysis. J. Manag. Eng. 2016, 32, 05016007. [Google Scholar] [CrossRef]
- Oliveira, C.; Tereso, A.; Fernandes, G. PMO conceptualization for engineering and construction businesses. Procedia Comput. Sci. 2017, 121, 592–599. [Google Scholar] [CrossRef]
- Chen, X.; Wang, Z.; He, S.; Li, F. Programme management of world bank financed small hydropower development in Zhejiang Province in China. Renew. Sustain. Energy Rev. 2013, 24, 21–31. [Google Scholar] [CrossRef]
- Hu, Y.; Chan, A.P.; Le, Y. Understanding the determinants of program organization for construction megaproject success: Case study of the Shanghai Expo construction. J. Manag. Eng. 2015, 31, 05014019. [Google Scholar] [CrossRef]
- Teubner, R.A. IT program management challenges: Insights from programs that ran into difficulties. Int. J. Inf. Syst. Proj. Manag. 2018, 6, 71–92. [Google Scholar] [CrossRef]
- Shi, Q.; Zhou, Y.; Xiao, C.; Chen, R.; Zuo, J. Delivery risk analysis within the context of program management using fuzzy logic and DEA: A China case study. Int. J. Proj. Manag. 2014, 32, 341–349. [Google Scholar] [CrossRef]
- Ershadi, M.; Jefferies, M.; Davis, P.; Mojtahedi, M. Project management offices in the construction industry: A literature review and qualitative synthesis of success variables. Constr. Manag. Econ. 2021, 39, 493–512. [Google Scholar] [CrossRef]
- PMI. The Standard for Program Management, 4th ed.; Project Management Institute Inc.: Newtown Square, PA, USA, 2017. [Google Scholar]
- Roden, E.; Vowler, S. Portfolio, Programme and Project Offices; Stationery Office Books: London, UK, 2013. [Google Scholar]
- Al-Khouri, A.M. Overview of Various Project and Program Management Standards. In Program Management of Technology Endeavours: Lateral Thinking in Large Scale Government Program Management; Al Khouri, A., Ed.; Palgrave Macmillan: London, UK, 2015; pp. 87–132. [Google Scholar]
- Reiss, G.; Rayner, P. Portfolio and programme management demystified: Managing multiple projects successfully, 2nd ed.; Routledge: New York, NY, USA, 2013. [Google Scholar]
- Taylor, M.P.; Mead, M.R.; Holloway, M.J. Delivering Successful PMOs: How to Design and Deliver the Best Project Management Office for Your Business; Gower Publishing Limited: England, UK, 2015. [Google Scholar]
- McNally, C.; Smith, H.; Morrison, P. Improving Portfolio, Programme and Project Financial Control; The Stationery Office: London, UK, 2011. [Google Scholar]
- Janka, T.; Kosieradzka, A. The new approach to the strategic project management in the polish public administration. Found. Manag. 2019, 11, 143–154. [Google Scholar] [CrossRef]
- Saeed, M.A.; Abbasi, A.; Rashid, T. Project Benefits Realization-Academics’ Aspiration or Practitioners’ Nightmare. PGCAR 2019, 2, 21–32. [Google Scholar]
- Shehu, Z.; Akintoye, A. Major challenges to the successful implementation and practice of programme management in the construction environment: A critical analysis. Int. J. Proj. Manag. 2010, 28, 26–39. [Google Scholar] [CrossRef]
- Shao, J. The moderating effect of program context on the relationship between program managers’ leadership competences and program success. Int. J. Proj. Manag. 2018, 36, 108–120. [Google Scholar] [CrossRef]
- Rijke, J.; van Herk, S.; Zevenbergen, C.; Ashley, R.; Hertogh, M.; ten Heuvelhof, E. Adaptive programme management through a balanced performance/strategy oriented focus. Int. J. Proj. Manag. 2014, 32, 1197–1209. [Google Scholar] [CrossRef]
- Trzeciak, M.; Kopec, T.P.; Kwilinski, A. Constructs of project programme management supporting open innovation at the strategic level of the organisation. JOItmC 2022, 8, 58. [Google Scholar] [CrossRef]
- Zhou, C.; He, Z.; Hu, P.; Yan, H. Empirical Research on the Critical Success Factors of Construction Program. Comput. Intell. Neurosci. 2022, 2022, 9701963. [Google Scholar] [CrossRef]
- Liu, Y.; van Marrewijk, A.; Houwing, E.J.; Hertogh, M. The co-creation of values-in-use at the front end of infrastructure development programs. Int. J. Proj. Manag. 2019, 37, 684–695. [Google Scholar] [CrossRef]
- Parolia, N.; Jiang, J.J.; Klein, G.; Sheu, T.S. The contribution of resource interdependence to IT program performance: A social interdependence perspective. Int. J. Proj. Manag. 2011, 29, 313–324. [Google Scholar] [CrossRef]
- Duryan, M.; Smyth, H. Service design and knowledge management in the construction supply chain for an infrastructure programme. Built Environ. Proj. Asset Manag. 2019, 9, 118–137. [Google Scholar] [CrossRef]
- Wen, Q.; Qiang, M.; Gloor, P. Speeding up decision-making in project environment: The effects of decision makers’ collaboration network dynamics. Int. J. Proj. Manag. 2018, 36, 819–831. [Google Scholar] [CrossRef]
- Laine, T.; Korhonen, T.; Martinsuo, M. Managing program impacts in new product development: An exploratory case study on overcoming uncertainties. Int. J. Proj. Manag. 2016, 34, 717–733. [Google Scholar] [CrossRef]
- Bell, E.; Bryman, A.; Harley, B. Business Research Methods, 6th ed.; Oxford University Press: Oxford, UK, 2022. [Google Scholar]
- Dzwigol-Barosz, M. Enhancement methods of emotional intelligence-related competencies of successors in family businesses. In Proceedings of the Economic and Social Development: Book of Proceedings, Moscow, Russia, 30–31 October 2017; pp. 718–726. [Google Scholar]
- Saunders, M.; Lewis, P.; Thornhill, A. Research Methods for Business Students, 5th ed.; Pearson education Limited: England, UK, 2009. [Google Scholar]
- Cresswell, J.W. Research Design: Qualitative, Quantitative, and Mixed Methods Approaches, 3rd ed.; Sage: London, UK, 2009. [Google Scholar]
- Park, S.H. Whole life performance assessment: Critical success factors. J. Constr. Eng. Manag. 2009, 135, 1146–1161. [Google Scholar] [CrossRef]
- Granato, D.; Santos, J.S.; Escher, G.B.; Ferreira, B.L.; Maggio, R.M. Use of principal component analysis (PCA) and hierarchical cluster analysis (HCA) for multivariate association between bioactive compounds and functional properties in foods: A critical perspective. Trends Food. Sci. Technol. 2018, 72, 83–90. [Google Scholar] [CrossRef]
- Sienkiewicz-Małyjurek, K.; Owczarek, T. Complementarity of Communication and Coordination in Ensuring Effectiveness of Emergency Management Networks. Sustainability 2021, 13, 221. [Google Scholar] [CrossRef]
- Kempa, W.; Rydarowska-Kurzbauer, J.; Halama, M.; Smuda, E.; Biel, M. Statistical and Econometric Analysis of Selected Effects of COVID-19 Pandemic. Multidiscip. Asp. Prod. Eng. 2021, 4, 395–407. [Google Scholar] [CrossRef]
- Grabiński, T. Podstawy Kwantyfikacji Zmiennych Przestrzennych. In Badania Przestrzenne Rynku Konsumpcji; Mynarski, S., Ed.; PWN: Warsaw, Poland, 1992. [Google Scholar]

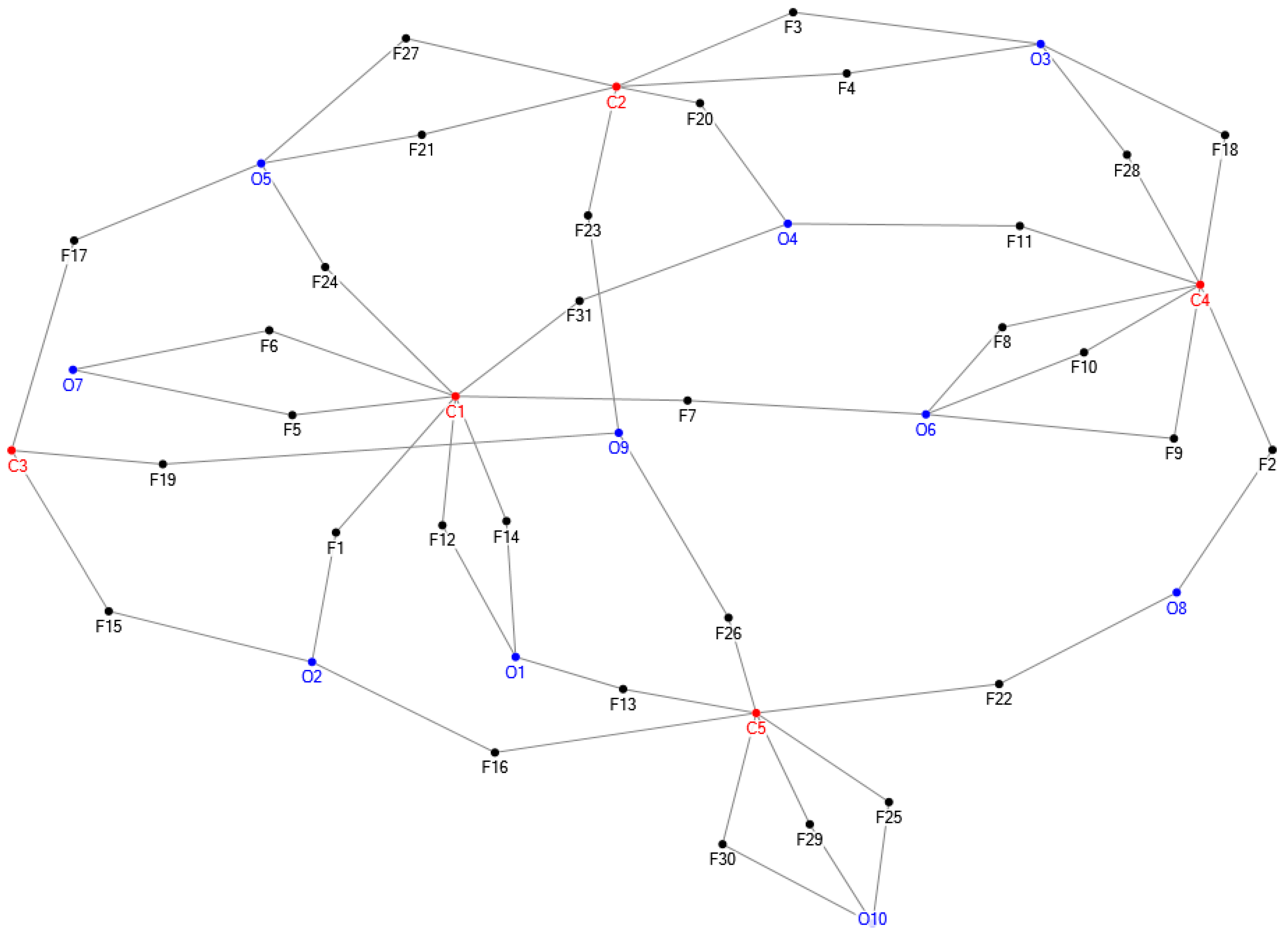

O 1 and F 2 | Functions Performed by PgMO and Success Factors of Construction Programs | References |
---|---|---|
O1 | Defining program goals and requirements | [25,42] |
F12 | Defining and maintaining consistent program vision | [2,8,52,54] |
F13 | Defining program requirements | [2,8,15] |
F14 | Defining clear and realistic program goals | [2,8,15,52] |
O2 | Developing program plan and schedule | [25,41,42] |
F1 | Development and execution of strategic program management plan | [1,53,54] |
F15 | Program planning | [7,15,39] |
F16 | Planning the program definition phase | [7,51] |
O3 | Allocating resources and assigning roles and responsibilities | [41,42] |
F3 | Optimal resource allocation | [1,55] |
F4 | Procedures for granting legal approvals | [1,39] |
F18 | Delegation of powers and responsibilities | [1,56] |
F28 | Resource allocation between projects | [1,55] |
O4 | Providing project management guidance and best practices | [25,41] |
F11 | Organization support for the program | [4,53,56] |
F31 | Program management standard | [39,54] |
F20 | Appropriateness of the selection of methods, techniques and tools to the level of complexity of the program | [1,53] |
O5 | Monitoring program progress and making adjustments as needed | [25,41,42] |
F17 | Approval of the program plan and its evaluation | [1,7] |
F21 | Measurement and control of the performance of the integrated logistics support (common resources and delivery program) | [15,55] |
F24 | Permanent reviews (monitoring and control) of the program | [1,8,19] |
F27 | Management and control of configuration | [1,7] |
O6 | Facilitating communication and collaboration among stakeholders | [25,42] |
F7 | Recognition of stakeholder attributes | [8,39,51,54] |
F8 | Supplier relationship management | [15,53,57] |
F9 | Stakeholder management | [8,9,49,51] |
F10 | Communication management | [15,39,53,55] |
O7 | Ensuring that program risks are identified and managed effectively | [25,41,42] |
F5 | Program risk management | [8,39] |
F6 | Risk management related to the relationship with stakeholders | [8,39] |
O8 | Providing oversight and quality assurance for program deliverables | [25,41,42] |
F2 | Supervision of the program | [9,15,54,55] |
F22 | Strong and structured quality control | [1,21,51] |
O9 | Tracking program finances and ensuring that the program stays within budget | [25,41,42] |
F19 | Budgeting the program | [10,51,58] |
F23 | Financial setup of the program based on a realistic business case | [15,21,58] |
F26 | Program cost management | [8,54] |
O10 | Program knowledge and information management | [41,42] |
F25 | Support for innovation | [54,58] |
F29 | Knowledge management: measurement and analysis of knowledge | [51,56,58] |
F30 | Information management | [9,15,39,55] |
E1 | E2 | E3 | E4 | E5 | E6 | E7 | E8 | E9 | E10 | E11 | E12 | E13 | E14 | E15 | E16 | E17 | |
---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
kz | 0.9 | 0.7 | 0.9 | 0.7 | 0.8 | 0.7 | 0.7 | 0.8 | 0.7 | 0.8 | 0.8 | 0.7 | 0.6 | 0.8 | 0.7 | 0.7 | 0.7 |
ka | 0.73 | 0.83 | 0.6 | 0.85 | 0.93 | 0.85 | 0.95 | 0.95 | 0.935 | 0.915 | 0.95 | 0.73 | 0.85 | 0.765 | 0.745 | 0.86 | 0.845 |
Kk | 0.815 | 0.765 | 0.75 | 0.775 | 0.865 | 0.775 | 0.825 | 0.875 | 0.818 | 0.858 | 0.875 | 0.715 | 0.725 | 0.783 | 0.723 | 0.78 | 0.773 |
E18 | E19 | E20 | E21 | E22 | E23 | E24 | E25 | E26 | E27 | E28 | E29 | E30 | E31 | E32 | E33 | E34 | |
kz | 0.8 | 0.9 | 0.6 | 0.8 | 0.8 | 0.7 | 0.7 | 0.8 | 0.6 | 0.6 | 0.6 | 0.7 | 0.9 | 0.8 | 0.8 | 0.9 | 0.6 |
ka | 0.73 | 0.85 | 0.815 | 0.95 | 0.86 | 0.765 | 0.75 | 0.96 | 0.93 | 0.935 | 0.7 | 0.745 | 0.83 | 0.9 | 0.95 | 0.735 | 0.715 |
Kk | 0.765 | 0.875 | 0.708 | 0.875 | 0.83 | 0.733 | 0.725 | 0.88 | 0.765 | 0.768 | 0.65 | 0.723 | 0.865 | 0.85 | 0.875 | 0.818 | 0.658 |
E35 | E36 | E37 | E38 | E39 | E40 | E41 | E42 | E43 | E44 | E45 | E46 | E47 | E48 | E49 | |||
kz | 0.6 | 0.8 | 0.6 | 0.6 | 0.7 | 0.7 | 0.6 | 0.9 | 0.7 | 0.7 | 0.8 | 0.7 | 0.9 | 0.9 | 0.7 | ||
ka | 0.735 | 0.86 | 0.635 | 0.665 | 0.645 | 0.85 | 0.815 | 0.835 | 0.665 | 0.75 | 0.6 | 0.715 | 0.95 | 0.835 | 0.73 | ||
Kk | 0.668 | 0.83 | 0.618 | 0.633 | 0.673 | 0.775 | 0.708 | 0.868 | 0.683 | 0.725 | 0.7 | 0.708 | 0.925 | 0.868 | 0.715 |
KFC | MS | SD | VAR |
---|---|---|---|
Optimal resource allocation | 3.535 | 0.839 | 0.704 |
Supervision over the program | 3.508 | 1.028 | 1.057 |
Budgeting the program | 3.298 | 1.011 | 1.022 |
Stakeholder management | 3.229 | 1.505 | 2.265 |
Program risk management | 3.092 | 1.078 | 1.162 |
Program cost management | 3.053 | 0.963 | 0.928 |
Communication management | 3.047 | 0.895 | 0.802 |
Resource allocation between projects | 2.957 | 0.815 | 0.665 |
Program planning | 2.953 | 1.019 | 1.038 |
Approval of the program plan and its evaluation | 2.937 | 0.746 | 0.556 |
Procedures for granting legal approvals | 2.865 | 0.939 | 0.881 |
Supplier relationship management | 2.841 | 0.823 | 0.677 |
Permanent reviews (monitoring and control) of the program | 2.835 | 0.895 | 0.801 |
Organization support for the program | 2.798 | 0.909 | 0.826 |
Financial setup of the program based on a realistic business case | 2.778 | 1.073 | 1.151 |
Recognition of stakeholder attributes | 2.776 | 1.321 | 1.744 |
Strong and structured quality control | 2.745 | 0.883 | 0.780 |
Defining and maintaining a consistent program vision | 2.700 | 1.194 | 1.425 |
Delegation of powers and responsibilities | 2.667 | 0.890 | 0.792 |
Risk management related to the relationship with stakeholders | 2.649 | 1.351 | 1.826 |
Program management standard | 2.616 | 0.993 | 0.986 |
Appropriateness of the selection of methods, techniques, and tools to the level of complexity of the program | 2.602 | 0.968 | 0.938 |
Management and control of configuration | 2.531 | 1.033 | 1.067 |
Development and execution of a strategic program management plan | 2.496 | 1.321 | 1.745 |
Measurement and control of the performance of the integrated logistics support (common resources and delivery program) | 2.453 | 0.999 | 0.998 |
Defining clear and realistic program goals | 2.310 | 0.802 | 0.643 |
Planning the program definition phase | 2.298 | 0.984 | 0.969 |
Information management | 2.231 | 0.931 | 0.866 |
Support for innovation | 2.033 | 0.928 | 0.862 |
Defining program requirements | 2.000 | 0.853 | 0.728 |
Knowledge management: measurement and analysis of knowledge | 1.951 | 0.741 | 0.550 |
Factor | Avg | SD | |
---|---|---|---|
F1 | Development and execution of a strategic program management plan | 3.816 | 0.527 |
F2 | Supervision over the program | 4.184 | 0.565 |
F3 | Optimal resource allocation | 4.061 | 0.556 |
F4 | Procedures for granting legal approvals | 3.776 | 0.715 |
F5 | Program risk management | 3.918 | 0.534 |
F6 | Risk management related to the relationship with stakeholders | 3.735 | 0.884 |
F7 | Recognition of stakeholder attributes | 3.959 | 0.644 |
F8 | Supplier relationship management | 3.816 | 0.697 |
F9 | Stakeholder management | 4.306 | 0.585 |
F10 | Communication management | 4.265 | 0.569 |
F11 | Organization support for the program | 3.959 | 0.644 |
F12 | Defining and maintaining a consistent program vision | 4.041 | 0.455 |
F13 | Defining program requirements | 3.224 | 0.771 |
F14 | Defining clear and realistic program goals | 3.898 | 0.421 |
F15 | Program planning | 4.041 | 0.763 |
F16 | Planning the program definition phase | 3.408 | 0.643 |
F17 | Approval of the program plan and its evaluation | 3.980 | 0.721 |
F18 | Delegation of powers and responsibilities | 3.837 | 0.624 |
F19 | Budgeting the program | 4.245 | 0.723 |
F20 | Appropriateness of the selection of methods, techniques, and tools to the level of complexity of the program | 4.143 | 0.707 |
F21 | Measurement and control of the performance of the integrated logistics support (common resources and delivery program) | 3.755 | 0.804 |
F22 | Strong and structured quality control | 3.714 | 0.764 |
F23 | Financial setup of the program based on a realistic business case | 4.041 | 0.644 |
F24 | Permanent reviews (monitoring and control) of the program | 3.776 | 0.743 |
F25 | Support for innovation | 3.388 | 0.533 |
F26 | Program cost management | 3.816 | 0.727 |
F27 | Management and control of configuration | 3.776 | 0.771 |
F28 | Resource allocation between projects | 3.837 | 0.657 |
F29 | Knowledge management: measurement and analysis of knowledge | 3.347 | 0.522 |
F30 | Information management | 3.551 | 0.542 |
F31 | Program management standard | 3.592 | 0.497 |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2023 by the author. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Trzeciak, M. Factors and Areas of PgMO Supporting the Success of the Program Management in the Construction Sector. Buildings 2023, 13, 1336. https://doi.org/10.3390/buildings13051336
Trzeciak M. Factors and Areas of PgMO Supporting the Success of the Program Management in the Construction Sector. Buildings. 2023; 13(5):1336. https://doi.org/10.3390/buildings13051336
Chicago/Turabian StyleTrzeciak, Mateusz. 2023. "Factors and Areas of PgMO Supporting the Success of the Program Management in the Construction Sector" Buildings 13, no. 5: 1336. https://doi.org/10.3390/buildings13051336
APA StyleTrzeciak, M. (2023). Factors and Areas of PgMO Supporting the Success of the Program Management in the Construction Sector. Buildings, 13(5), 1336. https://doi.org/10.3390/buildings13051336
