Construction Cost-Influencing Factors: Insights from a Survey of Engineers in Saudi Arabia
Abstract
:1. Introduction
2. Literature Review
2.1. Cost Overrun Issues in the Construction Industry Worldwide
2.2. Factors Influencing Construction Cost

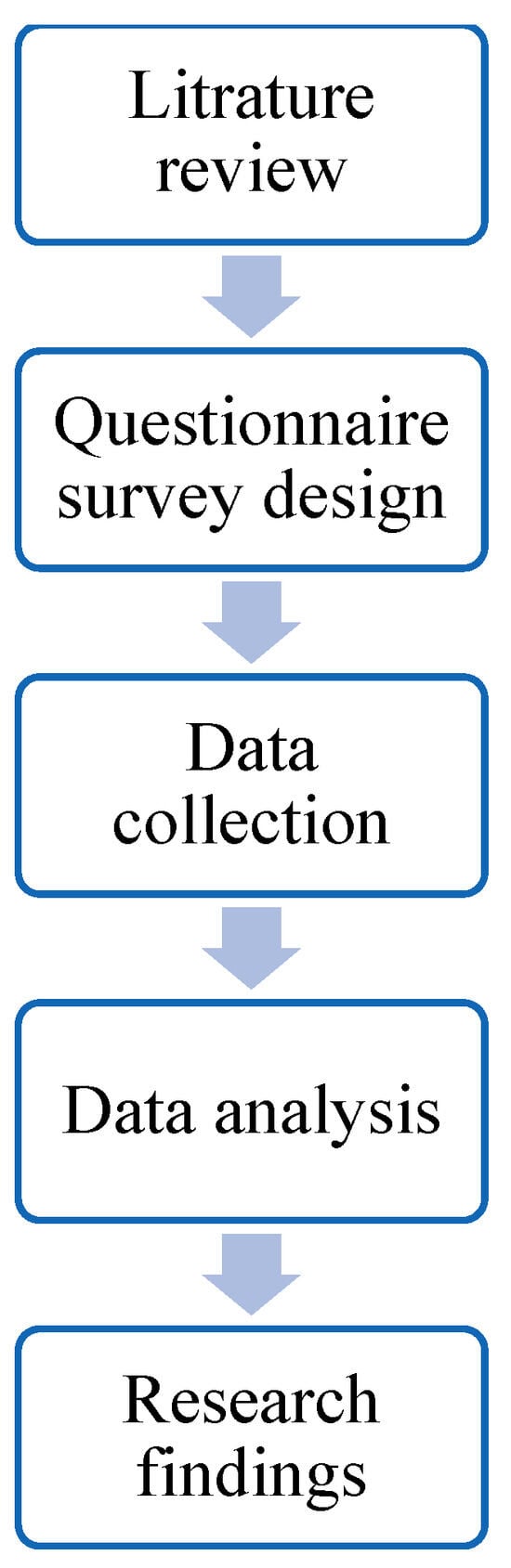

3. Methodology
- χ2 represents the Pearson’s chi-squared statistic;
- i represents the row in the contingency table;
- j represents the columns in the contingency table;
- Oij represents the observed frequency;
- Mij represents the model frequency, as follows:
- df represents the degree of freedom;
- r represents the number of rows;
- c represents the number of columns.
- How do engineers’ demographics influence their perception of construction cost influencing factors?
- How do project-specific characteristics affect engineers’ perceptions of cost-influencing factors?
- What are the implications and policy recommendations for construction industry practices?
- Engineers’ demographics vs. factors influencing construction cost.
- 2.
- Project-specific characteristics vs. factors influencing construction costs.
4. Results
4.1. Reliability Analysis
4.2. Demographic Profile and Project-Specific Characteristics
4.3. Chi-Squared Analysis
4.3.1. How Do Engineers’ Demographics Influence Their Perception of Construction Cost-Influencing Factors?
4.3.2. How Do Project-Specific Characteristics Affect Engineers’ Perceptions of Cost-Influencing Factors?
4.3.3. What Are the Implications and Policy Recommendations for Construction Industry Practices?
- It is important to promote best practices in project management to address the inadequate management of project, contract, and communication, which is the highest cost-influencing factor;
- To ensure clear communications among stakeholders, it is important to establish standardized communication protocols;
- Robust cost estimation methodologies that integrate historical data and contingency plans to enhance accuracy should be implemented;
- The use of cutting-edge planning and scheduling software to generate comprehensive project timelines and continuously monitor its activities should be promoted to mitigate delays and control costs;
- High-quality designs should be ensured by conducting frequent reviews and implementing strict quality assurance protocols, which in turn will assist in reducing design errors and weaknesses’
- Guidelines should be set to minimize design changes during the construction phase. To manage additional costs, it is important to perform a comprehensive impact assessment and obtain approvals for required changes;
- Construction professionals should be encouraged to enroll in formal education and comprehensive training programs to improve their technical knowledge and expertise;
- The establishment of a culture that prioritizes knowledge-sharing and mentorship within organizations should be encouraged in order to utilize the expertise of senior engineers in favor of younger engineers. Sharing project knowledge can enhance organizational cost-efficiency and performance [51];
- Strategies to minimize financial risks caused by fluctuations in currency exchange rates should be implemented, specifically for large-scale projects that heavily rely on imported materials;
- Support should be offered to engineers who deal with regulatory frameworks to ensure that they possess the necessary skills to successfully overcome any requirements;
- Anti-corruption training and policies should be implemented, with an emphasis on real-life cases in the construction context;
- Artificial intelligence should be adopted to enhance construction cost control. It was shown that the artificial intelligence approaches used in construction management can lead to minimizing cost overruns and improvements in project efficiency [52];
- Construction 4.0 should be adopted by using digital solutions to achieve cost efficiencies. Digitalizing construction improves efficiency, reduces errors, reduces delays, and prevents exceeding project budgets; it promotes collaboration and information-sharing throughout the construction supply chain [53];
- Incentives for fair labor practices and work safety in construction projects should be introduced to enhance ethical practices in the industry;
- Ethical cost management practices should be promoted to increase financial efficiency and minimize environmental impacts;
- Policymakers should establish holistic national standards for cost estimation in construction projects;
- Policymakers should stimulate incentives for companies that adopt digital construction technologies;
- Policymakers should expand on adopting public–private partnerships (PPPs), as it will promote the use of digital construction technologies and best practices in project management;
- Policymakers can mandate a number of certificate programs in advanced project management techniques to ensure consistent standards across the industry.
5. Conclusions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Acknowledgments
Conflicts of Interest
References
- Nasereddin, M.; Price, A. Addressing the capital cost barrier to sustainable construction. Dev. Built Environ. 2021, 7, 100049. [Google Scholar] [CrossRef]
- Zhao, L.; Mbachu, J.; Liu, Z. Identifying Significant Cost-Influencing Factors for Sustainable Development in Construction Industry Using Structural Equation Modelling. Math. Probl. Eng. 2020, 2020, 4810136. [Google Scholar] [CrossRef]
- Baria, N.; Yusuff, R.; Ismail, N.; Jaapar, A.; Ahmad, N. Factors Influencing the Construction Cost of Industrialised Building System (IBS) Projects. Procedia-Soc. Behav. Sci. 2012, 35, 689–696. [Google Scholar] [CrossRef]
- Albtoush, A.; Doh, S.; Abdul-Rahman, A. Factors Effecting the Cost Management in Construction Projects. Int. J. Civ. Eng. Technol. 2020, 11, 105–111. [Google Scholar] [CrossRef]
- Tayyab, M.; Furkhan, M.; Rizwan, M.; Jameel, M.; Chadee, A. A Study on Factors Influencing Cost Overrun in High-Rise Building Construction Across India. J. Smart Build. Constr. Technol. 2023, 5, 52–83. [Google Scholar] [CrossRef]
- Jamaludin, S.; Mohammad, M.; Ahmad, K. Enhancing the Quality of Construction Environment by Minimizing the Cost Variance. Procedia-Soc. Behav. Sci. 2014, 153, 70–78. [Google Scholar] [CrossRef]
- Xie, W.; Deng, B.; Yin, Y.; Lv, X.; Deng, Z. Critical Factors Influencing Cost Overrun in Construction Projects: A Fuzzy Synthetic Evaluation. Buildings 2022, 12, 2028. [Google Scholar] [CrossRef]
- Valinejadshoubi, M.; Moselhi, O.; Iordanova, I.; Valdivieso, F.; Bagchi, A. Automated system for high-accuracy quantity takeoff using BIM. Autom. Constr. 2024, 157, 105155. [Google Scholar] [CrossRef]
- Shoushtari, F.; Daghighi, A.; Ghafourian, E. Application of Artificial Intelligence in Project Management. Int. J. Ind. Eng. Oper. Res. 2024, 6, 49–63. [Google Scholar]
- Dindorf, R.; Wos, P. Challenges of Robotic Technology in Sustainable Construction Practice. Sustainability 2024, 16, 5500. [Google Scholar] [CrossRef]
- Al-Nahhas, Y.; Hadidi, L.; Islam, M.; Skitmore, M.; Abunada, Z. Modified Mamdani-fuzzy inference system for predicting the cost overrun of construction projects. Appl. Soft Comput. 2024, 151, 111152. [Google Scholar] [CrossRef]
- Musarat, M.; Alaloul, W.; Liew, M. Incorporating inflation rate in construction projects cost: Forecasting model. Heliyon 2024, 10, e26037. [Google Scholar] [CrossRef] [PubMed]
- Love, P. Influence of Project Type and Procurement Method on Rework Costs in Building Construction Projects. J. Constr. Eng. Manag. 2002, 128, 18–29. [Google Scholar] [CrossRef]
- Wyke, S.; Lindhard, S.; Larsen, J. Using Principal component analysis to identify latent factors affecting cost- and time overrun in public construction projects. Eng. Constr. Archit. Manag. 2024, 31, 2415–2436. [Google Scholar] [CrossRef]
- Daoud, A.; Hefnawy, M.; Wefki, H. Investigation of critical factors affecting cost overruns and delays in Egyptian mega construction projects. Alex. Eng. J. 2023, 83, 326–334. [Google Scholar] [CrossRef]
- Kumar, T.; Priya, M.; Arthi, A.; Singh, V.; Bano, S. Factors Affecting Time and Cost Overruns in the Construction Projects and Its Control Techniques. J. Balk. Tribol. Assoc. 2022, 28, 26–38. [Google Scholar]
- Annamalaisami, C.; Kuppuswamy, A. Managing Cost Risks: Toward a Taxonomy of Cost Overrun Factors in Building Construction Projects. J. Risk Uncertain. Eng. Syst. Part A Civ. Eng. 2021, 7, 04021021. [Google Scholar] [CrossRef]
- Vu, T.; Pham, C.; Nguyen, T.; Nguyen, P.; Phan, P.; Nguyen, Q. Factors Influencing Cost Overruns in Construction Projects of International Contractors in Vietnam. J. Asian Financ. Econ. Bus. 2020, 7, 389–400. [Google Scholar] [CrossRef]
- Kamaruddeen, A.; Sung, C.; Wahi, W. A Study on Factors Causing Cost Overrun of Construction Projects in Sarawak, Malaysia. Civ. Eng. Archit. 2020, 8, 191–199. [Google Scholar] [CrossRef]
- Khodeir, L.; Ghandour, A. Examining the role of value management in controlling cost overrun [application on residential construction projects in Egypt]. Ain Shams Eng. J. 2019, 10, 471–479. [Google Scholar] [CrossRef]
- Aboelmagd, Y. Assessments of Barriers to Implementing Cost Control and Optimal Cost Reduction Techniques in Construction Projects: A Case Study of Egypt. J. Eng. Sci. 2021, 49, 509–529. [Google Scholar]
- Chadee, A.; Allis, C.; Rathnayake, U.; Martin, H.; Azamathulla, H. Data exploration on the factors associated with cost overrun on social housing projects in Trinidad and Tobago. Data Brief 2024, 52, 109966. [Google Scholar] [CrossRef] [PubMed]
- Alkhattabi, L.; Alkhard, A.; Gouda, A. Effects of change orders on the budget of the public sector construction projects in the kingdom of Saudi Arabia. Results Eng. 2023, 20, 101628. [Google Scholar] [CrossRef]
- Mahamid, I. Effects of project’s physical characteristics on cost deviation in road construction. J. King Saud Univ.–Eng. Sci. 2013, 25, 81–88. [Google Scholar] [CrossRef]
- Mubarak, M.; Husin, S.; Oktaviati, M. External risk factors affecting construction costs. In Proceedings of the 3rd International Conference on Construction and Building Engineering (ICONBUILD 2017), Palembang, South Sumatera, Indonesia, 14 November 2017. [Google Scholar]
- Devi, A.; Ananthanarayanan, K. Factors influencing cost over-run in Indian construction projects. In Proceedings of the International Conference on Advances in Sustainable Construction Materials & Civil Engineering Systems (ASCMCES-17), Sharjah, United Arab Emirates, 18–20 April 2017; p. 8. [Google Scholar]
- Ndunguru, D.; Niyonyungu, F.; Yang, X. Quantification of the Influence of Factors Causing Time and Cost Overruns in Tanzanian Construction Projects. Open J. Bus. Manag. 2020, 8, 2133–2147. [Google Scholar] [CrossRef]
- Rajput, B.; Agarwal, A.; Yadav, S. Risk Factors Causing Cost Overrun in Highway Construction Projects. IUP J. Manag. Res. 2020, XIX, 7–22. [Google Scholar]
- Kavuma, A.; Ock, J.; Jang, H. Factors influencing Time and Cost Overruns on Freeform Construction Projects. KSCE J. Civ. Eng. 2019, 23, 1442–1450. [Google Scholar] [CrossRef]
- Ali, Z.; Zhu, F.; Hussain, S. Identification and Assessment of Uncertainty Factors that Influence the Transaction Cost in Public Sector Construction Projects in Pakistan. Buldings 2018, 8, 18. [Google Scholar] [CrossRef]
- Muianga, E.; Granja, A.; Ruiz, J. Influence Factors on Cost and Time Overruns in Mozambicans Construction Projects: Preliminary Findings. In Proceedings of the International Conference on Engineering, Project, and Production Management, Port Elizabeth, South Africa, 26–28 November 2014; pp. 10–21. [Google Scholar]
- Rathi, A.; Khandve, P. Study of Factors Influencing Cost Overruns: An Overview. Int. J. Sci. Res. 2016, 5, 334–336. [Google Scholar]
- Niazia, G.; Painting, N. Significant Factors Causing Cost Overruns in the Construction Industry in Afghanistan. Procedia Eng. 2017, 182, 510–517. [Google Scholar] [CrossRef]
- Bakri, A.; Razak, M.; Shukor, A. Identification of Factors Influencing Time and Cost Risks in Highway Construction Projects. Int. J. Sustain. Constr. Eng. Technol. 2021, 12, 280–288. [Google Scholar] [CrossRef]
- Bhavsar, V.; Alex, S.; Vaishnav, P.K.; Jose, A.; Koshy, N.; Atiwadkar, S. Investigation of critical factors influencing construction of airports: The case of India. Int. J. Constr. Manag. 2022, 22, 2905–2913. [Google Scholar] [CrossRef]
- Chadee, A.; Hernandez, S.; Martin, H. The Influence of Optimism Bias on Time and Cost on Construction Projects. Emerg. Sci. J. 2021, 5, 429–442. [Google Scholar] [CrossRef]
- Amusan, L.; Afolabi, A.; Ojelabi, R.; Omuha, I.; Okagbue, H. Data exploration on factors that influences construction cost and time performance on construction project sites. Data Brief 2018, 17, 1320–1325. [Google Scholar] [CrossRef]
- Kaming, P.; Olomolaiye, P.; Holt, G.; Harris, F. Factors influencing construction time and cost overruns on high-rise projects in Indonesia. Constr. Manag. Econ. 1997, 15, 83–94. [Google Scholar] [CrossRef]
- Alfahad, B.; Alabdullah, S.; Ahmad, M. Investigation of the Critical Factors Influencing Low-Cost Green Sustainable Housing Projects in Iraq. Math. Stat. Eng. Appl. 2022, 71, 310–329. [Google Scholar]
- Haslinda, A.; Xian, T.; Norfarahayu, K.; Hanafi, R.; Fikri, H. Investigation on the Factors Influencing Construction Time and Cost Overrun for High-Rise Building Projects In Penang. In Proceedings of the International Seminar on Mathematics and Physics in Sciences and Technology 2017 (ISMAP 2017), Batu Pahat, Malaysia, 28–29 October 2017; pp. 1–11. [Google Scholar]
- Lapidus, A.; Topchiy, D.; Kuzmina, T.; Chapidze, O. Influence of the Construction Risks on the Cost and Duration of a Project. Buildings 2022, 12, 484. [Google Scholar] [CrossRef]
- Yunna, W.; Qing, B.; Ping, L. The ISM Analysis on Influence Factors of Cost Control in the Wind Power Construction Project. Phys. Procedia 2012, 24, 587–590. [Google Scholar] [CrossRef]
- Tawfek, H.; Mohammed, H.; Razek, M. Assessment of the expected cost of quality (COQ) in construction projects in Egypt using artificial neural network model. HBRC J. 2012, 8, 132–143. [Google Scholar] [CrossRef]
- Jafari, A.; Rodchua, S. Survey research on quality costs and problems in the construction environment. Total Qual. Manag. 2013, 25, 1–13. [Google Scholar] [CrossRef]
- Mashwama, N.; Aigbavboa, C.; Thwala, D. Investigation of construction stakeholders’ perception on the effects & cost of construction dispute in Swaziland. Procedia Eng. 2016, 164, 196–205. [Google Scholar]
- Antoniou, F.; Tsioulpa, A. Assessing the Delay, Cost, and Quality Risks of Claims on Construction Contract Performance. Buildings 2024, 14, 333. [Google Scholar] [CrossRef]
- Mashwama, N.; Aigbavboa, C.; Thwala, D. An Assessment of the Critical Success factor for the Reduction of Cost of Poor Quality in Construction Projects in Swaziland. Procedia Eng. 2017, 196, 447–453. [Google Scholar] [CrossRef]
- Love, P.; Matthews, J.; Sing, M.; Porter, S.; Fang, W. State of Science: Why Does Rework Occur in Construction? What Are Its Consequences? And What Can be Done to Mitigate Its Occurrence? Engineering 2022, 18, 246–258. [Google Scholar] [CrossRef]
- Field, A. Discovering Statistics Using Spss, 3rd ed.; SAGE Publications: London, UK, 2009. [Google Scholar]
- Hinton, P.; McMurray, I.; Brownlow, C. SPSS Explained; Routledge: New York, NY, USA, 2014. [Google Scholar]
- Beste, T.; Klakegg, O. Strategic change towards cost-efficient public construction projects. Int. J. Proj. Manag. 2022, 40, 372–384. [Google Scholar] [CrossRef]
- Scott, E.; Bommu, R. Efficient Construction Management: AI-Driven Strategies to Combat Cost Overruns. Int. J. Adv. Eng. Technol. Innov. 2024, 1, 222–240. [Google Scholar]
- Yilmaz, G.; Salter, L.; McFarlane, D.; Schonfu, B. Low-cost (Shoestring) digital solution areas for enabling digitalisation in construction SMEs. Comput. Ind. 2023, 150, 103941. [Google Scholar] [CrossRef]
Factor | Brief Description | References |
---|---|---|
Currency exchange rate fluctuations | The increase/decrease in value of local currency. | [7,15,16,25,26,27] |
Delay in project/owner payment | Delays in payments from project owners. | [5,7,11,15,18,19,21,26,28,29,30,31,32,33] |
Design changes | Design changes that occur during the construction stage. | [5,7,11,15,16,18,19,21,25,26,27,29,31,32,33,34,35,36,37] |
Design error/weakness | Existence of errors or quality issues in the project designs. | [7,11,21,26,28,30,31] |
Economic fluctuation/market price changes | Inflation and changes in prices of materials, fuel, and labor services. | [7,15,16,19,21,25,26,27,28,29,31,34,36,37,38,39,40] |
Equipment breakdowns and inefficiencies | Malfunctioning or underperformance of machinery or a tool. | [7,19,26,27,28,31,36] |
Force majeure and environmental issues | Natural disasters or extreme weather conditions. | [7,11,15,18,19,21,25,26,28,29,30,36,37,38,41,42] |
Governmental regulations | Compliance with strict government regulations or changes that occur to it. | [7,19,25,26,29,30,36] |
Inadequate cost estimation | Inaccuracy in estimating the project budget. | [7,15,16,18,21,26,27,28,29,31,32,34,37,38,40,43] |
Inadequate management of project, contract, and communication | Insufficient or ineffective ways to manage projects, contracts, or communication. | [7,11,15,18,19,21,26,28,31,33,36] |
Inadequate planning and scheduling | Insufficient or ineffective planning and scheduling of a project. | [7,11,15,18,19,21,26,28,29,31,33,36,37,39] |
Lack of technical knowledge and experience | Personnel deficiency in required knowledge, skills, and experience. | [5,7,11,18,19,26,27,28,31,33,35,38,40,41,44] |
Legal disputes between various parties | Conflict or disagreement between two or more parties. | [7,11,26,30,31,45,46] |
Poor/unclear drawing | Unreadable drawings due to printing issues or other damages. | [7,15,31] |
Rework | Redoing a job due to errors, design changes, or defects. | [5,7,26,27,29,31,32,47,48] |
Safety issues and accidents | Incidents that may lead to harm, injury, or death of a person. | [5,7,18,19,36] |
Social and cultural influences | Community opposition or strikes. | [7,11,18,19,25,36] |
Staff corruption | Unethical or illegal behavior of an employee. | [7,18,28,30] |
Age | Frequency | Percent |
---|---|---|
20–25 | 54 | 5.1 |
26–35 | 432 | 40.6 |
36–45 | 271 | 25.5 |
46–55 | 143 | 13.4 |
More than 55 | 164 | 15.4 |
Total | 1064 | 100.0 |
Specialization | Frequency | Percent |
---|---|---|
Civil Engineering | 952 | 89.5 |
Architecture | 41 | 3.9 |
Mechanical Engineering | 25 | 2.3 |
Electrical Engineering | 28 | 2.6 |
Industrial Engineering | 5 | 0.5 |
Health and Safety Engineering | 4 | 0.4 |
Chemical Engineering | 6 | 0.6 |
Computer Engineering | 2 | 0.2 |
Mining engineering | 1 | 0.1 |
Total | 1064 | 100.0 |
Academic Qualification | Frequency | Percent |
---|---|---|
Bachelor | 867 | 81.5 |
Master | 156 | 14.7 |
Ph.D. | 41 | 3.9 |
Total | 1064 | 100.0 |
Experience | Frequency | Percent |
---|---|---|
Less than 5 | 173 | 16.3 |
5–10 | 257 | 24.2 |
11–15 | 183 | 17.2 |
16–20 | 125 | 11.7 |
More than 20 | 326 | 30.6 |
Total | 1064 | 100.0 |
Type of Project | Frequency | Percent |
---|---|---|
Residential Construction | 437 | 41.1 |
Commercial Construction | 254 | 23.9 |
Industrial Construction | 110 | 10.3 |
Infrastructure Construction | 263 | 24.7 |
Total | 1064 | 100.0 |
Project Size | Frequency | Percent |
---|---|---|
Less than 1 million | 64 | 6.0 |
1–5 million | 153 | 14.4 |
6–10 million | 82 | 7.7 |
11–20 million | 80 | 7.5 |
More than 20 million | 685 | 64.4 |
Total | 1064 | 100.0 |
Project Location | Frequency | Percent |
---|---|---|
Rabigh | 17 | 1.6 |
Riyadh | 414 | 38.9 |
Taif | 7 | 0.7 |
Jeddah | 200 | 18.8 |
Al Khobar | 20 | 1.9 |
Makkah | 67 | 6.3 |
Al Jubail | 17 | 1.6 |
Neom and Red Sea Project | 52 | 4.9 |
Jazan | 32 | 3.0 |
Madinah | 38 | 3.6 |
Sakakah | 6 | 0.6 |
Hail | 23 | 2.2 |
Al Qassim | 29 | 2.7 |
Abha | 16 | 1.5 |
Yanbu | 9 | 0.8 |
AlUla | 7 | 0.7 |
Tabuk | 18 | 1.7 |
Al Hasa | 15 | 1.4 |
Najran | 7 | 0.7 |
Buraydah | 6 | 0.6 |
Dammam | 58 | 5.5 |
Al Bahah | 6 | 0.6 |
Total | 1064 | 100.0 |
Factor | Mean |
---|---|
Inadequate management of project, contract, and communication | 3.77 |
Inadequate cost estimation | 3.68 |
Inadequate planning and scheduling | 3.65 |
Design error/weakness | 3.63 |
Design changes | 3.61 |
Lack of technical knowledge and experience | 3.57 |
Delay in project/owner payment | 3.47 |
Rework | 3.44 |
Economic fluctuation/market price changes | 3.43 |
Staff corruption | 3.23 |
Poor/unclear drawing | 3.15 |
Legal disputes between various parties | 3.12 |
Equipment breakdowns and inefficiencies | 3.00 |
Force majeure and environmental issues | 2.86 |
Safety issues and accidents | 2.86 |
Governmental regulations | 2.74 |
Currency exchange rate fluctuations | 2.55 |
Social and cultural influences | 2.39 |
Variables Tested | Test | X2 | p-Value |
---|---|---|---|
Age vs. Currency exchange rate fluctuations | Pearson Chi-Squared | 26.638 | 0.046 |
Linear-by-Linear Association | 8.205 | 0.004 | |
Age vs. Safety issues and accidents | Pearson Chi-Squared | 30.446 | 0.016 |
Linear-by-Linear Association | 6.101 | 0.014 | |
Specialization vs. Governmental regulations | Pearson Chi-Squared | 67.185 | 0.000 |
Linear-by-Linear Association | 1.018 | 0.313 | |
Academic qualification vs. Design changes | Pearson Chi-Squared | 21.597 | 0.006 |
Linear-by-Linear Association | 11.834 | 0.001 | |
Academic qualification vs. Staff corruption | Pearson Chi-Squared | 20.357 | 0.009 |
Linear-by-Linear Association | 0.240 | 0.624 | |
Academic qualification vs. Governmental regulations | Pearson Chi-Squared | 19.948 | 0.011 |
Linear-by-Linear Association | 13.507 | 0.000 | |
Experience vs. Currency exchange rate fluctuations | Pearson Chi-Squared | 40.239 | 0.001 |
Linear-by-Linear Association | 12.814 | 0.000 | |
Experience vs. Design error/weakness | Pearson Chi-Squared | 34.961 | 0.004 |
Linear-by-Linear Association | 1.562 | 0.211 | |
Experience vs. Staff Corruption | Pearson Chi-Squared | 27.836 | 0.033 |
Linear-by-Linear Association | 7.233 | 0.007 | |
Experience vs. Safety issues and accidents | Pearson Chi-Squared | 28.234 | 0.030 |
Linear-by-Linear Association | 6.597 | 0.010 | |
Type of project vs. Design changes | Pearson Chi-Squared | 25.360 | 0.013 |
Linear-by-Linear Association | 3.340 | 0.068 | |
Type of project vs. Equipment breakdowns and inefficiencies | Pearson Chi-Squared | 47.881 | 0.000 |
Linear-by-Linear Association | 14.555 | 0.000 | |
Type of project vs. Force majeure and environmental issues | Pearson Chi-Squared | 30.771 | 0.002 |
Linear-by-Linear Association | 7.080 | 0.008 | |
Type of project vs. Governmental regulations | Pearson Chi-Squared | 23.646 | 0.023 |
Linear-by-Linear Association | 7.273 | 0.007 | |
Project size vs. Design changes | Pearson Chi-Squared | 29.742 | 0.019 |
Linear-by-Linear Association | 7.763 | 0.005 | |
Project size vs. Design error/weakness | Pearson Chi-Squared | 37.480 | 0.002 |
Linear-by-Linear Association | 5.675 | 0.017 | |
Project size vs. Economic fluctuation/market price changes | Pearson Chi-Squared | 28.452 | 0.028 |
Linear-by-Linear Association | 7.303 | 0.007 | |
Project size vs. Social and cultural influences | Pearson Chi-Squared | 29.424 | 0.021 |
Linear-by-Linear Association | 5.329 | 0.021 | |
Project location vs. Design changes | Pearson Chi-Squared | 107.287 | 0.044 |
Linear-by-Linear Association | 7.410 | 0.006 |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2024 by the author. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Mosly, I. Construction Cost-Influencing Factors: Insights from a Survey of Engineers in Saudi Arabia. Buildings 2024, 14, 3399. https://doi.org/10.3390/buildings14113399
Mosly I. Construction Cost-Influencing Factors: Insights from a Survey of Engineers in Saudi Arabia. Buildings. 2024; 14(11):3399. https://doi.org/10.3390/buildings14113399
Chicago/Turabian StyleMosly, Ibrahim. 2024. "Construction Cost-Influencing Factors: Insights from a Survey of Engineers in Saudi Arabia" Buildings 14, no. 11: 3399. https://doi.org/10.3390/buildings14113399
APA StyleMosly, I. (2024). Construction Cost-Influencing Factors: Insights from a Survey of Engineers in Saudi Arabia. Buildings, 14(11), 3399. https://doi.org/10.3390/buildings14113399
