Whole Life Critical Factors Influencing Construction Project Performance for Different Objectives: Evidence from Thailand
Abstract
:1. Introduction
- Provide better insights into the CFs that influence project performance for various criteria in Thai construction projects and assess their relative importance;
- Determine the factors that contribute to improvements in project performance for effective management over the course of a project’s life cycle.
- Which factors influence project performance within the Thai construction industry?
- Which factors contribute to the enhancement of construction project performance?
- Which practices could aid in addressing the practical performance management approach to construction projects?
2. Literature Review
2.1. Critical Success Factors
2.2. Project Performance Criteria
2.3. Project Life Cycle
2.4. Gaps in Past Studies
- Which factors influence the performance of construction projects throughout the entire life cycle in the Thai construction industry?
3. Materials and Methods

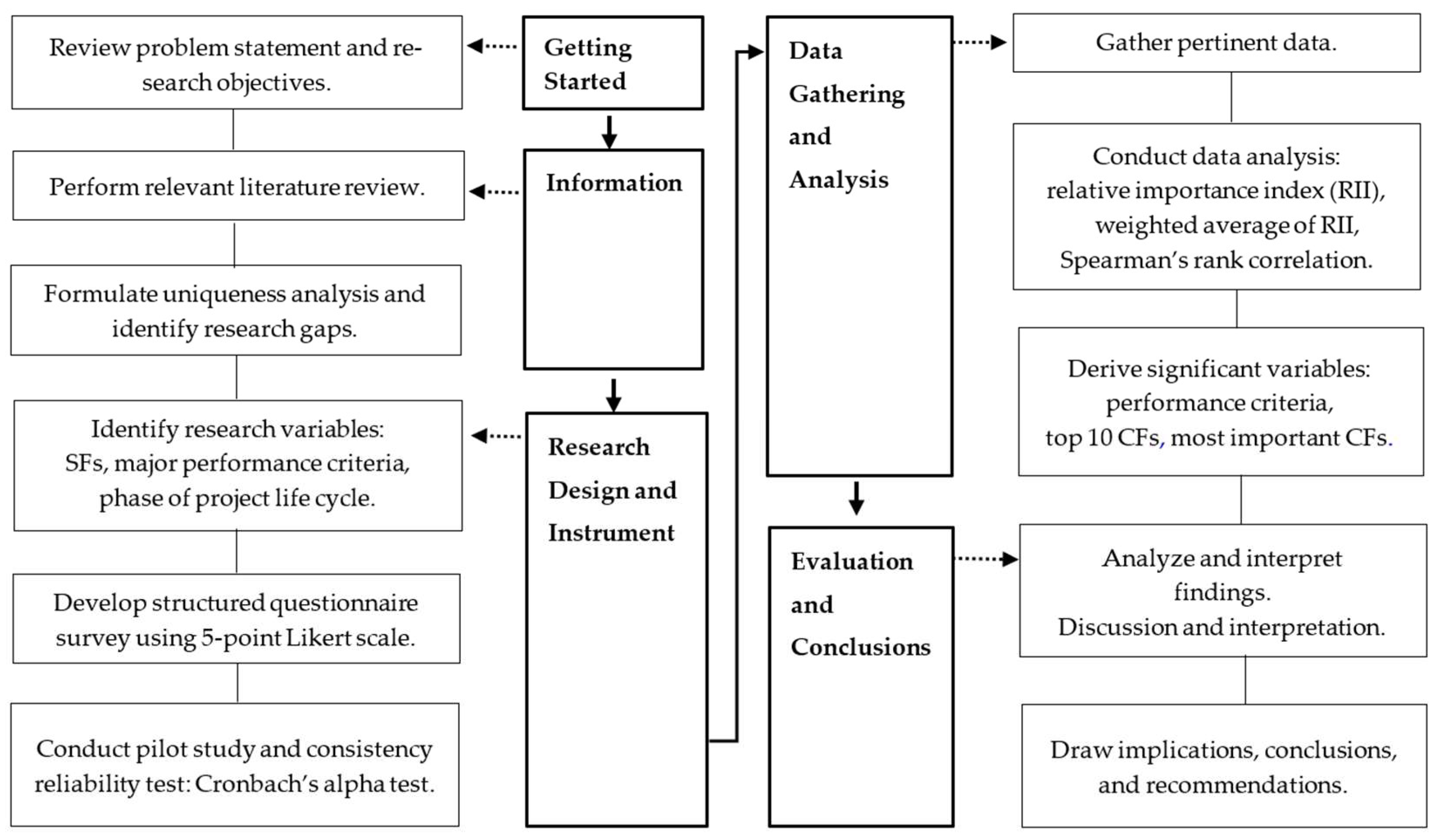

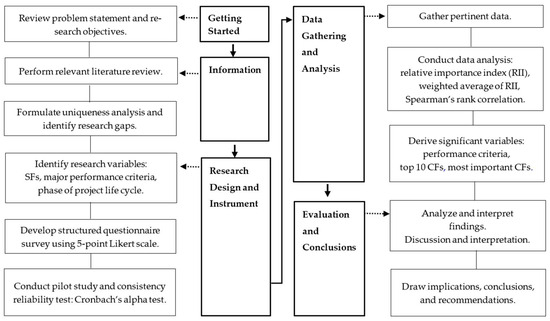

3.1. Research Framework
3.2. Keyword Selection
- Depicting the primary concepts, issues, and themes of the study;
- Outlining the study’s objectives;
- Obtaining descriptors to identify the content and subject matter of the study.
3.3. Identification of Research Variables
3.4. Questionnaire Design
- Group 1—Client Representatives (CR);
- Group 2—Construction Supervision Consultants/Design Consultants (CD);
- Group 3—Contractors (CS).
3.5. Data Collection
3.6. Statistical Analysis and Hypothesis Testing
3.6.1. Relative Importance Index (RII)
- 0.00–0.20: Extremely low importance;
- 0.21–0.40: Low importance;
- 0.41–0.60: Moderate importance;
- 0.61–0.80: High importance;
- 0.81–1.00: Extremely high importance.
3.6.2. Weighted Average (Wa) of the Rankings
3.6.3. Spearman’s Rank Correlation
- It is highly suitable for the analysis of ordinal data, where the variables are ranked instead of being measured on a continuous scale;
- It is a nonparametric test that does not require normality;
- It is suitable for small sample sizes.
- rs between 0.00 and 0.19: Very weak correlation;
- rs between 0.20 and 0.39: Weak correlation;
- rs between 0.40 and 0.59: Moderate correlation;
- rs between 0.60 and 0.79: Relatively strong correlation;
- rs between 0.80 and 1.00: Very strong correlation.
- H0: There is an insignificant degree of agreement among the participants;
- H1: There is a statistically significant degree of agreement among the participants.
4. Results
4.1. Background of Respondents and Characteristics of Projects
4.2. Importance of Project Performance Criteria
4.3. Deriving Critical Factors for Different Objectives across the Project Life Cycle
4.4. Degree of Agreement among the Respondent Groups
4.4.1. Major Performance Categories
4.4.2. Top 90 Critical Factors
4.5. Analysis of Most Critical Factors
- Competence of project participants;
- Adequate experience of project participants;
- Availability of competent staff;
- Positive personal attitudes of project participants;
- Participation in environmental initiatives by management;
- Competent supervisors;
- Effective project planning and control;
- Need for collaboration;
- Professionalism of services provided by project team.
5. Discussion
5.1. The Most Critical Factors
5.1.1. Competence of Project Participants
5.1.2. Adequate Experience of Project Participants
5.1.3. Availability of Competent Staff
5.1.4. Positive Personal Attitudes of Project Participants
5.1.5. Participation in Environmental Initiatives by Management
5.1.6. Competent Supervisors
5.1.7. Effective Project Planning and Control
5.1.8. Need for Collaboration
5.1.9. Professionalism of Services Provided by Project Team
5.2. Comparison of This Research’s Findings with Previous Studies
- A comparison of the importance of the project performance criteria reveals that this study and that of Park [10] provide similar findings; namely, that cost performance and quality performance are essential criteria (particularly in the PD and CN phases, respectively). Moreover, the results of this study correlate favorably with those of Park [10] and Enshassi et al. [23], who found that health and safety, human resources, and the environment are less likely to influence project performance. However, when compared to these previous studies, client satisfaction—which was not considered previously—was found to be of importance. It is the most frequently used criterion in evaluating a project’s success. This difference between these findings is probably due to the different contexts of the organizations considered in each study.
- Examining the importance of the CFs, as anticipated, it was observed that the sets of CFs in each performance category differed from those in previous works. Nevertheless, the top 10 CFs identified in the present study share a number of similarities with Park’s [10] findings. Both studies conclude that the CFs influencing project performance in each category are rapid decision making (time); the certainty of the cash flow for the project (cost); quality in construction (quality); the proper planning and organization of a safe working environment on-site (health and safety); the financial stability of the project participants (risk); and the need for collaboration (human resources). The comparison suggests that these critical factors are reliable, in the sense that they are consistent with the findings of the previous study.
- With the careful consideration of the most important factors considered in the present research and Park’s study, it is apparent that there are some discrepancies in the conclusions of the two studies. There are several possible explanations for this result, one of which is the variation in the set of individual factors employed in the two studies. As a result, this led to a discrepancy in the research outcomes.
6. Practical Implications
- Enhanced decision making: The findings of this study offer project executives invaluable insights to refine their decision-making processes. Through discerning the most significant factors across various project phases, project leaders can make informed decisions to mitigate risks, optimize resources, and ultimately enhance the likelihood of project success. This may involve prioritizing specific aspects of project management based on the identified critical factors.
- Improved project management practices: The identification of the CFs throughout the phases of the project life cycle provides practical insights for project management teams. Through acknowledging these factors, project managers can customize their management strategies to tackle specific challenges and enhance the overall project performance, thereby fostering improved project outcomes.
- Proactive performance improvement: Understanding the dynamic nature of the project performance criteria and the shifting significance of the CFs across various project phases facilitates proactive performance enhancement measures. Project teams can foresee challenges, closely monitor key factors, and promptly implement corrective actions to steer the project toward success. This proactive approach can engender better control over project outcomes and mitigate deviations from the objectives.
7. Conclusions and Recommendations for Future Research
- The importance of individual critical factors and project performance criteria varies depending on the phase of the project life cycle.
- Notably, client satisfaction emerged as a key criterion contributing to project success, suggesting a shift toward broader measures of success beyond traditional metrics. The statistical analysis demonstrated that the top 10 CFs vary, according to the project objectives and the phase of the project.
- This study revealed the following most important CFs influencing project performance in construction projects within the Thai construction industry: the competence of project participants, adequate experience of project participants, the availability of competent staff, positive personal attitudes of project participants, participation in environmental initiatives by management, competent supervisors, effective project planning and control, need for collaboration, and the professionalism of the services provided by the project team. These factors were found to vary across different phases of the project life cycle, emphasizing the dynamic nature of project performance criteria.
- This study identified factors that enhance construction project performance, emphasizing the key success criteria and highlighting their role in overall project improvement. The results of this study suggest that decision makers, professionals, and practitioners in Thailand’s construction sector should prioritize client satisfaction, quality performance, and time performance as the key components to achieve project success.
- The practical implications suggest potential practices that could aid in improving the performance management approaches in construction projects. These offer insights for project stakeholders—particularly project leaders, project managers, and project teams—to enhance their decision making, improve their project management practices, and implement proactive performance improvement measures, ultimately improving the outcomes of construction projects.
- The findings of this study were compared to those of earlier studies. The comparison indicated that the importance of the performance criteria and the top 10 CFs identified were consistent with those determined previously, while the most important CFs significantly differed from those in previous studies.
- Further works should be undertaken that adopt an identical approach to determine and compare the perceived CFs across diverse regions. More information in this field will not only enable a high degree of consensus on the CFs associated with project performance, but will also serve as a guideline to develop good practices for effective project management in the construction industry.
- Given the rapid evolution of technology, future research could explore emerging trends and their implications for project management practices. For example, sustainability, digitalization, and innovation could be investigated as emerging criteria to assess their influence on project performance and success.
Author Contributions
Funding
Data Availability Statement
Conflicts of Interest
Appendix A. The List of Success-Related Factors Employed for the Research
No. | Success-Related Factors | Comment | Reference(s) |
---|---|---|---|
1 | Adequacy of communication and coordination among parties | Merged | [29,32,33,34] |
2 | Adequacy of plans and specifications | Selected | [11,32] |
3 | Adequate experience of project participants | Modified | [29,32,33,34] |
4 | Availability of resources as planned throughout the project duration | Modified | [23,29,32,33] |
5 | Commitment and involvement of all project participants | Selected | [9,11] |
6 | Competency of project participants | Selected | [9,11] |
7 | Completeness of design documents | Modified | [32] |
8 | Contractual motivation/incentives | Selected | [11,32] |
9 | Control of delays among agencies involved in the project | Modified | [29,32,34] |
10 | Effective change order management | Selected | [10,29,32,33,34] |
11 | Effective planning and scheduling | Modified | [29,32,34] |
12 | Effective site management and supervision | Modified | [29,32,33,34] |
13 | Favorable climatic condition | Selected | [9,32] |
14 | Frequent reviewing, monitoring, and updating of construction program | Selected | [11,33] |
15 | Mode of financing and payment for completed works | Selected | [23,32,33,34] |
16 | Proper construction methods/techniques implemented in the project | Modified | [32,33] |
17 | Proper procurement programming of materials and stacking | Selected | [29,32] |
18 | Rapid decision making | Selected | [9,10] |
19 | Realistic obligations/clear objectives | Selected | [9,11] |
20 | Realistic project time imposed in contract duration | Modified | [10,29,32,33] |
21 | Timely delivery of materials/equipment as planned | Modified | [10,32] |
22 | Top management support | Selected | [11,32] |
No. | Success-Related Factors | Comment | Reference(s) |
---|---|---|---|
1 | Adequacy of communication and coordination among parties | Merged | [35,37,38] |
2 | Adequacy of raw materials and equipment | Modified | [32,35,36,38] |
3 | Adequacy of scopes and specifications | Modified | [38] |
4 | Adequate experience of project participants | Added | - |
5 | Adequate tender sum | Selected | [35,39] |
6 | Availability of resources as planned throughout the project duration | Modified | [35,36] |
7 | Certainty of cash flow of the project | Selected | [32,39] |
8 | Competitive tendering process | Selected | [35,39] |
9 | Completeness of considerations in design | Selected | [36] |
10 | Completeness of design documents | Modified | [36,38] |
11 | Effective change in the scope of work management | Selected | [32] |
12 | Effective contract administration and management | Modified | [35,36,38] |
13 | Effective project cost control mechanisms | Selected | [7,32,36] |
14 | Effective site management and supervision | Added | - |
15 | Eliminating waste | Selected | [32,39] |
16 | Favorable climatic condition | Selected | [35,36,37] |
17 | Frequent progress meeting | Modified | [32,37,39] |
18 | Mode of financing and payment for completed works | Selected | [35,36] |
19 | Proper project planning and scheduling | Modified | [35] |
20 | Rapid decision making | Selected | [39] |
21 | Realistic duration of contract period and requirement imposed | Modified | [35,36] |
22 | Relationship among project participants | Modified | [35,36] |
23 | Stability in the price of materials | Modified | [7,32,35,36] |
No. | Success-Related Factors | Comment | Reference(s) |
---|---|---|---|
1 | Adequacy of plans and specifications | Selected | [42] |
2 | Adequate communication among project teams | Selected | [4,42] |
3 | Availability of competent staff | Selected | [9,11,23] |
4 | Availability of trained resources | Selected | [9,10,23,30,42] |
5 | Commitment and involvement of all project participants | Merged | [9,11,42] |
6 | Competency of project manager | Selected | [9,11,41] |
7 | Conformance to specification | Selected | [10,23] |
8 | Constructability | Modified | [10,11] |
9 | Contractual motivation/incentives | Selected | [11] |
10 | Determining quality in construction | Selected | [10] |
11 | Effective cooperation between parties taking part in the project | Selected | [9,30] |
12 | Effective design and construction quality plan | Selected | [10] |
13 | Effective monitoring and feedback | Selected | [9,43] |
14 | Effective quality assurance system in organization | Selected | [10,23,42] |
15 | Effective teamwork to promote quality issues in the project | Selected | [2,30,40] |
16 | Favorable working condition | Selected | [9] |
17 | Management commitment to continual quality improvement | Selected | [30,41] |
18 | Management leadership in promoting high process quality | Selected | [18,30,40,42] |
19 | Quality of equipment and raw materials | Selected | [10,23] |
20 | Top management support | Selected | [9,18,41] |
21 | Utilization of up-to-date technology | Merged | [2,10,41] |
No. | Success-Related Factors | Comment | Reference(s) |
---|---|---|---|
1 | Adequacy of budget allocated for safety | Selected | [43,44] |
2 | Adequate number of site safety representatives | Selected | [43,44,45] |
3 | Availability of adequate facilities for first aid treatment and medical advice | Selected | [10,43] |
4 | Clear organizational safety policy | Selected | [42,43,45,46] |
5 | Conducting incident investigation | Selected | [43,44,46] |
6 | Conducting regular safety meetings | Selected | [10,23,42,43,44] |
7 | Conducting safety hazard identification and review | Selected | [10,42] |
8 | Delegation of safety authority and responsibility to site personnel | Selected | [10,42,43,80] |
9 | Development of safety committee in the project | Selected | [42,45] |
10 | Effective coordination, control, and management of subcontractors | Selected | [43,45] |
11 | Frequent conduct of appropriate site safety inspection and supervision | Merged | [42,43,80] |
12 | Historic, human, and psychological climate | Merged | [43,44,45] |
13 | Implementation of safety incentives and penalties | Merged | [43,44,46] |
14 | Implementation of safety management system in accordance to legislation | Selected | [10,42] |
15 | Interrelation between employee and supervisor | Merged | [43,44,45] |
16 | Involvement of project participants in safety awareness | Merged | [43,44,45,80] |
17 | Issuing and implementation of in-house safety rules and procedures | Selected | [42,43] |
18 | Positive personal attitudes of project participants toward safety management | Merged | [43,46,80] |
19 | Proper planning and organizing of safety working environment onsite | Merged | [10,42,43] |
20 | Provision and conduct of appropriate safety education and training | Merged | [42,43,45,80] |
21 | Safety equipment acquisition and maintenance | Merged | [42,80] |
22 | Sufficient safety resource allocation | Selected | [10,43,44,46,80] |
23 | Top management support | Selected | [43,44,80] |
No. | Success-Related Factors | Comment | Reference(s) |
---|---|---|---|
1 | Adequacy of cooperation among project participants | Merged | [48,49,50] |
2 | Budgeting allowed in implementing environmental management activities | Selected | [49] |
3 | Clear definitions on environmental management responsibilities among project parties | Selected | [48,49] |
4 | Effective air pollution control | Selected | [23,47] |
5 | Effective ecological control | Selected | [47] |
6 | Effective indoor air quality control | Added | - |
7 | Effective land contamination control | Added | - |
8 | Effective monitoring of energy consumption | Selected | [47] |
9 | Effective noise pollution control | Selected | [23,47] |
10 | Effective supervision among project parties | Merged | [48,49] |
11 | Effective waste pollution control | Selected | [23,47] |
12 | Effective water pollution control | Selected | [47,48] |
13 | Involvement by clients on environmental management plan | Selected | [49] |
14 | Participation in environmental initiatives by management | Selected | [83] |
15 | Project participants’ awareness of waste reduction | Modified | [47,48] |
16 | Proper environmental site planning | Selected | [49] |
17 | Proper positioning and maintenance of site environment | Merged | [47,51] |
18 | Regular maintenance of equipment on the project | Merged | [47,51] |
19 | Sufficient auditing activities | Merged | [47,49] |
20 | Sufficient provision of environmental management training to all staff | Selected | [48,49,51] |
21 | Use of environmentally friendly equipment | Selected | [51] |
22 | Use of modular materials in the project | Merged | [50,51] |
23 | Utilization of up-to-date technology | Added | - |
No. | Success-Related Factors | Comment | Reference(s) |
---|---|---|---|
1 | Adequacy of skill training and development to employees | Modified | [86] |
2 | Adequate communication among project teams | Modified | [52,57,84,85] |
3 | Adequate control of absenteeism rate through the project | Selected | [23,52,53,84,86] |
4 | Appropriate construction method | Modified | [55,85,86] |
5 | Availability of construction materials | Modified | [20,52,53,57,84,86] |
6 | Availability of financial motivation system | Modified | [57,86] |
7 | Availability of skilled personnel | Modified | [52,55,85,86] |
8 | Availability of tools and equipment | Modified | [45,53,84,85] |
9 | Availability of utilities | Modified | [52,85] |
10 | Clear and timely inspection | Modified | [57,84,85,86] |
11 | Competent supervisors | Modified | [52,53,84,85] |
12 | Completeness of drawing documents | Modified | [57,84,85,86] |
13 | Constructability | Added | - |
14 | Effective change order management | Selected | [55,57,84,85] |
15 | Effective control of working overtime | Selected | [53,57,84,85,86] |
16 | Effective planning and scheduling | Added | - |
17 | Effective rework | Selected | [53,57,84,85,86] |
18 | Effective site management and supervision | Modified | [54] |
19 | Efficiency of tools and equipment | Modified | [53,55,84,85,86] |
20 | Favorable climatic condition | Modified | [52,54,57,84,85,86] |
21 | Management–labor relationship | Selected | [23] |
22 | Proper site layout arrangement and management | Selected | [84] |
23 | Specification and standardization | Selected | [84] |
24 | Systematic control of workers turnover and changing crew members | Merged | [52,53,56,84,85] |
25 | Utilization of up-to-date technology | Selected | [54] |
No. | Success-Related Factors | Comment | References |
---|---|---|---|
1 | Absence of change in government codes and regulations | Merged | [59,60,61] |
2 | Absence of defective materials | Selected | [10,59,61] |
3 | Accurate anticipation of exchange rate fluctuation and inflation | Selected | [58,59,60,61] |
4 | Accurate measurement and pricing of bill of quantities | Modified | [58,60,61,62] |
5 | Adequacy of communication and coordination among parties | Merged | [10,58,59] |
6 | Adequacy of risk management techniques | Selected | [10] |
7 | Appropriate risk identification and risk response | Modified | [10,60] |
8 | Availability of funds as planned throughout the project duration | Modified | [58] |
9 | Availability of resources as planned throughout the project duration | Selected | [4,58,60,61] |
10 | Certainty of cash flow of the project | Modified | [10,62] |
11 | Clear objectives and scope of work definition | Merged | [10,41,58,59,60] |
12 | Competence of project participants | Modified | [10,58,59,60,61] |
13 | Completeness of design documents | Modified | [10,58,59,60,61,62] |
14 | Dispute resolution clauses incorporated in the contract | Selected | [4,58,59,61] |
15 | Effective change in the scope of work management | Selected | [4,10,58,59,61] |
16 | Effective control of third-party delays | Modified | [58,59,60,61] |
17 | Effective project planning and control | Selected | [4,10,58,59,60,62] |
18 | Feasibility of construction method | Selected | [58,60] |
19 | Financial stability of project participants | Modified | [10,58,59,61] |
20 | High construction productivity | Modified | [58,59,61,62] |
21 | Implementation of effective site safety management program | Modified | [58,59,60,61,62] |
22 | Implementation of proper site condition survey | Modified | [10,58,60] |
23 | Provision of force majeure plan | Modified | [58,59,60,61] |
24 | Quality of work to match standards | Selected | [58,59,60,61] |
25 | Timely payment on contract and extra works | Modified | [20,58,59,61,62] |
No. | Success-Related Factors | Comment | Reference(s) |
---|---|---|---|
1 | Adequacy of compensation level | Selected | [63,64] |
2 | Adequacy of skill training and development to employees | Merged | [3,10,63,65,66] |
3 | Adequate communication among project teams | Modified | [10] |
4 | Adequate employee support from senior management | Modified | [63,66] |
5 | Availability of employee motivation system | Merged | [10,23,66] |
6 | Availability of internal promotion | Selected | [64] |
7 | Availability of participation programs | Selected | [64] |
8 | Availability of skilled personnel | Selected | [10] |
9 | Clearly written line of responsibility | Selected | [63] |
10 | Commitment of the project team | Selected | [63] |
11 | Comprehension of organization’s mission/vision | Selected | [10] |
12 | Effective human resource planning | Merged | [3,23,63,64,65] |
13 | Effective monitoring and feedback | Selected | [10] |
14 | High effectiveness of training programs | Modified | [64] |
15 | High efficiency of project organization | Modified | [10] |
16 | High labor productivity | Modified | [10,65] |
17 | Legal requirement/compliance | Selected | [63] |
18 | Need for collaboration | Selected | [10] |
19 | Positive attitude of employees | Modified | [23] |
20 | Proper administration and disciplinary procedures to all employees | Modified | [63] |
21 | Spirit of cooperation among project team members | Merged | [10,66] |
22 | Sufficiency of managerial and technical manpower | Selected | [10,65] |
23 | Timely decision making in human resource | Selected | [10,65] |
24 | Top-down decision making | Selected | [10] |
No. | Success-Related Factors | Comment | Reference(s) |
---|---|---|---|
1 | Accurate project cost estimates in accordance with plans and specifications | Selected | [22] |
2 | Adequate cost control measures | Selected | [22,70] |
3 | Aesthetics of completed work | Selected | [68,69,70,82] |
4 | Appropriate provision of skilled and trained workforce | Selected | [22,68] |
5 | Client orientation | Selected | [22,70,82] |
6 | Commitment and involvement of top management | Modified | [71] |
7 | Completeness of considerations in design | Selected | [82] |
8 | Completeness of product/service | Merged | [69,71,82] |
9 | Durability of completed work | Merged | [69,70] |
10 | Effective change order management | Modified | [22] |
11 | Effective coordination between client and project parties | Merged | [23,68] |
12 | Effective management and organization of work | Selected | [68] |
13 | Effective planning and scheduling | Merged | [22,69,70] |
14 | Effective supervision and control on-site project activities | Selected | [22,83] |
15 | Efficient functionality of product/service | Merged | [69,71] |
16 | Good communication at all levels | Selected | [22,67,69,82] |
17 | High quality of workmanship | Selected | [69] |
18 | Participation and commitment of project teams | Modified | [67] |
19 | Professionalism of services provided by project team | Selected | [23,82] |
20 | Proper dispute resolution | Modified | [23,69,71] |
21 | Quality of product/service to match standards | Selected | [22,69] |
22 | Rapid response to legitimate complaints | Selected | [70] |
23 | Recognition of risks and uncertainties associated with the project | Selected | [69] |
24 | Safe work environment | Modified | [22] |
25 | Timeliness of service | Selected | [69,70,82] |
References
- Sanvido, V.; Grobler, F.; Parfitt, K.; Guvenis, M.; Coyle, M. Critical success factors for construction projects. J. Constr. Eng. Manag. 1992, 118, 94–111. [Google Scholar] [CrossRef]
- Chan, A.P.C.; Scott, D.; Chan, A.P.L. Factors affecting the success of a construction project. J. Constr. Eng. Manag. 2004, 130, 153–155. [Google Scholar] [CrossRef]
- Pinto, J.K.; Slevin, D.P. Critical success factors across the project life cycle. Proj. Manag. J. 1988, 19, 67–75. [Google Scholar]
- Toor, S.; Ogunlana, S. Critical COMs of success in large-scale construction projects: Evidence from Thailand construction industry. Int. J. Proj. Manag. 2008, 26, 420–430. [Google Scholar] [CrossRef]
- Teeratansirikool, L.; Siengthai, S.; Badir, Y.; Charoenngam, C. Competitive strategies and firm performance: The mediating role of performance measurement. Int. J. Product. Perform. Manag. 2013, 62, 168–184. [Google Scholar] [CrossRef]
- Rockart, J.F. The changing role of the information systems executive: A critical success factors perspective. Sloan Manag. Rev. 1982, 24, 3–13. [Google Scholar]
- Chua, D.K.H.; Kog, Y.C.; Loh, P.K. Critical success factors for different project objectives. J. Constr. Eng. Manag. 1999, 125, 142–150. [Google Scholar] [CrossRef]
- Cooke-Davies, T. The “real” success factors on projects. Int. J. Proj. Manag. 2002, 20, 185–190. [Google Scholar] [CrossRef]
- Iyer, K.C.; Jha, K.N. Critical factors affecting schedule performance: Evidence from Indian construction projects. J. Constr. Eng. Manag. 2006, 132, 871–881. [Google Scholar] [CrossRef]
- Park, S.H. Whole life performance assessment: Critical success factors. J. Constr. Eng. Manag. 2009, 135, 1146–1161. [Google Scholar] [CrossRef]
- Kog, Y.C.; Loh, P.K. Critical success factors for different components of construction projects. J. Constr. Eng. Manag. 2012, 138, 520–528. [Google Scholar] [CrossRef]
- Alzahrani, J.I.; Emsley, M.W. The impact of contractors’ attributes on construction project success: A post construction evaluation. Int. J. Proj. Manag. 2013, 31, 313–322. [Google Scholar] [CrossRef]
- Yun, S.; Jung, W.; Han, S.H.; Park, H. Critical organizational success factors for public private partnership projects—A comparison of solicited and unsolicited proposals. J. Civ. Eng. Manag. 2015, 21, 131–143. [Google Scholar] [CrossRef]
- Li, Y.; Song, H.; Sang, P.; Chen, H.P.; Liu, X. Review of critical success factors (CSFs) for green building project. Build. Environ. 2019, 158, 182–191. [Google Scholar] [CrossRef]
- Sobieraj, J.; Metelski, D. Quantifying critical success factors (CSFs) in management of investment-construction projects: Insights from Bayesian model averaging. Buildings 2021, 11, 360. [Google Scholar] [CrossRef]
- Jung, S.; Lee, S.; Yu, J. Identification and prioritization of critical success factors for off-site construction using ISM and MICMAC analysis. Sustainability 2021, 13, 8911. [Google Scholar] [CrossRef]
- Wuni, I.Y.; Shen, G.Q. Developing critical success factors for integrating circular economy into modular construction projects in Hong Kong. Sustain. Prod. Consum. 2022, 29, 574–588. [Google Scholar]
- Alawag, A.M.; Alaloul, W.S.; Liew, M.S.; Musarat, M.A.; Baarimah, A.O.; Saad, S.; Ammad, S. Critical success factors influencing total quality management in industrialised building system: A case of Malaysian construction industry. Ain Shams. Eng. J. 2023, 14, 101877. [Google Scholar] [CrossRef]
- Ahmad, T. Green building success factors: An exploratory inquiry. J. Build. Eng. 2023, 76, 107136. [Google Scholar] [CrossRef]
- Naji, K.K.; Gunduz, M.; Adalbi, M. Analysis of critical project success factors—Sustainable management of the fast-track construction industry. Buildings 2023, 13, 2890. [Google Scholar] [CrossRef]
- Georgy, M.E.; Chang, L.; Zhang, L. Prediction of engineering performance: A neurofuzzy approach. J. Constr. Eng. Manag. 2005, 131, 548–557. [Google Scholar] [CrossRef]
- Maloney, W.F. Framework for analysis of performance. J. Constr. Eng. Manag. 1990, 116, 399–415. [Google Scholar] [CrossRef]
- Enshassi, A.; Mohamed, S.; Abushaban, S. Factors affecting the performance of construction projects in the Gaza Strip. J. Civil. Eng. Manag. 2009, 15, 269–280. [Google Scholar] [CrossRef]
- Ashley, D.B.; Lurie, C.S.; Jaselskis, E.J. Determinants of construction project success. Proj. Manag. J. 1987, 18, 69–79. [Google Scholar]
- Lim, C.S.; Mohamed, M.Z. Criteria of project success: An exploratory re-xamination. Int. J. Proj. Manag. 1999, 17, 243–248. [Google Scholar] [CrossRef]
- Atkinson, R. Project management: Cost, time and quality, two best guesses and a phenomenon, its time to accept other success criteria. Int. J. Proj. Manag. 1999, 17, 337–342. [Google Scholar] [CrossRef]
- Chan, A.P.C.; Chan, A.P.L. Key performance indicators for measuring construction success. Benchmarking Int. J. 2004, 11, 203–221. [Google Scholar] [CrossRef]
- Yu, I.; Kim, K.; Jung, Y.; Chin, S. Comparable performance measurement system for construction companies. J. Manag. Eng. 2007, 23, 131–139. [Google Scholar] [CrossRef]
- Chan, D.W.M.; Kumaraswamy, M. A comparative study of causes of time overruns in Hong Kong construction projects. Int. J. Proj. Manag. 1997, 15, 55–63. [Google Scholar] [CrossRef]
- Arditi, D.; Gunaydin, H.M. Factors that affect process quality in the life cycle of building projects. J. Constr. Eng. Manag. 1998, 124, 194–203. [Google Scholar] [CrossRef]
- Project Management Institute. A Guide to the Project Management Body of Knowledge: PMBOK Guide, 4th ed.; Project Management Institute Inc.: Philadelphia, PA, USA, 2008. [Google Scholar]
- Assaf, S.A.; Al-Hejji, S. Causes of delay in large construction projects. Int. J. Proj. Manag. 2006, 24, 349–357. [Google Scholar] [CrossRef]
- Hwang, B.; Zhao, X.; Ng, S.J. Identifying the critical factors affecting schedule performance of public housing projects. Habitat. Int. 2013, 38, 214–221. [Google Scholar] [CrossRef]
- Sambasivan, M.; Soon, Y.W. Cause and effects of delays in Malaysian construction industry. Int. J. Proj. Manag. 2007, 25, 517–525. [Google Scholar] [CrossRef]
- Elinwa, A.U.; Bula, S.A. Construction cost factors in Nigeria. J. Constr. Eng. Manag. 1993, 119, 698–713. [Google Scholar] [CrossRef]
- Okpala, C.C.; Aniekwu, A.N. Causes of high costs of construction in Nigeria. J. Constr. Eng. Manag. 1988, 114, 233–244. [Google Scholar] [CrossRef]
- Iyer, K.; Jha, K. Factors affecting cost performance: Evidence from Indian construction projects. Int. J. Proj. Manag. 2005, 23, 283–295. [Google Scholar] [CrossRef]
- Enshassi, A.; Arain, F.; Al-Raee, S. Cause of variation orders in construction projects in the Gaza Strip. J. Civil. Eng. Manag. 2010, 16, 540–551. [Google Scholar] [CrossRef]
- Kaming, P.F.; Olomolaiye, P.O.; Holt, G.D.; Harris, F.C. Factors influencing construction time and cost overruns on high-rise projects in Indonesia. Constr. Manag. Econ. 1997, 15, 83–94. [Google Scholar] [CrossRef]
- Ledbetter, W.B. Quality performance on successful project. J. Constr. Eng. Manag. 1994, 120, 34–46. [Google Scholar] [CrossRef]
- Nguyen, L.D.; Ogunlana, S.O.; Lan, D.T.K. A study on project success factors in large construction projects in Vietnam. Eng. Constr. Arch. Manag. 2004, 11, 404–413. [Google Scholar] [CrossRef]
- Ng, S.T.; Cheng, K.P.; Skitmore, M. A frame for evaluating the safety performance of construction contractors. Bldg. Environ. 2005, 40, 1347–1355. [Google Scholar]
- Abdul-Rashid, I.; Bassioni, H.; Bawazeer, F. Factor Affecting Safety Performance in Large Construction Contractors in Egypt. In Proceeding of the 23th Annual ARCOM Conference, Belfast, UK, 3–5 September 2007. [Google Scholar]
- Fang, D.P.; Huang, X.Y.; Hinze, J. Benchmarking studies on construction safety management in China. J. Constr. Eng. Manag. 2004, 130, 424–432. [Google Scholar] [CrossRef]
- Sawacha, E.; Naoum, S.; Fong, D. Factors affecting safety performance on construction sites. Int. J. Proj. Manag. 1999, 17, 309–315. [Google Scholar] [CrossRef]
- El-Mashaleh, M.S.; Rababeh, S.M.; Hyari, K.H. Utilizing data envelopment analysis to benchmark safety performance of construction contractor. Int. J. Proj. Manag. 2010, 28, 61–67. [Google Scholar] [CrossRef]
- Tam, V.W.Y.; Le, K.N. Assessing environmental performance in the construction industry. Surv. Built. Environ. 2007, 18, 59–72. [Google Scholar]
- Shen, L.Y.; Tam, V.W.Y. Implementation of environmental management in the Hong Kong construction industry. Int. J. Proj. Manag. 2002, 20, 535–543. [Google Scholar] [CrossRef]
- Tam, V.W.Y.; Shen, L.Y.; Yau, R.M.Y.; Tam, C.M. On using a communication-mapping model for environmental management (CMEM) to improve environmental performance in project development processes. Bldg. Environ. 2007, 42, 3093–3107. [Google Scholar] [CrossRef]
- Cha, H.S.; Kim, J.; Han, J. Identifying and assessing influence factors on improving waste management performance for building construction projects. J. Constr. Eng. Manag. 2009, 135, 647–656. [Google Scholar] [CrossRef]
- Fuertes, A.; Casals, M.; Gangolells, M.; Forcada, N.; Macarulla, M.; Roca, X. An environmental impact causal model for improving the environmental performance of construction processes. J. Clean. Prod. 2013, 52, 425–437. [Google Scholar] [CrossRef]
- Lim, E.C.; Alum, J. Construction productivity: Issues encountered by contractors in Singapore. Int. J. Proj. Manag. 1995, 13, 51–58. [Google Scholar] [CrossRef]
- Kaming, P.F.; Holt, G.D.; Kometa, S.T.; Olomolaiye, P.O. Severity diagnosis of productivity problem—A reliability analysis. Int. J. Proj. Manag. 1998, 16, 107–113. [Google Scholar] [CrossRef]
- Olomolaiye, P.O.; Jayawardane, A.K.W.; Harris, F.C. Construction Productivity Management; Addison Wesley Longman: Amsterdam, The Netherlands, 1998. [Google Scholar]
- Alwi, S. Factor Influencing Construction Productivity in the Indonesian Context. In Proceedings of the 5th Eastern Asia Society for Transportation Studies Conference, Fukuoka, Japan, 29 October–1 November 2003. [Google Scholar]
- Makulsawatudom, A.; Emsleey, M. Factors Affecting the Productivity of the Construction Industry in Thailand: The Foreman’s Perspective. In Proceedings of the Construction Research Congress, ASCE, Honolulu, HI, USA, 19–21 March 2003. [Google Scholar]
- Abdul Kadir, M.R.; Lee, W.P.; Jaafar, M.S.; Sapuan, S.M.; Ali, A.A. Factors affecting construction labour productivity for Malaysian residential projects. Struct. Surv. 2005, 23, 42–54. [Google Scholar] [CrossRef]
- Ghosh, S.; Jintanapakanont, J. Identifying and assessing the critical risk factors in an underground rail project in Thailand: A factor analysis approach. Int. J. Proj. Manag. 2004, 22, 633–643. [Google Scholar] [CrossRef]
- Kartam, N.A.; Kartam, S.A. Risk and its management in the Kuwaiti construction industry: A contractors’ perspective. Int. J. Proj. Manag. 2001, 19, 325–335. [Google Scholar] [CrossRef]
- Tang, W.; Qiang, M.; Duffield, C.F.; Young, D.M.; Lu, Y. Risk management in the Chinese construction industry. J. Constr. Eng. Manag. 2007, 133, 944–956. [Google Scholar] [CrossRef]
- Kangari, R. Risk management perceptions and trends of U.S. construction. J. Constr. Eng. Manag. 1995, 121, 422–429. [Google Scholar] [CrossRef]
- Wang, S.Q.; Dulaimi, M.F.; Aguria, M.Y. Risk management framework for construction projects in developing countries. Constr. Manag. Econ. 2004, 22, 237–252. [Google Scholar] [CrossRef]
- Belout, A. Effects of human resource management on project effectiveness and success: Toward a new conceptual framework. Int. J. Proj. Manag. 1998, 16, 21–26. [Google Scholar] [CrossRef]
- Liu, Y.; Combs, J.G.; Ketchen, D.J., Jr.; Ireland, R.D. The value of human resource management for organizational performance. Bus. Horiz. 2007, 50, 503–511. [Google Scholar] [CrossRef]
- Meeampol, S. Improving Project Performance in the Public Sector: The Case of Thailand. Ph.D. Dissertation, Asian Institute of Technology, Klong Luang, Thailand, 2006. [Google Scholar]
- Daily, B.F.; Huang, S. Achieving sustainability through attention to human resource factors in environment management. Int. J. Oper. Prod. Manag. 2001, 21, 1539–1552. [Google Scholar] [CrossRef]
- Yang, J.; Peng, S. Development of a customer satisfaction evaluation model for construction project management. Build. Environ. 2008, 43, 458–468. [Google Scholar] [CrossRef]
- Palaneeswaran, E.; Ng, T.; Kumaraswamy, M. Client satisfaction and quality management systems in contractor organizations. Build. Environ. 2006, 41, 1557–1570. [Google Scholar] [CrossRef]
- Chinyio, E.; Olomolaiye, O.; Corbett, P. An evaluation of the project needs of UK building clients. Int. J. Proj. Manag. 1998, 16, 385–391. [Google Scholar] [CrossRef]
- Ahmed, S.; Kangari, R. Analysis of client-satisfaction actors in construction industry. J. Constr. Eng. Manag. 1995, 11, 36–44. [Google Scholar]
- Torbica, Z.; Stroh, R. Impact of total quality management on home-buyer satisfaction. J. Constr. Eng. Manag. 1999, 125, 198–203. [Google Scholar] [CrossRef]
- Gliner, J.A.; Morgan, G.A. Research Methods in Applied Setting: An Integrated Approach to Design and Analysis; Lawrence Erlbaum Associates Publishers: Mahwah, NJ, USA, 2000. [Google Scholar]
- Sekaran, U. Research Methods for Business: A Skill-Building Approach, 4th ed.; John Wiley & Sons: New York, NY, USA, 2000. [Google Scholar]
- Chan, D.W.M.; Kumaraswamy, M. An evaluation of construction time performance in the building industry. Build. Environ. 1996, 31, 569–578. [Google Scholar] [CrossRef]
- Oh, M.; Choi, S. The competence of project team members and success factors with open innovation. J. Open Innov. Technol. Mark. Complex. 2020, 6, 51. [Google Scholar] [CrossRef]
- Belout, A.; Gauvreau, C. Factors influencing project success: The impact of human resource management. Int. J. Proj. Manag. 2004, 22, 1–11. [Google Scholar] [CrossRef]
- Sommerville, J.; Dalziel, S. Project teambuilding—The applicability of Belbin’s team-role self-perception inventory. Int. J. Proj. Manag. 1998, 16, 165–171. [Google Scholar] [CrossRef]
- Balthazard, P.; Potter, R.E.; Warren, J. Expertise, extraversion and group interaction styles as performance indicators in virtual teams. Data Base Adv. Inf. Syst. 2004, 35, 41–64. [Google Scholar] [CrossRef]
- Fishbein, M.; Ajzen, I. Belief, Attitude, Intention and Behavior: An Introduction to Theory and Research; Addison-Wesley Publishing Company: Reading, MA, USA, 1975; pp. 216–217. [Google Scholar]
- Aksorn, T.; Hadikusumo, B.H.W. Critical success factors influencing safety program performance in Thai construction projects. Safety Sci. 2008, 46, 709–729. [Google Scholar] [CrossRef]
- Liu, H.; Jazayeri, E.; Dadi, B.G. Establishing the influence of owner practices on construction safety in an operational excellence model. J. Constr. Eng. Manag. 2017, 143, 04017005. [Google Scholar] [CrossRef]
- Tang, S.L.; Lu, M.; Chan, Y.L. Achieving client satisfaction for engineering consulting firms. J. Manag. Eng. 2003, 19, 166–172. [Google Scholar] [CrossRef]
- Lopez-Gamero, M.D.; Molina-Azorın, J.F.; Claver-Cortes, E. The whole relationship between environmental variables and firm performance: Competitive advantage and firm resources as mediator variables. J. Environ. Manag. 2006, 90, 3110–3121. [Google Scholar] [CrossRef] [PubMed]
- Makulsawatudom, A.; Emsley, M.; Sinthawanarong, K. Critical factors influencing construction productivity in Thailand. J. King Mongkut’s Inst. Technol. North Bangk. 2004, 14, 1–6. [Google Scholar]
- Alinaitwe, H.M.; Mwakali, J.A.; Hansson, B. Factors affecting the productivity of building craftsmen—Studies of Uganda. J. Civil. Eng. Manag. 2007, 13, 169–176. [Google Scholar] [CrossRef]
- Enshassi, A.; Mohamed, S.; Mustafa, Z.A.; Mayer, P.E. Factors affecting labour productivity in building projects in the Gaza Strip. J. Civil. Eng. Manag. 2007, 13, 245–254. [Google Scholar] [CrossRef]
- Proverbs, D.G.; Holt, G.D.; Olomolaiye, P.O. The management of labor on high rise construction projects: An international investigation. Int. J. Proj. Manag. 1999, 17, 195–204. [Google Scholar] [CrossRef]
- Abednego, M.P.; Ogunlana, S. Good project governance for proper risk allocation in public–private partnerships in Indonesia. Int. J. Proj. Manag. 2006, 24, 622–634. [Google Scholar] [CrossRef]
- Charoenngam, C.; Yeh, C.Y. Contractual risk and liability sharing in hydropower construction. Int. J. Proj. Manag. 1999, 17, 29–37. [Google Scholar] [CrossRef]
Group of Respondents | Number of Questionnaires | Response Rate (%) | Proportion (%) | |
---|---|---|---|---|
Distributed | Returned | |||
Client representatives | 51 | 26 | 51.0 | 28.0 |
Consultants | 45 | 22 | 48.9 | 23.6 |
Contractors | 68 | 45 | 66.2 | 48.4 |
Total | 164 | 93 | 56.7 | 100.0 |
General Information | Absolute Frequency | Relative Percent | Cumulative Percent | |
---|---|---|---|---|
Job Title | Managing Director/Deputy Managing Director/Vice President | 8 | 8.6 | 8.6 |
Project Director | 10 | 10.8 | 19.4 | |
Project Manager | 38 | 40.9 | 60.3 | |
Production Manager | 10 | 10.8 | 71.1 | |
Quality Control manager/Quantity Surveying Manager | 5 | 5.4 | 76.5 | |
Design Manager/Technical Manager | 8 | 8.6 | 85.1 | |
MEP Manager | 3 | 3.2 | 88.3 | |
Others | 11 | 11.7 | 100.0 | |
Type of business | Public sector | 5 | 5.4 | 5.4 |
Private sector | 88 | 94.6 | 100.0 | |
Field of specialisation | Building construction | 15 | 16.1 | 16.1 |
Residential construction | 70 | 75.3 | 91.4 | |
Heavy engineering construction | 1 | 1.1 | 92.5 | |
Industrial construction | 7 | 7.5 | 100.0 | |
Type of project delivery systems | Design–bid–build | 36 | 38.7 | 38.7 |
Design–build | 30 | 32.3 | 71.0 | |
Construction management | 26 | 27.9 | 98.9 | |
Public–private partnership | 1 | 1.1 | 100.0 |
Weighted Average | ||||||||||
---|---|---|---|---|---|---|---|---|---|---|
Project Performance Criteria | CC | PD | PR | CN | OM | |||||
RII | R | RII | R | RII | R | RII | R | RII | R | |
Time | 0.632 | 4 | 0.705 | 3 | 0.704 | 2 | 0.918 | 2 | 0.619 | 5 |
Cost | 0.635 | 3 | 0.671 | 6 | 0.811 | 1 | 0.884 | 5 | 0.585 | 8 |
Quality | 0.568 | 7 | 0.701 | 4 | 0.688 | 3 | 0.920 | 1 | 0.781 | 2 |
Health and safety | 0.502 | 9 | 0.535 | 9 | 0.516 | 9 | 0.908 | 4 | 0.667 | 3 |
Environment | 0.608 | 6 | 0.680 | 5 | 0.525 | 8 | 0.862 | 8 | 0.611 | 6 |
Productivity | 0.524 | 8 | 0.634 | 8 | 0.623 | 6 | 0.912 | 3 | 0.630 | 4 |
Risk | 0.695 | 2 | 0.729 | 2 | 0.660 | 5 | 0.852 | 9 | 0.570 | 9 |
Human resources | 0.613 | 5 | 0.664 | 7 | 0.609 | 7 | 0.878 | 6 | 0.596 | 7 |
Client satisfaction | 0.711 | 1 | 0.776 | 1 | 0.688 | 4 | 0.877 | 7 | 0.845 | 1 |
Weighted Average | ||||||||||
---|---|---|---|---|---|---|---|---|---|---|
Hypothesized Factors | CC | PD | PR | CN | OM | |||||
RII | R | RII | R | RII | R | RII | R | RII | R | |
Time | ||||||||||
Adequacy of communication and coordination among parties | 0.682 | 9 | 0.783 | 8 | 0.749 | 6 | 0.899 | 10 | 0.617 | 8 |
Adequacy of plans and specification | 0.701 | 8 | 0.777 | 9 | - | - | - | - | - | - |
Adequate experience of project participants | 0.776 | 4 | 0.853 | 2 | 0.748 | 7 | 0.903 | 5 | 0.671 | 2 |
Availability of resources as planned throughout the project duration | - | - | - | - | - | - | 0.906 | 3 | - | - |
Commitment and involvement of all project participants | 0.738 | 7 | 0.776 | 10 | 0.737 | 10 | - | - | 0.658 | 3 |
Completeness of design documents | - | - | 0.910 | 1 | 0.746 | 9 | - | - | - | - |
Contractual motivation/incentives | - | - | - | - | - | - | - | - | 0.624 | 7 |
Control of delays among agencies involved in the project | - | - | - | - | - | - | 0.912 | 2 | - | - |
Effective change order management | - | - | - | - | - | - | - | - | 0.618 | 9 |
Effective planning and scheduling | 0.746 | 6 | 0.809 | 6 | - | - | - | - | - | - |
Effective site management and supervision | - | - | - | - | - | - | 0.901 | 9 | 0.648 | 4 |
Favorable climatic condition | - | - | - | - | - | - | 0.905 | 4 | - | - |
Frequent reviewing, monitoring, and updating of construction program | - | - | - | - | - | - | 0.916 | 1 | - | - |
Mode of financing and payment for completed works | 0.650 | 10 | - | - | 0.787 | 4 | - | - | - | - |
Competence of project participants | 0.783 | 3 | 0.847 | 3 | 0.776 | 5 | 0.901 | 7 | 0.683 | 1 |
Proper construction methods/techniques implemented in the project | - | - | 0.843 | 4 | - | - | 0.901 | 8 | - | - |
Proper procurement programing of materials and stacking | - | - | - | - | 0.874 | 1 | - | - | - | - |
Rapid decision making | 0.604 | 10 | ||||||||
Realistic obligations/clear objectives | 0.750 | 5 | - | - | - | - | - | - | 0.639 | 5 |
Realistic project time imposed in contract duration | 0.783 | 2 | 0.799 | 7 | 0.746 | 8 | - | - | - | - |
Timely delivery of materials/equipment as planned | - | - | - | - | 0.835 | 2 | 0.903 | 6 | - | - |
Top management support | 0.790 | 1 | 0.817 | 5 | 0.796 | 3 | - | - | 0.630 | 6 |
Weighted Average | ||||||||||
---|---|---|---|---|---|---|---|---|---|---|
Hypothesized Factors | CC | PD | PR | CN | OM | |||||
RII | R | RII | R | RII | R | RII | R | RII | R | |
Cost | ||||||||||
Adequacy of communication and coordination among parties | 0.660 | 10 | 0.755 | 10 | - | - | 0.897 | 10 | 0.615 | 4 |
Adequacy of raw materials and equipment | - | - | - | - | - | - | 0.908 | 3 | 0.600 | 7 |
Adequacy of scopes and specifications | 0.760 | 1 | 0.813 | 5 | 0.759 | 10 | - | - | - | - |
Adequate experience of project participants | 0.739 | 2 | 0.828 | 4 | 0.770 | 7 | 0.903 | 4 | 0.660 | 2 |
Adequate tender sum | 0.683 | 8 | - | - | 0.836 | 4 | - | - | - | - |
Availability of resources as planned throughout the project duration | - | - | - | - | - | - | 0.903 | 5 | 0.603 | 6 |
Certainty of cash flow of the project | 0.682 | 9 | - | - | 0.823 | 5 | 0.901 | 8 | - | - |
Competitive tendering process | - | - | - | - | 0.845 | 3 | - | - | - | - |
Completeness of considerations in design | 0.707 | 6 | 0.873 | 2 | - | - | - | - | - | - |
Completeness of design documents | 0.704 | 7 | 0.899 | 1 | 0.766 | 8 | - | - | - | - |
Effective change in the scope of work management | - | - | 0.768 | 7 | - | - | - | - | - | - |
Effective contract administration and management | - | - | - | - | 0.761 | 9 | - | - | 0.598 | 9 |
Effective project cost control mechanisms | - | - | - | - | 0.847 | 2 | 0.901 | 7 | - | - |
Effective site management and supervision | - | - | - | - | - | - | 0.899 | 9 | 0.614 | 5 |
Eliminating waste | - | - | - | - | - | - | 0.902 | 6 | 0.600 | 8 |
Frequent progress meeting | - | - | - | - | - | - | 0.935 | 1 | 0.641 | 3 |
Mode of financing and payment for completed works | - | - | - | - | 0.791 | 6 | - | - | - | - |
Proper project planning and scheduling | 0.716 | 5 | 0.834 | 3 | - | - | - | - | - | - |
Rapid decision making | - | - | 0.759 | 9 | - | - | 0.916 | 2 | 0.592 | 10 |
Realistic duration of contract period and requirement imposed | 0.720 | 4 | 0.808 | 6 | - | - | - | - | - | - |
Relationship among project participants | 0.723 | 3 | 0.760 | 8 | - | - | - | - | 0.669 | 1 |
Stability in the price of materials | - | - | - | - | 0.860 | 1 | - | - | - | - |
Quality | ||||||||||
Adequacy of plans and specifications | - | - | 0.780 | 9 | - | - | - | - | - | - |
Adequate communication among project teams | 0.716 | 4 | 0.784 | 7 | 0.744 | 4 | 0.89 | 10 | - | - |
Availability of competent staff | 0.755 | 1 | 0.808 | 4 | 0.735 | 8 | 0.919 | 3 | 0.689 | 4 |
Commitment and involvement of all project participants | 0.702 | 6 | 0.789 | 6 | 0.738 | 7 | - | - | - | - |
Competency of project manager | 0.748 | 2 | - | - | 0.751 | 3 | 0.935 | 1 | 0.673 | 6 |
Conformance to specification | - | - | 0.824 | 2 | 0.761 | 2 | - | - | - | - |
Constructability | 0.680 | 10 | - | - | - | - | 0.901 | 6 | - | - |
Determining quality in construction | - | - | 0.824 | 3 | 0.767 | 1 | 0.907 | 5 | - | - |
Effective cooperation between parties taking part in the project | 0.699 | 7 | 0.78 | 8 | 0.738 | 6 | 0.894 | 8 | 0.668 | 9 |
Effective design and construction quality plan | 0.703 | 5 | 0.873 | 1 | - | - | - | - | - | - |
Effective monitoring and feedback | - | - | - | - | - | - | - | - | 0.689 | 3 |
Effective quality assurance system in organization | - | - | - | - | - | - | - | - | 0.800 | 1 |
Effective teamwork to promote quality issues in the project | - | - | - | - | 0.725 | 9 | 0.901 | 7 | - | - |
Favorable working condition | - | - | - | - | - | - | - | - | 0.671 | 7 |
Management commitment to continual quality improvement | 0.680 | 9 | - | - | 0.723 | 10 | 0.894 | 9 | 0.668 | 10 |
Management leadership in promoting high process quality | 0.689 | 8 | - | - | - | - | - | - | 0.697 | 2 |
Quality of equipment and raw materials | - | - | - | - | - | - | 0.916 | 4 | 0.669 | 8 |
Top management support | 0.725 | 3 | 0.796 | 5 | 0.744 | 5 | - | - | 0.684 | 5 |
Utilization of up-to-date technology | - | - | 0.774 | 10 | - | - | 0.925 | 2 | - | - |
Weighted Average | ||||||||||
---|---|---|---|---|---|---|---|---|---|---|
Hypothesized Factors | CC | PD | PR | CN | OM | |||||
RII | R | RII | R | RII | R | RII | R | RII | R | |
Health and safety | ||||||||||
Adequacy of budget allocated for safety | 0.609 | 8 | 0.635 | 6 | 0.647 | 3 | - | - | - | - |
Adequate number of site safety representatives | - | - | - | - | - | - | - | - | 0.662 | 6 |
Availability of adequate facilities for first aid treatment and medical advice | - | - | - | - | - | - | 0.914 | 7 | - | - |
Clear organizational safety policy | 0.658 | 2 | 0.660 | 4 | - | - | - | - | - | - |
Conducting regular safety meetings | - | - | - | - | - | - | 0.925 | 4 | 0.658 | 10 |
Conducting safety hazard identification and review | - | - | - | - | - | - | 0.914 | 8 | 0.66 | 7 |
Delegation of safety authority and responsibility to site personnel | 0.589 | 9 | 0.617 | 9 | - | - | - | - | - | - |
Effective coordination, control, and management of subcontractors | - | - | - | - | 0.608 | 6 | 0.925 | 3 | 0.666 | 2 |
Frequent conduct of appropriate site safety inspection and supervision | - | - | - | - | - | - | - | - | 0.658 | 9 |
Historic, human, and psychological climate | - | - | - | - | 0.593 | 10 | - | - | - | - |
Implementation of safety management system in accordance to legislation | 0.632 | 4 | 0.661 | 3 | 0.603 | 9 | 0.933 | 1 | 0.665 | 4 |
Interrelation between employee and supervisor | 0.622 | 5 | 0.633 | 8 | 0.606 | 8 | - | - | 0.671 | 1 |
Involvement of project participants in safety awareness | - | - | 0.613 | 10 | - | - | 0.912 | 10 | 0.660 | 8 |
Issuing and implementation of in-house safety rules and procedures | 0.620 | 6 | 0.634 | 7 | - | - | 0.914 | 9 | - | - |
Positive personal attitudes of project participants | 0.641 | 3 | 0.690 | 1 | 0.645 | 4 | - | - | 0.666 | 3 |
Proper planning and organizing of safety working environment onsite | 0.609 | 7 | 0.658 | 5 | 0.606 | 7 | 0.914 | 6 | - | - |
Provision and conduct of appropriate safety education and training | - | - | - | - | - | - | 0.920 | 5 | 0.662 | 5 |
Safety equipment acquisition and maintenance | - | - | - | - | 0.727 | 1 | - | - | - | - |
Sufficient safety resource allocation | 0.581 | 10 | - | - | 0.626 | 5 | 0.929 | 2 | - | - |
Top management support | 0.683 | 1 | 0.666 | 2 | 0.714 | 2 | - | - | - | - |
Environment | ||||||||||
Adequacy of cooperation among project participants | 0.613 | 6 | 0.703 | 5 | 0.619 | 3 | - | - | - | - |
Budgeting allowed in implementing environmental management activities | 0.656 | 4 | 0.682 | 6 | 0.669 | 1 | - | - | - | - |
Clear definitions on environmental management responsibilities among project parties | 0.701 | 3 | 0.736 | 3 | - | - | - | - | - | - |
Effective air pollution control | - | - | - | - | - | - | 0.888 | 4 | - | - |
Effective monitoring of energy consumption | - | - | - | - | - | - | 0.861 | 9 | 0.682 | 4 |
Effective noise pollution control | - | - | - | - | - | - | 0.896 | 1 | - | - |
Effective supervision among project parties | 0.596 | 8 | 0.658 | 9 | 0.612 | 7 | - | - | - | - |
Effective waste pollution control | - | - | - | - | - | - | 0.894 | 2 | 0.664 | 7 |
Effective water pollution control | - | - | - | - | - | - | 0.890 | 3 | 0.661 | 10 |
Involvement by clients on environmental management plan | 0.718 | 2 | 0.763 | 2 | 0.611 | 8 | - | - | - | - |
Participation in environmental initiatives by management | 0.760 | 1 | 0.785 | 1 | 0.615 | 6 | - | - | - | - |
Project participants’ awareness of waste reduction | 0.589 | 9 | - | - | - | - | 0.881 | 5 | - | - |
Proper environmental site planning | 0.654 | 5 | 0.733 | 4 | - | - | - | - | 0.664 | 8 |
Proper positioning and maintenance of site environment | - | - | - | - | - | - | 0.874 | 7 | 0.662 | 9 |
Regular maintenance of equipment on the project | - | - | - | - | - | - | 0.873 | 8 | 0.692 | 1 |
Sufficient auditing activities | - | - | - | - | 0.618 | 4 | 0.875 | 6 | 0.684 | 2 |
Sufficient provision of environmental management training to all staff | - | - | - | - | 0.600 | 10 | - | - | 0.682 | 3 |
Use of environmentally friendly equipment | - | - | 0.647 | 10 | 0.615 | 5 | - | - | 0.664 | 6 |
Use of modular materials in the project | 0.578 | 10 | 0.660 | 8 | 0.609 | 9 | - | - | - | - |
Utilization of up-to-date technology | 0.604 | 7 | 0.677 | 7 | 0.633 | 2 | 0.860 | 10 | 0.666 | 5 |
Weighted Average | ||||||||||
---|---|---|---|---|---|---|---|---|---|---|
Hypothesized Factors | CC | PD | PR | CN | OM | |||||
RII | R | RII | R | RII | R | RII | R | RII | R | |
Productivity | ||||||||||
Adequacy of skill training and development to employees | - | - | - | - | - | - | - | - | 0.635 | 7 |
Adequate communication among project teams | 0.617 | 6 | 0.693 | 9 | 0.714 | 4 | - | - | - | - |
Appropriate construction method | - | - | 0.740 | 3 | - | - | 0.924 | 1 | - | - |
Availability of construction materials | - | - | - | - | 0.729 | 2 | 0.912 | 4 | - | - |
Availability of financial motivation system | 0.613 | 8 | - | - | - | - | - | - | 0.630 | 10 |
Availability of skilled personnel | 0.611 | 9 | - | - | 0.688 | 8 | 0.911 | 5 | 0.647 | 3 |
Availability of tools and equipment | - | - | - | - | - | - | 0.914 | 3 | - | - |
Availability of utilities | 0.604 | 10 | - | - | - | - | - | - | - | - |
Clear and timely inspection | 0.631 | 4 | 0.695 | 8 | 0.712 | 5 | 0.910 | 6 | 0.643 | 4 |
Competent supervisors | 0.645 | 2 | 0.732 | 4 | 0.717 | 3 | 0.916 | 2 | 0.675 | 1 |
Completeness of drawing documents | - | - | 0.785 | 1 | 0.763 | 1 | - | - | - | - |
Constructability | - | - | 0.680 | 10 | - | - | - | - | - | - |
Effective change order management | - | - | - | - | - | - | - | - | 0.641 | 5 |
Effective control of working overtime | - | - | - | - | - | - | 0.910 | 7 | - | - |
Effective planning and scheduling | 0.643 | 3 | 0.767 | 2 | 0.710 | 6 | 0.908 | 9 | - | - |
Effective rework | - | - | - | - | - | - | - | - | 0.639 | 6 |
Effective site management and supervision | 0.620 | 5 | - | - | 0.684 | 9 | - | - | - | - |
Efficiency of tools and equipment | - | - | - | - | - | - | 0.908 | 8 | 0.632 | 8 |
Management–labor relationship | 0.645 | 1 | 0.714 | 5 | 0.679 | 10 | - | - | 0.651 | 2 |
Proper site layout arrangement and management | 0.615 | 7 | 0.707 | 6 | - | - | - | - | - | - |
Specification and standardization | - | - | 0.701 | 7 | 0.704 | 7 | - | - | - | - |
Utilization of up-to-date technology | - | - | - | - | - | - | 0.906 | 10 | 0.632 | 9 |
Risk | ||||||||||
Absence of change in government codes and regulations | 0.663 | 10 | - | - | - | - | - | - | - | - |
Absence of defective materials | - | - | - | - | 0.791 | 6 | - | - | 0.643 | 6 |
Accurate anticipation of exchange rate fluctuation and inflation | 0.669 | 9 | - | - | 0.766 | 8 | - | - | - | - |
Accurate measurement and pricing of bill of quantities | - | - | 0.761 | 8 | 0.833 | 1 | - | - | - | - |
Adequacy of communication and coordination among parties | 0.679 | 8 | 0.766 | 7 | 0.742 | 10 | 0.875 | 9 | 0.645 | 5 |
Availability of funds as planned throughout the project duration | 0.733 | 3 | - | - | 0.793 | 5 | - | - | 0.637 | 7 |
Availability of resources as planned throughout the project duration | - | - | 0.742 | 9 | - | - | 0.881 | 8 | - | - |
Certainty of cash flow of the project | - | - | - | - | 0.800 | 2 | 0.870 | 10 | 0.632 | 9 |
Clear objectives and scope of work definition | 0.767 | 1 | 0.805 | 4 | - | - | - | - | - | - |
Completeness of design documents | 0.684 | 7 | 0.849 | 1 | 0.756 | 9 | - | - | - | - |
Effective change in the scope of work management | - | - | 0.772 | 6 | - | - | - | - | - | - |
Effective control of third-party delays | - | - | - | - | 0.770 | 7 | 0.882 | 7 | 0.649 | 4 |
Effective project planning and control | 0.716 | 4 | 0.827 | 2 | - | - | 0.890 | 4 | - | - |
Feasibility of construction method | - | - | 0.811 | 3 | - | - | - | - | - | - |
Financial stability of project participants | 0.738 | 2 | - | - | 0.794 | 4 | 0.901 | 2 | - | - |
High construction productivity | - | - | - | - | - | - | 0.894 | 3 | - | - |
Implementation of effective site safety management program | - | - | - | - | - | - | - | - | 0.635 | 8 |
Implementation of proper site condition survey | 0.714 | 5 | 0.740 | 10 | - | - | - | - | - | - |
Competence of project participants | 0.703 | 6 | 0.790 | 5 | - | - | 0.886 | 5 | 0.669 | 3 |
Quality of work to match standards | - | - | - | - | - | - | 0.884 | 6 | 0.695 | 1 |
Timely payment on contract and extra works | - | - | - | - | 0.798 | 3 | 0.905 | 1 | 0.676 | 2 |
Weighted Average | ||||||||||
---|---|---|---|---|---|---|---|---|---|---|
Hypothesized Factors | CC | PD | PR | CN | OM | |||||
RII | R | RII | R | RII | R | RII | R | RII | R | |
Human resources | ||||||||||
Adequacy of compensation level | - | - | - | - | 0.705 | 3 | - | - | - | - |
Adequacy of skill training and development to employees | - | - | - | - | - | - | - | - | 0.699 | 3 |
Adequate communication among project team members | 0.669 | 8 | 0.733 | 6 | 0.715 | 1 | - | - | - | - |
Adequate employee support from senior management | 0.682 | 6 | - | - | - | - | - | - | 0.692 | 9 |
Attractiveness of compensation level | - | - | - | - | - | - | 0.880 | 9 | - | - |
Availability of employee motivation system | 0.663 | 10 | - | - | 0.695 | 5 | - | - | - | - |
Availability of internal promotion | - | - | - | - | - | - | - | - | 0.692 | 8 |
Availability of participation programs | - | - | - | - | - | - | 0.890 | 4 | - | - |
Availability of skilled personnel | - | - | 0.746 | 1 | 0.686 | 9 | 0.899 | 2 | 0.710 | 2 |
Clearly written line of responsibility | 0.686 | 5 | 0.725 | 8 | - | - | - | - | - | - |
Commitment of the project team | 0.688 | 3 | 0.733 | 5 | 0.692 | 6 | - | - | - | - |
Comprehension of organization’s mission/vision | 0.712 | 2 | 0.727 | 7 | - | - | - | - | - | - |
Effective human resource planning | - | - | 0.742 | 3 | - | - | 0.884 | 6 | - | - |
Effective monitoring and feedback | - | - | - | - | - | - | - | - | 0.699 | 5 |
High effectiveness of training program | - | - | - | - | - | - | - | - | 0.682 | 10 |
High efficiency of project organization | - | - | 0.724 | 9 | 0.688 | 8 | 0.875 | 10 | - | - |
High labor productivity | - | - | - | - | - | - | 0.905 | 1 | - | - |
Legal requirement/compliance | - | - | - | - | 0.699 | 4 | - | - | 0.695 | 6 |
Need for collaboration | 0.688 | 4 | 0.744 | 2 | 0.707 | 2 | 0.895 | 3 | 0.699 | 4 |
Positive attitude of employees | 0.678 | 7 | - | - | - | - | - | - | 0.720 | 1 |
Proper administration and disciplinary procedures to all employees | - | - | - | - | 0.677 | 10 | - | - | - | - |
Spirit of cooperation among project team members | 0.666 | 9 | 0.723 | 10 | 0.692 | 7 | 0.884 | 7 | 0.695 | 7 |
Sufficiency of managerial and technical manpower | - | - | - | - | - | - | 0.888 | 5 | - | - |
Timely decision making in human resource | - | - | - | - | - | - | 0.880 | 8 | - | - |
Top-down decision making | 0.718 | 1 | 0.740 | 4 | - | - | - | - | - | - |
Client satisfaction | ||||||||||
Accurate project cost estimates in accordance with plans and specifications | 0.729 | 10 | 0.795 | 4 | 0.796 | 2 | - | - | - | - |
Adequate cost control measures | - | - | - | - | 0.804 | 1 | 0.890 | 9 | - | - |
Aesthetics of completed work | - | - | - | - | - | - | 0.914 | 3 | 0.832 | 2 |
Appropriate provision of skilled and trained workforce | - | - | - | - | - | - | 0.909 | 4 | - | - |
Client orientation | 0.748 | 4 | - | - | 0.736 | 10 | - | - | - | - |
Commitment and involvement of top management | 0.779 | 1 | 0.791 | 5 | - | - | - | - | - | - |
Completeness of considerations in design | 0.759 | 3 | 0.811 | 2 | - | - | - | - | - | - |
Completeness of product/service | - | - | - | - | 0.748 | 6 | - | - | 0.764 | 7 |
Durability of completed work | - | - | - | - | - | - | 0.918 | 1 | 0.849 | 1 |
Effective change order management | - | - | - | - | - | - | 0.899 | 7 | - | - |
Effective coordination between client and project parties | 0.734 | 7 | 0.774 | 6 | 0.750 | 5 | - | - | 0.748 | 10 |
Effective management and organization of work | 0.734 | 6 | 0.763 | 9 | - | - | - | - | - | - |
Effective planning and scheduling | 0.747 | 5 | 0.848 | 1 | 0.740 | 7 | - | - | - | - |
Efficient functionality of product/service | - | - | - | - | - | - | - | - | 0.772 | 6 |
Good communication at all levels | 0.733 | 8 | 0.763 | 10 | 0.738 | 9 | - | - | - | - |
High quality of workmanship | - | - | - | - | - | - | 0.918 | 2 | 0.752 | 9 |
Participation and commitment of project teams | - | - | 0.764 | 8 | 0.738 | 8 | 0.883 | 10 | - | - |
Professionalism of services provided by project team | 0.776 | 2 | 0.798 | 3 | 0.761 | 3 | 0.903 | 6 | 0.758 | 8 |
Quality of product/service to match standards | - | - | - | - | - | - | - | - | 0.779 | 5 |
Rapid response to legitimate complaints | - | - | - | - | - | - | - | - | 0.794 | 3 |
Recognition of risks and uncertainties associated with the project | 0.733 | 9 | - | - | - | - | - | - | - | - |
Safe work environment | - | - | - | - | - | - | 0.896 | 8 | - | - |
Timeliness of service | - | - | 0.770 | 7 | 0.755 | 4 | 0.905 | 5 | 0.786 | 4 |
Participants | CC | PD | PR | CN | OM | |||||
---|---|---|---|---|---|---|---|---|---|---|
rs | Sig | rs | Sig | rs | Sig | rs | Sig | rs | Sig | |
Client representatives and consultants | 0.600 | 0.088 | 0.617 | 0.077 | 0.700 | 0.036 * | −0.100 | 0.798 | 0.500 | 0.170 |
Consultants and contractors | 0.500 | 0.170 | 0.450 | 0.224 | 0.750 | 0.020 * | 0.667 | 0.050 * | 0.717 | 0.030 * |
Client representatives and contractors | 0.967 | 0.000 ** | 0.667 | 0.000 ** | 0.950 | 0.000 ** | 0.483 | 0.187 | 0.683 | 0.042 * |
Participants | CC | PD | PR | CN | OM | |||||
---|---|---|---|---|---|---|---|---|---|---|
rs | Sig | rs | Sig | rs | Sig | rs | Sig | rs | Sig | |
Client representatives and consultants | 0.495 | 0.000 ** | 0.382 | 0.000 ** | 0.326 | 0.006 ** | 0.515 | 0.069 | 0.313 | 0.003 * |
Consultants and contractors | 0.327 | 0.002 ** | 0.578 | 0.000 ** | 0.231 | 0.029 * | −0.162 | 0.128 | 0.112 | 0.294 |
Client representatives and contractors | 0.372 | 0.000 ** | 0.482 | 0.000 ** | 0.326 | 0.002 ** | −0.074 | 0.486 | 0.057 | 0.596 |
Performance Criteria/Critical Factors | Wa of RII | Combined Wa of the RII | R | ||||
---|---|---|---|---|---|---|---|
CC | PD | PR | CN | OM | |||
Time | |||||||
Competence of project participants | 0.783 | 0.847 | 0.776 | 0.901 | 0.683 | 0.807 | 1 |
Adequate experience of project participants | 0.776 | 0.853 | 0.749 | 0.903 | 0.671 | 0.800 | 2 |
Top management support | 0.790 | 0.817 | 0.796 | 0.875 | 0.630 | 0.791 | 3 |
Commitment and involvement of all project participants | 0.738 | 0.776 | 0.737 | 0.897 | 0.658 | 0.772 | 4 |
Adequacy of communication and coordination among parties | 0.682 | 0.783 | 0.748 | 0.899 | 0.617 | 0.759 | 5 |
Effective planning and scheduling | 0.746 | 0.809 | 0.707 | 0.860 | 0.590 | 0.753 | 6 |
Realistic project time imposed in contract duration | 0.783 | 0.799 | 0.746 | 0.836 | 0.552 | 0.753 | 7 |
Realistic obligations/clear objectives | 0.750 | 0.773 | 0.727 | 0.835 | 0.639 | 0.753 | 8 |
Completeness of design documents | 0.641 | 0.910 | 0.746 | 0.822 | 0.568 | 0.748 | 9 |
Rapid decision making | 0.645 | 0.733 | 0.723 | 0.886 | 0.604 | 0.732 | 10 |
Cost | |||||||
Adequate experience of project participants | 0.739 | 0.828 | 0.770 | 0.903 | 0.660 | 0.790 | 1 |
Relationship among project participants | 0.723 | 0.760 | 0.732 | 0.895 | 0.669 | 0.765 | 2 |
Completeness of design documents | 0.704 | 0.899 | 0.766 | 0.812 | 0.542 | 0.755 | 3 |
Adequacy of communication and coordination among parties | 0.660 | 0.755 | 0.758 | 0.897 | 0.615 | 0.751 | 4 |
Rapid decision making | 0.658 | 0.759 | 0.751 | 0.916 | 0.592 | 0.751 | 5 |
Certainty of cash flow of the project | 0.682 | 0.690 | 0.823 | 0.901 | 0.560 | 0.750 | 6 |
Frequent progress meeting | 0.656 | 0.731 | 0.703 | 0.935 | 0.641 | 0.747 | 7 |
Effective project cost control mechanisms | 0.604 | 0.695 | 0.847 | 0.901 | 0.565 | 0.743 | 8 |
Adequacy of scopes and specifications | 0.760 | 0.813 | 0.759 | 0.776 | 0.546 | 0.739 | 9 |
Proper project planning and scheduling | 0.716 | 0.834 | 0.709 | 0.836 | 0.522 | 0.735 | 10 |
Quality | |||||||
Availability of competent staff | 0.755 | 0.808 | 0.735 | 0.919 | 0.689 | 0.788 | 1 |
Competency of project manager | 0.748 | 0.770 | 0.751 | 0.935 | 0.673 | 0.784 | 2 |
Determining quality in construction | 0.669 | 0.824 | 0.767 | 0.907 | 0.665 | 0.776 | 3 |
Top management support | 0.725 | 0.796 | 0.744 | 0.882 | 0.684 | 0.773 | 4 |
Adequate communication among project teams | 0.716 | 0.784 | 0.744 | 0.890 | 0.665 | 0.767 | 5 |
Effective cooperation between parties taking part in the project | 0.699 | 0.780 | 0.738 | 0.894 | 0.668 | 0.764 | 6 |
Management leadership in promoting high process quality | 0.689 | 0.749 | 0.714 | 0.891 | 0.697 | 0.758 | 7 |
Effective design and construction quality plan | 0.703 | 0.873 | 0.696 | 0.866 | 0.615 | 0.756 | 8 |
Management commitment to continual quality improvement | 0.680 | 0.760 | 0.723 | 0.894 | 0.669 | 0.755 | 9 |
Effective quality assurance system in organisation | 0.627 | 0.704 | 0.716 | 0.860 | 0.800 | 0.754 | 10 |
Health and safety | |||||||
Positive personal attitudes of project participants | 0.641 | 0.690 | 0.645 | 0.912 | 0.666 | 0.734 | 1 |
Top management support | 0.683 | 0.666 | 0.714 | 0.879 | 0.637 | 0.732 | 2 |
Implementation of safety management system in accordance to legislation | 0.632 | 0.661 | 0.603 | 0.933 | 0.665 | 0.726 | 3 |
Clear organisational safety policy | 0.658 | 0.660 | 0.583 | 0.912 | 0.654 | 0.719 | 4 |
Proper planning and organising of safety working environment onsite | 0.609 | 0.658 | 0.606 | 0.914 | 0.647 | 0.714 | 5 |
Safety equipment acquisition and maintenance | 0.576 | 0.581 | 0.727 | 0.897 | 0.643 | 0.709 | 6 |
Interrelation between employee and supervisor | 0.622 | 0.633 | 0.606 | 0.884 | 0.671 | 0.708 | 7 |
Issuing and implementation of in-house safety rules and procedures | 0.620 | 0.634 | 0.577 | 0.914 | 0.648 | 0.706 | 8 |
Sufficient safety resource allocation | 0.581 | 0.604 | 0.626 | 0.929 | 0.641 | 0.706 | 9 |
Adequacy of budget allocated for safety | 0.609 | 0.635 | 0.647 | 0.873 | 0.645 | 0.704 | 10 |
Environment | |||||||
Participation in environmental initiatives by management | 0.760 | 0.785 | 0.615 | 0.818 | 0.609 | 0.728 | 1 |
Involvement by clients on environmental management plan | 0.718 | 0.763 | 0.611 | 0.800 | 0.600 | 0.709 | 2 |
Clear definitions on environmental management responsibilities among project parties | 0.701 | 0.736 | 0.587 | 0.830 | 0.622 | 0.708 | 3 |
Proper environmental site planning | 0.654 | 0.733 | 0.560 | 0.849 | 0.665 | 0.708 | 4 |
Utilisation of up-to-date technology | 0.604 | 0.677 | 0.633 | 0.860 | 0.666 | 0.703 | 5 |
Budgeting allowed in implementing environmental management activities | 0.656 | 0.682 | 0.669 | 0.832 | 0.581 | 0.696 | 6 |
Adequacy of cooperation among project participants | 0.613 | 0.703 | 0.619 | 0.834 | 0.633 | 0.694 | 7 |
Sufficient auditing activities | 0.573 | 0.629 | 0.618 | 0.875 | 0.684 | 0.693 | 8 |
Effective supervision among project parties | 0.596 | 0.658 | 0.612 | 0.854 | 0.653 | 0.690 | 9 |
Project participants’ awareness of waste reduction | 0.589 | 0.636 | 0.583 | 0.881 | 0.660 | 0.689 | 10 |
Productivity | |||||||
Competent supervisors | 0.645 | 0.732 | 0.717 | 0.916 | 0.675 | 0.755 | 1 |
Completeness of drawing documents | 0.579 | 0.785 | 0.763 | 0.905 | 0.621 | 0.750 | 2 |
Effective planning and scheduling | 0.643 | 0.767 | 0.710 | 0.908 | 0.619 | 0.748 | 3 |
Clear and timely inspection | 0.631 | 0.695 | 0.712 | 0.910 | 0.643 | 0.737 | 4 |
Appropriate construction method | 0.588 | 0.740 | 0.666 | 0.924 | 0.628 | 0.731 | 5 |
Management–labor relationship | 0.645 | 0.714 | 0.679 | 0.873 | 0.651 | 0.728 | 6 |
Adequate communication among project teams | 0.693 | 0.714 | 0.888 | 0.630 | 0.708 | 0.726 | 7 |
Availability of skilled personnel | 0.656 | 0.688 | 0.911 | 0.647 | 0.703 | 0.723 | 8 |
Effective site management and supervision | 0.678 | 0.684 | 0.881 | 0.630 | 0.698 | 0.716 | 9 |
Utilisation of up-to-date technology | 0.678 | 0.668 | 0.906 | 0.632 | 0.692 | 0.714 | 10 |
Risk | |||||||
Effective project planning and control | 0.716 | 0.824 | 0.732 | 0.890 | 0.611 | 0.767 | 1 |
Competence of project participants | 0.703 | 0.790 | 0.731 | 0.886 | 0.669 | 0.765 | 2 |
Financial stability of project participants | 0.738 | 0.731 | 0.793 | 0.901 | 0.606 | 0.765 | 3 |
Clear objectives and scope of work definition | 0.767 | 0.805 | 0.714 | 0.856 | 0.620 | 0.763 | 4 |
Availability of funds as planned throughout the project duration | 0.733 | 0.710 | 0.794 | 0.862 | 0.637 | 0.755 | 5 |
Completeness of design documents | 0.684 | 0.849 | 0.756 | 0.835 | 0.581 | 0.752 | 6 |
Adequacy of communication and coordination among parties | 0.679 | 0.766 | 0.742 | 0.875 | 0.645 | 0.751 | 7 |
Accurate measurement and pricing of bill of quantities | 0.636 | 0.761 | 0.833 | 0.858 | 0.597 | 0.747 | 8 |
Availability of resources as planned throughout the project duration | 0.655 | 0.742 | 0.738 | 0.881 | 0.618 | 0.738 | 9 |
Timely payment on contract and extra works | 0.600 | 0.650 | 0.798 | 0.905 | 0.676 | 0.734 | 10 |
Human resources | |||||||
Need for collaboration | 0.688 | 0.744 | 0.707 | 0.895 | 0.699 | 0.759 | 1 |
Availability of skilled personnel | 0.660 | 0.746 | 0.686 | 0.899 | 0.710 | 0.753 | 2 |
Spirit of cooperation among project team members | 0.666 | 0.723 | 0.692 | 0.884 | 0.695 | 0.744 | 3 |
Top-down decision making | 0.718 | 0.740 | 0.677 | 0.869 | 0.638 | 0.740 | 4 |
Effective human resource planning | 0.660 | 0.742 | 0.677 | 0.884 | 0.658 | 0.737 | 5 |
Clearly written line of responsibility | 0.686 | 0.725 | 0.673 | 0.867 | 0.678 | 0.737 | 6 |
Adequate communication among project team members | 0.669 | 0.733 | 0.715 | 0.859 | 0.652 | 0.737 | 7 |
Commitment of the project team | 0.688 | 0.733 | 0.692 | 0.856 | 0.658 | 0.736 | 8 |
Positive attitude of employees | 0.678 | 0.716 | 0.673 | 0.846 | 0.720 | 0.736 | 9 |
Availability of employee motivation system | 0.663 | 0.694 | 0.695 | 0.867 | 0.677 | 0.731 | 10 |
Client satisfaction | |||||||
Professionalism of services provided by project team | 0.776 | 0.798 | 0.761 | 0.903 | 0.758 | 0.802 | 1 |
Timeliness of service | 0.708 | 0.770 | 0.755 | 0.905 | 0.786 | 0.790 | 2 |
Effective planning and scheduling | 0.747 | 0.848 | 0.740 | 0.880 | 0.714 | 0.789 | 3 |
Commitment and involvement of top management | 0.779 | 0.791 | 0.733 | 0.867 | 0.726 | 0.781 | 4 |
Effective coordination between client and project parties | 0.734 | 0.774 | 0.750 | 0.882 | 0.748 | 0.781 | 5 |
Accurate project cost estimates in accordance with plans and specifications | 0.729 | 0.795 | 0.796 | 0.869 | 0.678 | 0.774 | 6 |
Client orientation | 0.748 | 0.761 | 0.736 | 0.866 | 0.731 | 0.772 | 7 |
Adequate cost control measures | 0.689 | 0.742 | 0.804 | 0.889 | 0.718 | 0.771 | 8 |
Participation and commitment of project teams | 0.703 | 0.764 | 0.738 | 0.885 | 0.739 | 0.770 | 9 |
Effective management and organisation of work | 0.734 | 0.763 | 0.722 | 0.884 | 0.725 | 0.770 | 10 |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2024 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Homthong, S.; Moungnoi, W.; Charoenngam, C. Whole Life Critical Factors Influencing Construction Project Performance for Different Objectives: Evidence from Thailand. Buildings 2024, 14, 999. https://doi.org/10.3390/buildings14040999
Homthong S, Moungnoi W, Charoenngam C. Whole Life Critical Factors Influencing Construction Project Performance for Different Objectives: Evidence from Thailand. Buildings. 2024; 14(4):999. https://doi.org/10.3390/buildings14040999
Chicago/Turabian StyleHomthong, Samart, Wutthipong Moungnoi, and Chotchai Charoenngam. 2024. "Whole Life Critical Factors Influencing Construction Project Performance for Different Objectives: Evidence from Thailand" Buildings 14, no. 4: 999. https://doi.org/10.3390/buildings14040999
APA StyleHomthong, S., Moungnoi, W., & Charoenngam, C. (2024). Whole Life Critical Factors Influencing Construction Project Performance for Different Objectives: Evidence from Thailand. Buildings, 14(4), 999. https://doi.org/10.3390/buildings14040999
