3.3.1. System Boundaries and Modeling Assumptions
This paper takes the risk of technological innovation in the construction of major railway projects as the research object, reveals the dynamic evolution law of risk over time in the construction process of technological innovation projects of major railroad projects, and analyzes the degree of influence of risk factors on technological innovation risk.

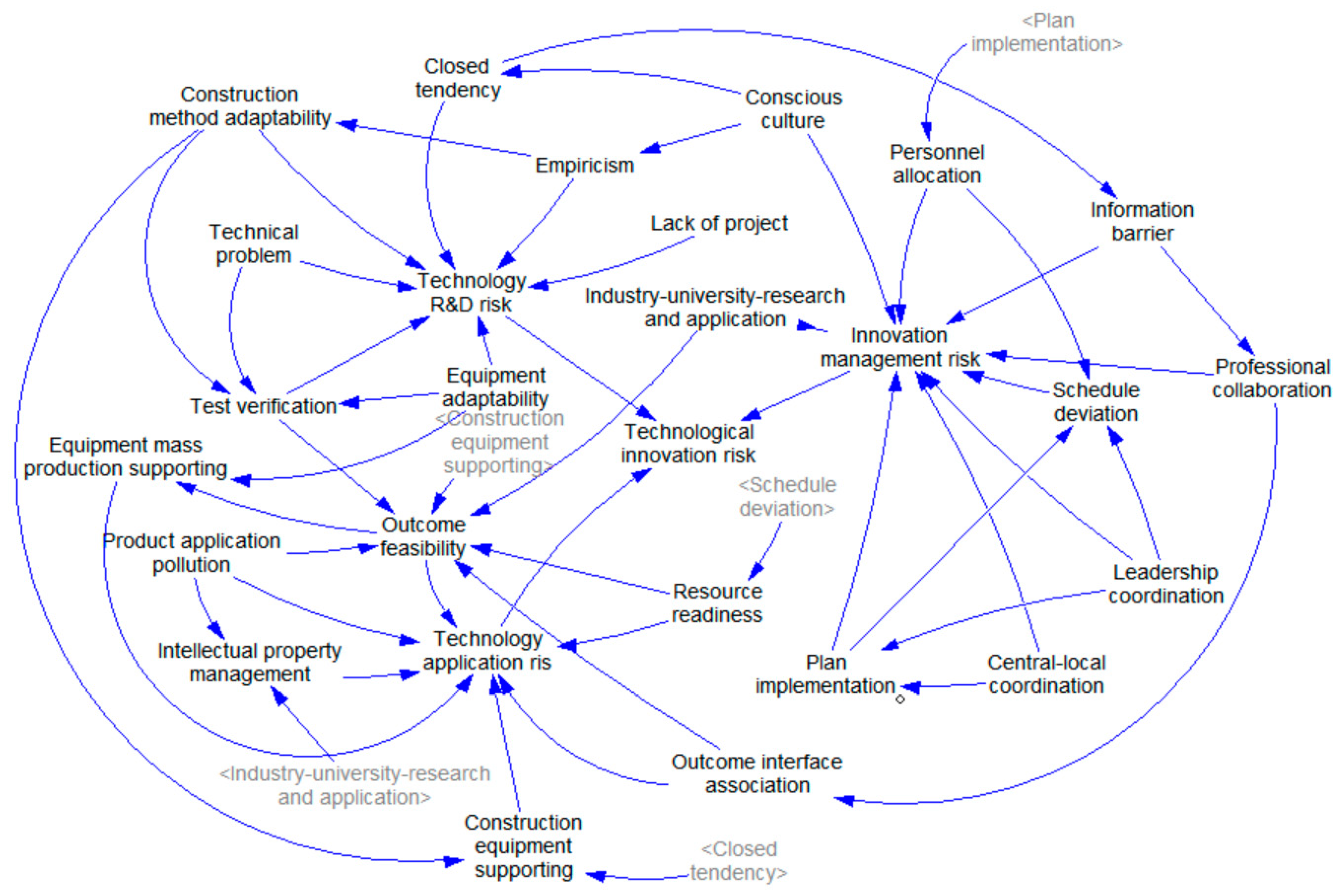

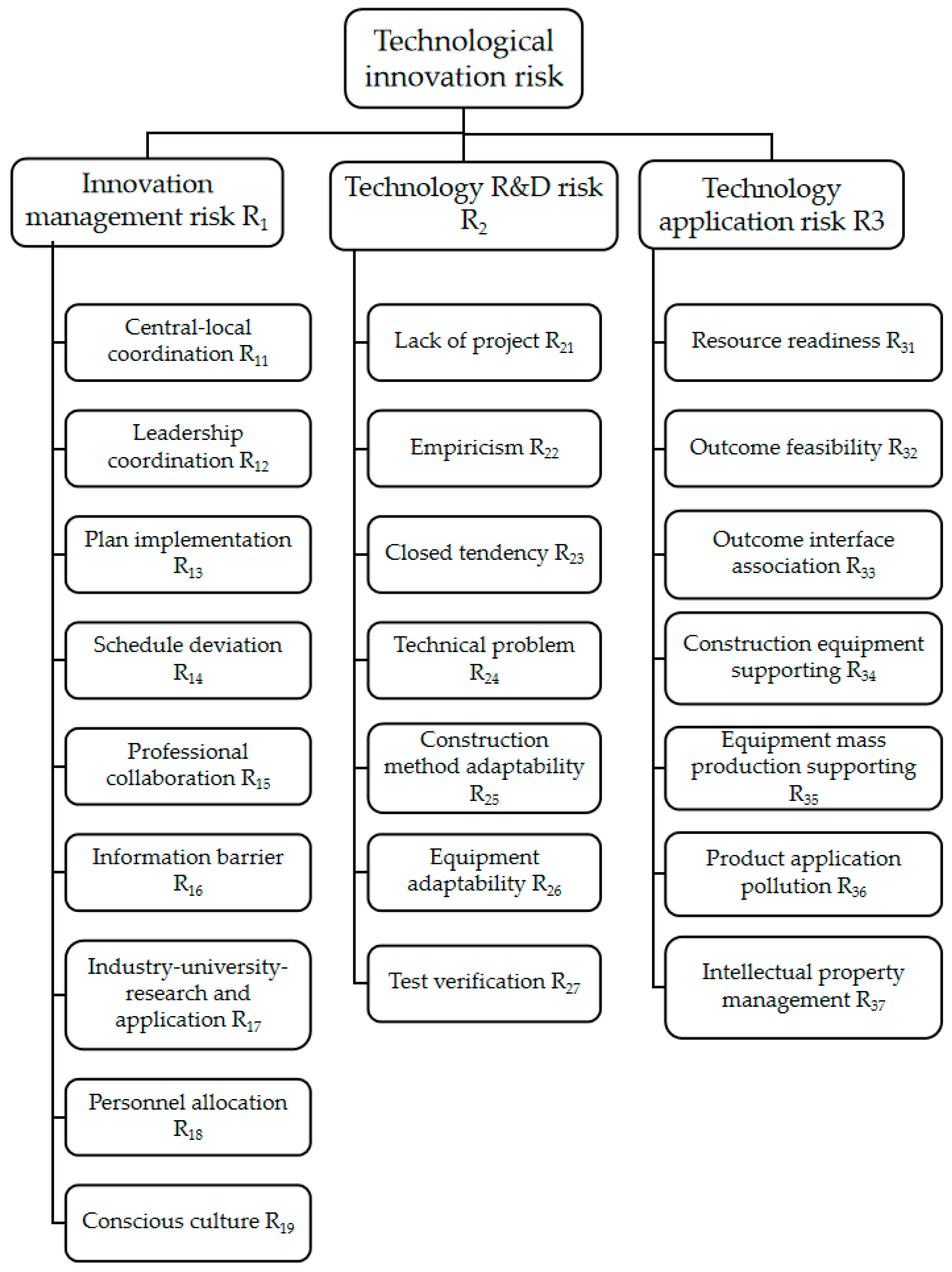

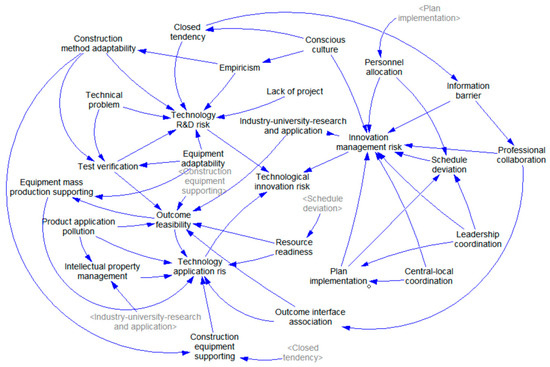

Before constructing the system dynamics model of major railway engineering technological innovation risk, it is necessary to delineate the system boundaries, exclude the unimportant elements that cannot effectively influence the system, and retain only the key factors, so as to facilitate the clearer expression of the main contents of the system. In this paper, the major railway engineering technological innovation project is defined as a closed system with a wide range and a complex operational process, which needs to determine the endogenous and exogenous variables in the system. The major railway engineering construction technological innovation process will face risk factors from different sources; with reference to the risk classification basis in the field of engineering construction technology innovation, this paper, from the authors’ point of view and technological innovation process, will be discussing a major railway engineering technological innovation risk system, which is divided into innovation management risk subsystems, technology R&D risk subsystems, and technology application risk subsystems. The innovation management risk subsystem includes risk factors such as central-local coordination, leadership coordination, plan implementation, schedule deviation, professional collaboration, information barriers, industry–university–research and application, personnel allocation, and conscious culture. The technology R&D risk subsystem includes risk factors such as lack of projects, empiricism, closed tendency, technical difficulties, construction method adaptability, equipment adaptability, and test verification. The technology application risk subsystem includes risk factors such as resource readiness, outcome feasibility, outcome interface association, construction equipment supporting, equipment mass production supporting, product application pollution, and intellectual property management. In summary, the boundaries of the major railway engineering technological innovation risk system dynamics model are innovation management risk subsystem, technology R&D risk subsystem, and technology application risk subsystem and its risk factors.
Meanwhile, in order to simplify the model and improve the relevance of the study, the following assumptions are made for the system:
Assumption 1. The technological innovation risk of railway engineering construction is a complex system, and only the role of innovation management risk, technology application risk, and technology application risk factors and their comprehensive impact on the technological innovation risk system are considered in the model.
Assumption 2. It is assumed that all the risk factors of technological innovation risk of major railway projects will neither be in a perfect nor imperfect state within the time limit, but will only change within a certain range, and will not suddenly undergo great changes.
Assumption 3. Only the risk factors from the decision-making and planning stage to the implementation and application stage of the project are considered.
3.3.4. Determine the Model Parameters and Equations

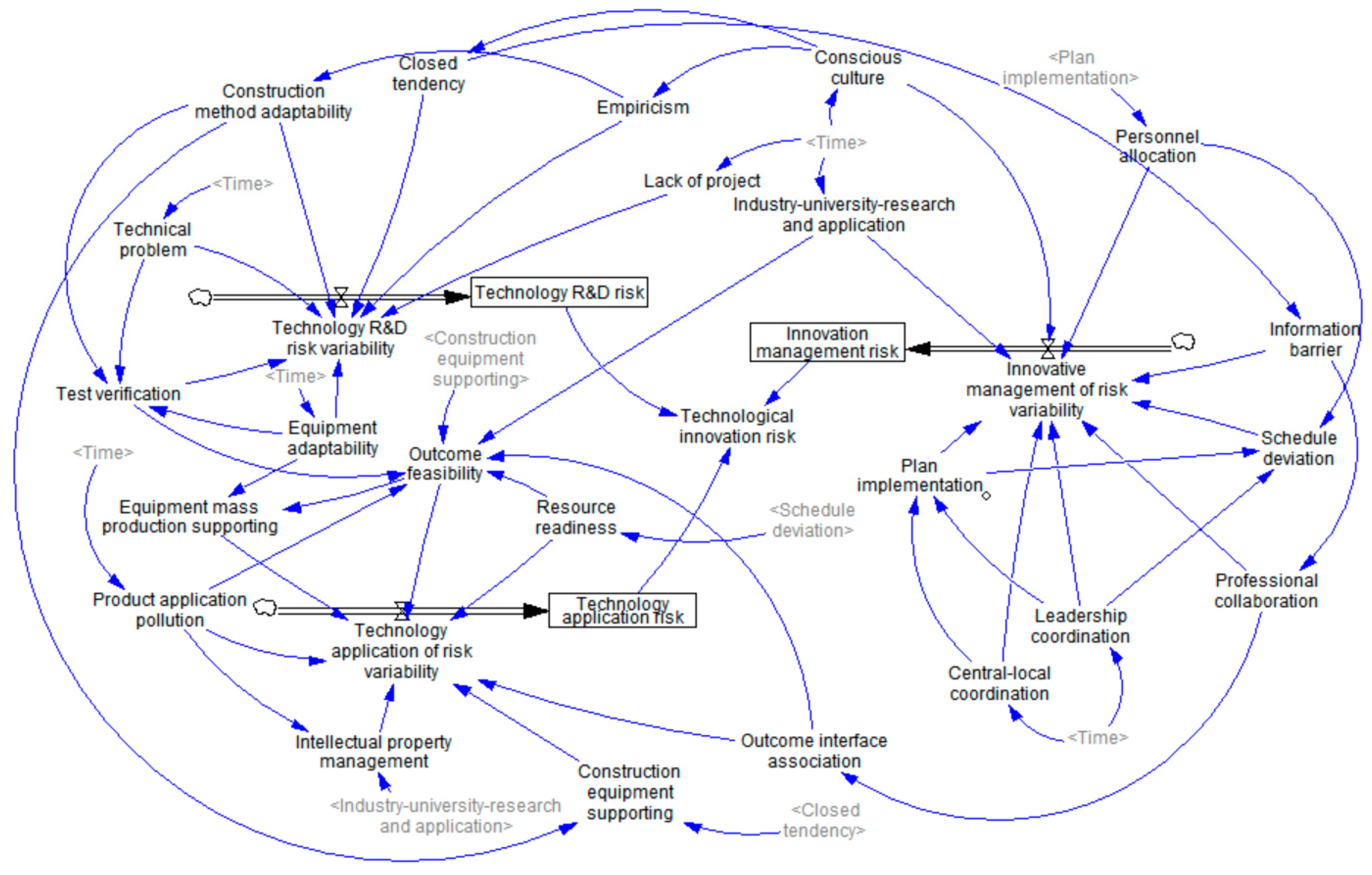

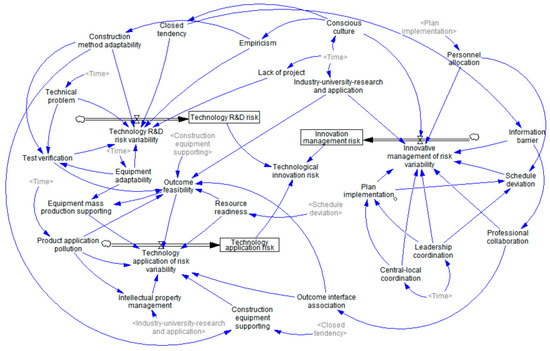

This model equation considers the different stages of each risk factor using the single pulse function as a constraint, and with reference to the actual progress of a technological innovation project of C railway engineering, it is set that the decision-making planning stage is 3 months, the technology R&D stage is 21 months, and the technology application stage is 12 months. According to whether the risk factors are affected by other risk factors in the system, they are divided into endogenous variables and exogenous variables; for the exogenous variables that are not affected by the internal system, the introduction of the risk evolution index describes the change in risk factors over time, specifically as shown in Equation (1), where Ri (t) is the value of the risk factor Ri at “t” time, r
0 is the value of the risk factor at t = t
0, a is the risk evolution index: a > 0 indicates that the risk is more and more serious, a = 0 indicates that the risk factor is constant and does not change over time, a < 0 indicates that the risk is gradually becoming smaller, (t
0, t
1) is the time of risk generation. For the endogenous variables to introduce the influence coefficient, specifically as shown in Equation (2), where w
ij is the degree of influence of risk factors R
j on risk factors R
i.
- (1)
The determination of the initial value of a variable
After completing the construction of the technological innovation risk evolution model of major railway project construction, the initial value of the required parameters in the model variables should be determined first. This study uses the risk matrix method to determine the initial value of each risk factor, through expert scoring to determine the likelihood of the emergence of risk factors and the severity of the consequences of risk factors to determine the initial value of risk factors R = f (p, c).
The specific calculation formula is

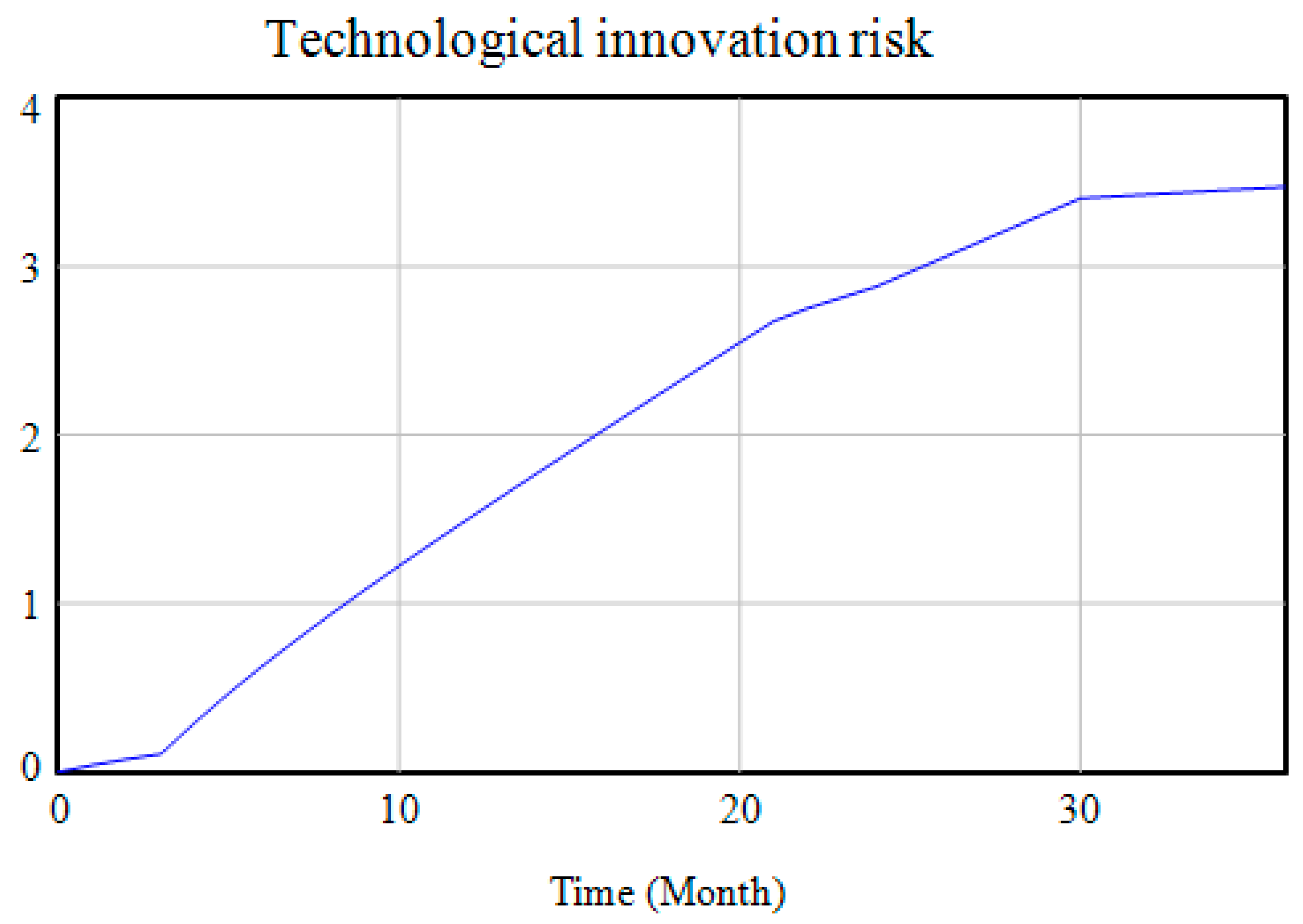

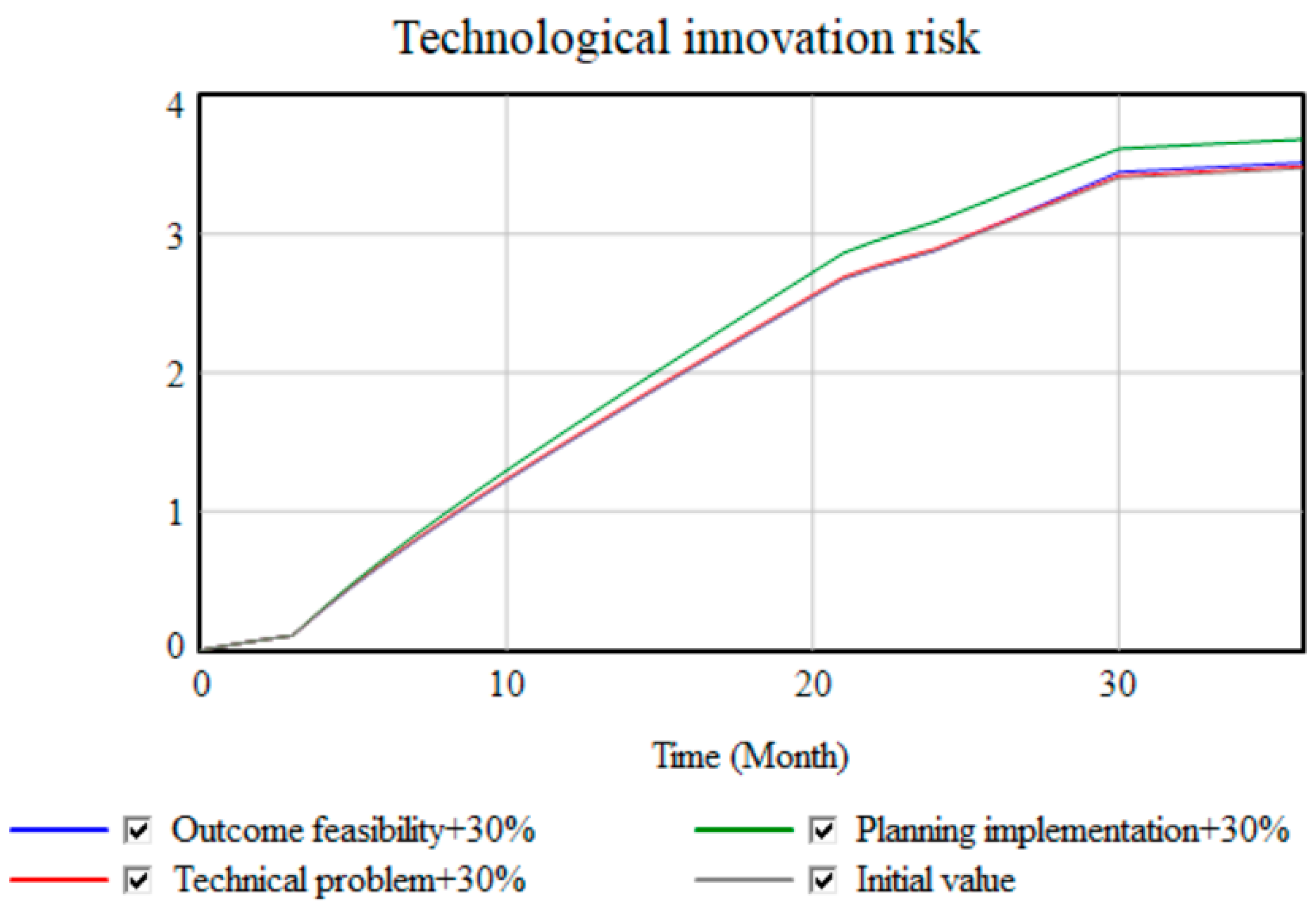

The initial values of the risk factors in the system are shown in
Table 2.
- (2)
Calculation of risk factor weights
In this section, by adopting the comprehensive empowerment method, one can organically combine the subjective and objective empowerment methods, so that it can not only reflect the researcher’s subjective will for the research object, but also make up for the defects of poor objectivity brought about by insufficient data. To sum up, this study will adopt both the entropy value method and G1 method to empower the risk factors of technological innovation.
(1) Entropy
German scholar Rudolf Clausius put forward the concept of “entropy” in 1850, which is used to indicate the distribution of energy in space, the more uniform the distribution, the greater the entropy value. Claude Elwood Shannon introduced this concept into the information theory to judge the degree of disorder in the system. The connotative idea is to determine the weight of the corresponding indicator by the size of the information provided by each indicator. The main source of data for this study is the scoring of relevant experts and scholars in the field of railway construction. If there is a big difference between the data scored by experts for a certain indicator, the score cannot be deleted, and it should be considered that the information contained in this indicator is bigger, which may be more important for the study of the evolution of technological innovation risk in the construction of major railway projects. Therefore, the use of entropy value method of weight assignment can be pre-set indicators for experts to give subjective weight, and then use the entropy value method for weight correction, the specific steps are as follows. The questionnaire is shown in
Appendix A.
① Create a matrix of expert scores for each risk indicator.
② Perform dimensionless processing of the data, using the standardization method in the non-linear method to calculate the mean and standard deviation:
③ Calculate the weight of each expert’s score under the jth risk or risk factor
:
④ Calculate the entropy of each risk and risk factor
:
where “m” is the sample size, i.e., the number of experts involved in scoring.
⑤ Calculate the coefficient of variation for each risk and risk factor
:
⑥ Calculate the weight of each risk and risk factor
:
(2) G1 method
G1 method was first proposed by Prof. Guo Yajun of Northeastern University on the basis of hierarchical analysis method, which is a new method without constructing judgment matrix or consistency test. The principle of its assignment is to judge the importance of evaluation indexes by experts, and then assign the importance between them according to the scoring principle. The main steps of the method are as follows. The questionnaire is shown in
Appendix B.
① Determination of the order relationship
When the degree of importance of the evaluation index a
i relative to a
j is large or equal, it is written as a
i ≥ a
j, when the evaluation index “
…
” satisfy the relation “
≥
≥ … ≥
, it represents that the evaluation indicators
…
the order relationship is determined by “≥”. Here,
denotes the ith evaluation indicator after {a
i} is ranked according to the ordinal relation “≥”, which is still denoted below. Denote the relation as
② Comparative judgment of the relative importance of the indicators is given
Set up a ratio
to
for the level of importance of the experts between the evaluation indicators
and
:
The assignment of
can be referred to as shown in
Table 3.
③ Calculation of weighting factors
Based on the
values given by the experts, it comes out
to be
④ Categorized discussion of cluster evaluations
When several experts were invited to evaluate the evaluation indicators, the findings that emerged were generally the following:
a. Cases with the same ordinal relationship
Assuming that L indicates that the experts are identical with respect to the ordinal relationship between indicators
, …,
, it can be recorded as follows:
Let the assignment of expert K to (i = n, n − 1, n − 2, …, 3, 2) be in the order
where
satisfies
(i = n, n − 1, n − 2, …, 3, 2) yields:
b. The situation in the event of inconsistencies in ordinal relationships
Assuming that there are L0 (1 ≤ L0 ≤ L) experts to give the evaluation of the ordinal relationship between the indicator , …, is the same, the corresponding weight of the indicator can be obtained as .
Let the L-L0 experts with different order relations give the order relations as
where
denotes the ith element in the set {
} (i = 1, 2,
, n) of experts K arranged in the order relation “
”. Let the ratio of the importance of expert K to the ratio between
and
be
, when
satisfies
then the weight coefficient of
:
(i = n, n − 1, n − 2,
, 3, 2
− L0) can be found.
For each k (1 ≤ k ≤ L-L0), the sets {
} and {
} correspond one to one. The weights (i = 1, 2, …, n) based on the judgments performed by each expert k (1 ≤ k ≤ L-L0) are used as the result of the combined calculation, denoted as
:
The final synthesis yields a weight of ( > 0), generally taken as =/=/.
(3) Comprehensive Empowerment Method
After assigning weights to each risk and risk factor by the entropy value method and G1 method, respectively, the final weights are determined by comprehensive assignment method [
51]. Let denotes the weight of each risk and risk factor, denotes the weight obtained by entropy value method, and denotes the weight obtained by G1 method.
where
is the proportion of the objective preference coefficient weights to the combination weights. The objective function is established with the goal of minimizing the square sum of the deviations between the combined weights and the entropy weights and the deviation between the combined weights and the G1 weights, namely
After substitution, the derivation about and the other first-order derivative is zero, solve the equation to obtain .5, then the optimal composite weight results in half of the subjective and half of the objective weights when the composite weights minimize the sum of the squares of the two deviations from the subjective and objective weights, respectively.
(4) Weighting
Through the questionnaire data and entropy method steps for the objective weights of risk factors, the data were normalized, and the results of the calculations are shown in
Table 4.
(5) Determination of model parameter equations
Based on the above initial values of risk factors and risk factor weights, due to the limited space of the article, only the equations of the main variables of the model are listed, as shown in
Table 5.
