Case Report

Dye Schedule Optimization: A Case Study in a Textile Industry

by
Uiraquitan Tadeu Gomes
1,*,
Plácido Rogério Pinheiro
2 and
Rommel Dias Saraiva
2
1
Vicunha Têxtil S/A, Maracanaú 61939-210, Brazil
2
Graduate Program in Applied Informatics, University of Fortaleza, Fortaleza 60811-905, Brazil
*
Author to whom correspondence should be addressed.
Appl. Sci. 2021, 11(14), 6467; https://doi.org/10.3390/app11146467
Submission received: 11 June 2021 / Revised: 30 June 2021 / Accepted: 7 July 2021 / Published: 13 July 2021
(This article belongs to the Special Issue Textiles Surface: Wearable and Smart Devices)

Abstract

:
In a demanding and globalized market, production management plays a fundamental role in the company’s reference. Proper management of the production area allows companies to obtain productivity gains, reducing operational costs and make contributions to face the competitiveness of their competitors. When defining its strategic objectives in a productive system, it is necessary to formulate plans to manage human resources and strategies based on requirements. In this context, planning, production, and control (PPC) is an excellent ally of the organizations. The adequate development of the activities of the PPC allows companies to minimize production orders not attended, minimize stocks of raw materials, and finished products, minimize idleness of human resources by efficient allocation of work and minimize production processing times. The present work proposes a study to organize and develop a model that guides the prediction of the setup gain in the fabric dyeing process, structured by the traveling salesman problem.

1. Introduction

Globalization crosses borders, and free trade intensifies between countries. As a result, many sectors of the economy benefited from trade barriers that limited import and export quotas find themselves threatened by foreigners. In this sense, the threat of new entrants implies competition for market share, reduced margins, better performance, quality, cost, productivity, and operational efficiency. According to [1], these factors are essential for companies to be consistently inserted as new competitive dimensions.
In conjunction with coordinated and integrated operational management, an organization’s livelihood depends on its financial and economic results. Thus, resource management aimed at reducing costs without compromise the benefit to customers. These resources must be managed efficiently, minimizing waste and costs, and maximizing profits [2].
In this context, a planning area plays a fundamental role in the company’s strategy, coordinating the flow of information so that available resources are directed to serving the end customer at the lowest cost. To seek efficient use of resources, companies are increasingly using tools and methods to support decision making [3].
It is no different in the textile and clothing sector, as it has been suffering from the loss of market share for imported products and its low operational efficiency. The sector presents a high complexity in the planning process due to the vast portfolio of products needed to meet the dynamism of the fashion market. Serving this market requires a lot of flexibility in the production process that can often compromise its operational efficiency, so the quality of the preparation of the production schedule impacts productivity, intermediate stocks, quality, and billing.
According to [4], Brazil holds the most extensive integrated textile chain in the West, ranging from the production of fibres, through cotton plantations, for example, to fashion shows, going through all industrial processes such as spinning mills, weaving, finishing, clothing, and retail. Among the different types of fabrics produced, the study turns its attention to the production of denim, a kind of fabric that is the basis to produce jeans.
Nowadays, most textile industries use automated equipment for scale and quality. In the context of the fourth industrial revolution, the textile industry seeks to expand from automation to planning and scheduling tasks [5]. Until the mid-1960s, many papers published assumed that setup time (cost) was not necessary. However, this assumption simplifies the analysis and compromises the solution quality of many scheduling applications requiring appropriate treatment of setup time (cost) [6].
Setup times are significant in the textile industry and should be considered as separated. Fabrics are produced on looms with specific adjustments, and when this fabric is changed, the loom must be adjusted accordingly, consuming time that is a scarce resource [7].
Given the context presented, the following research question arises:
  • How to improve the scheduling of the fabric dyeing process by optimizing setup times?
This research is positioned in the operational research (OR) in mathematical programming involving integer programming models. It aims to present a solution model for the production scheduling problem applied in a confirmed case of fabric dyeing scheduling, structured in the traveling salesman problem, to optimize the setup. The purpose of this research goes beyond the comparison between scheduling methodology, and it aims to obtain a formulation that can be replicated in companies of the same segment.
The remainder of the paper is structured as follows. Section 2 presents a literature review with the main concepts, definitions, and approaches on the Brazilian textile sector, planning production control and operational research. Moreover, Section 3 focuses on research methodology, with its characterization and structuring choose the representative features for simulation and comparison between the optimized model and empiric model. Besides, Section 4 shows the evaluation model’s structuring, containing the relationship of the result with the parameters. Finally, Section 5 concludes with results and discussions of this application, followed by a conclusion.

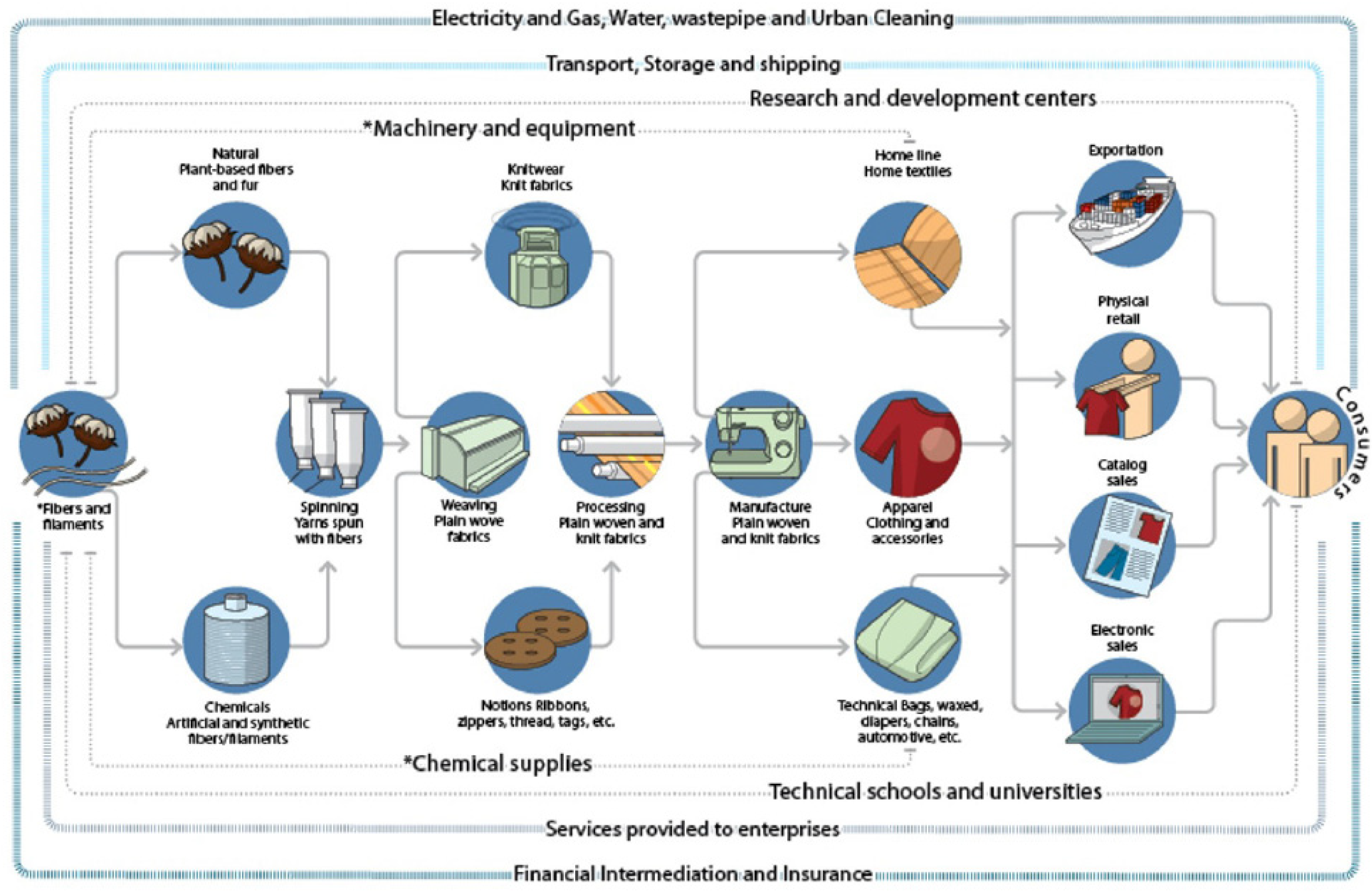

2. Brazilian Textile Sector

Denim is a popular fabric that no other fabric has received such a wide acceptance [8]. Today, Brazil is a world reference in beachwear, jeanswear and homeware design, with the fitness and lingerie segments has also grown. The sector is one of the largest employers in the country, accounting for about 1.5 million direct jobs, equivalent to 21% of the total workers allocated to industrial production in 2019, reinforcing the sector’s importance for the economy in general. In that same year, the textile chain produced approximately BRL186 billion, equivalent to 7% of the total production value of the Brazilian transformation industry, excluding the mineral extraction industries and civil construction activities [9].
Domestic production is practically directed to meet domestic consumption, but a relevant portion of what is consumed internally is imported. Analyzing the imports of the entire textile chain from 2015 to 2019, there was an increase of 20.7% in volume but a drop of 10.7% in value. There was an increase of 56.4% in volume and 29.9% in value in the fibre and filament segment. On the other hand, textile manufacturers advanced 4.5% in volume and retreated 8.8% in value, while in manufactured goods, there was a drop of 3.7% in volume and 25.2% in value. The behaviour of imported apparel, which fell in both types, is due to competition with domestic production in the period, which was more advantageous for purchase after the increase in imported products [9].

2.1. Manufacture

The textile chain starts transforming the raw material (natural, synthetic fibres and polymers) into yarns and filaments in the spinning mills. Then there can be two flows, first: warping, dyeing, flat weaving, finishing, and finally the clothing phase, and second: knitting, finishing, and finally the clothing and distribution phase. In Figure 1, we can see the macro flow of the chain. Thus, the result of each step constitutes the primary input of the next one. Each stage has its characteristics, with discontinuity between them, subdividing into several operations and elaborating intermediate products.
The dyeing sector stands out as a critical process in operation and with many opportunities for gain. Beyond the technical aspect, there have been concerns about minimizing the negative environmental impact of the dyeing industry. For this production, scheduling has been applied [10] in many process industries for reducing pollutions emissions. Denim manufacturing faces an eco-efficiency challenge concerning sustainability. Alternatives have been studied to develop new dyeing processes that are cleaner, more efficient, faster, cheaper, and easier to apply [8].
The dyeing process of denim type fabrics (used to make jeans) is characterized by dyeing the cotton yarn before weaving [11]. In this process, the most used dye is indigo, whose method remains the same as natural indigo [12].
In the continuous indigo dyeing process, there are three technologies, which are:
  • Rope dye
  • Slasher dye
  • Loop dye

2.2. Planning Production Control

The problem of timing and sizing production lots are frequently in several companies. These setup operations, like switching between production batches, machine adjustments, and cleansing procedures over a given planning horizon, are critical because the sequencing influences the consumption time and raises costs [8]. Sequencing establishes the order in which lots are executed within a period, accounting for the sequence-dependent setup times and costs. Integration of lot sizing and sequencing enables the creation of better production plans. Production plans can minimize the overall costs of stock holding and setups while satisfying the available capacity in each period from which the expenditure in setup times is deducted [13].
Planning production control (PPC) is responsible for coordinating a company’s productive resources to meet market demands, reconciling internal limitations (production and financial capacity) and assisting in the organization’s decision-making, such as stock policies, service level in service and cost reduction [14].

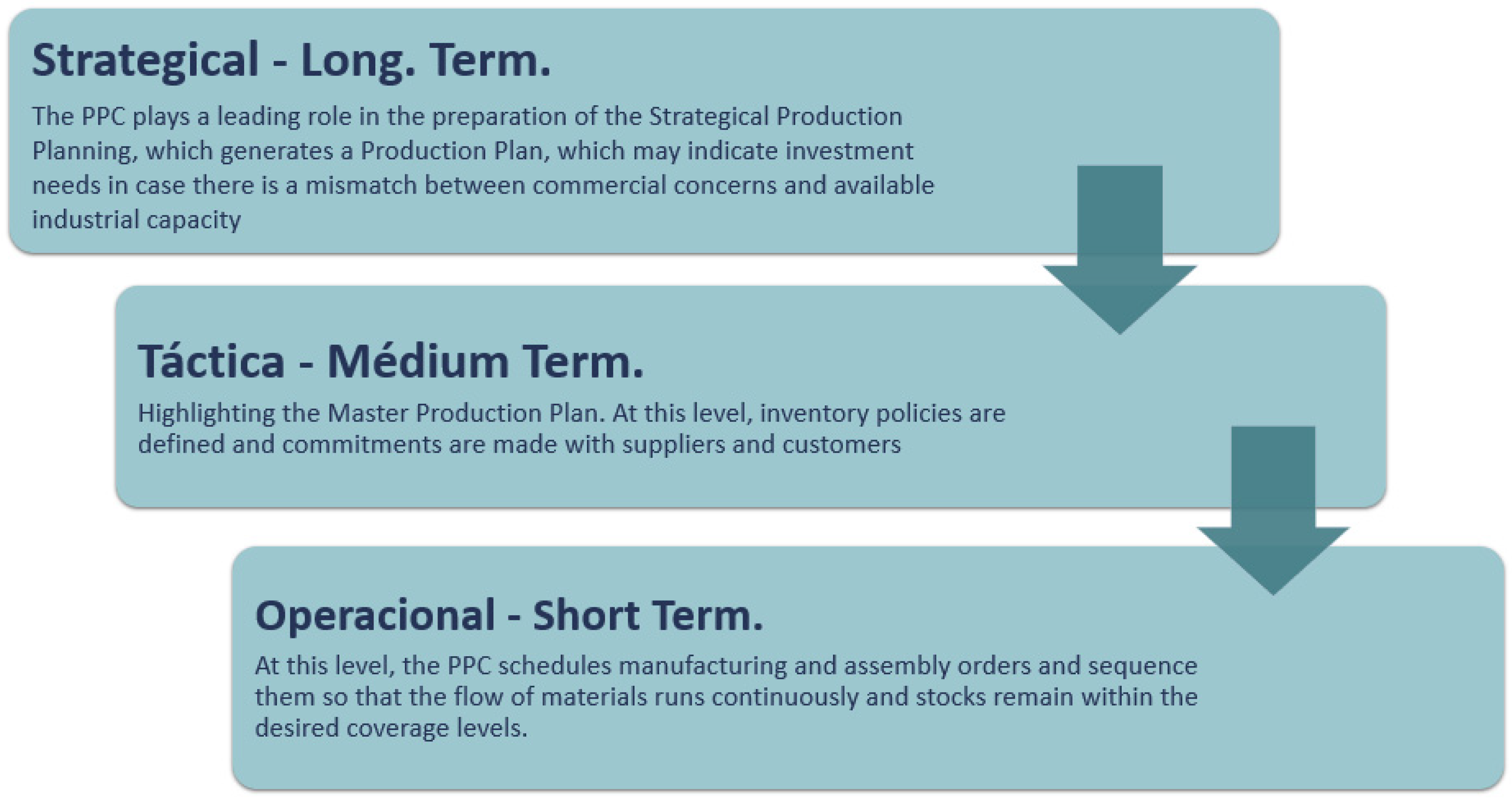

According to [15], the PPC performs activities at three different hierarchical levels. Each level varies according to the time horizon understudy, as shown in Figure 2.
PPC is responsible for managing the flow of information through various production systems to meet best the plans established at the strategic, tactical, and operational levels.

2.3. Operational Research

The growth and complexity of organizations that emerged after the industrial revolution led to a division of labor and fragmentation of managerial responsibilities. Although this fragmentation of tasks has generated excellent results, in many cases, different sectors have their own goals and values, losing sight of the organization’s functioning. The organization of the operations of these large corporations made new methodologies popular. Among them, we highlight the scientific approach called operational research (OR), which aims to solve decision-making problems through typically mathematical models, whether deterministic or probabilistic [16].
According to [17], OR is characterized using scientific and quantitative methods by interdisciplinary teams to seek the best use of scarce resources and optimize and coordinate the operation of a company.

2.3.1. Integer Programming

For a problem to be classified as an integer programming (IP) problem, all decision variables in the model must be discrete. They can assume values within a finite set or a countable amount of importance derived from a count. When part of the decision variables is discrete, and the others are continuous, the model is called mixed integer programming [18].
In cases where all decision variables are binary, they can only assume values of 1 or 0. There is a Binary Programming model. Further, when part of the decision variables is binary, and the others are continuous, there is a mixed binary programming model. Furthermore, when the model has decision variables, discrete and binary, there is a binary integer programming problem [18].
Task assignment problems are examples of binary programming, including backpack problem, traveling salesman problem, vehicle routing problem, among others. As an example of IP, there is the problem of staff scheduling, and as an example of the mixed binary problem, there is the problem of the location of facilities [18].

2.3.2. Traveling Salesman Problem

The travelling salesman problem (TSP) is one of the most widely studied problems in the combinatorial optimization area [19]. TSP is interesting not only from a theoretical point of view but because of the various practical applications that can be modelled by the problem or its variations, with the need to find an efficient algorithm to solve it, among the most valuable applications known from the TSP, stand out the sequencing of the machine operations in manufacturing, optimization of hole drilling in printed circuit boards and most vehicle routing problems [20]. According to [13], it can be an essential source of ideas for developing more efficient models and scheduling problems. Similarities between TSP and the sequencing problem allow for direct manufacturing, where the city would be a job. The distance between one city and another would be the time (cost) of moving from one job to another [21].
We can describe the problem as follows: a travelling salesman has the task of visiting a set of cities, with each pair of cities i and j having an associated cost, representing the distance to travel from city i to city j. The salesman must depart from an initial town, visit all other cities once and return to the city of departure, completing a Hamiltonian Cycle at the lowest possible cost or the shortest trajectory.
There are several formulations for the TSP, and these formulations can be considered canonical because it is a classic optimization problem widely spread in the specialized literature and because they develop peculiar ways of characterizing the problem. To simulate the dye sequencing to obtain the shortest setup time, the TSP model was used, with the approach proposed by Miller–Tucker–Zemlim (MTZ) formulation, with the contribution of [22,23], for the elimination of sub-routes, because according to the latter, the MTZ formulation is vulnerable to the relaxation of constraints. This model was chosen because it works with a limited number of restrictions.
Min   J = 1 n i = 1 n c i j x i j
subject to:
i = 1 n x i j = 1 ;   j = 2 , , n
j = 1 n x i j = 1 ;   i = 2 , , n
The formulation of elimination of subtours proposed by MTZ, can be expressed by:
u i u j + ( n 1 ) x i j n 2 ;   2 i j n
1 u i n 1 ;   i = 2 , , n
The formulation of elimination of sub tours proposed by MTZ can be strengthened using the elevation technique [22].
u i u j + ( n 1 ) x i j + ( n 3 ) x j i n 2 ;   2 i j n
Equation (1) represents the objective function to minimize the total cost of the salesman route, where c i j is the cost or distance of the arc i, j and x i j is the binary variable (0 or 1) that decides whether route i, j will be included in the problem’s solution or not. Equations (2) and (3) refers to constraints that ensure that each node or vertex has only one input and only one output to the optimized graph.
Moreover, Equations (4) and (5) prevent the travelling salesman, saw more than n cities on a trip (a trip we understand, as visiting all the cities without passing through the city origin). In addition, u i and, u j are non-negative variable, which represents the number of cities visited before returning to the city of origin. However, it still does not guarantee the existence of sub tours, that is, two or more graphs disconnected from each other. Thus, adding a set of constraints like Equation (6) on the possible sub tours of the problem does not contain enough edges to make them closed loops.

3. Structuring the Problem Assessment Model

In this section, will be presented the methodological aspects necessary for the research to reach the proposed objectives are addressed. The section is divided into four parts, starting with the research characteristics and then by the three phases of study construction: informative, development and application.
On the other hand, this research is applied because it aims to develop a study to reduce setup time in a dyeing process in the textile industry, and with a qualitative–quantitative approach, as it will use statistical resources and techniques and will have interactions with experts from process and researchers to legitimize the information gathered and generate practical knowledge.
This research is characterized as a case study in the denim textile industry, and analyzes will be carried out on documents, data collection, identifying the current sequencing process of the dyeing schedule, and the impacts of the application of setup optimization cost and time availability.
Then, an optimizer processed these data that proposed an optimal fabric dyeing scheduling, whose objective function is to reduce the total setup time. Subsequently, the two situations (empirical and optimized) were compared to measure the financial impact and the factors that correlate to the outcome of the problem.
Regarding data collection, they were collected from the company’s database, parameterized from 1 February 2018 to 30 November 2018. This period was chosen because production took place uniformly throughout the year, unlike 2019 and 2020, when there was a substantial recession in the textile sector followed by the coronavirus pandemic, which would undoubtedly compromise data quality. In addition, January and December are months of return from vacations and deceleration of production for the beginning of holidays.

3.1. Informative

This research is structured in three data collection instruments: bibliographic research, electronic research, and interviews. For [24], bibliographical research is intended to put the researcher in contact with everything that has been produced on the subject.
This study began with searching for the existing theoretical framework on the subject in question, with a systematic literature review being carried out, selecting books, journal articles, doctoral theses, and master’s dissertations, which had some degree of impact on the research.

3.2. Development

The structuring phase began with electronic research through data collection in the company’s information system. The report used to obtain the data was parameterized for the period from 1 February 2018 to 30 November 2018. This report could extract the accurate dyeing scheduling, type of SKU (stock keeping unit) processed, the machine used, and the processing date. Then, interviews were conducted with experts in dyeing and PPC through brainstorming, as shown below.
(a)
Step 1—Interview with dyeing experts
At this stage, interviews were conducted with experts in the dyeing area to review and structure the setup time matrix.
(b)
Step 2—Interview with PPC and dyeing experts
At this stage, a brainstorming session was carried out between the PPC and dyeing team members to define the factors that could most influence the dyeing setup time. After brainstorming, the PPC and dyeing teams evaluated three factors as the most relevant: machine group, SKU number and programming horizon. It is believed that there is a correlation between these factors and setup time.

3.3. Application

For the study of setup time scheduling, the traveling salesman problem methodology was chosen, as it was seen the opportunity to employ a classic problem, which consists of searching for a circuit that has the shortest distance, passing through n cities, starting from any city, visiting all the others once and returning to the city of origin. In the study in question, the SKUs will represent the cities, and the setup time between pairs of SKUs will represent the distance between cities.
Considering that the analysis aims to create a model that guides the prediction of setup time gain, comparing the optimized method with the empirical method, the tests were performed within a set of configurations, parameterized by factors that are subject to change, and which may influence the result of the optimization.
The factor is:
  • Machine group: despite not being input to the problem, it deserves attention because the analyzed samples were processed in two groups of machines: slasher dye, being more complex and larger machines for more elaborate dyeing, and loop dye are smaller machines with a more straightforward conception and low-cost dyeing, so the two groups must be analyzed separately.
  • Number of SKU: this factor is susceptible to seasonality and can vary significantly depending on fashion trends and market demand.
  • Programming horizon: the further we can see the demand, the greater the optimization opportunities, so for each composition of machine group and SKU number, tests were performed for different horizons, ranging from one to four weeks.

4. Evaluation Model

According to [25], a model represents an object, system, or idea in some form other than the entity itself and aims to understand the characteristics of the real system better.
We can consider two ways to solve the sequencing problem using TSP, the first one, considering that each SKU will be produced only once per cycle, and determining the sequence that minimizes the total setup. Furthermore, the other way is to establish a finite number of production runs for a given number of SKUs. An SKU can be programmed more than once in the cycle and then determine the runs that optimize the total setup [26].
Bringing this model to the case of fabric dyeing scheduling, the matrix VxV with c i j elements are considered, where V represents the total of SKU number, and c i j the setup time necessary to adjust the machine to the SKU j, from that the SKU i was produced immediately before. Given this condition, it is possible to form a cycle with the V SKUs taking their respective c i j as for arc length [27].

4.1. Structuring Setup Time Matrix

The company studied is composed by two groups machines, slasher dye group and loop group.
The preparation of the setup time matrix was structured from the survey of the SKUs processed throughout 2018. From the knowledge of the SKUs processed in each dyeing machine, it was possible to structure a setup time matrix filled in by the area’s technical coordinator, with setup times for each likely SKU pair.
The setup time matrix was building for each machine of the company, and Supplementary Material Table S1 shows an application of a VxV matrix with 38 SKU’s for a machine from the loop dye group.
It can be observed a particularity that distinguishes it from a distance matrix between cities, according to the classic TSP, which has its principal diagonal equal to zero, since the distance to go from city i to the city i is equal to zero. In the case of the dyeing process, the dyeing batches are finite. At the end of each batch of a given SKU, it is necessary to restock the machine with a new load of yarn, prepare dye baths and calibrate the control points of the machine, even if the next batch refers to the same SKU processed previously, so the setup time between pairs of the same SKU will be greater than zero, but less than or equal to the setup time between different pairs of SKUs. Only six machines were eligible for the study from the company’s industrial park, as the others had the exact setup times. Thus, the study was based on three machines from the slasher dye group and three machines from the loop dye group.

4.2. Structuring for Test

To achieve the objectives of the research, which proposes the creation of a model that guides the prediction of reduced setup time, with the adoption of optimization tools, it is necessary to carry out a certain number of tests, in different process configurations, to generate a quantity of data that can provide a function capable of responding to most situations that may be encountered.
As mentioned before, it was evaluated those three factors are relevant to the operation, namely: machine group, SKU number and planning horizon. As the machine groups are already known (slasher dye and loop dye) and we know that the planning horizon will vary from one to four weeks, it remains to define the number of SKUs. For this, an analysis was carried out on the company’s data to identify the number of processed SKUs by the dyeing machine throughout 2018. According to Table 1, we can identify each machine, the number of dyeing batches and the SKU number processed throughout the month. A single SKU can be processed more than once throughout the month, so the number of batches is greater than the number of SKUs.
From these data, it was possible to build a histogram demonstrating the frequency of the number of processed SKU per month for the two groups of machines, as shown in Scheme 1. The importance of this parameter is due to its variability throughout the year, mainly due to market seasonality and fashion trends. Thus, a range of SKU quantities to be tested was defined, which could guarantee a good range of results.

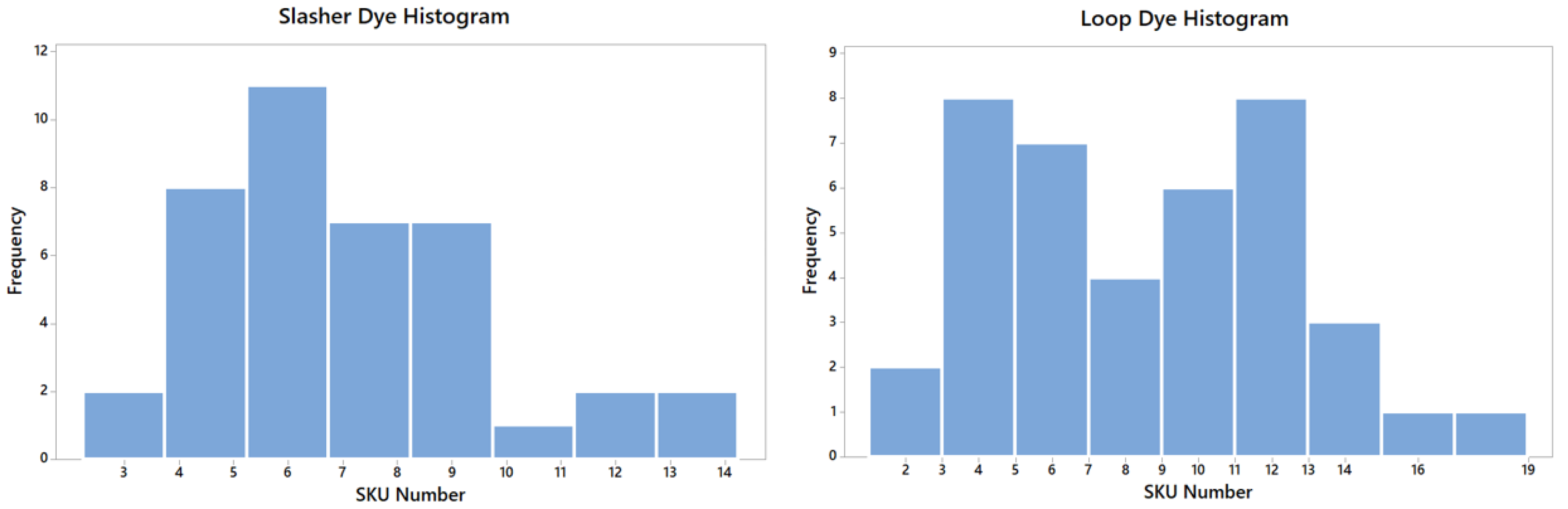

The histograms were thought to select many SKUs for testing to obtain a range of results, which serve as parameters for constructing a linear regression equation. This can be used in other companies with the same similar process.
Therefore, for the slasher dye group, the SKU number defined was: 4, 6, 8, 9 and 12. As for the loop dye group, the SKU number was: 5, 7, 9, 11, 12, 13 and 16. This dataset should cover the possible occurrences. Table 2 shows how the configurations of the number of SKUs per dye machine were structured.
With the definition of these configurations, it was possible to advance the measurement of setup times according to the empirical sequencing through the company’s reports. From the report, it was possible to extract, for each machine, the processing sequence throughout each month, fractionate the horizons. With the setup time matrices, it was possible to measure the setup time to go from SKU i to SKU j.
A total of 52 tests were carried out, 24 tests for the slasher dye machine group and 28 tests for the loop dye machine group. Figure 3 shows an example of setup time measurement performed on machine 7, with 13 SKU, broken down into four horizons.
It is adapting the TSP model to the case study, starting from the need to produce a given amount of n dyeing batches for each SKU, which must be sequenced to obtain the shortest setup time, represented by c i j in the Equation (1). There will be situations that, for the same SKU, the demand will be greater than one dyeing batch. Thus, for each batch to be processed, its code will be indexed to construct the setup time matrix. In this way, the same SKU can appear more than once in the matrix.
To ensure a better understanding, let’s take the situation illustrated in Figure 3, where the development of actions to optimize the sequencing of machine seven of the loop group will be presented.
For the machine in question, tests were performed for three SKU situations, as shown in Table 2. However, it is enough to describe only one situation for a good understanding, as the rationale is the same for all other cases. Therefore, the situation with 13 SKUs will be described, where the reference month was August 2018, as shown in Table 1.

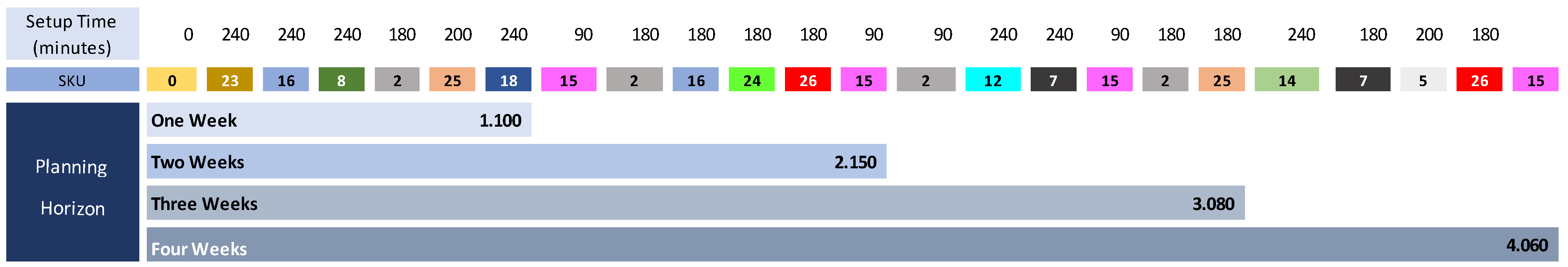

The main matrix was built with all the SKUs processed on Machine 7. As shown in Supplementary Material Table S1, it was possible to build the setup time matrix for each programming horizon, according to Table 3, Table 4 and Table 5.
It can be noted that a SKU was incorporated into the setup time matrix that was called zero and that it has a setup time equal to zero to any other SKU. This device was used so that when completing a sequencing cycle, the return from the last processed SKU would go to SKU 0 because in the real situation, a new sequencing would hardly start from the SKU that was the origin of the previous sequencing.
For the simulations, LINGO software was used, version 17, licensed educational version, and the implementation was performed on a Dell branded equipment, i7 processor, 16 Gb, SSD.
After processing the data in the simulator, the results obtained can be viewed in Figure 4.

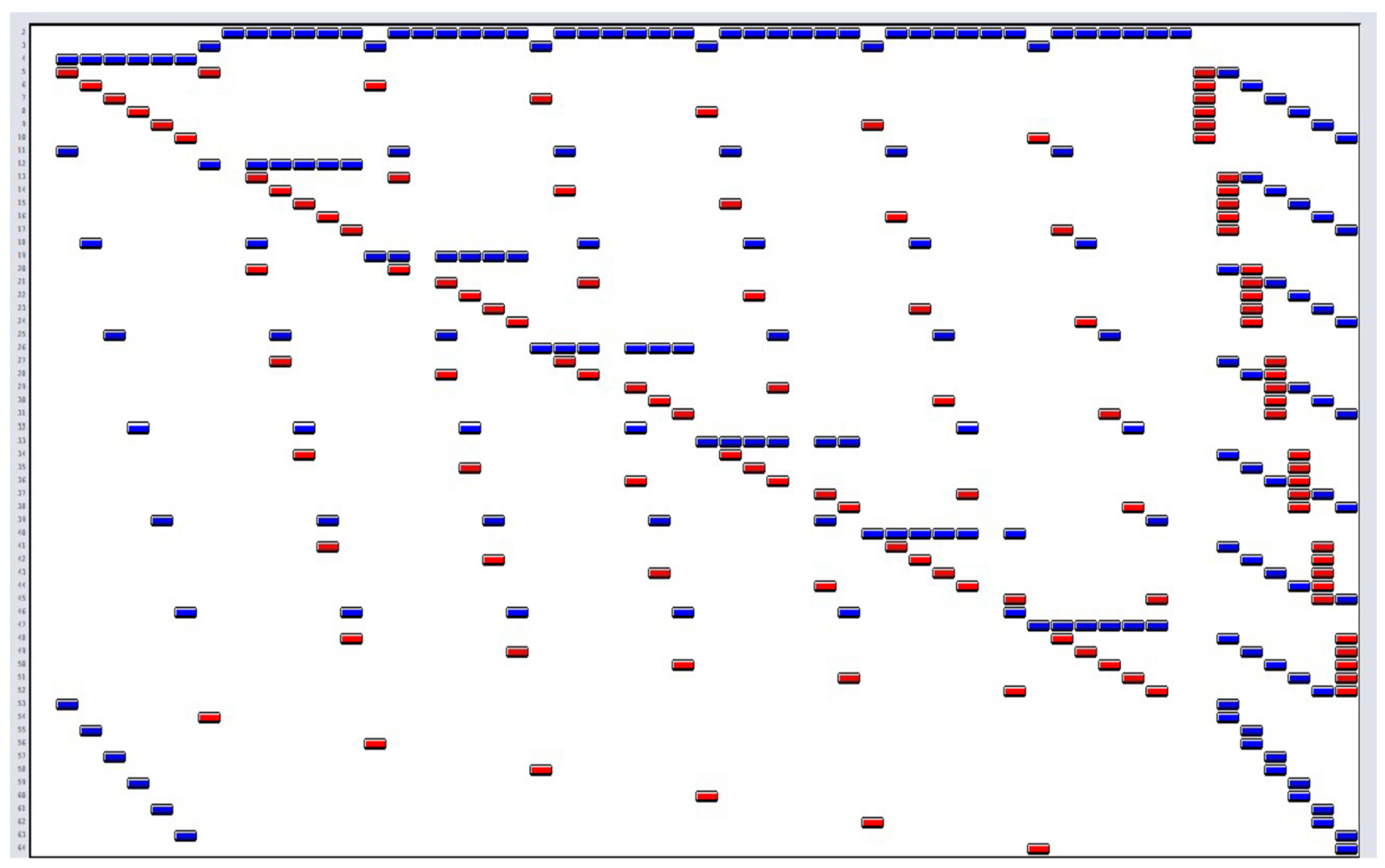

Figure 5 presented by the LINGO software [28], shows the fill-in of the matrix model composed of values in zeros and ones, varying only in the number of variables and constraints.
Considering that this is the application of the traveling salesman problem, there is a limitation of the problem considering that it is a large problem that may involve thousands of variables and restrictions. In this aspect, it is necessary to research the possibility of applying large scale decompositions, namely, Benders, Danzig–Wolfe or cross-decomposition decompositions, to the traveling salesman problem to obtain an exact solution. Other options are structured in hybrid methods [29].
For large models structured, considering the traveling salesman problem approach becomes necessary for other methodologies [30,31,32].

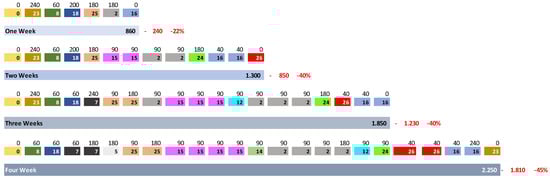

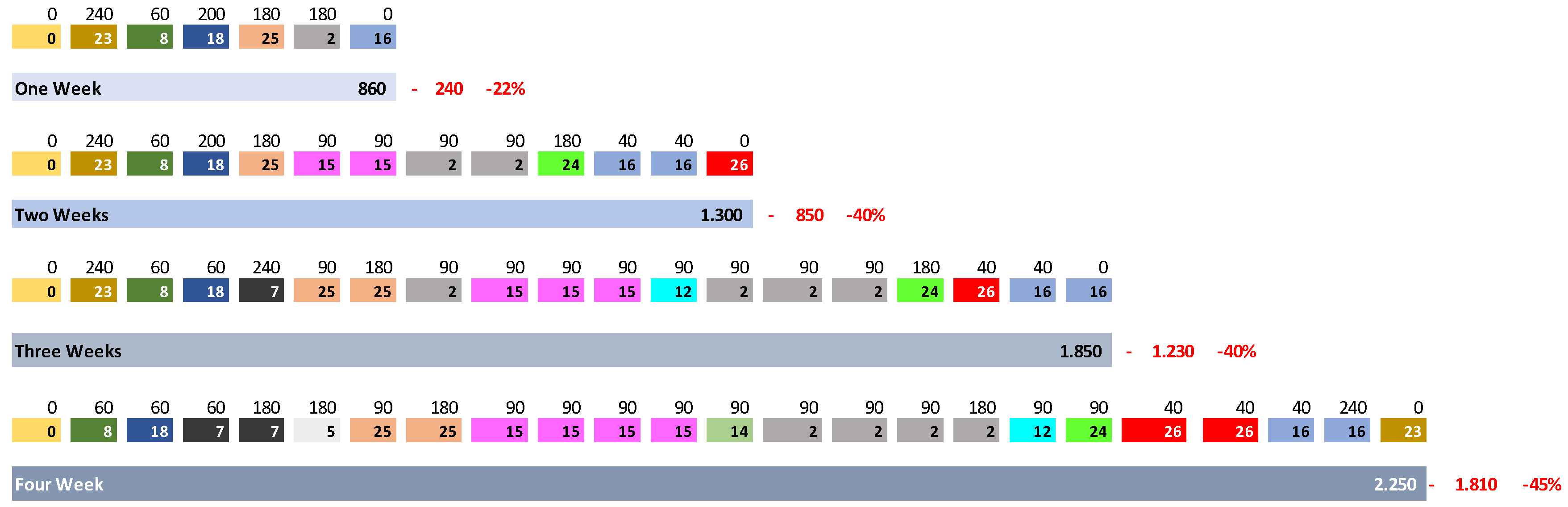

After measuring the setup times for all the suggested settings in four kind horizons, one week, two weeks, three weeks and four weeks, the SKU number referring to the whole horizon, we came to Table 6.
The collected data made it possible to analyze the correlation between the setup time variation with the parameters, machine group, SKU number, and programming horizon. The information obtained was submitted to estimate the linear correlation coefficients (r) using the Minitab 17 software.
The linear correlation coefficient, sometimes called Pearson’s product moment correlation coefficient, is represented by the letter r and takes values from −1 to 1 and measures the degree of the linear relationship between the paired values x and y in a sample. When r = 1, it represents the perfect and positive correlation between two variables, and for r = −1, it means a perfect negative correlation between two variables. That is, while one increases, the other decreases [33].
The Pearson’s correlation coefficient is calculated according to the following formula:
r = n x y ( x ) ( y ) n ( x 2 ) ( x ) 2 n ( y 2 ) ( y ) 2
where: n—represents the number of data pairs present; x, y—are the sample values you want to evaluate the correlation.
The analysis was performed separately for each machine group, and the correlation between % variation with the number of SKU and % variation with the programming horizon was evaluated. Absolute variation with SKU number and absolute variation with programming horizon.
Below in Table 7 are presented the results obtained for the two groups of machines.
It was chosen to study the correlation of both the relative variation and the absolute variation of setup times to assess possible divergences in the behaviour of the linear correlation coefficients. As it can be seen, there is a difference in the reading of information between the two situations.
Contrary to what was expected, the correlation of the number of SKUs with variation in setup time presented practically null correlation coefficients for both machine groups. That is, there is no correlation between the number of SKUs with variation in setup time. However, the planning horizon showed a strong negative correlation with the interpretation in setup time, with the value of r for slasher dye and loop dye group for the relative variation being −0.644 and −0.679, respectively. For the absolute deviation, it was −0.928 and −0.859, respectively. That is, the absolute variation presented a more substantial relationship degree with the planning horizon. The negative correlation shows that, as the planning horizon increases, the optimization system is more efficient is in reducing setup time. In a way, this result was already expected, as not only in dyeing sequencing, as in other areas, the more you can anticipate the needs, the better the resources are used.
Based on the results presented, we can propose a model based on linear regression that can predict the variation in setup time. However, such interpretation must refer to relative deviation, despite having presented a weaker degree of relationship when compared to absolute variation. It is not advisable to propose a model that indicates the possible absolute variation in setup time. This, when replicated in another operation with a similar process, will undoubtedly face different setup times between pairs of SKUs.
Therefore, we will describe the relationship through the straight-line equation representing the relationship between the variation in setup time with the planning horizon.
Given a collection of paired sample data, the simple regression equation describes the relationship between two variables.
Further, its representation is given by Equation (8):
y = b 0 + b 1 x
where: y—dependent variable or response variable; x—independent variable or predictor variable; b 0 —the y-intercept; b 1 —angular coefficient.
Applying the simple linear regression method to both machine groups, the following data are obtained, shown in Scheme 2:
Therefore, obtained the formulation can be tested in other companies.
Slasher dye:

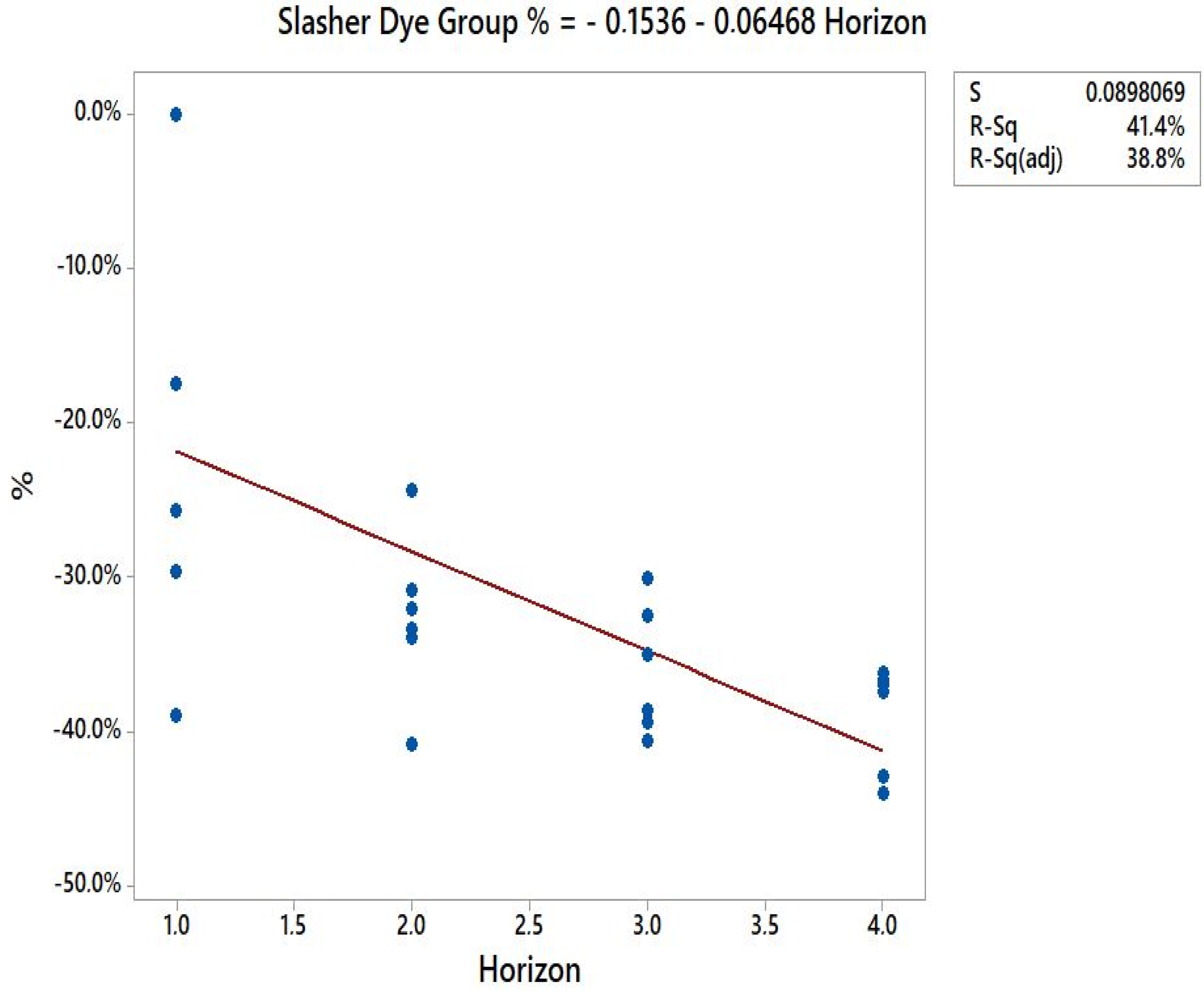

gain % = −0.1536 − 0.06468 × h
Loop dye:

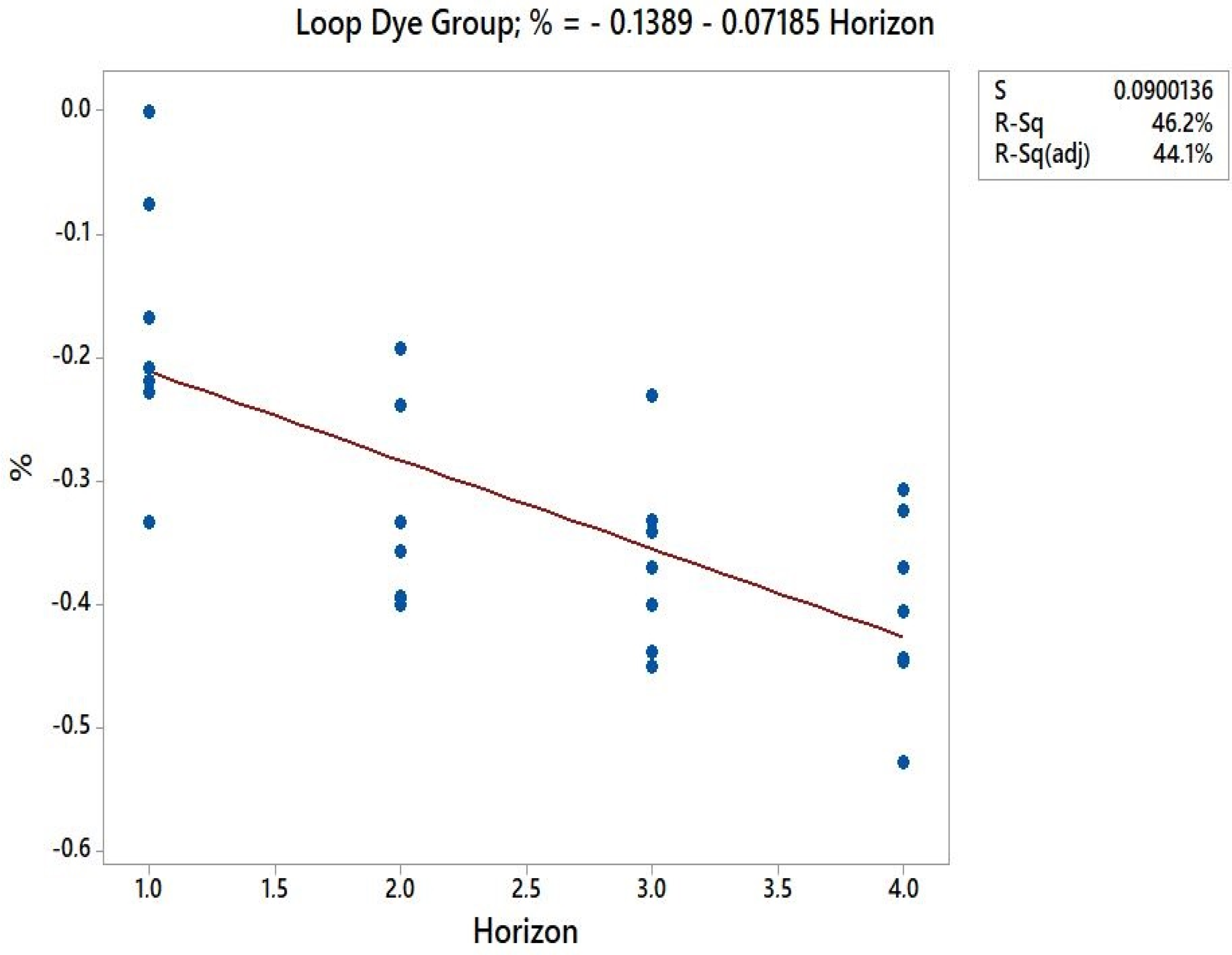

gain % = −0.1389 − 0.07185 × h
where: h—planning horizon.

5. Conclusions

The present work was limited to bringing science a formulation that can simulate the gain in setup time when comparing the model optimized by the TSP with the empirical model in companies with a similar process. In addition, to prepare the proposal, it was necessary to apply OR, specifically, PI, using the TSP as an approach.
The study brought to light that the influence of the SKU number is not related to the variation in setup time. However, the growth of this number can impact the batch size because the more SKUs is composing the portfolio, the smaller the batch sizes will be, and consequently, more setups will be needed.
The operation has a limitation regarding the dependence of the weaving sector on the dyeing sector. Therefore, to assure the supply of the weaving industry and avoid idleness, the dyeing sector must work in the function of the weaving industry. Therefore, the scheduling optimized proposed can be compromised. Another restriction that impacts the quality of the dyeing sequencing is the limited stock of intermediate rolls between dyeing and weaving, limiting the dyeing flexibility. Depending on the proposed optimized sequencing, there may be a disruption in the weaving supply. In addition to not coinciding with the need for the weaving sector, it may not have an intermediate roll stock that absorbs this mismatch, resulting in machine stoppage. In this way, the programmer will face the tradeoff between dye sequencing and weaving supply.
Moreover, to deal with this problem, it is proposed to discuss the decoupling point. According to [34], the decoupling end refers to the position within the supply chain, where the production flow changes from pushed to pulled, corresponding to the demand penetration point. It is the separation between what is produced for stock and what is produced to order. In this case, it is proposed to shift the decoupling point from the finished product stock (higher added value) to the intermediate stock between the dyeing and weaving sectors (lower added value), increasing the warp roll stock so that the sequencing dyeing does not compromise the supply of the weaving. Consequently, a working capital gain is expected due to the difference in the added value of the two inventories.
The objectives created to carry out this work were pursued. For future research, the study of a model that serves both the dyeing area and the weaving area is also necessary to assess the stock levels and deepen the study of the decoupling point.
It is expected that this work will arouse the interest of textile industries in the use of OR techniques to solve problems in the production process, using mathematical models and software for accurate simulations, allowing a broad view, and contributing to decision making [35].

Supplementary Materials

The following are available online at https://www.mdpi.com/article/10.3390/app11146467/s1, Table S1: Setup time matrix, Machine 7 belonged loop dye group—(minutes).

Author Contributions

Conceptualization, P.R.P. and U.T.G.; Data curation, U.T.G.; Formal analysis, U.T.G. and P.R.P.; Funding acquisition, U.T.G. and P.R.P.; Investigation, R.D.S. and U.T.G.; Methodology, R.D.S. and P.R.P.; Project administration, P.R.P. and U.T.G.; Resources, U.T.G. and R.D.S.; Software, P.R.P.; Supervision, P.R.P.; Validation, R.D.S.; Writing—original draft, U.T.G. and P.R.P. All authors have read and agreed to the published version of the manuscript.

Funding

This research was funded by the National Council for Scientific and Technological Development (CNPq), grant number 304272/2020-5.

Institutional Review Board Statement

Not applicable.

Informed Consent Statement

Not applicable.

Data Availability Statement

Data sharing not appropriate.

Acknowledgments

Plácido Rogério Pinheiro is grateful to the National Council for Scientific and Technological Development (CNPq) for developing this project.

Conflicts of Interest

The author declares no conflict of interest.

References

  1. Porter, M.E. The Five Competitive Forces That Shape Strategy. Harv. Bus. Rev. 2008, 86, 78. [Google Scholar] [PubMed]
  2. Jacson, R.H.F.; Jones, A.W.T. An Architecture for Decision Making in the Factory of the Future. Interfaces 1987, 17, 15–28. [Google Scholar] [CrossRef]
  3. Chiavenato, I. Gestão da Produção: Uma abordagem Introdutória, 3rd ed.; Manole: São Paulo, Brazil, 2017. [Google Scholar]
  4. ABIT. Perfil do Setor: Dados Gerais do Setor Referentes a 2018 (Updated in 2019). Available online: https://www.abit.org.br/cont/perfil-do-setor (accessed on 11 November 2020).
  5. Albin, A.M.; Gaudreault, J.; Quimper, C.G. Leverage constraint scheduling: A case study to the textile industry. In Integration of Constraint Programming, Artificial Intelligence, and Operational Research; Springer: Cham, Switzerland, 2020. [Google Scholar]
  6. Allahverdi, A.; Ng, C.T.; Cheng, T.C.E.; Kovalyov, M.Y. A survey of scheduling problems with setup times or costs. Eur. Oper. Res. 2008, 187, 985–1032. [Google Scholar] [CrossRef] [Green Version]
  7. Gendreau, M.; Laporte, G.; Guimarães, E.M. A divide and merge heuristic for the multiprocessor scheduling problem with sequence dependent setup times. Eur. J. Oper. Res. 2001, 133, 183–189. [Google Scholar] [CrossRef]
  8. Paul, R. Denim and jeans: An overview. Denim—Manufacture, Finishing and Applications. In Denim; Elsevier: Amsterdam, The Netherlands, 2015; pp. 1–11. [Google Scholar]
  9. IEMI. Brasil Têxtil: Relatório Setorial da Indústria Têxtil Brasileira; IEMI: São Paulo, Brazil, 2020; Volume 20. [Google Scholar]
  10. Zang, R. Sustainable Scheduling of Cloth Production Processes by Multi-Objective Genetic Algorithm with Tabu-Enhanced Local Search. Sustainability 2017, 9, 1754. [Google Scholar] [CrossRef] [Green Version]
  11. Lima, F.; Ferreira, P. Índigo: Tecnologias, Processos, Tingimento, Acabamento, 1st ed.; Artes Gráficas: Recife, Brazil, 2007. [Google Scholar]
  12. Li, S.; Cunninghan, A.B.; Fan, R.; Wang, Y. Identity blues: The ethnobotany of the indigo dyeing by Landian Yao (Iu Mien) in Yunnan, Southwest China. J. Ethnobiol. Ethnomedicine 2019, 15, 1–14. [Google Scholar] [CrossRef] [PubMed]
  13. Guimarães, L.; Klabjan, D.; Almada-Lobo, B. Modeling lot sizing and scheduling problems with sequence dependent setups. Eur. J. Oper. Res. 2014, 239, 644–662. [Google Scholar] [CrossRef]
  14. Lustosa, L.; Mesquita, M.A.; Oliveira, R.J. Planejamento e Controle da Produção; Elsevier: Rio de Janeiro, Brazil, 2008. [Google Scholar]
  15. Tubino, D.F. Planejamento e Controle da Produção: Teoria e Prática; Atlas: São Paulo, Brazil, 2007. [Google Scholar]
  16. Carvalho, R.M. Otimização Bi-Objetivo Para o Problema de Sequenciamento de Tarefas em um Máquina com Tempos de Preparação Dependente da Sequencia. Master’s Thesis, Electrical Engineering, Universidade Estadual de Campinas, Campinas, Brazil, 2002. [Google Scholar]
  17. Andrade, E.L. Introdução à Pesquisa Operacional: Métodos e Modelos Para Análise de Decisões, 5th ed.; LTC: Rio de Janeiro, Brazil, 2015. [Google Scholar]
  18. Belfiore, P.; Fávero, L.P. Pesquisa Operacional Para Cursos de Engenharia, 1st ed.; Elsevier: Rio de Janeiro, Brazil, 2013. [Google Scholar]
  19. Masutti, T.A.; Castro, L.N. A self-organizing neural network using ideas from the imune system to solve the traveling salesman problem. Inf. Sci. 2009, 179, 1454–1468. [Google Scholar] [CrossRef]
  20. Silva, G.A.N.; Silva, F.A.; Russi, D.T.A.; Pazoti, M.A.; Siscouto, R.A. Algoritmos heurísticos construtivos aplicados ao Problema do Caixeiro Viajante para a definição de rotas otimizadas. Colloq. Exactarum 2013, 5, 30–46. [Google Scholar] [CrossRef]
  21. Solem, O. Contribution to the solution of sequencing problems in the process industry. Int. J. Prod. Res. 1974, 12, 55–75. [Google Scholar] [CrossRef]
  22. Desrochers, M.; Laporte, G. Improvements and Extensions to the Miller-Tucker-Zemlin Subtour Elimination Constraints; Elsevier Science Publishers: Amsterdam, The Netherlands, 1991. [Google Scholar]
  23. Miller, C.; Tucker, A.; Zemlin, R. Integer programming formulations and travelling salesman problems. J. Assoc. Comput. Mach. 1960, 7, 326–329. [Google Scholar] [CrossRef]
  24. Lakatos, E.M.; Marconi, M.A. Fundamentos de Metodologia Científica, 3rd ed.; Atlas: São Paulo, Brazil, 1991. [Google Scholar]
  25. Shannon, R.E. Systems Simulation: The Art and Science; Prentice-Hall: Englewood Cliffs, NJ, USA, 1975. [Google Scholar]
  26. Castro, J.G. A Programação de Lotes Econômicos de Produção (ELSP) com Tempos e Custo de Setup Dependentes da Sequência: Um estudo de caso. Rev. Gestão Industrial. 2005, 1, 60–70. [Google Scholar] [CrossRef]
  27. Maxwell, W.L. The scheduling of economic lot sizes. Nav. Res. Logist. 1964, 11, 89–124. [Google Scholar] [CrossRef]
  28. Schrage, L. Optimization Modeling with LINGO; Lindo Systems: Chicago, IL, USA, 2010. [Google Scholar]
  29. Pinheiro, P.R.; Oliveira, P.R. A Hybrid Approach of Bundle and Benders Applied Large Mixed Linear Integer Problem. J. Appl. Math. 2013, 2013. [Google Scholar] [CrossRef]
  30. Junior, B.A.; Pinheiro, P.R.; Saraiva, R.D. A Hybrid Methodology for Nesting Irregular Shapes: Case Study on a Textile Industry. IFAC Proc. Vol. 2013, 46, 15–20. [Google Scholar] [CrossRef]
  31. Pureza, V.; Morabito, R.; Luna, H.P. Modeling and solving the travelling salesman problem with priority prizes. Pesqui. Oper. 2018, 38, 499–522. [Google Scholar] [CrossRef]
  32. Applegate, D.L.; Bixby, R.E.; Chvátal, V.; Cook, W.J. The Traveling Salesman Problem: A Computational Study; Princeton University Press: Princeton, NJ, USA, 2007. [Google Scholar]
  33. Triola, M.F. Introdução à Estatística, 7th ed.; LTC: Rio de Janeiro, Brazil, 1998. [Google Scholar]
  34. Mason-Jones, R.; Towill, D.R. Using the Information Decoupling Point to Improve Supply Chain Performance. Int. J. Logist. Manag. 1999, 10, 13–28. [Google Scholar] [CrossRef] [Green Version]
  35. Pinheiro, P.R.; Amaro Júnior, B.; Saraiva, R.D. A Random-Key Genetic Algorithm for Solving the Nesting Problem. Int. J. Comput. Integr. Manuf. 2016, 29, 1159–1165. [Google Scholar] [CrossRef]
Figure 1. Structure of the textile and apparel production and distribution chain.
Figure 1. Structure of the textile and apparel production and distribution chain.
Applsci 11 06467 g001
Figure 2. Hierarchical level of activities.
Figure 2. Hierarchical level of activities.
Applsci 11 06467 g002
Scheme 1. Frequency of the number of processed SKUs per month.
Scheme 1. Frequency of the number of processed SKUs per month.
Applsci 11 06467 sch001
Figure 3. Measurement of setup time–machine seven from loop dye group, 13 SKU.
Figure 3. Measurement of setup time–machine seven from loop dye group, 13 SKU.
Applsci 11 06467 g003
Figure 4. Optimized result for Machine 7, from the loop dye group, 13 SKUs.
Figure 4. Optimized result for Machine 7, from the loop dye group, 13 SKUs.
Applsci 11 06467 g004
Figure 5. Fill-in approach to the model matrix.
Figure 5. Fill-in approach to the model matrix.
Applsci 11 06467 g005
Scheme 2. Simple Linear Regression.
Scheme 2. Simple Linear Regression.
Applsci 11 06467 sch002aApplsci 11 06467 sch002b
Table 1. Number of processed SKU.
Table 1. Number of processed SKU.
Batch NumberSKU NumberBatch NumberSKU NumberBatch NumberSKU Number
Machine 1Machine 3Machine 4
Slasher DyeFebruary/182613215218
March/18219186248
April/18307226196
May/182912247239
June/18148144158
July/18219256219
August/182914246259
September/182812225208
October/18216185186
November/182492142311
Machine 6Machine 7Machine 8
Loop DyeFebruary/182282619206
March/1819523102412
April/182253014259
May/1824725112411
June/1813514111510
July/1825528162712
August/182582313199
September/182272511229
October/1820621111710
November/1822625132111
Table 2. SKU numbers were chosen to test.
Table 2. SKU numbers were chosen to test.
Machine GroupMachineSKU Number
Slasher Dye16
9
12
34
6
48
Loop Dye65
7
711
13
16
89
12
Table 3. Setup time matrix for one and two weeks, Machine 7, 13 SKUs.
Table 3. Setup time matrix for one and two weeks, Machine 7, 13 SKUs.
One-Week:
SKU Code 02316822518
Batch Code1234567
010000000
232060240240240240240
163024040240180200240
8402402409024024060
25024018024090180240
256024020024018090200
187024024018024020060
Two-week:
SKU Code 0231682251815216242615
Batch Code12345678910111213
010000000000000
232060240240240240240240240240240240240
1630240402401802002401801804018040180
8402402409024024060240240240240240240
2502401802409018024090901809018090
256024020024018090200180180200180200180
187024024018024020060240240240240240240
15802401802409018024090901809018090
2902401802409018024090901809018090
16100240402401802002401801804018040180
241102401802409018024090901806018090
26120240402401802002401801804018040180
151302401802409018024090901809018090
Table 4. Setup time matrix for three weeks, Machine 7, 13 SKUs.
Table 4. Setup time matrix for three weeks, Machine 7, 13 SKUs.
Three weeks:
SKU Code 0231682251815216242615212715225
Batch Code12345678910111213141516171819
010000000000000000000
232060240240240240240240240240240240240240240240240240240
1630240402401802002401801804018040180180180240180180200
8402402409024024060240240240240240240240240180240240240
250240180240901802409090180901809090902409090180
25602402002401809020018018020018020018018018024018018090
18702402401802402006024024024024024024024024060240240200
1580240180240901802409090180901809090902409090180
290240180240901802409090180901809090902409090180
16100240402401802002401801804018040180180180240180180200
24110240180240901802409090180601809090902409090180
26120240402401802002401801804018040180180180240180180200
15130240180240901802409090180901809090902409090180
2140240180240901802409090180901809090902409090180
12150240180240901802409090180901809090902409090180
71602402401802402406024024024024024024024024060240240240
15170240180240901802409090180901809090902409090180
2180240180240901802409090180901809090902409090180
251902402002401809020018018020018020018018018024018018090
Table 5. Setup time matrix for three weeks, Machine 7, 13 SKUs.
Table 5. Setup time matrix for three weeks, Machine 7, 13 SKUs.
Four weeks:
SKU Code 02316822518152162426152127152251452615
Batch Code1234567891011121314151617181920222324
0100000000000000000000000
232060240240240240240240240240240240240240240240240240240240240240240
163024040240180200240180180401804018018018024018018020018020040180
8402402409024024060240240240240240240240240180240240240240180240240
2502401802409018024090901809018090909024090901809018018090
25602402002401809020018018020018020018018018024018018090180180200180
18702402401802402006024024024024024024024024060240240200240180240240
15802401802409018024090901809018090909024090901809018018090
2902401802409018024090901809018090909024090901809018018090
1610024040240180200240180180401804018018018024018018020018020040180
241102401802409018024090901806018090909024090901809018018090
2612024040240180200240180180401804018018018024018018020018020040180
151302401802409018024090901809018090909024090901809018018090
21402401802409018024090901809018090909024090901809018018090
121502401802409018024090901809018090909024090901809018018090
71602402401802402406024024024024024024024024060240240240240180240240
151702401802409018024090901809018090909024090901809018018090
21802401802409018024090901809018090909024090901809018018090
251902402002401809020018018020018020018018018024018018090180180200180
142002401802409018024090901809018090909024090901809018018090
72102402401802402406024024024024024024024024060240240240240180240240
522024020018018018018018018020018020018018018018018018018018090200180
2623024040240180200240180180401804018018018024018018020018020040180
152402401802409018024090901809018090909024090901809018018090
Table 6. Results of slasher dye and loop dye group, accurate and optimized setup times.
Table 6. Results of slasher dye and loop dye group, accurate and optimized setup times.
MachineMachineSKU 1 Week2 Weeks3 Weeks4 Weeks
Group Number RealOptmizedVaryRealOptmizedVaryRealOptmizedVaryRealOptmizedVary
Slasher Die1 6 Time (minutes)810 570 −240 1560 1080 −480 2490 1530 −960 3360 2130 −1230
Vary (%) −30% −31% −39% −37%
9 Time (minutes)1080 660 −420 1680 1110 −570 2310 1560 −750 3430 2190 −1240
Vary (%) −39% −34% −32% −36%
12 Time (minutes)1170 870 −300 2220 1680 −540 3300 2310 −990 4680 2950 −1730
Vary (%) −26% −24% −30% −37%
3 4 Time (minutes)740 740 0 1750 1190 −560 2760 1640 −1120 3660 2090 −1570
Vary (%) 0% −32% −41% −43%
6 Time (minutes)860 710 −150 2110 1250 −860 3250 1970 −1280 4390 2460 −1930
Vary (%) −17% −41% −39% −44%
4 8 Time (minutes)450 450 0 1530 1020 −510 2400 1560 −840 3260 2040 −1220
Vary (%) 0% −33% −35% −37%
Loop Dye6 5 Time (minutes)510 510 0 1260 960 −300 1950 1500 −450 2940 2040 −900
Vary (%) 0% −24% −23% −31%
7 Time (minutes)900 750 −150 1800 1200 −600 2640 1740 −900 3240 2190 −1050
Vary (%) −17% −33% −34% −32%
7 11 Time (minutes)1110 740 −370 2010 1220 −790 3030 1910 −1120 3780 2250 −1530
Vary (%) −33% −39% −37% −40%
13 Time (minutes)1100 860 −240 2150 1300 −850 3080 1850 −1230 4060 2250 −1810
Vary (%) −22% −40% −40% −45%
16 Time (minutes)860 710 −150 2110 1250 −860 3250 1970 −1280 4390 2460 −1930
Vary (%) −17% −41% −39% −44%
8 9 Time (minutes)660 510 −150 1770 1140 −630 3150 1770 −1380 4550 2150 −2400
Vary (%) −23% −36% −44% −53%
12 Time (minutes)1170 870 −300 2220 1680 −540 3300 2310 −990 4680 2950 −1730
Vary (%) −26% −24% −30% −37%
Table 7. Linear Correlation Coefficient.
Table 7. Linear Correlation Coefficient.
Slasher DyeCoefficient% VaryAbsolute Vary
SKU Numberr0.0410.009
p-value0.8480.966
Planning Horizonr−0.644−0.928
p-value0.0010.000

Loop DyeCoefficient% VaryAbsolute Vary
SKU Numberr−0.171−0.173
p-value0.3860.377
Planning Horizonr−0.679−0.859
p-value0.0000.000
Publisher’s Note: MDPI stays neutral with regard to jurisdictional claims in published maps and institutional affiliations.

Share and Cite

MDPI and ACS Style

Gomes, U.T.; Pinheiro, P.R.; Saraiva, R.D. Dye Schedule Optimization: A Case Study in a Textile Industry. Appl. Sci. 2021, 11, 6467. https://doi.org/10.3390/app11146467

AMA Style

Gomes UT, Pinheiro PR, Saraiva RD. Dye Schedule Optimization: A Case Study in a Textile Industry. Applied Sciences. 2021; 11(14):6467. https://doi.org/10.3390/app11146467

Chicago/Turabian Style

Gomes, Uiraquitan Tadeu, Plácido Rogério Pinheiro, and Rommel Dias Saraiva. 2021. "Dye Schedule Optimization: A Case Study in a Textile Industry" Applied Sciences 11, no. 14: 6467. https://doi.org/10.3390/app11146467

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
