1. Introduction
Conventional industrial robots work in a safety fence, and their work trajectory is usually preset through a program. In recent years, with the concept of human–robot collaboration, robots have gradually stepped out of the safety fence, which has made the working environment of robots more complicated and unpredictable, and offline programming would not be able to meet such work requirements.
LfD can quickly transfer human skills to robots through human–computer interaction and teaching methods, to realize the rapid programming of robots [
1]. However, the teaching scene and the recurring scene are usually not completely consistent while repeating the task. At present, most path planning algorithms are aimed at the point-to-point path planning problem, that is, when encountering obstacles, the information of the whole workspace is obtained first, and then, a feasible path from the starting point to the target point is planned. However, the path planning problem of task recurrence in the process of LfD is not a point-to-point path planning problem, but a problem of tracking a task trajectory while avoiding obstacles. Meanwhile, not only industrial robots, but also other platforms, such as parallel robot platforms, require path planning. Russo presented the mechanical design of a humanoid robot named LARMbot 2. The torso of LARMbot 2 can be described as a 4SPS-(3E) parallel mechanism with four degrees of freedom, and the legs of LARMbot 2 are structured by a 3UPR lower-mobility parallel mechanism. The parallel architectures on which the robot is based allowed it to lift a considerable payload [
2]. Ceccarelli presented the results of HeritageBot. The novel aspect of the HeritageBot robot is that it was designed with a modular structure. The HeritageBot robot can be recognized in the modular design by combining a legged parallel manipulator locomotor with a drone with a short flight capability, which allows the robot to have greater potential in cultural heritage services [
3]. The dynamic control of both LARMbot 2 and the HeritageBot robot requires path planning.
The path planning algorithm usually models the free configuration space through random sampling and collision detection and then generates an effective collision-free path in the sampled free configuration space. The most famous sampling-based planning algorithms are PRM [
4] and RRT [
5], which use roadmaps and tree structures to model the free space, respectively [
6]. In addition, in order to extend the capabilities of these algorithms, many variants have been proposed, such as LazyPRM [
7], EST [
8], SBL [
9], RRT-Connect [
10], NC-RR [
11], and KPIEC [
12]. Due to the inherent characteristics of random sampling, these algorithms have some common problems, such as the low efficiency of narrow channel search and the optimal probability of the searched path [
13].
In recent years, researchers have proposed many sampling planning algorithms based on optimization, such as TRRT [
14], RRT* [
15], and BIT* [
16]. Although some optimization goals or constraints can be achieved gradually, such as minimizing the length of the path, the computational cost of these optimization planners is relatively expensive. Aiming at the problem that the constrained optimal feedback controllers require extensive calculation, Chen presented two locally optimal feedback controllers that can be efficiently computed online in real time. The controllers use an iterative algorithm to numerically compute the constrained optimal feed-forward control input, so the computation of the inputs can be performed in real time [
17]. However, this controller can better mitigate external perturbations and imperfect model information. In addition, the optimization objective of some problems may be difficult to describe as a specific mathematical function. For example, the motion generated by a humanoid robot is an optimization objective that is difficult to describe by mathematical function [
18]. With the popularity of reinforcement learning, people began to study path planning based on reinforcement learning. Shahid used the modern proximal policy optimization algorithm to learn a grasping task [
19]. However, the path planning algorithm based on reinforcement learning requires much training time, so it cannot realize online path planning.
In addition, path planning algorithms based on sampling always start planning from the beginning, while the LfD method aims to generate task trajectories from human teaching paths. LfD uses demonstration paths to simulate the free space and optimize the objectives. The most famous one is the DMPS method. Generally, the reference trajectory of DMPS can be obtained from the suboptimal teaching path with noise by the GMM/GMR or reinforcement learning method [
20]. Roveda presented a task-trajectory learning algorithm based on a few human demonstrations, and the demonstrated data were processed by a hidden Markov model approach. A Bayesian optimization-based algorithm has designed to autonomously optimize the robot control parameters. The proposed HMM algorithm can select the most reliable demonstrated task trajectory [
21]. However, the HMM algorithm cannot deal with the inconsistency of the working environment between task demonstration and task reproduction.
Aiming at the problem of the LfD method not being able to deal with new obstacles in the environment, many scholars have made efforts to solve such problems. Rai used the coupling terms in DMPS to solve path planning problems, and the coupling term can allow avoiding obstacles of different sizes in a reactive manner after learning from human demonstrations [
22]. By estimating an unknown reward function from the demonstration and using the quasi-Newton strategy to learn the parameters of the reward function, Amir realized the path planning [
23]. However, these algorithms are generally based on nonlinear optimization, which may fall into local minima.
In order to use the prior knowledge of LfD, Jiang and Kallmann proposed a method called the Attractor-Guided Planner (AGP), wherein each attractor point works as a replacement of the random sampling strategy in the original RRT. The results showed that the AGP planner is well suited for dynamic tasks in dynamic environments [
24]. Rosell used Principal Component Analysis (PCA) to increase the probability of finding collision-free samples in a space with low clearance [
25]. García used the PCA algorithm to find the joint synergy of different areas in the configuration space according to the demonstration and used the joint synergy to determine the expansion of the tree based on the basic RRT [
26]. Mike presented a search-based planning method with experience graphs. The experience graphs can be generated in the configuration space by searching the search-space, and an effective path can be generated by searching the experience graphs with the weighted A-star algorithm [
27,
28].
Although traditional motion planning algorithms have certain adaptive capabilities, they can only find a feasible path from the starting point to the target point. For complex tasks, they cannot guarantee that the planned path will pass through all key points, and the cost of designing a specific loss function for each task is high. Although LfD does not require defining the loss function manually, it cannot demonstrate all the possibilities of a task, so the adaptability is poor.

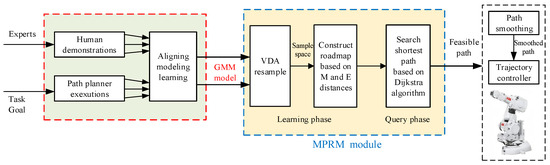

Therefore, this paper proposes a path planning algorithm called the GMM/GMR-MPRM. The algorithm combines the advantages of the LfD algorithm and the motion planning to realize the path planning algorithm and uses the feasible space of the task trajectory obtained by the LfD as the sampling space of the MPRM algorithm. The algorithm can improve the success rate of path planning and maintain the similarity of the original task trajectory simultaneously. The main contributions of this paper are:
Aiming at the inconsistency between the recurrent scene and the teaching scene in LfD, a path planning algorithm with certain adaptive capabilities and an obstacle avoidance capability is proposed. When the obstacles are detected, only the part of the path that collides with the obstacle is modified, and the rest of the path remains unchanged, then a path that can avoid the obstacles can be generated;
The sampling space is constructed by means of variable density resampling, and more sampling points are generated in the Gaussian component close to the obstacle, which improves the resampling speed and the success rate of path planning;
Euclidean and probability distance are used to construct the roadmap, so that the resampling points closer to the task trajectory have higher importance, so as to ensure that the searched path has a high similarity to the task path.
The rest of this paper is organized into five sections.
Section 2 addresses the related work of the GMM/GMR-MPRM.
Section 3 describes the construction and the details of the implementation of the GMM/GMR module.
Section 4 describes the construction and the details of the implementation of the MPRM module.
Section 5 shows the simulations and the experiments.
Section 6 gives some conclusions of the research.
3. GMM/GMR Module
The GMM/GMR module is used to generate the sampling space based on the teaching data.

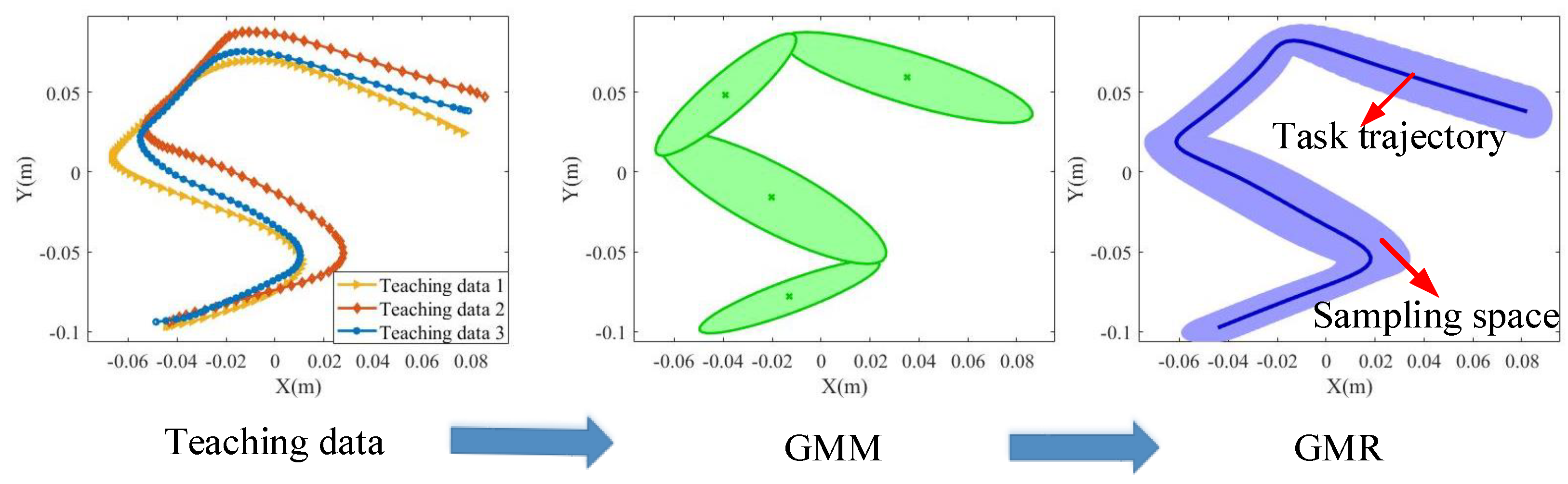

Figure 2 gives the flowchart for generating the sampling space based on the GMM/GMR algorithm. First, according to the teaching path data, the GMM algorithm is used to obtain the Gaussian conditional distribution of the data of the teaching path, and then, the GMR algorithm is used to generate the task path and sampling space.
Usually, the dataset of the teaching path consists of
N teaching paths, so it can be represented by
, where
is one-time teaching path data. The teaching trajectory data are a sequence of random variables that obey the multivariate normal distribution. The GMM of the teaching data can be expressed as:
where
stands for the coefficient of the
Gaussian component and
,
,
stands for the distribution density of the
Gaussian component of dimensionality
D, which can be defined as:
where
,
, and
stand for the mean and variance of the
Gaussian component, respectively, and
can be expressed as:
The parameters of the GMM are solved using the EM algorithm. The solution steps are as follows: Firstly, the k-means clustering algorithm is used to obtain the initial estimated value of the EM algorithm to prevent the solution from falling into the local minima; secondly, the GMM infinitely approaches the optimal solution through the iteration of the E steps and M steps; finally, the parameters of the GMM that meet the requirements are obtained.
After using the GMM to obtain the distribution of the teaching trajectory, the GMR algorithm is used for regression to obtain a continuous path, and the path contains the mean and the covariance of each point on the path. Using time series as the index variables, the corresponding space vector is:
For a GMM
, the GMM is transformed into a continuous model by varying
t, according to the linear transformation properties of the Gaussian distribution, that is:
where,
For the totality component, the expected distribution is:
where
is the prior probability of each component and can be expressed as:
For the
component, the mean and covariance matrices of each time point can be computed as:
Then, a continuous trajectory can be generalized by calculating . The feasible space of the trajectory is used as the sampling space of the MPRM algorithm.
4. MPRM Module
The MPRM module consists of two parts: the construction part and the query part. In the construction part, by randomly sampling nodes in the free space and connecting them with each other, a roadmap can be constructed. In the query part, a path from the start location to the target location can be queried on the roadmap with the Dijkstra search algorithm. The conventional PRM methods uses a grid map in 2D space or a voxel map in 3D space to describe the roadmap. The roadmap covers the whole workspace, and once the environment changes, the roadmap has to be reconstructed. The MPRM module is used to generate robot motion from a given roadmap and the target location without a priori knowledge. However, in this paper, the GMM/GMR model already encoded the ideal robot motion. Therefore, it was able to combine these two methods and exploit their advantages so as to meet the online adaptive requirements.
4.1. Collision Detection and Path Segmentation
Before resampling, it is necessary to divide the path into a collision path and a noncollision path, that is to separate the collision path from the path and record the start and end points of the collision path.
In order to divide the path, it is necessary to calculate the Euclidean distance from the points on the path to the obstacle surface and then select the smallest Euclidean distance to compare with the threshold , where , stands for the radius of the obstacle, and stands for the radius of the manipulator of the robot. If , the point is considered to collide with the obstacle. The first collision point is recorded as the starting point of the collision path, then whether the next point is a collision point is determined, until the next point is a noncollision point, and the point is recorded as the end point of the collision path. Repeat the iteration until the last point on the path. The iterative process of the path segmentation algorithm is shown in Algorithm 1.
Algorithm 1 Path segmentation algorithm. |
Input: Task trajectory Output: The Startpoints and Endpoints of the collision path
1: Startpoints=[]; Endpoints=[]; StartFlag=False; EndFlag=False;
2: ; ;
3: while do
4: ;
5: if then
6: if Startflag==False then
7: Startflag=True; Startpoints(j)=i; ;
8: end if
9: else
10: if Startflag==True then
11: Startflag=False; Endpoints(j)=i;
12: end if
13: end if
14: end while
|
4.2. Variable Density Resampling
Each point on the task path obtained by the GMM/GMR algorithm has a mean and a covariance. The mean value is represented by
, and the covariance is represented by
. This paper used the
function in MATLAB to generate the sampling space. The function can generate a dataset that conforms to the multivariate Gaussian distribution. Therefore, resampling the
point on the path based on the Gaussian distribution can be expressed as:
where
is the resampled dataset of the
point,
is the sample quantity of resampling, and
is the resampled dataset with a sample quantity of
.
If the sample quantity of resampling for each Gaussian component on the task path is the same, then there will be a large number of resampling points near the obstacle when the Gaussian component close to the obstacle is resampled, which reduces the success rate of path planning. In addition, the covariance of the Gaussian component also has an impact on the quantity of resampling, that is the Gaussian component with a smaller covariance has higher importance, and the quantity of resampling for this component should be increased, while the Gaussian component with a larger covariance has lower importance, and the quantity of resampling for this component should be reduced.
Therefore, a variable density resampling method is proposed, that is the Gaussian component that is closer to the obstacle generates more sampling points, and the Gaussian component that is farther from the obstacle generates fewer sampling points. The Gaussian component with a small covariance generates more sampling points, and the Gaussian component with a high covariance generates fewer sampling points. This can not only increase the sampling speed and the success rate of path planning, but also improve the consistency of the planned path and the task path. The quantity of resampling
can be defined as:
where
is the shortest distance between the
Gaussian component and the obstacle,
is the threshold of the distance,
is the covariance of the
Gaussian component, and
and
are the reference quantity of resampling based on the covariance and distance, respectively. Since there is no collision detection during resampling, some sampling points will fall into the position of obstacles. If the roadmap is constructed directly in this sampling space, the number of collision detections and invalid queries will increase. Therefore, it is necessary to recalculate the minimum distance
between the sampling point and the obstacle surface. If
, the point is considered as the collision point and removed; otherwise, the point is retained.
4.3. Euclidean and Probability Distance
In the traditional PRM algorithm, the distance between two points is usually defined by the Euclidean distance between two points. The PRM algorithm adopted in this paper ensures that the shortest feasible path can be found, and it tries to ensure the similarity with the original trajectory. Therefore, this paper redefined the distance between two points as the weighted sum of the Euclidean distance and the probability distance, that is:
where
represents the Euclidean distance between two points.
is the coefficient with the value range of
, used to balance the length of the planned path and the similarity with the task path, that is the larger
is, the greater the similarity with the task path; the smaller
is, the shorter the length of the planned path;
represents the distance generated by the probability density.
The higher the probability density of the point is, the closer to the task path. Therefore, the probability distance
is defined as the following form:
where
,
D is the dimension of the variable
x,
is the mean value, and
is the covariance matrix.
Finally, according to the weighted distance , construct a locally weighted roadmap for each collision path, where is the edge and is the vertex.
4.4. Path Search Based on the Dijkstra Algorithm
The Dijkstra algorithm is one of the most famous algorithms for searching the shortest path. It uses the breadth-first search to solve the single-source shortest path problem of a weighted directed graph or an undirected graph. Given the roadmap , the starting vertex , and the target vertex , the shortest path from the starting point to the target point can be searched. Since the similarity with the task path is taken into account when constructing the roadmap, the algorithm follows the two principles of the shortest path and the highest similarity.
4.5. Path Pruning Based on the Shortcut Algorithm
The Shortcut path pruning process is shown in

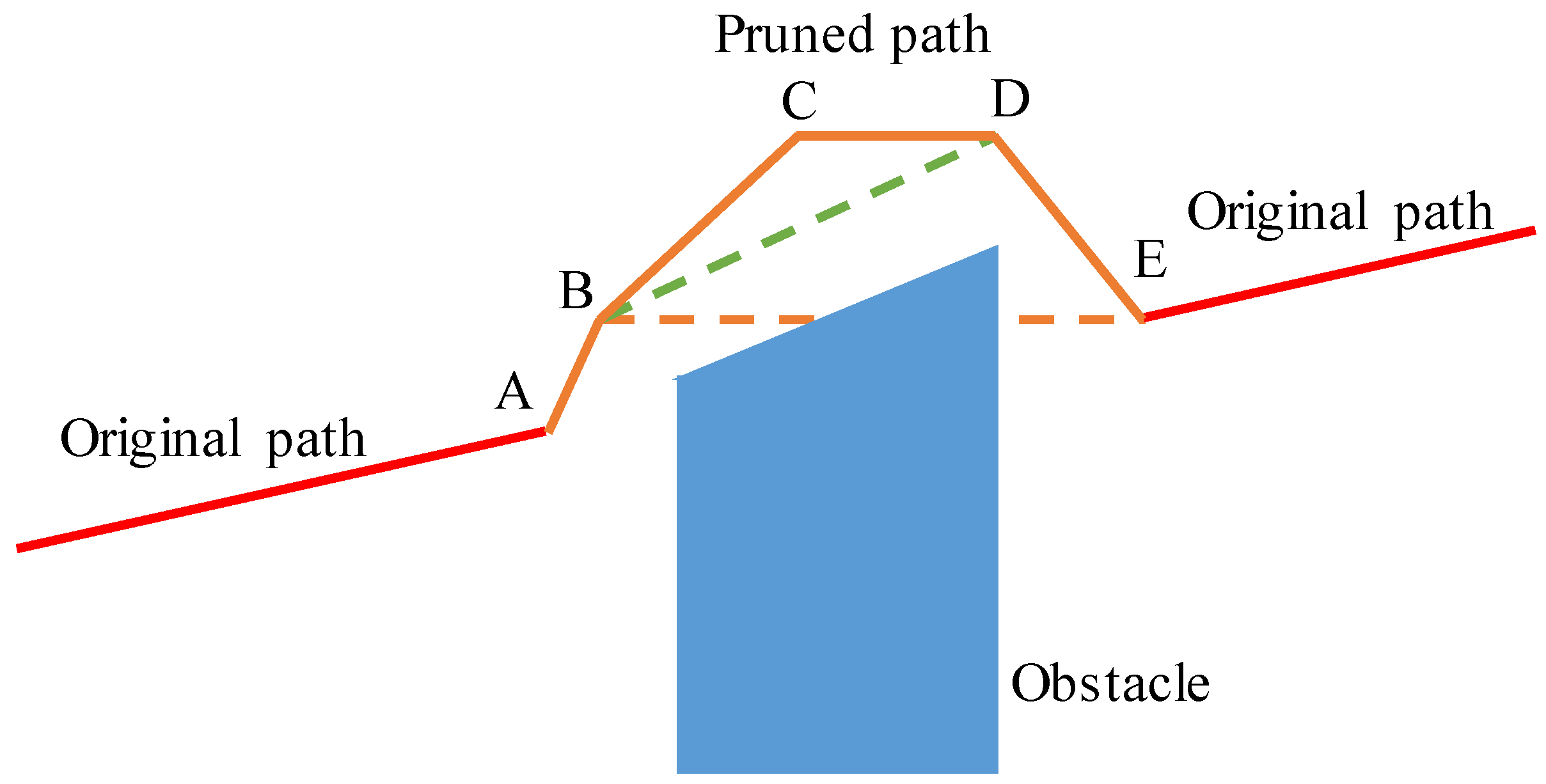

Figure 3, assuming that the planned path is composed of Points A, B, C, D, and E. Although the trajectory can avoid the obstacle, it can be further simplified. For example, Point B can be directly connected to Point D, then Point C can be removed. However, when Point B and Point E are connected, they will collide with an obstacle, then Point D cannot be removed. The pruning algorithm is shown in Algorithm 2.
Algorithm 2 Shortcut path pruning algorithm. |
Input: Path to be pruned path1 Output: Path after pruning path2
1:
2: ;
3:while do
4: for do
5: if then
6: ;
7: ;
8: break
9: end if
10: end for
11: end while |
4.6. B-Spline Trajectory Smoothing

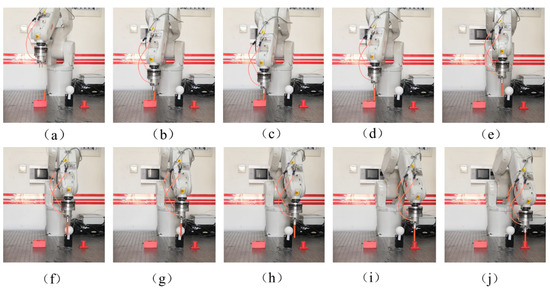

After shortening the length of the path by using the Shortcut algorithm, B-spline interpolation is used to smooth the pruned path. At the same time, in order to ensure the continuous speed of the connection, the speed boundary condition is set. The B-spline curve is essentially a set of piecewise continuous polynomials, and complex curves can be described by low-order polynomials. The B-spline curve can be represented by:
where
is the B-spline basis function,
is the control vertex, and
p is the order of the polynomial. The value of
u is defined by the node vector:
Take
, and use the Cox–de Boor recursion formula for the basis function of the B-spline; the recursion formula can be given by:
The shape of the B-spline curve is determined by the node vector and the control vertices. There are various parameterization methods to parameterize the node vector, such as uniform parameterization, chord length parameterization, and centripetal parameterization. Centripetal parameterization can obtain a smoother curve; therefore, this paper adopted this parameterization method:
where
,
and
are the points to be interpolated.
For the cubic B-spline curve, when performing the interpolation calculation, there is:
This formula can be expressed in the form of the matrix equation:-4.6cm0cm
For the cubic B-spline curve, the first and last nodes in the node vector are quadruple nodes, and this causes the first (end) vertex to be the same as the first (end) data point. After removing the first and last two equations of the above formula, the matrix equation can be expressed as:
Add two boundary conditions and simplify; the matrix equation can be expressed as:
where,
The velocity boundary conditions are:
Therefore, given the boundary velocities and , an interpolated B-spline curve with a continuous velocity can be obtained.
