Performance Analysis and Assessment of BIM-Based Construction Support with Priority Queuing Policy
Abstract
:1. Introduction

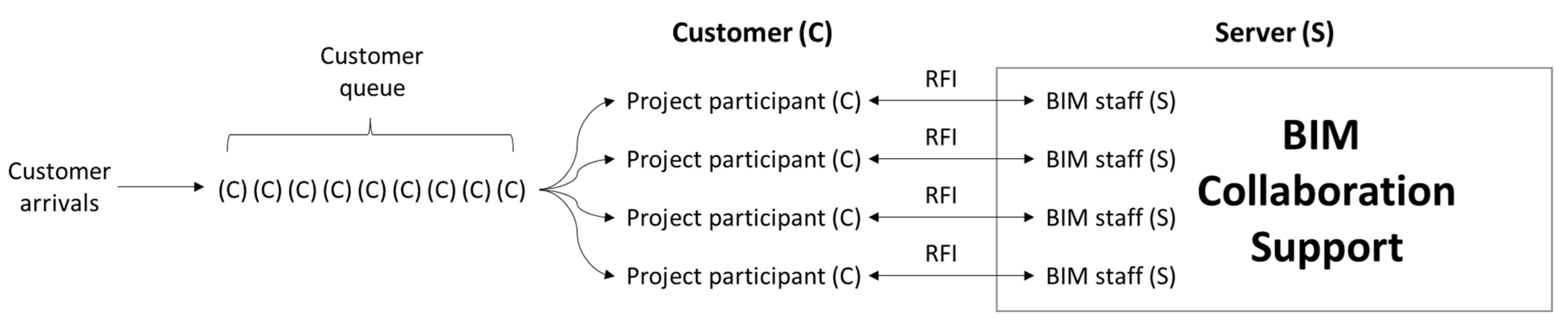

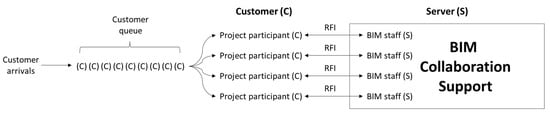

- Customer: Reflection of the properties (randomness) of BIM RFIs in the construction phase.
- Server: Reflection of the competencies (randomness) of BIM staff in the construction phase.
- Priority: Reflection of the priorities for each purpose of RFI by the project manager.
- Performance indicators: Presentation of micro-level BIM performance indicators.
2. Literature Review
2.1. Performance Analysis and Assessment of BIM-Based Construction Projects
2.2. Properties of Request for Information in BIM-Based Construction Support
2.3. Queuing Model
3. Problem Statements in BIM-Based Construction Support
4. Research Method
4.1. M/M/s Queuing Model with Priority
- The inter-arrival times are distributed independently and equally, depending on the probability distribution.
- All arriving customers enter the queue system and stay there until service is complete.
- The queuing system has one infinite queue. Thus, it can accommodate an infinite number of customers.
- The queuing rule is first come, first served (FCFS).
- There is a fixed number of servers in the queuing system, and each server can serve any customer.
- Each customer is served individually by one server.
- Service times are distributed independently and identically according to the specified probability distribution.
4.2. Performance Indicators of M/M/s Queuing Model
- : No. of tasks in the system
- : No. of tasks in the queue
- : Average waiting time of each customer in the system
- : Average waiting time of each customer in the queue
4.3. Performance Indicators of M/M/s Queuing Model with Priority
5. Case Study

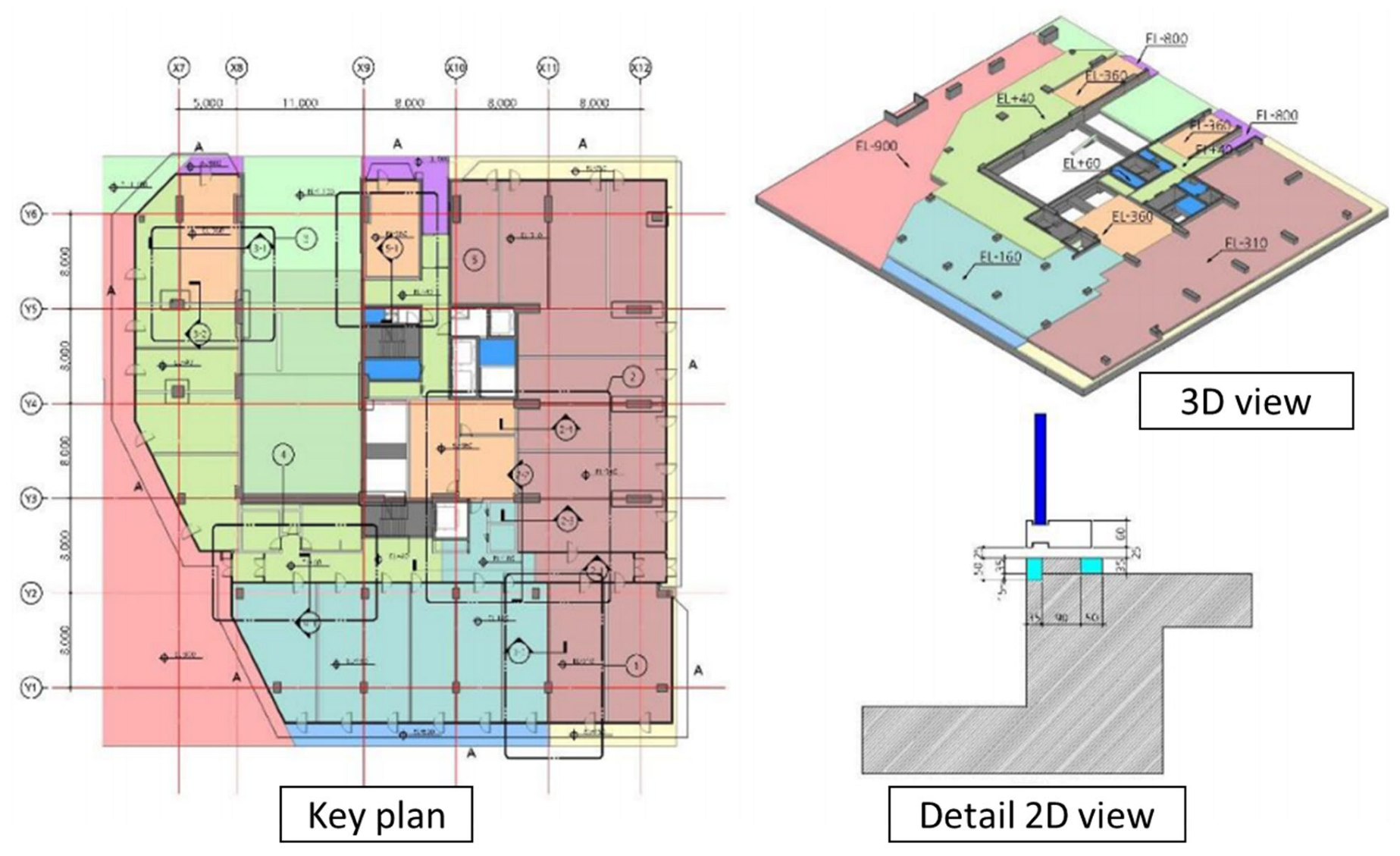

5.1. Project Description and Data Collection
5.2. Data Analysis
6. Discussion and Conclusions
Author Contributions
Funding
Conflicts of Interest
References
- Sacks, R.; Eastman, C.; Lee, G.; Teicholz, P. BIM Handbook: A Guide to Building Information Modeling for Owners, Designers, Engineers, Contractors, and Facility Managers; John Wiley & Sons: Hoboken, NJ, USA, 2018. [Google Scholar]
- Shen, F.Y.; Chang, A.S. Exploring coordination goals of construction projects. J. Manag. Eng. 2011, 27, 90–96. [Google Scholar] [CrossRef]
- De Saram, D.D.; Ahmed, S.M.; Anson, M. Suitability of the critical incident technique to measure quality of construction coordination. J. Manag. Eng. 2004, 20, 97–109. [Google Scholar] [CrossRef]
- Forcael, E.; Martínez-Rocamora, A.; Sepúlveda-Morales, J.; García-Alvarado, R.; Nope-Bernal, A.; Leighton, F. Behavior and performance of BIM users in a collaborative work environment. Appl. Sci. 2020, 10, 2199. [Google Scholar] [CrossRef] [Green Version]
- Merschbrock, C.; Munkvold, B.E. Effective digital collaboration in the construction industry—A case study of BIM deployment in a hospital construction project. Comput. Ind. 2015, 73, 1–7. [Google Scholar] [CrossRef]
- Lee, G.; Park, H.K.; Won, J. D3 City project—Economic impact of BIM-assisted design validation. Autom. Constr. 2012, 22, 577–586. [Google Scholar] [CrossRef]
- Howard, R.; Björk, B.C. Building information modelling—Experts’ views on standardisation and industry deployment. Adv. Eng. Inform. 2008, 22, 271–280. [Google Scholar] [CrossRef] [Green Version]
- Ham, N.; Moon, S.; Kim, J.H.; Kim, J.J. Optimal BIM staffing in construction projects using a queueing model. Autom. Constr. 2020, 113, 103123. [Google Scholar] [CrossRef]
- bimSCORE. bimSCORE Official Website. 2012. Available online: www.bimscore.com (accessed on 24 October 2022).
- IU BIM Proficiency Matrix; Indiana University Architect’s Office: Bloomington, IN, USA, 2009.
- McCuen, T.L.; Suermann, P.C.; Krogulecki, M.J. Evaluating award-winning BIM projects using the national building information model standard capability maturity model. J. Manag. Eng. 2012, 28, 224–230. [Google Scholar] [CrossRef]
- Arup. The Arup BIM Maturity Measure. 2016. Available online: https://www.arup.com/perspectives/publications/research/section/bim-maturity-model (accessed on 3 January 2023).
- Duncan, A.; Aldwinckle, G. BM6460—How to Measure the Impact of Building Information Modeling on Your Business; Autodesk University: San Francisco, CA, USA, 2014. [Google Scholar]
- Sebastian, R.; van Berlo, L. Tool for benchmarking BIM performance of design, engineering and construction firms in the Netherlands. Archit. Eng. Des. Manag. 2010, 6, 254–263. [Google Scholar] [CrossRef]
- Underwood, J.; Isikdag, U. (Eds.) Handbook of Research on Building Information Modeling and Construction Informatics: Concepts and Technologies: Concepts and Technologies; IGI Global: Hershey, PA, USA, 2009; pp. 65–102. [Google Scholar]
- Succar, B.; Kassem, M. Macro-BIM adoption: Conceptual structures. Autom. Constr. 2015, 57, 64–79. [Google Scholar] [CrossRef]
- Won, J.; Lee, G. How to tell if a BIM project is successful: A goal-driven approach. Autom. Constr. 2016, 69, 34–43. [Google Scholar] [CrossRef]
- Ham, N.; Moon, S.; Kim, J.H.; Kim, J.J. Economic analysis of design errors in BIM-based high-rise construction projects: Case study of Haeundae L project. J. Constr. Eng. Manag. 2018, 144, 05018006. [Google Scholar] [CrossRef]
- Kim, S.; Chin, S.; Han, J.; Choi, C.H. Measurement of construction BIM value based on a case study of a large-scale building project. J. Manag. Eng. 2017, 33, 05017005. [Google Scholar] [CrossRef]
- Bryde, D.; Broquetas, M.; Volm, J.M. The project benefits of building information modelling (BIM). Int. J. Proj. Manag. 2013, 31, 971–980. [Google Scholar] [CrossRef] [Green Version]
- Neelamkavil, J.; Ahamed, S.S. The Return on Investment from BIM-Driven Projects in Construction; National Research Council of Canada: Ottawa, ON, Canada, 2012.
- Solibri—BIM Software—For Architects and Engineers. Available online: http://www.solibri.com/ (accessed on 19 December 2022).
- BIMcollab: Model Validation and Issue Management for BIM. Available online: http://www.bimcollab.com (accessed on 19 December 2022).
- Revizto. Available online: https://revizto.com (accessed on 19 December 2022).
- Halpin, D.W. CYCLONE—Method for modeling job site processes. J. Constr. Div. 1977, 103, 489–499. [Google Scholar] [CrossRef]
- Halpin, D.W.; Riggs, L.S. Planning and Analysis of Construction Operations; John Wiley & Sons: Hoboken, NJ, USA, 1992; ISBN 978-0-471-55510-0. [Google Scholar]
- Chang, D.M. RESQUE: A resource based simulation system for construction process planning. Diss. Ph.D. Thesis, University of Michigan, Ann Arbor, MI, USA, 1986. [Google Scholar]
- Liu, L.Y. COOPS: Construction Object-Oriented Simulation System. Ph.D. Thesis, University of Michigan, Ann Arbor, MI, USA, 1991. [Google Scholar]
- Martinez, J.C. STROBOSCOPE: State and Resource Based Simulation of Construction Processes. Ph.D. Thesis, University of Michigan, Ann Arbor, MI, USA, 1996. [Google Scholar]
- Halligan, D.W.; Demsetz, L.A.; Brown, J.D.; Pace, C.B. Action-response model and loss of productivity in construction. J. Constr. Eng. Manag. 1994, 120, 47–64. [Google Scholar] [CrossRef]
- Bernolak, I. Effective measurement and successful elements of company productivity: The basis of competitiveness and world prosperity. Int. J. Prod. Econ. 1997, 52, 203–213. [Google Scholar] [CrossRef]
- Reijers, H.A.; Van Der Aalst, W.M. The effectiveness of workflow management systems: Predictions and lessons learned. Int. J. Inf. Manag. 2005, 25, 458–472. [Google Scholar] [CrossRef]
- Chang, D.H.; Son, J.H.; Kim, M.H. Critical path identification in the context of a workflow. Inf. Softw. Technol. 2002, 44, 405–417. [Google Scholar] [CrossRef]
- Li, H.; Yang, Y. Dynamic checking of temporal constraints for concurrent workflows. Electron. Commer. Res. Appl. 2005, 4, 124–142. [Google Scholar] [CrossRef]
- Son, J.H.; Kim, J.S.; Kim, M.H. Extracting the workflow critical path from the extended well-formed workflow schema. J. Comput. Syst. Sci. 2005, 70, 86–106. [Google Scholar] [CrossRef] [Green Version]
- Zhuge, H.; Cheung, T.Y.; Pung, H.K. A timed workflow process model. J. Syst. Softw. 2001, 55, 231–243. [Google Scholar] [CrossRef] [Green Version]
- Jeong, K.Y.; Cho, H.; Phillips, D.T. Integration of queueing network and IDEF3 for business process analysis. Bus. Process Manag. J. 2008, 14, 471–482. [Google Scholar] [CrossRef] [Green Version]
- Truong, N.K.V.; Choi, Y.; Kim, I.; Shin, S.; Hwang, W.J. A probabilistic approach to workflow time analysis for business process management. Int. J. Hum. Soc. Sci. 2010, 5, 811–815. [Google Scholar]
- Hiller, F.; Hiller, M. Introduction to Management Science: A Modeling and Case Studies Approach with Spreadsheets, 4th ed.; McGraw-Hill Education: New York, NY, USA, 2010; ISBN 007809660X. [Google Scholar]
- Schwarz, J.A.; Selinka, G.; Stolletz, R. Performance analysis of time-dependent queueing systems: Survey and classification. Omega 2016, 63, 170–189. [Google Scholar] [CrossRef] [Green Version]
- Gillard, J.; Knight, V. Using Singular Spectrum Analysis to obtain staffing level requirements in emergency units. J. Oper. Res. Soc. 2014, 65, 735–746. [Google Scholar] [CrossRef] [Green Version]
- Kolesar, P.J.; Rider, K.L.; Crabill, T.B.; Walker, W.E. A queuing-linear programming approach to scheduling police patrol cars. Oper. Res. 1975, 23, 1045–1062. [Google Scholar] [CrossRef] [Green Version]
- Bookbinder, J.; Martell, D. Time-dependent queueing approach to helicopter allocation for forest fire initial-attack. Inf. Syst. Oper. Res. 1979, 17, 58–70. [Google Scholar] [CrossRef]
- Jung, W. Recoverable inventory systems with time-varying demand. Prod. Invent. Manag. J. 1993, 34, 77. [Google Scholar]
- Koopman, B.O. Air-terminal queues under time-dependent conditions. Oper. Res. 1972, 20, 1089–1114. [Google Scholar] [CrossRef]
- Bookbinder, J. Multiple queues of aircraft under time-dependent conditions. Inf. Syst. Oper. Res. 1986, 24, 280–288. [Google Scholar] [CrossRef]
- Chakroborty, P.; Gill, R.; Chakraborty, P. Analysing queueing at toll plazas using a coupled, multiple-queue, queueing system model: Application to toll plaza design. Transp. Plan. Technol. 2016, 39, 675–692. [Google Scholar] [CrossRef]
- Zhang, M.; Ji, S.; Zhou, K. Modelling and application on the extension scale of port based on queuing theory. In Proceedings of the 2010 Ninth International Symposium on Distributed Computing and Applications to Business, Engineering and Science, Hong Kong, China, 10–12 August 2010; pp. 663–666. [Google Scholar]
- Teknomo, K. Queuing rule of thumb based on M/M/s queuing theory with applications in construction management. Civ. Eng. Dimens. 2012, 14, 139–146. [Google Scholar]
- Lee, J.S.; Kwon, N.; Ham, N.H.; Kim, J.J.; Ahn, Y.H. BIM-based digital fabrication process for a free-form building project in South Korea. Adv. Civ. Eng. 2019, 2019, 4163625. [Google Scholar] [CrossRef] [Green Version]
- Bailey, N.T. A study of queues and appointment systems in hospital out-patient departments, with special reference to waiting-times. J. R. Stat. Soc. Ser. B (Methodol.) 1952, 14, 185–199. [Google Scholar] [CrossRef]
- de Souza, R.M.; Morabito, R.; Chiyoshi, F.Y.; Iannoni, A.P. Incorporating priorities for waiting customers in the hypercube queuing model with application to an emergency medical service system in Brazil. Eur. J. Oper. Res. 2015, 242, 274–285. [Google Scholar] [CrossRef]
- Lin, J.S.; Huang, C.Y.; Fang, C.C. Analysis and assessment of software reliability modeling with preemptive priority queueing policy. J. Syst. Softw. 2022, 187, 111249. [Google Scholar] [CrossRef]
- Kim, C.; Dudin, S.; Taramin, O.; Baek, J. Queueing system MAP|PH|N|N + R with impatient heterogeneous customers as a model of call center. Appl. Math. Model. 2013, 37, 958–976. [Google Scholar] [CrossRef]
- Nan, X.; He, Y.; Guan, L. Queueing model based resource optimization for multimedia cloud. J. Vis. Commun. Image Represent. 2014, 25, 928–942. [Google Scholar] [CrossRef]
- Little, J.D.C. A proof of the queuing formula: L= λW. Oper. Res. 1961, 9, 383–387. [Google Scholar] [CrossRef]
Purpose of BIM Information Use | Construction Type | |||||
---|---|---|---|---|---|---|
Earthwork | Foundations | Framing | Finishing | Mechanical, Electrical, and Plumbing | Total | |
Constructability review | 13 | 6 | 56 | 37 | 49 | 161 |
Process review | 3 | 7 | 111 | 5 | 1 | 127 |
Design review and changes | 1 | 0 | 168 | 53 | 40 | 262 |
Quantity take-off and review | 2 | 13 | 126 | 57 | 0 | 198 |
Interference review | 1 | 0 | 15 | 5 | 49 | 70 |
Shop drawing review | 0 | 0 | 8 | 14 | 2 | 24 |
Safety management | 0 | 0 | 8 | 14 | 3 | 25 |
Others (visualization, etc.) | 0 | 0 | 4 | 0 | 1 | 5 |
Total | 20 | 26 | 496 | 185 | 145 | 872 |
Purpose of BIM Information Use | Source of Information | ||||
---|---|---|---|---|---|
Revit | Navisworks | AutoCAD | etc. (xlsx) | Total | |
Constructability review | 132 | 22 | 26 | 9 | 161 |
Process review | 52 | 72 | 2 | 5 | 127 |
Design review and changes | 186 | 35 | 126 | 0 | 262 |
Quantity take-off and review | 149 | 10 | 4 | 46 | 198 |
Interference review | 32 | 36 | 12 | 0 | 70 |
Shop drawing review | 13 | 4 | 14 | 1 | 24 |
Safety management | 15 | 9 | 0 | 1 | 25 |
Others (visualization, etc.) | 2 | 0 | 4 | 0 | 5 |
Total | 581 | 188 | 188 | 62 | 1019 |
Purpose of BIM Information Use | Type of Information | ||||
---|---|---|---|---|---|
2D Information | 3D Information | 4D Information | Combination of 2D, 3D, and 4D Information | Total | |
Constructability review | 41 | 78 | 0 | 42 | 161 |
Process review | 8 | 84 | 21 | 14 | 127 |
Design review and changes | 98 | 52 | 0 | 112 | 262 |
Quantity take-off and review | 25 | 69 | 2 | 102 | 198 |
Interference review | 5 | 52 | 0 | 13 | 70 |
Shop drawing review | 9 | 7 | 0 | 8 | 24 |
Safety management | 6 | 18 | 0 | 1 | 25 |
Others (visualization, etc.) | 3 | 1 | 0 | 1 | 5 |
Total | 195 | 361 | 23 | 293 | 872 |
Priority | Purpose of Information Use | Earthwork | Foundations | Framing | Finishing | Mechanical, Electrical, and Plumbing | Total |
---|---|---|---|---|---|---|---|
Level 1 | Design review and changes | 1 | 0 | 168 | 53 | 40 | 262 |
Level 2 | Constructability review | 13 | 6 | 56 | 37 | 49 | 161 |
Process review | 3 | 7 | 111 | 5 | 1 | 127 | |
Quantity take-off and review | 2 | 13 | 126 | 57 | 0 | 198 | |
Level 3 | Interference review | 1 | 0 | 15 | 5 | 49 | 70 |
Shop drawing review | 0 | 0 | 8 | 14 | 2 | 24 | |
Safety management | 0 | 0 | 8 | 14 | 3 | 25 | |
Others (visualization, etc.) | 0 | 0 | 4 | 0 | 1 | 5 |
Parameter | Value | Description |
---|---|---|
λ | 2.03 | Mean arrival rate |
λ1 | 0.61 | Mean arrival rate of priority level 1 |
λ2 | 1.13 | Mean arrival rate of priority level 2 |
λ3 | 0.29 | Mean arrival rate of priority level 3 |
μ | 3 | Mean service rate |
s | 1 | Number of servers |
ρ = λ/sμ | 0.6775 | Utilization factor |

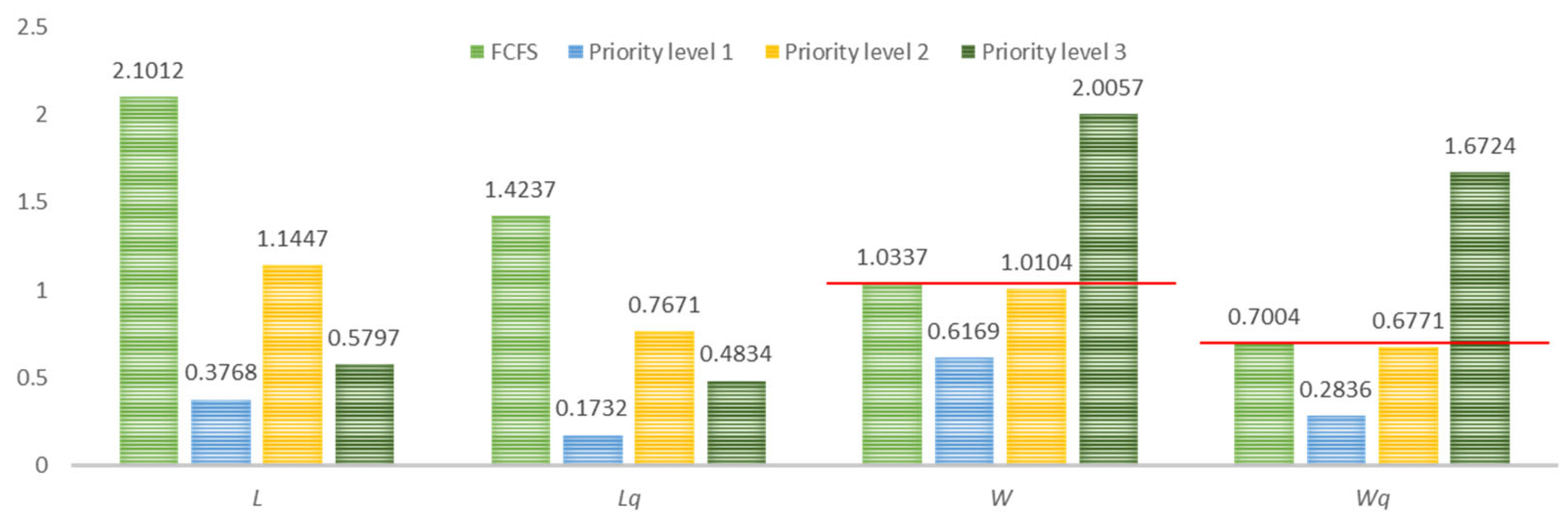

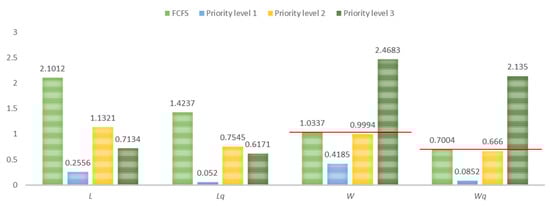

Performance Indicator | First Come First Served (FCFS) | Non-Preemptive Priorities | Preemptive Priorities | ||||
---|---|---|---|---|---|---|---|

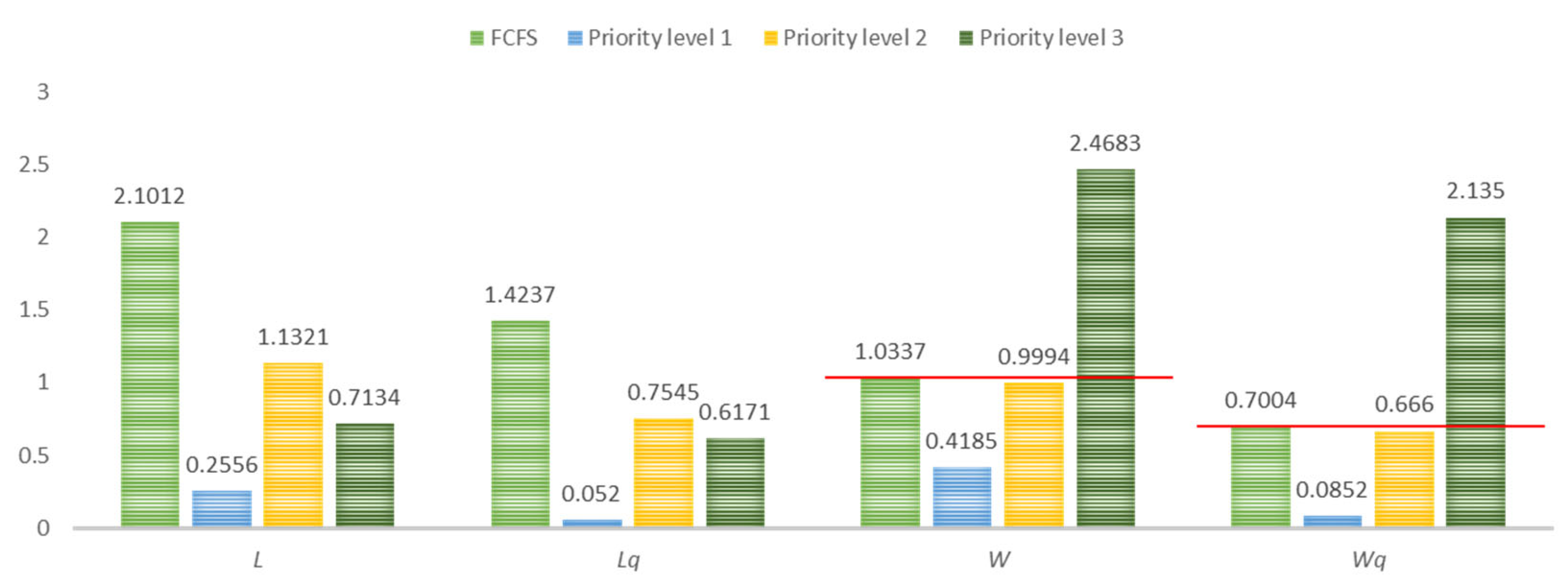

Priority Level 1 | Priority Level 2 | Priority Level 3 | Priority Level 1 | Priority Level 2 | Priority Level 3 | ||
L | 2.1012 | 0.3768 | 1.1447 | 0.5797 | 0.2556 | 1.1321 | 0.7134 |
Lq | 1.4237 | 0.1732 | 0.7671 | 0.4834 | 0.0520 | 0.7545 | 0.6171 |
W | 1.0337 | 0.6169 | 1.0104 | 2.0057 | 0.4185 | 0.9994 | 2.4683 |
Wq | 0.7004 | 0.2836 | 0.6771 | 1.6724 | 0.0852 | 0.6660 | 2.1350 |
ρ = λ/sμ | 0.6775 | 0.6775 | 0.6775 | 0.6775 | 0.6775 | 0.6775 | 0.6775 |
