Article

Analyzing Barriers of BIM and Blockchain Integration: A Hybrid ISM-DEMATEL Approach

1
School of Business and Management, Jilin University, Changchun 130012, China
2
School of Civil Engineering and Architecture, Hainan University, Haikou 570228, China
3
School of Engineering Audit, Nanjing Audit University, Nanjing 211815, China
4
School of Civil and Hydraulic Engineering, Chongqing University of Science and Technology, Chongqing 401331, China
*
Authors to whom correspondence should be addressed.
Buildings 2025, 15(8), 1370; https://doi.org/10.3390/buildings15081370
Submission received: 24 March 2025 / Revised: 11 April 2025 / Accepted: 18 April 2025 / Published: 20 April 2025
(This article belongs to the Section Construction Management, and Computers & Digitization)

Abstract

:
Building information modeling (BIM) and blockchain are reshaping construction business processes. This is particularly important for efficient information management and collaboration, especially in the current environment of complexity and fragmentation in construction business processes. However, due to the limits of practical experience and exploration, construction organizations continue to face significant challenges in adopting integrated BIM and blockchain. This study concentrates on exploring the integration of BIM and blockchain by identifying and analyzing key barriers. Through a systematic literature review and expert consultation, 13 major barriers have been identified. Relationships among barriers have been established using interpretive structural modeling (ISM) and decision-making trial and evaluation laboratory (DEMATEL) approaches. The analysis shows that high initial costs and legal and regulatory limits are the root causes that affect the adoption of BIM and blockchain integration. Additionally, investment and return risk, stakeholder attitudes and unclear value proposition have a great impact on the overall system. These findings can help construction practitioners in developing and planning strategies for the effective implementation of BIM and blockchain integration.

1. Introduction

Smart construction involves the organic integration of a new generation of information technologies with construction practices, and is a key driver of high-quality development in the construction industry [1]. However, despite the widespread promotion of smart construction, the traditional construction sector continues to face significant challenges. Notable issues such as insufficient trust among stakeholders, limited information sharing, complex business processes, and payment delays hinder the sustainable development of the industry [2]. As smart construction evolves rapidly, digital technologies like building information modeling (BIM) and blockchain have matured, and are being increasingly adopted. These technologies are reshaping production methods, business models, value chain distribution, and competitive dynamics in the construction industry. Moreover, they provide robust technical support for refined management and intensive development [3].
BIM and blockchain integration has received extensive attention from scholars [4]. BIM is a transformative technology that revolutionizes conventional practices [5], while blockchain, as an advanced and decentralized system, is widely recognized as a disruptive innovation under “Construction 4.0” [2]. Given their respective advantages, scholars have explored the potential of their integration. For instance, Elghaish et al. (2023) [6] highlighted that BIM and blockchain integration enables a digital circular construction supply chain. Celik et al. (2023) [7] found that BIM and blockchain integration enhances collaboration, efficiency, and traceability in construction. Hsu et al. (2023) [8] revealed that BIM and blockchain integration facilitates knowledge sharing in construction projects. Yoon et al. (2024) [9] demonstrated that BIM and blockchain integration improves the effectiveness and fairness of construction project procurement. Elsharkawi et al. (2025) [10] showed how the combination of smart contracts and BIM can automate construction payments.
Despite the numerous advantages of BIM and blockchain integration, several challenges persist [4]. Xue and Lu (2020) [11] emphasized that integrating BIM with blockchain is a formidable task due to the issue of information redundancy. Tao et al. (2022) [12] cautioned that directly integrating BIM with blockchain entails a risk of exposing sensitive data. Xu et al. (2024) [3] identified three key areas in the challenges of BIM and blockchain integration: technology, organization and environment. More importantly, although prior research has investigated BIM–blockchain integration, most studies have focused on technical aspects, with limited attention to integration management. Construction organizations continue to face significant barriers due to limited contextual knowledge, insufficient practical experience, and a lack of awareness of the complexities involved.
This study aims to identify barriers to BIM and blockchain integration in smart construction, providing guidance for practitioners and addressing the existing research gaps. Although a few studies have employed multi-criteria decision-making (MCDM) strategies or empirical methods to evaluate interrelationships among integration barriers, such approaches remain limited. Most existing studies focus on qualitative analysis or system design rather than exploring dynamic interactions between integration barriers. Based on the above analysis, the study formulates the following research objectives:
(a)
Identify the barriers to BIM and blockchain integration;
(b)
Determine the contextual relationships among the identified barriers;
(c)
Assess the causal relationships between barriers.
To achieve these objectives, a hybrid research method was adopted. First, barriers to BIM and blockchain integration were identified through a systematic literature review and validated through expert consultation. Next, the Interpretive Structural Model (ISM) method was used to analyze the contextual relationships among these barriers. To further assess the strength and causal relationships among the barriers, the Decision-Making Trial and Evaluation Laboratory (DEMATEL) approach was applied. This study contributes to the understanding of BIM and blockchain integration by identifying barriers across technical, organizational, and institutional levels, thereby providing deeper insights into the challenges of digital transformation in the construction industry. Additionally, it provides targeted strategies for policymakers and industry practitioners to facilitate the effective integration of BIM and blockchain.

2. Literature Review

2.1. Integration of BIM and Blockchain

BIM and blockchain are reshaping the future of the construction industry. From a narrow technical perspective, BIM is typically defined as a data-rich, object-oriented, 3D digital representation of the physical and functional characteristics of a construction project [13]. It serves as a shared knowledge resource for information throughout a building’s lifecycle [1]. From a broader perspective, BIM is increasingly being conceptualized as an integrated process or methodology that facilitates collaboration among stakeholders across all phases of a building’s lifecycle [14]. Obviously, BIM is not merely a technology, but also a project management tool and process. It enhances design accuracy, streamlines construction processes, and supports effective project operation and maintenance [3]. In addition, as the foundation of digital twins, BIM also enables integration with emerging technologies such as blockchain [15]. Blockchain, as a distributed ledger technology, ensures data security and transparency through decentralized networks and encryption algorithms [2], enabling the immutability and traceability of information [16]. Given these advantages, scholars have increasingly explored the integration of BIM and blockchain. Existing research on BIM and blockchain integration primarily focuses on two key areas.
The first area emphasizes the advantages of BIM and blockchain integration from a qualitative perspective. For instance, Nawari and Ravindran (2019) [17,18] surveyed the application of blockchain in the construction industry and analyzed its potential advantages in the BIM process. Mohammed et al. (2021) [19] examined how blockchain enhances construction workflows and advocated for its integration with BIM to optimize business processes. Hijazi et al. (2021) [20] reviewed BIM and blockchain integration in the construction supply chain, providing a rationale for their integration. Zhang et al. (2023) [21] suggested that through BIM and blockchain integration, construction organizations can avoid various problems and obtain multiple benefits. Elghaish et al. (2023) [6] pointed out that the integration of BIM and blockchain is a feasible strategy to realize a digital circular building supply chain. Celik et al. (2023) [7] indicated that the integration of BIM and blockchain can improve collaboration, efficiency and traceability in construction. Yu et al. (2024) [22] reviewed the current status and future opportunities of blockchain and BIM integration from a socio-technical perspective. Xu et al. (2024) [3] identified five key management impacts of BIM and blockchain integration through a hybrid study.
The second area explores the technical frameworks and system designs of BIM and blockchain integration. For instance, Tao et al. (2022) [12] outlined a blockchain-based confidentiality framework for BIM design collaboration to protect sensitive BIM data. Li et al. (2022) [23] introduced an innovative service-oriented system architecture for a blockchain-based IoT–BIM platform designed to support data–information–knowledge-driven supply chain management. Celik et al. (2023) [24] developed a blockchain-based BIM data provenance model to facilitate information exchange in construction projects. Brandín and Abrishami (2024) [25] proposed an integrated framework combining IoT, BIM, and blockchain to optimize efficiency and transparency in the construction supply chains. Yoon et al. (2024) [9] presented a proof-of-concept for a smart contract-enabled BIM procurement system in construction management. Elsharkawi et al. (2025) [10] employed an advanced technique to automate construction payments through the integration of smart contracts and scanning into BIM.
Based on the above literature review, it can be seen that scholars have explored the integration of BIM and blockchain to a certain extent. However, except for some qualitative studies, most studies are based on the perspective of technical integration framework development, and few studies have explored it from the perspective of integrated management, especially in the determination and interaction of barrier factors. Therefore, it is necessary for future research to explore the barriers to the integration of BIM and blockchain from the dual perspectives of technology and management, strengthen stakeholders’ understanding of the integration of the two, and further promote the effective application of the integration of the two.

2.2. Barriers to BIM and Blockchain Integration

Although BIM and blockchain integration has the potential to bring significant benefits and gains to the construction industry, its practical adoption continues to face numerous barriers and challenges. Identifying and understanding these barriers is critical for facilitating their effective adoption and implementation. This section systematically identifies and categorizes the barriers to BIM and blockchain integration through a comprehensive review of existing literature, industry reports, and expert feedback.
A systematic literature review was conducted to sort out the barriers preventing the integration of BIM and blockchain. This method involves the rigorous, transparent, and replicable collection, evaluation, analysis, and synthesis of existing research to address a specific research question [3]. This study selected Scopus and Web of Science for retrieval. The initial search was conducted on 1 January 2025, and updated on 1 March 2025. The search strategy used the following keyword combination: (“Blockchain”) and (“BIM” or “building information modeling” or “Building information modelling”). To ensure the quality and reliability of the search results, several screening criteria were set, including that only peer-reviewed journal articles published in English be retained. The initial search yielded 350 results from Scopus and 283 from Web of Science. After removing duplicates, screening titles and abstracts, and conducting full-text reviews, 60 relevant studies were retained. In addition, two more articles were identified through extended reading, resulting in a final selection of 62 documents used to identify and categorize barriers to BIM and blockchain integration. The detailed literature retrieval and screening process is shown in Figure 1.
In addition to academic literature, industry reports from various websites and consulting agencies (such as Arup and the Institution of Civil Engineers) were retrieved to gain further insights into the topic. Finally, based on the discussions and feedback from industry experts and scholars, 13 key barriers to BIM and blockchain integration were identified. The identified barriers, along with their main references, are shown in Table 1.

3. Methods

This study combined ISM and DEMATEL to explore the interrelationships among barriers to BIM and blockchain integration. These two methods are widely used for complex problem analysis and decision support, and they are considered complementary. ISM is mainly employed to examine the relationships among elements in complex systems and to analyze the system’s structure and the hierarchical relationships among different factors [42]. Its specific steps are to first identify the key elements in the system, then determine their interrelationships, after which constructing a structural model through matrix operations, including a structural self-interaction matrix (SSIM), an initial reachability matrix (IRM), and a final reachability matrix (FRM) [43,44]. DEMATEL is a tool grounded in graph theory and matrix, which is mainly utilized to address the cause–effect relationships in complex problems [45]. Its specific steps are as follows: first, collect experts’ evaluations of the relationships between various factors, then construct an average direct influence matrix, obtain the total relation matrix (TRM) through matrix operations, and finally generate a causal diagram and analyze the weight and impact direction of each factor [43,45].
Both ISM and DEMATEL perform well in studies with small sample sizes [44]. ISM offers significant benefits as it presents results through a hierarchical topology diagram. This display is very intuitive. Through the hierarchical topology diagram, the causal relationships and hierarchical structure between system factors can be clearly understood at a glance. However, one limitation of ISM is that it does not quantify the strength of these relationships—an important consideration given that not all influences are equal in practice. DEMATEL compensates for this limitation by quantifying the strength of influence between variables, thereby offering deeper insights into the causal dynamics among factors [45]. In addition, the integration of ISM and DEMATEL enhances methodological robustness. By using the output of ISM as an input for DEMATEL, the combined approach reduces the computational burden on experts, simplifies mathematical operations, and further improves the reliability and interpretability of the results [44,46]. Figure 2 shows the specific ISM-DEMATEL method flow.

4. Analysis and Results

4.1. Data Collection

To ensure the quality and depth of expert input, participants were recruited from conferences and forums related to smart construction and blockchain technology. Such environments encourage open knowledge exchange, and importantly, attract professionals from a wide range of organizations. This diversity helped enhance the reliability and representativeness of the data collected. A total of 36 experts with relevant domain experience were contacted, and 15 agreed to participate in the study. These participants were all from leading construction firms, engineering consulting agencies, and renowned universities, and had eight years of experience in areas related to BIM, blockchain, or construction management. The specific data collection involves two stages. In the initial stage, experts were asked to assess the contextual relationships between each pair of influencing factors using the symbols “V”, “A”, “X”, and “O”, thereby generating an SSIM. In the second stage, based on the ISM model output, a follow-up survey was conducted in which the same experts were invited to quantify the strength of relationships between significantly related variables. This was done using a five-point scale ranging from 0 (no influence) to 4 (very high influence), following the DEMATEL methodology.

4.2. ISM Analysis

4.2.1. Constructing the SSIM

In development of the SSIM, the symbols “V”, “A”, “X”, and “O” were used to represent the contextual relationships between pairs of barriers [47]. Specifically, “V” indicates that the horizontal (row) barrier influences the vertical (column) barrier; “A” indicates that the vertical barrier influences the horizontal barrier; “X” denotes mutual influence between the two barriers; and “O” signifies no relationship between them [48]. The data results are shown in Table 2.

4.2.2. Constructing the IRM and FRM

The above SSIM structural relationships were converted into IRM. The symbols “V”, “A”, “X”, and “O” can be substituted according to the 0 or 1 transformation principle. The IRM is shown in Table 3.
Based on the IRM, the FRM was calculated. A key step in this process was checking for transitivity within the IRM [44,49]. Transitivity is a fundamental assumption in the ISM methodology; that is, if IB1 has an impact on IB2, and IB2 has an impact on IB3, then it is assumed that IB1 also has an impact on IB3. The reachability matrix indicates whether a linkage path exists from one influencing factor to another [50]. After checking the transitivity of the IRM, the 0 in the cells with transitivity was replaced with 1*, and then the FRM was constructed. The FRM is presented in Table 4.

4.2.3. Partitioning the Hierarchical Structure

To better understand the hierarchical relationships between the influencing factors in the ISM model, it was necessary to divide the hierarchical structure of each factor. The hierarchical division was mainly determined by the reachability matrix. Based on the reachability matrix results, the reachable set, predecessor set and common set for each barrier could be expressed. The reachable set for a given barrier consisted of the elements with a value of 1 in the corresponding row of the reachability matrix. For example, the reachable set of IB11 was (8, 9, 10, 11, 12). The predecessor set for a given barrier included the elements with a value of 1 in the corresponding column. For instance, the predecessor set of IB5 was (5, 6, 7, 13). The common set for a given barrier was the intersection of its reachable and predecessor sets. For example, the common set of IB6 was (5, 6). This study adopted a result-first hierarchical extraction rule method. The specific steps were to compare the reachable set of each barrier with its common set. If the reachable set was identical to the common set, the barrier was assigned to the highest level in the system [44]. Similarly, the barriers obtained in the first iteration were eliminated, and the values corresponding to those barriers were eliminated from other sets. This comparison process continued iteratively until the hierarchical relationships of all barriers were determined. The detailed iterative process and hierarchical division results are presented in Table 5.

4.2.4. ISM Model

The ISM model diagram of the barriers was drawn based on the reachability matrix and the results of the hierarchical relationship division. After thorough inspection, no internal inconsistencies were found in the model. The 13 barriers were categorized into five levels, with the final ISM model diagram presented in Figure 3. As illustrated in the figure, IB7 (High initial cost) and IB 13 (Legal and regulatory) are positioned at the bottom, and IB8 (Investment and return risk), IB9 (Unclear value proposition), and IB10 (Stakeholder attitudes) are placed at the top.

4.2.5. MICMAC Analysis

The MICMAC analysis was based on the principle of matrix multiplication, aiming to determine the “driving forces and dependent forces” of each barrier, and then classify the research variables accordingly [46]. Using the reachability matrix, the driving forces and dependencies of all barriers were calculated, with the results displayed in Table 4. Based on these results, the 13 barriers in this study were divided into four quadrants: I—autonomous clusters, II—dependent clusters, III—linkage clusters and IV—driving clusters. Figure 4 presents the MIMAC analysis results, revealing that no barrier was classified in the I—autonomous cluster. This indicates that all selected barriers were sufficient to ensure valid outcomes [44]; the II—dependent cluster contained IB8, IB9, IB10, IB11 and IB12, indicating that these factors were mainly affected by other factors; the III—linkage cluster contained IB1, IB2, IB3 and IB4, indicating that they were inherently unstable, and the IV—driving cluster contained IB5, IB6, IB7 and IB13, indicating that these factors mainly drove other barriers.

4.3. DEMATEL Analysis

4.3.1. Average Direct Influence Matrix

The output of the ISM method was used as the input of the DEMATEL method to construct the average direct impact matrix of the barriers. Specifically, only variables exhibiting an impact relationship in the ISM model were considered in the collection of data from experts. Experts were asked to assess the degree of influence between the corresponding barriers using a 0–4 scoring system, based on their impact on other barriers. The average direct impact matrix for the barriers to BIM and blockchain integration was then calculated by summarizing and averaging the data. The results are shown in Table 6.

4.3.2. Normalized Average Direct Influence Matrix

According to the average direct impact matrix, the elements in each row were summed, and the maximum sum value among the elements was identified. Each element was then divided by this maximum value, resulting in the normalized average direct impact matrix. The results are displayed in Table 7.

4.3.3. Constructing the TRM

Then, the comprehensive impact matrix was calculated using the formula T = D(ID)−1, where I represent the unit matrix and D represents the standardized average direct impact matrix [51]. By calculating the inverse matrix of the I-D matrix and multiplying it with the matrix D, the TRM was finally obtained, as illustrated in Table 8.

4.3.4. Influence and Causation

Using the total relationship matrix, the importance and corresponding causal relationships of each barrier were calculated. The influence of each barrier was determined by summing the elements in each row of the comprehensive influence matrix, while the causality of each barrier was assessed by summing the elements in each column of the matrix. The centrality of each barrier, reflecting its significance in BIM and blockchain integration barriers, was calculated by adding the influence and causality values of each factor [52,53]. The centrality value of a barrier indicates its importance in the system. The causality of each barrier was calculated as the difference between its influence and causality, yielding both positive and negative values. These values help categorize barriers into cause and effect groups based on their positions in the system. The results of the influence index for each barrier are shown in Table 9. Furthermore, a cause–effect relationship diagram was created with centrality on the horizontal axis and causality on the vertical axis, marking the position of each barrier in the diagram. The results are shown in Figure 5.

5. Discussion and Implications

5.1. Discussion

The findings of this research offer valuable insights, particularly as the ISM model identifies five distinct hierarchical levels that describe the relationships between the identified barriers. Among these, IB8, IB9 and IB10 are located in the first level, at the peak of the model. These barriers reflect the hesitation and concerns construction organizations have regarding the benefits of adopting emerging technologies. IB7 and IB13 are located in the fifth level, at the bottom of the model, serving as the fundamental factors. These barriers highlight that the key to BIM and blockchain integration lies in cost and regulation. In addition, the middle layer mainly contains barriers related to knowledge, skills training, and technology. These barriers are influenced by the bottom-level barriers and, in turn, they influence the top-level barriers. More importantly, the output of ISM shows that IB7 (High initial cost) and IB13 (Legal and regulatory) may fundamentally deter many construction companies from integrating BIM with blockchain, a finding that aligns with [3,4]. Due to the low investment in innovation in the construction industry, many companies face financial constraints, exacerbating their resistance to change. In addition, with the vigorous development of China’s new infrastructure, various government departments have realized the key role of information technology, and have introduced some favorable policies. However, since the integrated application of BIM and blockchain is still in its early stages, blockchain supervision and certain legal policies remain uncertain. This uncertainty causes many construction organizations to hesitate and refrain from investing significant resources in the digital transformation of BIM and blockchain. As highlighted in the industry report by the Institution of Civil Engineers, regulatory uncertainty is a key barrier to the early integration of BIM and blockchain [54].
The MICMAC analysis divides all barriers into four factor groups. Notably, the first quadrant, representing the autonomous factor group, contains no barriers, which further underscores the critical role of the identified barriers in the system. The second quadrant, representing the dependent factor group, includes IB8, IB9, IB10, IB11 and IB12, indicating that these barriers are more influenced by other barriers. The third quadrant, the linkage factor group, includes IB1, IB2, IB3 and IB4, which were mainly technical barriers. This highlights that technical barriers not only affect organizational or environmental factors, but also influence stakeholder trust, attitudes, and work processes. The fourth quadrant, the independent factor group, includes IB5, IB6, IB7 and IB13, emphasizing the importance of cost, regulation, expert experience, and training.
Finally, as per the DEMATEL analysis, the centrality of each obstacle was ranked, and the causal relationship of each obstacle in the whole system was determined. The results reveal that the centrality rankings of IB8, IB10, and IB9 were relatively high, indicating that these barriers play a crucial role in the system. Barriers with higher centrality are particularly important and should be prioritized. This also highlights that, in the initial stages of applying emerging technologies, the value of the technology and the attitudes of stakeholders are critical [55]. The technical barriers to BIM and blockchain integration can exacerbate this situation, especially for small and medium-sized construction companies, which often lack an understanding of how these technologies work and the value they can bring to project practice. Therefore, providing education, training, and expert guidance for employees is essential. Only with adequate organizational preparations can construction organizations successfully navigate the challenges of digital transformation and maximize the value of technology integration. In addition, IB1, IB2, IB3, IB4, IB5, IB6, IB7, and B13 were classified as the cause group, mainly influencing other barriers and contributing to the hindrance of BIM and blockchain integration. In contrast, IB8, IB9, IB10, IB11, and B12 were classified as the result group, mainly affected by other barriers and representing the effects of hindrance to the integration of BIM and blockchain.

5.2. Academic Implications

The contributions of this research are primarily reflected in the following aspects. First, although previous studies have extensively discussed BIM and blockchain integration, they have primarily focused on its advantages and potential value, with limited discussion of the barriers to such integration. This study fills this gap by systematically analyzing these barriers and employing ISM and DEMATEL methods to investigate the relationships between them. Second, although some prior studies have examined barriers to BIM and blockchain integration, most of them have focused on technical challenges in a fragmented manner, lacking a comprehensive and systematic analysis. This study has identified the barriers to BIM and blockchain integration through literature reviews, industry reports and expert feedback, not only encompassing technical barriers but also highlighting the crucial roles of cost, business processes, and human factors. By doing so, it enriches the theoretical framework for understanding the factors influencing BIM and blockchain integration. Finally, this research provides a foundation for future empirical studies and provides a theoretical basis for developing targeted intervention strategies in the future.

5.3. Managerial Implications

BIM and blockchain integration optimizes the management and execution of construction projects by improving data transparency, traceability, collaboration efficiency, and security [56,57]. However, as highlighted in this study, several challenges remain. Given that high initial costs are a major barrier, governments and policymakers should increase financial support and incentive policies for BIM and blockchain integration, particularly for small and micro enterprises, as well as for infrastructure development. At the same time, a well-defined legal and regulatory framework is essential for ensuring the sustainable development of these technologies. In addition, strengthening technical training and talent development is fundamental to the successful integration of BIM and blockchain. Establishing an industry certification system can help cultivate professionals with interdisciplinary expertise, addressing the construction industry’s growing demand for both technical and managerial talent [58]. To address concerns around technology immaturity and security risks, a unified data privacy protection and security management framework should be established. Enhancing technological maturity and strengthening security measures will mitigate technical risks associated with BIM and blockchain integration. Moreover, cross-industry and cross-departmental collaboration remains a challenge, particularly in fostering trust and adapting workflow. To overcome these barriers, industry stakeholders should build a collaborative framework, enhance communication, promote value co-creation, and facilitate cultural transformation within organizations. These efforts will help dispel skepticism toward new technologies, provide investors with a clearer value proposition, and boost investor confidence. Ultimately, such measures will accelerate the integration and widespread adoption of BIM and blockchain in the construction industry.

6. Conclusions and Limitation

6.1. Key Findings

This research mainly conducts a modeling analysis of the barriers to BIM and blockchain integration, exploring their hierarchical structure and causal relationships. Based on a comprehensive literature review and expert insights, 13 key barriers to BIM and blockchain integration have been identified and analyzed using a hybrid ISM–DEMATEL approach. The ISM analysis established the hierarchical structure of these barriers, dividing them into five levels. Among them, IB7 and IB13 were at the bottom of the hierarchy, serving as the root causes of barriers to BIM and blockchain integration. In addition, the DEMATE analysis determined the causal relationships and impacts of each barrier. These barriers were labeled as cause groups and effect groups. IB8, IB10 and IB9 emerged as the most impactful barriers in the system. By addressing the fragmentation of existing research on the factors influencing BIM and blockchain integration, this study provides a foundation for future empirical research, and offers valuable practical insights for policymakers and industry stakeholders.

6.2. Limitations and Future Directions

This research has some limitations. First, the study primarily draws on experts from China, which means the findings may be specific to the Chinese construction industry and may not directly apply to other countries or regions without modification. The barriers identified in this study could be influenced by unique cultural, regulatory, and technological factors in China. Therefore, caution should be taken when applying these findings to different contexts. Future research could expand the data collection across multiple countries or regions to allow for a comparative analysis, which would offer a broader understanding of commonalities and differences in barriers across various cultural and regulatory environments. Second, the identification and selection of barriers were mainly based on the literature and expert opinions, which may introduce biases related to the experts’ experiences and interests. To mitigate this, future research could validate these barriers through real-world case studies and explore their interdependencies more comprehensively. Finally, given that BIM and blockchain integration in construction is still in its early stages and there is a limited pool of available experts, this study did not conduct large-scale data collection for empirical tests on barrier factors. As the adoption of BIM and blockchain continues to grow, future research could employ methods such as structural equation modeling, regression analysis, or experiments to further investigate the drivers, barriers or critical success factors for the successful integration of these technologies in construction projects.

Author Contributions

Conceptualization, Y.X., Q.A. and X.B.; methodology, Q.A. and Y.X.; validation, Y.X. and H.-Y.C.; formal analysis, Q.A. and Y.X.; investigation, Y.X. and H.-Y.C.; resources, X.L. and H.-Y.C.; data curation, Q.A. and Y.X.; writing—original draft preparation, Y.X. and Q.A.; writing—review and editing, Y.X. and Q.A.; visualization, Q.A. and Y.X.; supervision, Y.X. and X.B.; project administration, Y.X. and H.-Y.C.; funding acquisition, Y.X. and H.-Y.C. All authors have read and agreed to the published version of the manuscript.

Funding

This research is partly supported by the National Natural Science Foundation of China (Grant No. 72461006), Hainan Provincial Natural Science Foundation of China (Grant No. 525RC706, 723QN217, and 723QN216), Hainan Province Philosophy and Social Sciences Planning Project (Grant No. HNSK(ZC)23-133).

Informed Consent Statement

Informed consent was obtained from all subjects involved in the study.

Data Availability Statement

The data used to support the findings of this study are available from the corresponding author upon request.

Conflicts of Interest

The authors declare no conflicts of interest.

References

  1. Pan, Y.; Zhang, L. Integrating BIM and AI for smart construction management: Current status and future directions. Arch. Comput. Methods Eng. 2023, 30, 1081–1110. [Google Scholar] [CrossRef]
  2. Xu, Y.; Chong, H.Y.; Chi, M. Blockchain in the AECO industry: Current status, key topics, and future research agenda. Autom. Constr. 2022, 134, 104101. [Google Scholar] [CrossRef]
  3. Xu, Y.; Chi, M.; Chong, H.Y.; Lee, C.Y.; Chen, K. When BIM meets blockchain: A mixed-methods literature review. J. Civ. Eng. Manag. 2024, 30, 646–669. [Google Scholar] [CrossRef]
  4. Singh, A.K.; Kumar, V.P. Analyzing the barriers for blockchain-enabled BIM adoption in facility management using best-worst method approach. Built Environ. Proj. Asset Manag. 2024, 14, 164–183. [Google Scholar] [CrossRef]
  5. Uvarova, S.S.; Orlov, A.K.; Kankhva, V.S. Ensuring efficient implementation of lean construction projects using building information modeling. Buildings 2023, 13, 770. [Google Scholar] [CrossRef]
  6. Elghaish, F.; Hosseini, M.R.; Kocaturk, T.; Arashpour, M.; Ledari, M.B. Digitalised circular construction supply chain: An integrated BIM-Blockchain solution. Autom. Constr. 2023, 148, 104746. [Google Scholar] [CrossRef]
  7. Celik, Y.; Petri, I.; Rezgui, Y. Integrating BIM and Blockchain across construction lifecycle and supply chains. Comput. Ind. 2023, 148, 103886. [Google Scholar] [CrossRef]
  8. Hsu, C.L.; Wang, J.T.; Hou, H.Y. A blockchain-based parametric model library for knowledge sharing in building information modeling collaboration. J. Constr. Eng. Manag. 2023, 149, 04023107. [Google Scholar] [CrossRef]
  9. Yoon, J.H.; Aurangzeb, I.; McNamara, S. BIM-and blockchain-enabled automatic procurement system (BBAPS) removing relationship bias. Autom. Constr. 2024, 168, 105779. [Google Scholar] [CrossRef]
  10. Elsharkawi, H.; Elbeltagi, E.; Eid, M.S.; Alattyih, W.; Wefki, H. Construction payment automation through scan-to-BIM and blockchain-enabled smart contract. Buildings 2025, 15, 213. [Google Scholar] [CrossRef]
  11. Xue, F.; Lu, W. A semantic differential transaction approach to minimizing information redundancy for BIM and blockchain integration. Autom. Constr. 2020, 118, 103270. [Google Scholar] [CrossRef]
  12. Tao, X.; Liu, Y.; Wong, P.K.Y.; Chen, K.; Das, M.; Cheng, J.C. Confidentiality-minded framework for blockchain-based BIM design collaboration. Autom. Constr. 2022, 136, 104172. [Google Scholar] [CrossRef]
  13. Alves, J.L.; Palha, R.P.; de Almeida Filho, A.T. Towards an integrative framework for BIM and artificial intelligence capabilities in smart architecture, engineering, construction, and operations projects. Autom. Constr. 2025, 174, 106168. [Google Scholar] [CrossRef]
  14. Zhao, X. A scientometric review of global BIM research: Analysis and visualization. Autom. Constr. 2017, 80, 37–47. [Google Scholar] [CrossRef]
  15. Yoon, S.; Lee, J.; Li, J.; Wang, P. Virtual in-situ modeling between digital twin and BIM for advanced building operations and maintenance. Autom. Constr. 2024, 168, 105823. [Google Scholar] [CrossRef]
  16. Hijazi, A.A.; Perera, S.; Calheiros, R.N.; Alashwal, A. A data model for integrating BIM and blockchain to enable a single source of truth for the construction supply chain data delivery. Eng. Constr. Archit. Manag. 2023, 30, 4645–4664. [Google Scholar] [CrossRef]
  17. Nawari, N.O.; Ravindran, S. Blockchain technology and BIM process: Review and potential applications. J. Inf. Technol. Constr. 2019, 24, 209–238. [Google Scholar]
  18. Nawari, N.O.; Ravindran, S. Blockchain and the built environment: Potentials and limitations. J. Build. Eng. 2019, 25, 100832. [Google Scholar] [CrossRef]
  19. Mohammed, A.; Almousa, A.; Ghaithan, A.; Hadidi, L.A. The role of blockchain in improving the processes and workflows in construction projects. Appl. Sci. 2021, 11, 8835. [Google Scholar] [CrossRef]
  20. Hijazi, A.A.; Perera, S.; Calheiros, R.N.; Alashwal, A. Rationale for the integration of BIM and blockchain for the construction supply chain data delivery: A systematic literature review and validation through focus group. J. Constr. Eng. Manag. 2021, 147, 03121005. [Google Scholar] [CrossRef]
  21. Zhang, T.; Doan, D.T.; Kang, J. Application of building information modeling-blockchain integration in the architecture, engineering, and construction/facilities management industry: A review. J. Build. Eng. 2023, 77, 107551. [Google Scholar] [CrossRef]
  22. Yu, J.; Zhong, H.; Bolpagni, M. Integrating blockchain with building information modelling (BIM): A systematic review based on a sociotechnical system perspective. Constr. Innov. 2024, 24, 280–316. [Google Scholar] [CrossRef]
  23. Li, X.; Lu, W.; Xue, F.; Wu, L.; Zhao, R.; Lou, J.; Xu, J. Blockchain-enabled IoT-BIM platform for supply chain management in modular construction. J. Constr. Eng. Manag. 2022, 148, 04021195. [Google Scholar] [CrossRef]
  24. Celik, Y.; Petri, I.; Barati, M. Blockchain supported BIM data provenance for construction projects. Comput. Ind. 2023, 144, 103768. [Google Scholar] [CrossRef]
  25. Brandín, R.; Abrishami, S. IoT-BIM and blockchain integration for enhanced data traceability in offsite manufacturing. Autom. Constr. 2024, 159, 105266. [Google Scholar] [CrossRef]
  26. Kiu, M.S.; Lim, K.X.; Wong, P.F. Blockchain technology in building information modelling (BIM): Potential, challenges, and strategies. IOP Conf. Ser. Earth Environ. Sci. 2024, 1347, 012027. [Google Scholar] [CrossRef]
  27. Sonmez, R.; Ahmadisheykhsarmast, S.; Güngör, A.A. BIM integrated smart contract for construction project progress payment administration. Autom. Constr. 2022, 139, 104294. [Google Scholar] [CrossRef]
  28. Liu, Y.; Tao, X.; Das, M.; Gong, X.; Liu, H.; Xu, Y.; Xie, A.; Cheng, J.C. Blockchain-enabled platform-as-a-service for production management in off-site construction design using openBIM standards. Autom. Constr. 2024, 164, 105447. [Google Scholar] [CrossRef]
  29. Tao, X.; Das, M.; Zheng, C.; Liu, Y.; Wong, P.K.-Y.; Xu, Y.; Liu, H.; Gong, X.; Cheng, J.C. Enhancing BIM security in emergency construction projects using lightweight blockchain-as-a-service. Autom. Constr. 2023, 150, 104846. [Google Scholar] [CrossRef]
  30. Lawal, O.O.; Nawari, N.O. Blockchain-Enabled City Information Modeling Framework for Urban Asset Management. J. Archit. Eng. 2024, 30, 04024020. [Google Scholar] [CrossRef]
  31. Faraji, A.; Homayoon Arya, S.; Ghasemi, E.; Rahnamayiezekavat, P.; Perera, S. Building information modeling (BIM), blockchain, and LiDAR applications in construction lifecycle: Bibliometric, and network analysis. Buildings 2024, 14, 919. [Google Scholar] [CrossRef]
  32. Wu, L.; Lu, W.; Xue, F.; Li, X.; Zhao, R.; Tang, M. Linking permissioned blockchain to Internet of Things (IoT)-BIM platform for off-site production management in modular construction. Comput. Ind. 2022, 135, 103573. [Google Scholar] [CrossRef]
  33. Javaherikhah, A.; Lopez, M.V.; Sarvari, H. Assessing the efficiency of integrating BIM and blockchain to improve information management for Mars buildings: A SWOT-AHP Analysis. Buildings 2025, 15, 494. [Google Scholar] [CrossRef]
  34. Faraji, A.; Homayoon Arya, S.; Ghasemi, E.; Rashidi, M.; Perera, S.; Tam, V.; Rahnamayiezekavat, P. A conceptual framework of decentralized blockchain integrated system based on building information modeling to steering digital administration of disputes in the IPD contracts. Constr. Innov. 2024, 24, 384–406. [Google Scholar] [CrossRef]
  35. Hsu, C.L.; Wang, J.T.; Xie, H.J. Modelling exchange with blockchain for the collaborative design of a building envelope in BIM. Open Constr. Build. Technol. J. 2024, 18, e18748368259109. [Google Scholar] [CrossRef]
  36. Chong, H.Y.; Diamantopoulos, A. Integrating advanced technologies to uphold security of payment: Data flow diagram. Autom. Constr. 2020, 114, 103158. [Google Scholar] [CrossRef]
  37. Sarkar, D.; Dhaneshwar, D.; Raval, P. Automation in monitoring of construction projects through BIM-IoT-blockchain model. J. Inst. Eng. (India) Ser. A 2023, 104, 317–333. [Google Scholar] [CrossRef]
  38. Elghaish, F.; Abrishami, S.; Hosseini, M.R. Integrated project delivery with blockchain: An automated financial system. Autom. Constr. 2020, 114, 103182. [Google Scholar] [CrossRef]
  39. Teisserenc, B.; Sepasgozar, S. Adoption of blockchain technology through digital twins in the construction industry 4.0: A PESTELS approach. Buildings 2021, 11, 670. [Google Scholar] [CrossRef]
  40. Tan, J.H.; Loo, S.C.; Zainon, N.; Aziz, N.M.; Mohd Rahim, F.A. Potential functionality and workability of blockchain within a building information modelling (BIM) environment. J. Facil. Manag. 2023, 21, 490–510. [Google Scholar] [CrossRef]
  41. Khalid, M.A.; Hassan, M.U.; Ullah, F.; Ahmed, K. Integrated building information modeling and blockchain system for decentralized progress payments in construction projects. J. Eng. Des. Technol. 2024. ahead-of-print. [Google Scholar] [CrossRef]
  42. Warfield, J.N. Toward interpretation of complex structural models. IEEE Trans. Syst. Man Cybern. 1974, 5, 405–417. [Google Scholar] [CrossRef]
  43. Yuan, H.; Du, W.; Zuo, J.; Ma, X. Paving a traceable green pathway towards sustainable construction: A fuzzy ISM-DEMATEL analysis of blockchain technology adoption barriers in construction waste management. Ain Shams Eng. J. 2024, 15, 102627. [Google Scholar] [CrossRef]
  44. Xu, Y.; Chong, H.Y.; Chi, M. Modelling the blockchain adoption barriers in the AEC industry. Eng. Constr. Archit. Manag. 2023, 30, 125–153. [Google Scholar] [CrossRef]
  45. Wu, H.; Zhong, W.; Zhong, B.; Li, H.; Guo, J.; Mehmood, I. Barrier identification, analysis and solutions of blockchain adoption in construction: A fuzzy DEMATEL and TOE integrated method. Eng. Constr. Archit. Manag. 2025, 32, 409–426. [Google Scholar] [CrossRef]
  46. Bagherian, A.; Gershon, M.; Kumar, S.; Mishra, M.K. Analyzing the relationship between digitalization and energy sustainability: A comprehensive ISM-MICMAC and DEMATEL approach. Expert Syst. Appl. 2024, 236, 121193. [Google Scholar] [CrossRef]
  47. Tian, B.; He, L.; Xu, Y.; Fu, J.; Wu, H. Critical success factors for blockchain implementation in the AEC industry: An integrated ISM and DEMATEL Approach. Eng. Manag. J. 2025, 1–17. [Google Scholar] [CrossRef]
  48. Yuan, H.; Du, W.; Ma, X.; Liu, J.; Li, L. Critical factors to influence the illegal dumping behavior of construction and demolition waste: An ISM-DEMATEL analysis. Dev. Built Environ. 2023, 14, 100159. [Google Scholar] [CrossRef]
  49. Wu, K.; Tang, S.; Tang, M. Interpretative structural modeling to social sciences: Designing better datasets for mixed method research. Qual. Quant. 2024, 58, 4073–4092. [Google Scholar] [CrossRef]
  50. Alshibani, A.; Aldossary, M.S.; Hassanain, M.A.; Hamida, H.; Aldabbagh, H.; Ouis, D. Investigation of the driving power of the barriers affecting BIM adoption in construction management through ISM. Results Eng. 2024, 24, 102987. [Google Scholar] [CrossRef]
  51. Kumar, A.; Dixit, G. An analysis of barriers affecting the implementation of e-waste management practices in India: A novel ISM-DEMATEL approach. Sustain. Prod. Consum. 2018, 14, 36–52. [Google Scholar] [CrossRef]
  52. Mousavizade, F.; Shakibazad, M. Identifying and ranking CSFs for KM implementation in urban water and sewage companies using ISM-DEMATEL technique. J. Knowl. Manag. 2019, 23, 200–218. [Google Scholar] [CrossRef]
  53. Pandey, P.; Agrawal, N.; Saharan, T.; Raut, R.D. Impact of human resource management practices on TQM: An ISM-DEMATEL approach. TQM J. 2022, 34, 199–228. [Google Scholar] [CrossRef]
  54. Penzes, B.; KirNup, A.; Gage, C.; Dravai, T.; Colmer, M. Blockchain Technology in the Construction Industry: Digital Transformation for High Productivity; Institution of Civil Engineers (ICE): London, UK, 2018; Volume 55. [Google Scholar]
  55. Xu, S.; Zhou, L.; Zou, P.X. What influences stakeholders’ decision in adopting blockchain-based quality tracking systems in prefabricated construction. Eng. Constr. Archit. Manag. 2024, 31, 2224–2247. [Google Scholar] [CrossRef]
  56. Ni, Y.; Sun, B.; Wang, Y. Blockchain-based BIM digital project management mechanism research. IEEE Access 2021, 9, 161342–161351. [Google Scholar] [CrossRef]
  57. Zhong, B.; Pan, X.; Ding, L.; Chen, Q.; Hu, X. Blockchain-driven integration technology for the AEC industry. Autom. Constr. 2023, 150, 104791. [Google Scholar] [CrossRef]
  58. Fang, Y.; Gao, S. Construction 4.0 technology and lean construction ambidexterity capability in China’s construction industry: A sociotechnical systems perspective. Constr. Innov. 2024. ahead-of-print. [Google Scholar] [CrossRef]

Figure 1. Literature identification and evaluation process.
Figure 1. Literature identification and evaluation process.
Buildings 15 01370 g001

Figure 2. Process based on ISM-DEMATEL approach.
Figure 2. Process based on ISM-DEMATEL approach.
Buildings 15 01370 g002

Figure 3. ISM model.
Figure 3. ISM model.
Buildings 15 01370 g003

Figure 4. MICMAC analysis results.
Figure 4. MICMAC analysis results.
Buildings 15 01370 g004

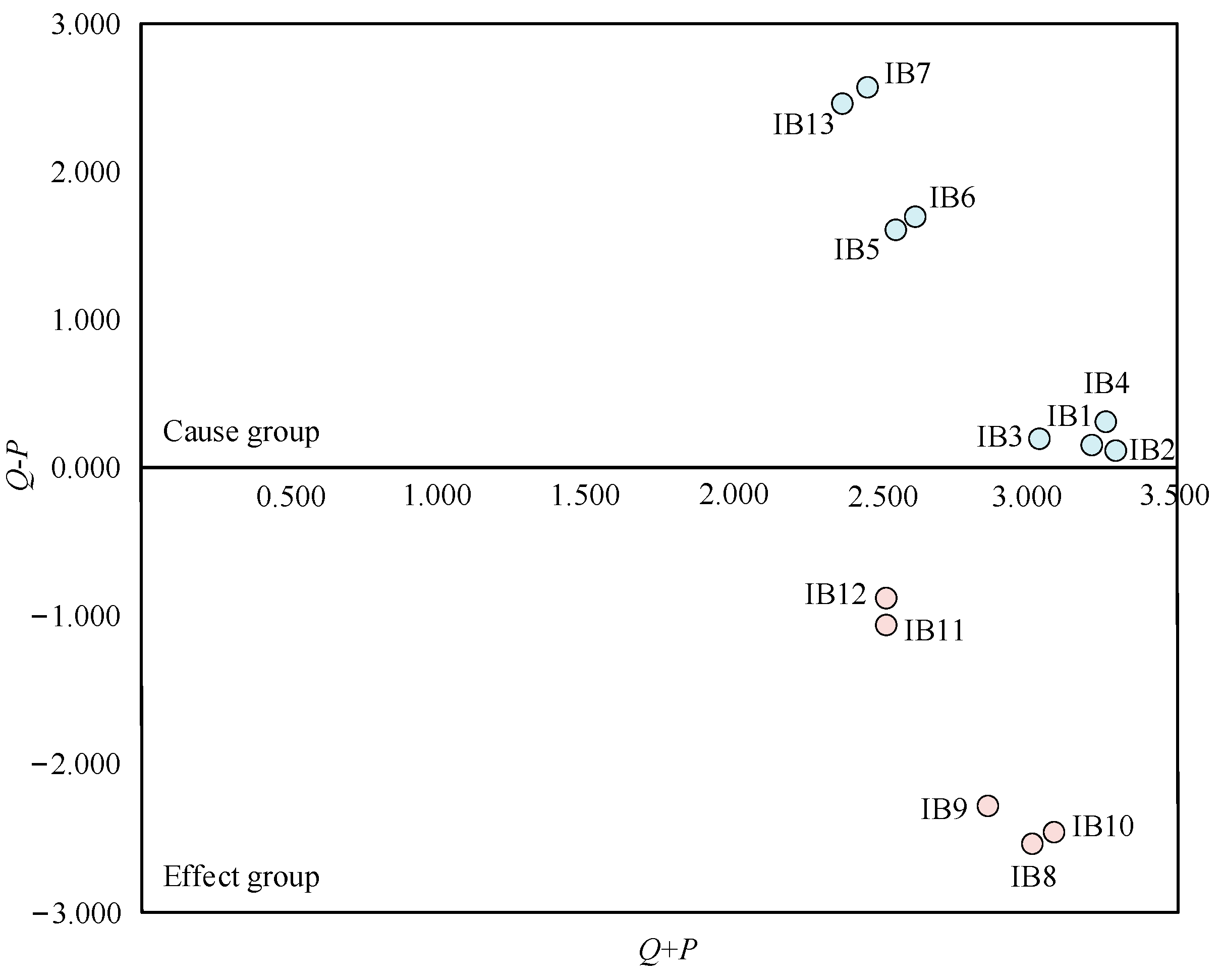

Figure 5. Overall degree of influence of barriers to BIM and blockchain integration.
Figure 5. Overall degree of influence of barriers to BIM and blockchain integration.
Buildings 15 01370 g005
Table 1. Barriers to BIM and blockchain integration.
Table 1. Barriers to BIM and blockchain integration.
CodeBarriersMain References
IB1Infrastructure and technology immaturity[3,22,26,27]
IB2Complexity of technology integration[4,6,9,10,27]
IB3Data privacy and security[3,4,21,27,28,29]
IB4Lack of standards and protocols[4,23,30,31,32]
IB5Lack of expertise and experience[4,10,11,22,25,33,34]
IB6Lack of training and education[10,17,18,35]
IB7High initial cost[3,4,10,17,18,33]
IB8Investment and return risk[4,17,18,36]
IB9Unclear value proposition[26,31,35,37]
IB10Stakeholder attitudes[27,32,36,38]
IB11Lack of trust and collaboration[4,7,25,36,39,40]
IB12Workflow changes and adjustments[10,28,30,32]
IB13Legal and regulatory[3,10,17,18,33,41]
Table 2. The structural self-interaction matrix result.
Table 2. The structural self-interaction matrix result.
Code12345678910111213
IB1VVOAAAVOVOOO
IB2 AAAOOVOVVAA
IB3 OAAVVOVVOO
IB4 XXOVOVVVA
IB5 VVVVXVVA
IB6 AXXAAAA
IB7 VVVOAV
IB8 XVAXA
IB9 XXXA
IB10 XVA
IB11 XA
IB12 A
IB13
Table 3. The initial reachability matrix result.
Table 3. The initial reachability matrix result.
Code12345678910111213
IB11111000101100
IB21100000101110
IB31111000101100
IB41111000101110
IB51111110111110
IB61011110111110
IB71010111111010
IB80000000111000
IB90000000111000
IB100000000111000
IB110000000111110
IB120000000111110
IB130101110111111
Table 4. The final reachability matrix result.
Table 4. The final reachability matrix result.
Code12345678910111213Driving Power
IB1111100011*111*09
IB2111*1*00011*11109
IB3111100011*111*09
IB4111100011*11109
IB5111111011111011
IB611*1111011111011
IB711*11*1111111*1012
IB800000001110003
IB900000001110003
IB1000000001110003
IB1100000001111105
IB1200000001111105
IB131*11*111011111112
Dependence power888844113131310101
Table 5. Partitioning the hierarchical structure.
Table 5. Partitioning the hierarchical structure.
InteractionCodeReachability SetAntecedent SetInteraction SetLevel
FirstIB11, 2, 3, 4, 8, 9, 10, 11, 121, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4
IB21, 2, 3, 4, 8, 9, 10, 11, 121, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4
IB31, 2, 3, 4, 8, 9, 10, 11, 121, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4
IB41, 2, 3, 4, 8, 9, 10, 11, 121, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4
IB51, 2, 3, 4, 5, 6, 8, 9, 10, 11, 125, 6, 7, 135, 6
IB61, 2, 3, 4, 5, 6, 8, 9, 10, 11, 125, 6, 7, 135, 6
IB71, 2, 3, 4, 5, 6, 7, 8, 9, 10, 11, 1277
IB88, 9, 101, 2, 3, 4, 5, 6, 7, 8, 9, 10, 11, 12, 138, 9, 10I
IB98, 9, 101, 2, 3, 4, 5, 6, 7, 8, 9, 10, 11, 12, 138, 9, 10I
IB108, 9, 101, 2, 3, 4, 5, 6, 7, 8, 9, 10, 11, 12, 138, 9, 10I
IB118, 9, 10, 11, 121, 2, 3, 4, 5, 6, 7, 11, 12, 1311, 12
IB128, 9, 10, 11, 121, 2, 3, 4, 5, 6, 7, 11, 12, 1311, 12
IB131, 2, 3, 4, 5, 6, 8, 9, 10, 11, 12, 131313
SecondIB11, 2, 3, 4, 11, 121, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4
IB21, 2, 3, 4, 11, 121, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4
IB31, 2, 3, 4, 11, 121, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4
IB41, 2, 3, 4, 11, 121, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4
IB51, 2, 3, 4, 5, 6, 11, 125, 6, 7, 135, 6
IB61, 2, 3, 4, 5, 6, 11, 125, 6, 7, 135, 6
IB71, 2, 3, 4, 5, 6, 7, 11, 1277
IB1111, 121, 2, 3, 4, 5, 6, 7, 11, 12, 1311, 12II
IB1211, 121, 2, 3, 4, 5, 6, 7, 11, 12, 1311, 12II
IB131, 2, 3, 4, 5, 6, 11, 12, 131313
ThirdIB11, 2, 3, 41, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4III
IB21, 2, 3, 41, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4III
IB31, 2, 3, 41, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4III
IB41, 2, 3, 41, 2, 3, 4, 5, 6, 7, 131, 2, 3, 4III
IB51, 2, 3, 4, 5, 65, 6, 7, 135, 6
IB61, 2, 3, 4, 5, 65, 6, 7, 135, 6
IB71, 2, 3, 4, 5, 6, 777
IB131, 2, 3, 4, 5, 6, 131313
FourthIB55, 65, 6, 7, 135, 6IV
IB65, 65, 6, 7, 135, 6IV
IB75, 6, 777
IB135, 6, 131313
FifthIB7777V
IB13131313V
Table 6. Average direct influence matrix.
Table 6. Average direct influence matrix.
Code12345678910111213
IB10.0003.4673.0673.2000.0000.0000.0001.0671.0001.1892.3332.5330.000
IB23.7330.0002.8002.8670.0000.0000.0001.1330.9331.1332.2672.0000.000
IB33.2003.1330.0003.3330.0000.0000.0001.0000.6671.5332.2002.3330.000
IB42.9333.0003.2000.0000.0000.0000.0000.9591.0671.3332.2002.1330.000
IB52.3332.3332.2672.2000.0003.6670.0001.3331.4671.4001.1331.0670.000
IB62.4672.4002.0672.1333.6000.0000.0001.4001.6001.5331.2671.3330.000
IB72.0002.1331.5332.2003.3333.5330.0001.1331.0671.2671.3331.5330.000
IB80.0000.0000.0000.0000.0000.0000.0000.0003.6003.6670.0000.0000.000
IB90.0000.0000.0000.0000.0000.0000.0003.4670.0003.5330.0000.0000.000
IB100.0000.0000.0000.0000.0000.0000.0003.3333.5330.0000.0000.0000.000
IB110.0000.0000.0000.0000.0000.0000.0002.6672.4673.0000.0003.0670.000
IB120.0000.0000.0000.0000.0000.0000.0003.0673.1332.9333.2000.0000.000
IB131.8672.0002.5332.2673.5333.3330.0001.0001.2001.1331.4671.4000.000
Table 7. Normalized average direct influence matrix.
Table 7. Normalized average direct influence matrix.
Code12345678910111213
IB10.0000.1600.1410.1470.0000.0000.0000.0490.0460.0550.1070.1170.000
IB20.1720.0000.1290.1320.0000.0000.0000.0520.0430.0520.1040.0920.000
IB30.1470.1440.0000.1530.0000.0000.0000.0460.0310.0710.1010.1070.000
IB40.1350.1380.1470.0000.0000.0000.0000.0440.0490.0610.1010.0980.000
IB50.1070.1070.1040.1010.0000.1690.0000.0610.0670.0640.0520.0490.000
IB60.1130.1100.0950.0980.1660.0000.0000.0640.0740.0710.0580.0610.000
IB70.0920.0980.0710.1010.1530.1630.0000.0520.0490.0580.0610.0710.000
IB80.0000.0000.0000.0000.0000.0000.0000.0000.1660.1690.0000.0000.000
IB90.0000.0000.0000.0000.0000.0000.0000.1600.0000.1630.0000.0000.000
IB100.0000.0000.0000.0000.0000.0000.0000.1530.1630.0000.0000.0000.000
IB110.0000.0000.0000.0000.0000.0000.0000.1230.1130.1380.0000.1410.000
IB120.0000.0000.0000.0000.0000.0000.0000.1410.1440.1350.1470.0000.000
IB130.0860.0920.1170.1040.1630.1530.0000.0460.0550.0520.0670.0640.000
Table 8. The total relation matrix result.
Table 8. The total relation matrix result.
Code12345678910111213Row Total
IB10.1040.2390.2200.2280.0000.0000.0000.2160.2110.2350.2220.2280.0001.904
IB20.2480.0990.2080.2130.0000.0000.0000.2100.2000.2240.2140.2040.0001.820
IB30.2320.2270.0960.2320.0000.0000.0000.2100.1960.2420.2150.2190.0001.869
IB40.2170.2170.2200.0940.0000.0000.0000.2030.2040.2300.2090.2060.0001.802
IB50.2310.2280.2180.2190.0290.1740.0000.2450.2500.2630.1830.1800.0002.220
IB60.2340.2290.2100.2150.1700.0290.0000.2530.2600.2730.1890.1900.0002.253
IB70.2380.2400.2080.2380.1850.1940.0000.2610.2600.2830.2100.2170.0002.534
IB80.0000.0000.0000.0000.0000.0000.0000.0670.2120.2140.0000.0000.0000.492
IB90.0000.0000.0000.0000.0000.0000.0000.2020.0670.2080.0000.0000.0000.477
IB100.0000.0000.0000.0000.0000.0000.0000.1960.2060.0670.0000.0000.0000.469
IB110.0000.0000.0000.0000.0000.0000.0000.2140.2100.2310.0210.1440.0000.820
IB120.0000.0000.0000.0000.0000.0000.0000.2380.2420.2380.1500.0210.0000.890
IB130.2410.2430.2560.2490.1930.1860.0000.2620.2700.2860.2230.2190.0002.629
Column total1.7461.7231.6361.6880.5780.5820.0002.7772.7882.9931.8371.8270.000λ = 0.120
Table 9. The degree of the barriers’ influence.
Table 9. The degree of the barriers’ influence.
CodePjQiPj + QiQiPjRank Based on Pj + QiGroup
IB11.5091.6933.2010.1847Cause
IB21.5391.6953.2330.1566Cause
IB31.4111.6113.0230.2008Cause
IB41.4791.7393.2180.2609Cause
IB50.5552.1142.6691.55910Cause
IB60.5512.1442.6961.59311Cause
IB70.0002.4742.4742.47413Cause
IB82.7080.3493.057−2.3591Effect
IB92.5090.3772.886−2.1323Effect
IB102.7060.3943.101−2.3122Effect
IB111.8180.7312.549−1.0864Effect
IB121.7550.7932.549−0.9625Effect
IB130.0002.4252.4252.42512Cause
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

An, Q.; Bi, X.; Xu, Y.; Chong, H.-Y.; Liao, X. Analyzing Barriers of BIM and Blockchain Integration: A Hybrid ISM-DEMATEL Approach. Buildings 2025, 15, 1370. https://doi.org/10.3390/buildings15081370

AMA Style

An Q, Bi X, Xu Y, Chong H-Y, Liao X. Analyzing Barriers of BIM and Blockchain Integration: A Hybrid ISM-DEMATEL Approach. Buildings. 2025; 15(8):1370. https://doi.org/10.3390/buildings15081370

Chicago/Turabian Style

An, Qi, Xinhua Bi, Yongshun Xu, Heap-Yih Chong, and Xiaofeng Liao. 2025. "Analyzing Barriers of BIM and Blockchain Integration: A Hybrid ISM-DEMATEL Approach" Buildings 15, no. 8: 1370. https://doi.org/10.3390/buildings15081370

APA Style

An, Q., Bi, X., Xu, Y., Chong, H.-Y., & Liao, X. (2025). Analyzing Barriers of BIM and Blockchain Integration: A Hybrid ISM-DEMATEL Approach. Buildings, 15(8), 1370. https://doi.org/10.3390/buildings15081370

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
