Lean and Flexible Project Delivery
Abstract
:1. Introduction
- (1)
- How to incorporate options for flexibility into project master schedules within the lean project delivery?
- (2)
- How to ascertain what is the ‘right’ level of flexibility to appropriately address risks and opportunities, and how to measure its value?
2. Materials and Methods
2.1. Theoretical Lens
2.1.1. Project Uncertainty
2.1.2. Resilient Approaches to Project Uncertainty
2.1.3. Lean Project Delivery and Practitioner Experience
2.2. Methodology
3. Results—Lean and Flexible Project Delivery: LPS® with Options
- 1.
- Implement a collaborative approach to define project value with accepted time-cost-risk estimates;
- 2.
- Develop a first draft master plan by applying lean principles for pull planning in a backward fashion from a selected completion date;
- 3.
- Assess project uncertainty, by the impact of changes in a systems perspective, disregarding the occurrence probability;
- 4.
- Manage uncertainty, by distinguishing between predictable and less predictable high-impact disruptions (where options may be needed);
- 5.
- Validate the project with the chosen level of flexibility, i.e., assess the value of the master plan with and without options, to prove with limited knowledge whether the project satisfies the goals from Step 1; adjust the goals or the plan (level of flexibility and/or buffers). Implement build-evaluate learning loops of Steps 1 ÷ 4, until the accepted trade-off between costs and benefits of flexibility is achieved;
- 6.
- Apply the established LPS® project control schedule (as described below) to progressively detail the alternative implementation pathways, to enable the selection of alternatives as execution approaches in time and relevant information is revealed.

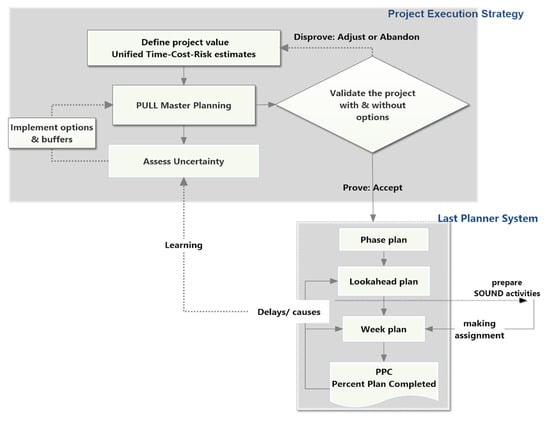

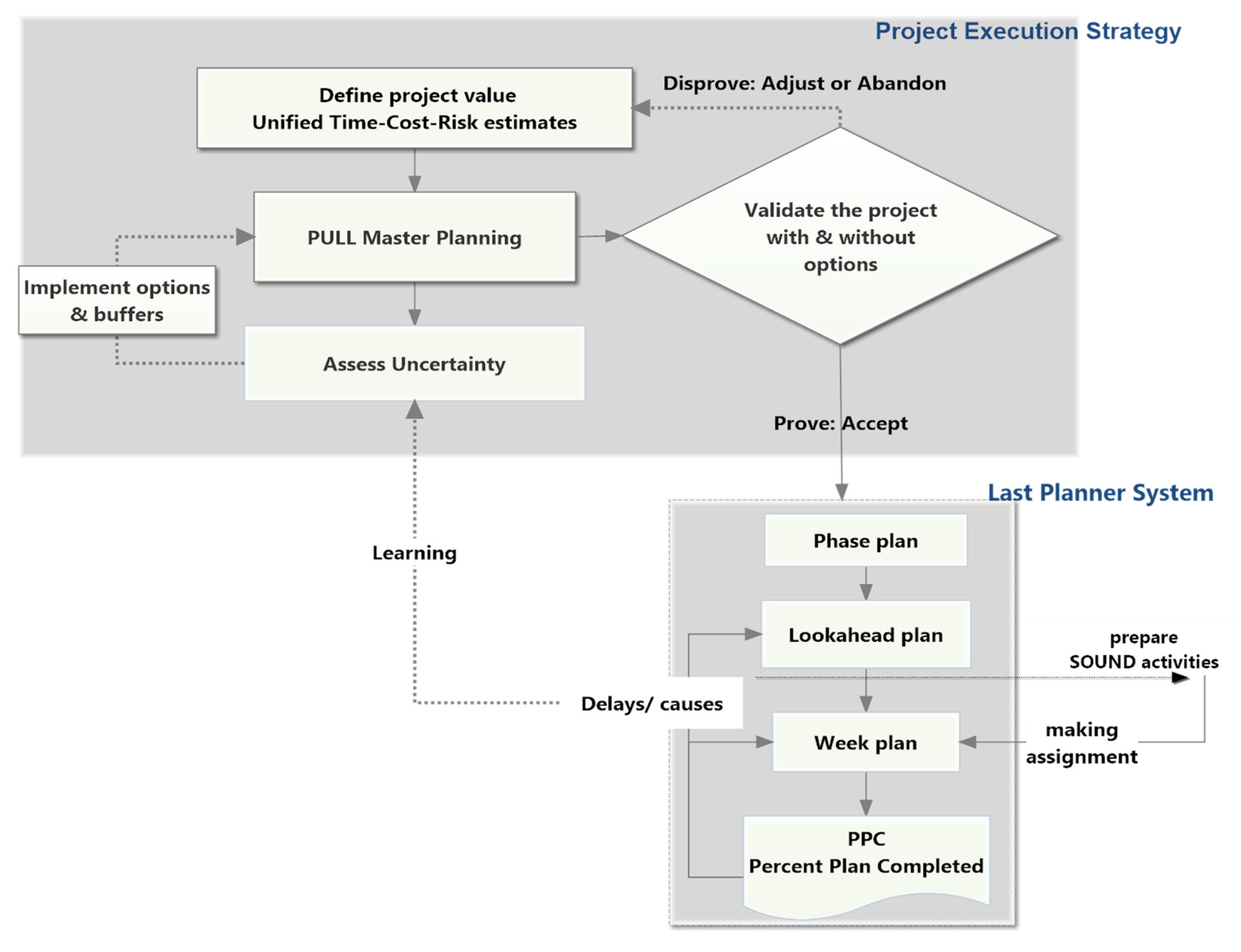

4. Discussion—The Utility of the Proposed Operational System
4.1. The Evaluation Process and Project Validation under Limited Knowledge
Activity | P0A | P0B | P1 | P2A | P2B | D0A | D0B | D1 | D2A | D2B | K |
Duration | 4 | 3 | 3 | 2 | 1 | 3 | 4 | 3 | 1 | 2 | 2 |
4.1.1. The Evaluation Process
4.1.2. Evaluation of the Different Planning Approaches
4.2. Utility Evaluation Using a Real Case
“We had enabling work in this project. We did pull planning, but it didn’t become a primary driver of the job. In XX hospital project we had to literally move a mountain (700,000CY of earth) before we could start construction. This was considered as an enabling project so it gave the designers ample time to get the project developed so design would not impact our construction schedule. However, our schedule process was as follows: We developed a Master Schedule or what we called a Validated Target Schedule (VTS) at the initial alignment meeting when YY conducted our offsite Business Case validation meeting. Next, we developed a Pull Schedule from the major milestones off the Master schedule with the major trade contractors. Then we refined the schedule as the design developed and conducted weekly work plans with the people or leaders of the teams that actually performed the work. We only tracked PPC, but we did our learning from our weekly analysis of our PPC and discussions stemming from that data at our weekly work plan meetings.”
5. Contributions and Conclusions
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Acknowledgments
Conflicts of Interest
References
- Hansen, M.J.; Vaagen, H.; Van Oorschot, K. Team collective intelligence in dynamically complex projects—A shipbuilding case. Proj. Manag. J. 2020, 51, 633–655. [Google Scholar] [CrossRef]
- Böhle, F.; Heidling, E.; Schoper, Y. A new orientation to deal with uncertainty in projects. Int. J. Proj. Manag. 2016, 34, 1384–1392. [Google Scholar] [CrossRef]
- Korhonen, T.; Laine, T.; Martinsuo, M. Management control of project portfolio uncertainty: A managerial role perspective. Proj. Manag. J. 2014, 45, 21–37. [Google Scholar] [CrossRef]
- Emblemsvåg, J. Lean project planning in shipbuilding. J. Ship Prod. Des. 2014, 30, 79–88. [Google Scholar] [CrossRef]
- Lenfle, S.; Loch, C. Lost roots: How project management came to emphasize control over flexibility and novelty. Calif. Manag. Rev. 2010, 53, 32–55. [Google Scholar] [CrossRef] [Green Version]
- Lenfle, S. Toward a genealogy of project management: Sidewinder and the management of exploratory projects. Int. J. Proj. Manag. 2014, 32, 921–931. [Google Scholar] [CrossRef]
- Vaagen, H.; Kaut, M.; Wallace, S.W. The impact of design uncertainty in engineer-to-order project planning. Eur. J. Oper. Res. 2017, 261, 1098–1109. [Google Scholar] [CrossRef] [Green Version]
- Kaut, M.; Vaagen, H.; Wallace, S.W. The combined impact of stochastic and correlated activity durations and design uncertainty on project plans. Int. J. Prod. Econ. 2021, 233, 108015. [Google Scholar] [CrossRef]
- Ramasesh, R.V.; Browning, T.R. A conceptual framework for tackling knowable unknown unknowns in project management. J. Oper. Manag. 2014, 32, 190–204. [Google Scholar] [CrossRef]
- Hällgren, M.; Maaninen-Olsson, E. Deviations, ambiguity and uncertainty in a project-intensive organization. Proj. Manag. J. 2005, 36, 17–26. [Google Scholar] [CrossRef]
- Petit, Y.; Hobbs, B. Project portfolios in dynamic environments: Sources of uncertainty and sensing mechanisms. Proj. Manag. J. 2010, 41, 46–58. [Google Scholar] [CrossRef]
- Padalkar, M.; Gopinath, S. Six decades of project management research: Thematic trends and future opportunities. Int. J. Proj. Manag. 2016, 34, 1305–1321. [Google Scholar] [CrossRef]
- Herroelen, W.; Leus, R. Project scheduling under uncertainty: Survey and research potentials. Eur. J. Oper. Res. 2005, 165, 289–306. [Google Scholar] [CrossRef] [Green Version]
- Jørgensen, T.; Wallace, S.W. Improving project cost estimation by taking into account managerial flexibility. Eur. J. Oper. Res. 2000, 127, 239–251. [Google Scholar] [CrossRef]
- King, A.J.; Wallace, S.W. Modeling with Stochastic Programming; Springer Science & Business Media: New York, NY, USA, 2012. [Google Scholar]
- Jaafari, A. Management of risks, uncertainties and opportunities on projects: Time for a fundamental shift. Int. J. Proj. Manag. 2001, 19, 89–101. [Google Scholar] [CrossRef]
- Ward, S.; Chapman, C. How to Manage Project Opportunity and Risk: Why Uncertainty Management Can Be a Much Better Approach Than Risk Management; John Wiley & Sons: Hoboken, NJ, USA, 2011. [Google Scholar]
- Maylor, H.; Turner, N.; Murray-Webster, R. “It worked for manufacturing…!”: Operations strategy in project-based operations. Int. J. Proj. Manag. 2015, 33, 103–115. [Google Scholar] [CrossRef]
- Nichols, K. Getting engineering changes under control. J. Eng. Des. 1990, 1, 5–15. [Google Scholar] [CrossRef]
- Pich, M.T.; Loch, C.H.; Meyer, A.D. On uncertainty, ambiguity, and complexity in project management. Manag. Sci. 2002, 48, 1008–1023. [Google Scholar] [CrossRef]
- Atkinson, R.; Crawford, L.; Ward, S. Fundamental uncertainties in projects and the scope of project management. Int. J. Proj. Manag. 2006, 24, 687–698. [Google Scholar] [CrossRef]
- Sutcliffe, W. Managing the Unexpected: Assuring High Performance in an Age of Complexity; John Wiley & Sons: Hoboken, NJ, USA, 2006. [Google Scholar]
- Servranckx, T.; Vanhoucke, M. A tabu search procedure for the resource-constrained project scheduling problem with alternative subgraphs. Eur. J. Oper. Res. 2019, 273, 841–860. [Google Scholar] [CrossRef]
- Huchzermeier, A.; Loch, C.H. Project management under risk: Using the real options approach to evaluate flexibility in R&D. Manag. Sci. 2001, 47, 85–101. [Google Scholar]
- Wied, M.; Koch-Ørvad, N.; Welo, T.; Oehmen, J. Managing exploratory projects: A repertoire of approaches and their shared underpinnings. Int. J. Proj. Manag. 2020, 38, 75–84. [Google Scholar] [CrossRef]
- Ward, S.; Chapman, C. Transforming project risk management into project uncertainty management. Int. J. Proj. Manag. 2003, 21, 97–105. [Google Scholar] [CrossRef]
- Wallace, S.W. Stochastic programming and the option of doing it differently. Ann. Oper. Res. 2010, 177, 3–8. [Google Scholar] [CrossRef]
- Braglia, M.; Dallasega, P.; Marrazzini, L. Overall Construction Productivity: A new lean metric to identify construction losses and analyse their causes in Engineer-to-Order construction supply chains. Prod. Plan. Control 2020, 1–18. [Google Scholar] [CrossRef]
- Kujala, S.; Artto, K.; Aaltonen, P.; Turkulainen, V. Business models in project-based firms—Towards a typology of solution-specific business models. Int. J. Proj. Manag. 2010, 28, 96–106. [Google Scholar] [CrossRef] [Green Version]
- Braglia, M.; Frosolini, M. An integrated approach to implement project management information systems within the extended enterprise. Int. J. Proj. Manag. 2014, 32, 18–29. [Google Scholar] [CrossRef]
- Hazir, O.; Ulusoy, G. A classification and review of approaches and methods for modeling uncertainty in projects. Int. J. Prod. Econ. 2019, 223, 10752. [Google Scholar] [CrossRef]
- Tillmann, P.; Ballard, G.; Tzortzopolous, P.; Formoso, C. How Integrated Governance Contributes to Value Generation—Insights from an IPD Case Study. In Proceedings of the 20th Annual Conference of the International Group for Lean Construction, San Diego, CA, USA, 18–20 July 2012. [Google Scholar]
- Ballard, G. Lean Project Delivery System; Lean Construction Institute: Arlington, VA, USA, 2000; Available online: https://leanconstruction.org (accessed on 26 August 2021).
- Engebø, A.; Lædre, O.; Young, B.; Larssen, F.; Lohne, J.; Klakegg, O.J. Collaborative project delivery methods: A scoping review. J. Civ. Eng. Manag. 2020, 26, 278–303. [Google Scholar] [CrossRef]
- Svejvig, P.; Schlichter, B.R. The long road to benefits management: Toward an integrative management model. Proj. Manag. J. 2020, 51, 312–327. [Google Scholar] [CrossRef]
- Ballard, G.; Tommelein, I. Current Process Benchmark for the Last Planner (R) System of Project Planning and Control. 2021. Available online: p2sl.berkeley.edu/Benchmarks (accessed on 27 September 2021).
- Al Sehaimi, A.O.; Fazenda, P.T.; Koskela, L. Improving construction management practice with the Last Planner System: A case study. Eng. Constr. Archit. Manag. 2014, 21, 51–64. [Google Scholar] [CrossRef] [Green Version]
- Solaimani, S.; Talab, A.H.; van der Rhee, B. An integrative view on Lean innovation management. J. Bus. Res. 2019, 105, 109–120. [Google Scholar] [CrossRef]
- Mesa, H.A.; Molenaar, K.R.; Alarcón, L.F. Comparative analysis between integrated project delivery and lean project delivery. Int. J. Proj. Manag. 2019, 37, 395–409. [Google Scholar] [CrossRef]
- Ward, A.; Liker, J.K.; Cristiano, J.J.; Sobek, D.K. The second Toyota paradox: How delaying decisions can make better cars faster. Sloan Manag. Rev. 1995, 36, 43. [Google Scholar]
- Voordijk, H. Construction management and economics: The epistemology of a multidisciplinary design science. Constr. Manag. Econ. 2009, 27, 713–720. [Google Scholar] [CrossRef]
- Ballard, G.; Vaagen, H. Project Flexibility and Lean Construction. In Proceedings of the 25th Annual Conference of the International Group for Lean Construction, Heraklion, Greece, 9–12 July 2017. [Google Scholar]
- Van de Vonder, S.; Demeulemeester, E.; Leus, R.; Herroelen, W. Proactive-reactive project scheduling-trade-offs and procedures. Int. Ser. Oper. Res. Manag. Sci. 2006, 92, 25. [Google Scholar]
- Herroelen, W.; Leus, R.; Demeulemeester, E. Critical chain project scheduling—Do not oversimplify. Proj. Manag. J. 2002, 33, 46–60. [Google Scholar] [CrossRef]
- Vaagen, H.; Aas, B. A multidisciplinary framework for robust planning and decision-making in dynamically changing engineering construction projects. In Proceedings of the IFIP International Conference on Advances in Production Management Systems, Ajaccio, France, 20–24 September 2014; Springer: Berlin/Heidelberg, Germany, 2014. [Google Scholar]
- Lechler, T.G.; Edington, B.H.; Gao, T. Challenging classic project management: Turning project uncertainties into business opportunities. Proj. Manag. J. 2012, 43, 59–69. [Google Scholar] [CrossRef]
- Dixit, R.K.; Pindyck, R.S. Investment under Uncertainty; Princeton University Press: Princeton, NJ, USA, 2012. [Google Scholar]
- Simchi-Levi, D. Operations Rules: Delivering Customer Value through Flexible Operations; MIT Press: Cambridge, MA, USA, 2010. [Google Scholar]
- Creemers, S.; De Reyck, B.; Leus, R. Project planning with alternative technologies in uncertain environments. Eur. J. Oper. Res. 2015, 242, 465–476. [Google Scholar] [CrossRef] [Green Version]
- Ibadov, N.; Kulejewski, J. Construction projects planning using network model with the fuzzy decision node. Int. J. Environ. Sci. Technol. 2019, 16, 4347–4354. [Google Scholar] [CrossRef] [Green Version]
- Ward, A.C.; Sobek, D.K., II. Lean Product and Process Development; Lean Enterprise Institute: Cambridge, MA, USA, 2014. [Google Scholar]
- Vaagen, H.; Wallace, S.W. Product variety arising from hedging in the fashion supply chains. Int. J. Prod. Econ. 2008, 114, 431–455. [Google Scholar] [CrossRef]
- Vaagen, H.; Wallace, S.W.; Kaut, M. The value of numerical models in quick response assortment planning. Prod. Plan. Control 2011, 22, 221–236. [Google Scholar] [CrossRef]
- Gao, S.; Low, S.P. The Last Planner System in China’s construction industry—A SWOT analysis on implementation. Int. J. Proj. Manag. 2014, 32, 1260–1272. [Google Scholar] [CrossRef]
- Garza, J.M.; Leong, M.-W. Last Planner technique: A case study. In Proceedings of the Construction Congress VI: Building Together for a Better Tomorrow in an Increasingly Complex World, Orlando, FL, USA, 20–22 February 2000. [Google Scholar]
- Tzortzopoulos, P.; Kagioglou, M.; Koskela, L. Lean Construction: Core Concepts and New Frontiers; Routledge: London, UK; New York, NY, USA, 2020. [Google Scholar]
- Ballard, G. The Lean Project Delivery System: An Update. Lean Constr. J. 2008, 1–19. [Google Scholar]
- Cook, K. Trust in Society; Russell Sage Foundation: New York, NY, USA, 2001. [Google Scholar]
- Priven, V.; Sacks, R. Social Network Development in Last Planner System™ Implementations. In Proceedings of the 21st Annual Conference of the International Group for Lean Construction, Fortaleza, Brazil, 29 July–2 August 2013. [Google Scholar]
- Priven, V.; Sacks, R. Effects of the last planner system on social networks among construction trade crews. J. Constr. Eng. Manag. 2015, 141, 04015006. [Google Scholar] [CrossRef]
- Ballard, G.; Vaagen, H.; Kay, B.; Stevens, B.; Pereira, M. Extending the Last Planner System® to the Entire Project. Lean Constr. J. 2020, 42–77. [Google Scholar]
- Korb, S.; Ballard, H.G. Believing is seeing: Paradigms as a focal point in the lean discourse. In Proceedings of the 26th Annual Conference of the International Group for Lean Construction, Chennai, India, 18–20 July 2018. [Google Scholar]
- Hevner, A.R.; March, S.T.; Park, J.; Ram, S. Design science in information systems research. MIS Q. 2004, 28, 75–105. [Google Scholar] [CrossRef] [Green Version]
- Kuechler, B.; Vaishnavi, V. On theory development in design science research: Anatomy of a research project. Eur. J. Inf. Syst. 2008, 17, 489–504. [Google Scholar] [CrossRef]
- Johnson, T.H.; Kaplan, R.S. Relevance Lost: The Rise and Fall of Management Accounting; Harvard Business School Press: Boston, MA, USA, 1987. [Google Scholar]
- Kasanen, E.; Lukka, K.; Siitonen, A. The constructive approach in management accounting research. J. Manag. Account. Res. 1993, 5, 243–264. [Google Scholar]
- Aken, J.E.V. Management research based on the paradigm of the design sciences: The quest for field-tested and grounded technological rules. J. Manag. Stud. 2004, 41, 219–246. [Google Scholar] [CrossRef]
- Peffers, K.; Tuunanen, T.; Rothenberger, M.A.; Chatterjee, S. A design science research methodology for information systems research. J. Manag. Inf. Syst. 2007, 24, 45–77. [Google Scholar] [CrossRef]
- Trullen, J.; Bartunek, J.M. What a design approach offers to organization development. J. Appl. Behav. Sci. 2007, 43, 23–40. [Google Scholar] [CrossRef]
- Manson, N.J. Is operations research really research? Orion 2006, 22, 155–180. [Google Scholar] [CrossRef] [Green Version]
- Holmström, J.; Ketokivi, M.; Hameri, A.P. Bridging practice and theory: A design science approach. Decis. Sci. 2009, 40, 65–87. [Google Scholar] [CrossRef]
- Meredith, J.R.; Raturi, A.; Amoako-Gyampah, K.; Kaplan, B. Alternative research paradigms in operations. J. Oper. Manag. 1989, 8, 297–326. [Google Scholar] [CrossRef]
- Formoso, C.T.; da Rocha, C.G.; Tzortzopoulos-Fazenda, P.; Koskela, L.; Tezel, A. Design Science Research in Lean Construction: An analysis of Process and Outcomes. In Proceedings of the 20th Annual Conference of the International Group for Lean Construction, San Diego, CA, USA, 18–20 July 2012. [Google Scholar]
- Venable, J.; Pries-Heje, J.; Baskerville, R. FEDS: A framework for evaluation in design science research. Eur. J. Inf. Syst. 2016, 25, 77–89. [Google Scholar] [CrossRef] [Green Version]
- Takeda, H.; Veerkamp, P.; Yoshikawa, H. Modeling design process. AI Mag. 1990, 11, 37. [Google Scholar]
- Simchi-Levi, D.; Schmidt, W.; Wei, Y.; Zhang, P.Y.; Combs, K.; Ge, Y.; Gusikhin, O.; Sanders, M.; Zhang, D. Identifying risks and mitigating disruptions in the automotive supply chain. Interfaces 2015, 45, 375–390. [Google Scholar] [CrossRef] [Green Version]
- Vaagen, H.; Masi, L. C IPD Methodology in Shipbuilding. In Proceedings of the IFIP International Conference on Advances in Production Management Systems; Springer: Cham, Switzerland, 2019; pp. 546–553. [Google Scholar]
- Browning, T.R. Applying the design structure matrix to system decomposition and integration problems: A review and new directions. IEEE Trans. Eng. Manag. 2001, 48, 292–306. [Google Scholar] [CrossRef] [Green Version]
- Manchinu, A.; McConnell, F. The SFI coding and classification system for ship information. In Proceedings of the REAPS Technical Symposium; Shipping Research Services Inc.: Alexandria, VA, USA, 1977. [Google Scholar]
- Ballard, G.; Tommelein, I. Current process benchmark for the Last Planner® System. Lean Constr. J. 2016, 89, 57–89. [Google Scholar]
- Christian, D.; Pereira, M. THE NEW LPS® 2.0 Metrics—What They Are, Why They Are Needed and Where They Are Used. Lean Constr. J. 2020, 119–140. [Google Scholar]
- Grau, D.; Cruz-Rios, F.; Sherman, R. Project validation—A novel practice to improve value and project performance. In Proceedings of the 27th Annual Conference of the International Group for Lean Construction, Dublin, Ireland, 1–7 July 2019; pp. 63–72. [Google Scholar]
- Nübel, K.; Bühler, M.M.; Jelinek, T. Federated Digital Platforms: Value Chain Integration for Sustainable Infrastructure Planning and Delivery. Sustainability 2021, 13, 8996. [Google Scholar] [CrossRef]
Lean Construction | Decisions under Uncertainty, Stochastic Optimization | Practitioner Experience |
---|---|---|
-Collaborative integration of phases and stakeholders, -LPS®, -PULL planning, -Last Responsible Moment (LRM), -Team learning, team responsiveness, -Lean/set-based design, -Control is proactive and reactive. | -Guidelines for flexibility assessment, -Options for flexibility, -Multi-stage decision process, -Minimal information needed for decisions, -The quantified value of proactive vs. reactive planning, -The impact of design changes, -The impact hierarchy of multiple uncertainties, -Control is proactive and reactive. | -Lean strategies, such as collaborative concept phase planning and team learning, -Just-in-time, -Rapid prototyping, set-based planning, -Continuous risk assessment and mitigation through the project, -Adapting LPS to the entire project. |
Planning Strategy | Duration | Costs | Decision Maker |
---|---|---|---|

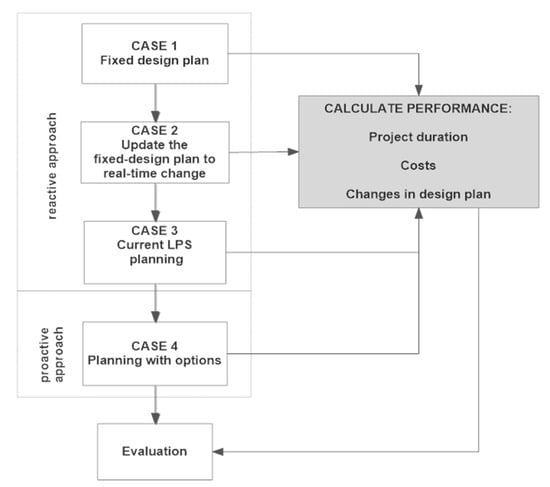

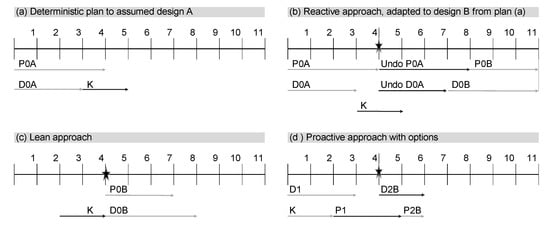

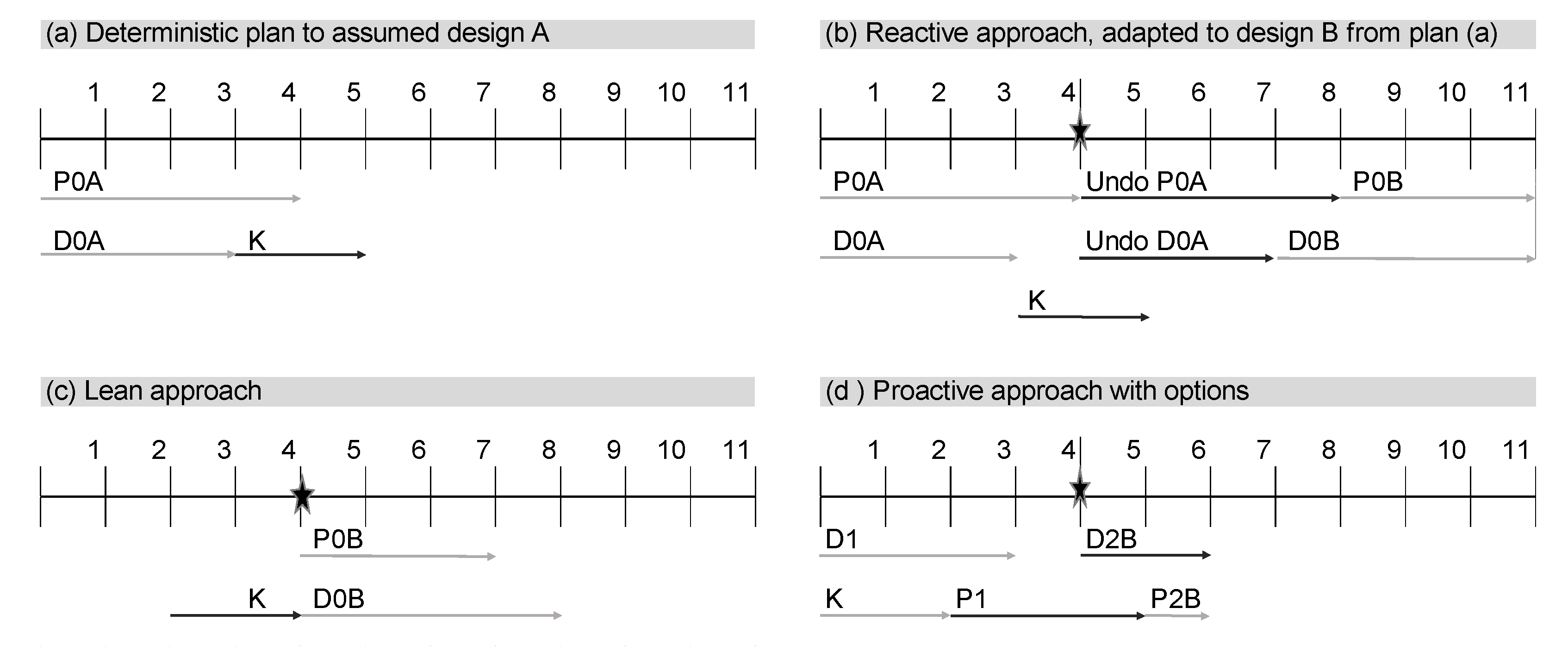

Case 1—Fixed design (A) plan | 5 | 9 | Believes to end up with this performance, |
Case 2—Reactive approach (Update Case 1 plan to design B) | 11 | 23.5 | but will end up with over 100% increase in time and costs. |
Case 3—Lean approach | 8 | 9 | Postponement and buffering. |
Case 4—Proactive approach with options | 6 | 11 | Flexibility to adapt changes with least time and costs. |
Planning Solution | Demand Satisfied | Lost Demand | Duration Subproject (Entire Project) | Costs Subproject (Entire Project) | |
---|---|---|---|---|---|

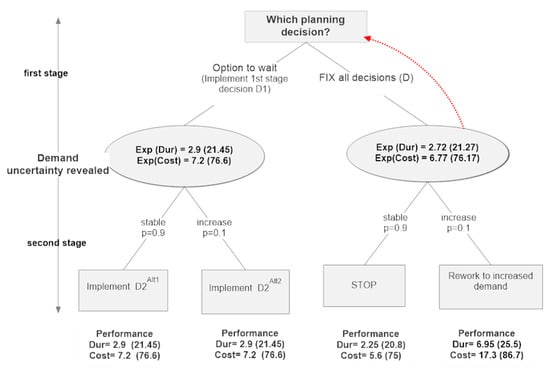

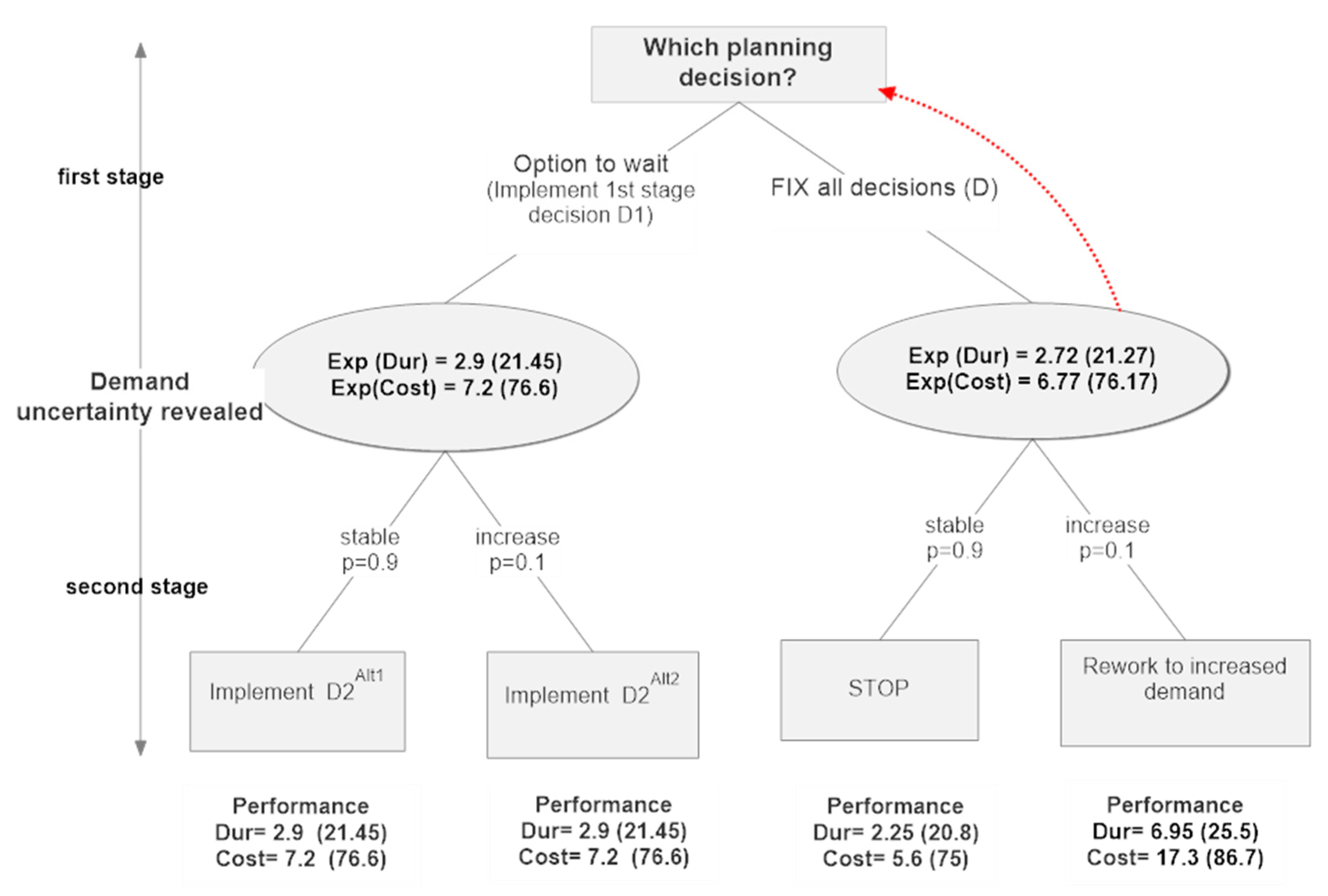

Demand scenario 1 | Deterministic | 10 | 0 | 2.25 (20.8) | 5.6 (75) |
Proactive | 10 | 0 | 2.9 (21.45) | 7.2 (76.6) | |
Demand scenario 2 | Deterministic | 10 | 10 | 2.25 (20.8) | 5.6 (75) |
Reactive | 20 | 0 | 6.95 (25.5) | 17.3 (86.7) | |
Proactive | 20 | 0 | 2.9 (21.5) | 7.2 (76.6) |
