Article

Using a Flexible Risk Priority Number Method to Reinforce Abilities of Imprecise Data Assessments of Risk Assessment Problems

by
Kuei-Hu Chang
1,*,
Tzu-Yi Fang
2 and
Zong-Sian Li
1,3
1
Department of Management Sciences, R.O.C. Military Academy, Kaohsiung 830, Taiwan
2
Department of Political Science, Fu Hsing Kang College, National Defense University, Beitou 112, Taiwan
3
Graduate Institute of Technology Management, National Chung Hsing University, Taichung 402, Taiwan
*
Author to whom correspondence should be addressed.
Electronics 2025, 14(3), 518; https://doi.org/10.3390/electronics14030518
Submission received: 27 December 2024 / Revised: 24 January 2025 / Accepted: 26 January 2025 / Published: 27 January 2025
(This article belongs to the Special Issue Advanced Research in Technology and Information Systems)

Abstract

:
Risk priority number (RPN) is the most commonly used failure risk ranking method among all risk assessment methods. However, the traditional RPN method not only cannot handle incomplete information and hesitation information (such as hesitation information between the s 5 = L o w and s 6 = M o d e r a t e ) provided by experts, but it also does not consider the objective weights of risk assessment factors. These reasons will lead to biased conclusions, causing decision makers to make wrong judgments. To address the limitations of the traditional RPN technique, the aim of this paper is to propose the flexible RPN assessment method under an uncertain environment. The flexible RPN assessment method is an extension of the traditional RPN technique. The flexible RPN method integrates the traditional RPN method and interval-valued 2-tuple weighted average method, and, simultaneously, considers subjective weights and objective weights. In the numerical verification, this study has adopted the example of stages of treatment planning for proton beam radiation therapy to verify the correctness and validity of the proposed flexible RPN technique. The numerical results show that the proposed flexible RPN technique not only handles the hesitation and incomplete information provided by experts but also considers the subjective and objective weights of risk assessment factors, providing more reasonable ranking results in the risk analysis.

1. Introduction

With the development of information technology and the arrival of the information age, the pursuit of high-quality systems or products has become the trend. Failure mode and effects analysis (FMEA) is one of the most commonly and widely used risk assessment tools. The purposes of FMEA are to provide early prevention of failure occurrences, reduce the impact of system failures on products, and improve product quality and market competitiveness. Therefore, many studies [1,2,3,4,5,6,7,8,9,10,11] have used the FMEA method to address practical issues related to risk assessment. Although the FMEA method is widely used for risk assessment, it still has several limitations, such as lacking consideration for the objective weight of risk factors and being unable to handle incomplete or uncertain information during information processing.
The traditional FMEA approach utilized risk priority number (RPN) to rank failure risk rating. The RPN score had the following risk assessment factors: severity (S), occurrence (O), and detection (D). The three risk assessment factors S, O, and D used an ordinal score of 1–10 to assess all of the potential failure modes. A higher RPN score means that the higher the risk level, the more the need for priority improvement measures. Because of the typical RPN method, simple calculations are widely used in various fields. For example, the ranking method based on ELECTRE was introduced by Liu, You, Chen, and Chen [12] to solve the issue of healthcare medical risk assessment in uncertain environments. Expanding the concept of data envelopment analysis (DEA), Chin et al. [13] developed interval DEA models to rank the failure modes risks. Chin et al. [13] used the geometric mean of the minimum and maximum risk of the failure mode as the overall risk of potential failure mode. Moreover, Yousefi et al. [14] introduced a robust DEA FMEA technique for the assessment of safety and environment risk prioritization in the automotive parts industry. They used S, O, and D indicators as input parameters, and duration of treatment and cost as output parameters to rank prioritization of safety and environmental risk. To increase the consideration of fuzzy information, Hosseinpour, Amirkhan, Rezaeian, and Doostideilami [15] combined the fuzzy decision-making trial and evaluation laboratory method with the fuzzy best–worst method to process risk assessment problems related to the food industry. Chang, Chen, and Liao [16] combined the 2-tuple fuzzy linguistic representation model with data envelopment analysis to process risk assessment problems of crawler cranes.
The typical RPN approach assumes that the three risk assessment factors, S, O, and D, are equally important [17,18,19]. However, the relative importance of these three risk assessment factors is not considered, which may lead to biased assessment results. Although the typical RPN approach has received great attention and has been used in the academic, industrial, and military fields, the typical RPN approaches have no consideration for the objective weight of risk assessment factors S, O, and D. Liu, Chan, and Ran [20] pointed out that to obtain more accurate and logical decision outcomes, subjective weights and objective weights must be simultaneously considered. Yu et al. [21] combined subjective and objective weight considerations to calculate risk factor weights, then integrated Fermatean fuzzy sets and the combined compromise solution method to address the failure risk assessment problems of liquefied natural gas storage tank leakage. Nowadays, many scholars combine the consideration of subjective and objective weights to solve decision-making problems in different fields [22,23,24,25,26,27,28,29,30,31,32,33].
Another limitation of the typical RPN approach is that it cannot handle incomplete or hesitant information during information processing. To process incomplete or hesitant information, the typical RPN approach will directly delete these messages and only process complete information. This technique will cause insufficient consideration of all available information, resulting in biased decision results. The interval value 2-tuple weighted average (IV2WA) method can solve the related problems of incomplete or hesitant information during the implementation of risk assessment. Akyuz and Celik [34], combining FMEA and interval type 2 fuzzy sets, proposed a new quantitative risk analysis method to conduct risk assessment in maritime transportation. Akyuz and Celik’s [34] research findings show that the incomplete information provided by local maritime authorities and poor organized coastline cleanup teams are the main causes of oil spills.
Recently, Zhang [35] introduced the IV2WA method as a useful tool to handle the multi-attribute group decision-making issues. Moreover, Zhang [35] introduced the accuracy function and the score function to compare the difference with the two interval-valued 2-tuples linguistic (IV2L) method. For the processing of incomplete information, the IV2WA method does not reference other experts to provide this failure mode’s useful information. This is due to the fact that the typical RPN approach cannot handle incomplete or hesitant information during information processing. In order to effectively address the limitations of the typical RPN approach, this paper proposes a flexible RPN method to enhance the ability to assess imprecise data in failure mode and effect analysis. For verification, the paper adopts the risk assessment of the stages of treatment planning for proton beam radiation therapy as a numerical example to validate the proposed flexible RPN method. The main advantages of the proposed flexible RPN method are as follows: for incomplete information processing, this study adopted other experts who provided useful and complete information to perform information filling of incomplete data. For aggregated information processing, the proposed flexible RPN method uses interval-valued 2-tuple information to handle complete, incomplete, and hesitation information during the information aggregation process. Moreover, the proposed method fully considers both subjective and objective weights of the risk assessment factors.
The remainder of this paper is organized as follows: Section 2 presents a brief introduction of FMEA, the interval 2-tuple linguistic model, the analytic hierarchy process (AHP) method, and the stepwise weight assessment ratio analysis (SWARA) method; Section 3 explains the theoretical background and calculation execution procedure of the proposed flexible RPN assessment method; Section 4 presents an illustrative example of stages of treatment planning for proton beam radiation therapy, which has been analyzed and compared with some common methods; and Section 5 offers a brief summary of this study and future possible research directions.

2. Preliminaries

This section features briefly reviewed definitions and operations of FMEA and the interval 2-tuple linguistic representation model (LRM), the AHP method, and the SWARA method, which are relevant to this study.

2.1. FMEA

The FMEA approach originated in the 1960s to solve issues related to safety and reliability requirements in the aerospace industry [36]. For its applicability to different purposes, different types of FMEA exist such as the process FMEA, design FMEA, machinery FMEA, service FMEA, and the system FMEA. Because the FMEA approach is easy for calculation and important for risk assessment, it is used by many internationally related standards such as ISO/TS 16949, IEC 60812, QS9000, BS 5760, MIL-STD-1629A, and SAE J1739 [3]. Today, a large amount of research combines FMEA with different calculation methods to address risk assessment issues in various fields. For example, Kan, Wei, Zhao, and Cao [37] combined the gray relational projection method and the VIKOR compromise ranking method (Serbian term: VlseKriterijumska Optimizacija I Kompromisno Resenje) to evaluate submarine pipeline risk. Liao, Hu, Zhang, Tang, and Banaitis [38] combined the best–worst method, the PROMETHEE-II method, and the hesitant fuzzy linguistic term set to assess the risk of the food cold chain.
The traditional FMEA method used severity (S), occurrence (O), and detection (D) of risk assessment factors to calculate RPN values. Table 1 shows the linguistic terms for the ratings of these three risk factors [12]. The RPN score is the product of the following three risk factors S, O, and D as indicated below:
R P N = S × O × D
The failure risk has a higher RPN score, which is more serious and critical and should be given higher risk priorities. In fact, the FMEA method is mainly used to provide early preventive actions before risk occurs.

2.2. Interval 2-Tuple LRM

Extending the definition of 2-tuple fuzzy LRM [39], Zhang [40] introduced the interval 2-tuple LRM as a generalization of 2-tuple fuzzy LRM. Some basic definitions about 2-tuple fuzzy LRM and interval 2-tuple LRM are stated subsequently:
Definition 1
([27,39]). Let  S = s 0 ,   s 1 , , s g  be an ordered set of linguistic terms, and  β [ 0 , g ]  be the values that support the symbolic aggregation operations result; the translation function   is utilized to obtain the equivalent information of β.
Δ : [ 0 , g ] S × [ 0.5 , 0.5 )
Δ ( β ) = ( s i , α ) ,   with s i , i = round ( β ) α = β i , α [ 0.5 , 0.5 )
where si has the label index closest to the index β, round (·) is the operation of the usual round, and α is the value of symbolic translation.
Definition 2
([27,40]). Let  S = s 0 ,   s 1 , , s g  be an ordered set of linguistic terms. The interval 2-tuple linguistic terms consist of two tuples, expressed by  s i , α 1 , s j , α 2 , where  i j . s i  and  s j  represent the linguistic term, and  α 1  and  α 2  are two crisp numbers representing the symbolic translation. It expresses the equivalent information as the interval 2-tuple and interval value  β 1 , β 2  ( β 1 β 2   a n d   β 1 , β 2 [ 0 ,   1 ] ) as the following function:
β 1 , β 2 = s i , α 1 , s j , α 2 w i t h   s i , s j , α 1 = β 1 i / g α 2 = β 2 i / g i = r o u n d ( β 1 · g ) j = r o u n d ( β 2 · g ) α 1 [ 0.5 / g , 0.5 / g ) α 2 [ 0.5 / g , 0.5 / g )
Definition 3
([27,40]). Let  S = s 0 ,   s 1 , , s g  be an ordered set of linguistic terms and  s i , α 1 , s j , α 2   be the IV2L. There is always a function  1 , such that  s i , α 1 , s j , α 2 can be converted to interval value  [ β 1 , β 2 ]   ( β 1 β 2   a n d   β 1 , β 2 [ 0 ,   1 ] ) as the following function:
1 s i , α 1 , s j , α 2 = i g + α 1 , j g + α 2
When   s i = s j   and  α 1 = α 2 , then the IV2L returns to a traditional 2-tuple linguistic.
Definition 4
([35,40]). Let  S = s 0 ,   s 1 , , s g  be an ordered set of linguistic terms. For an IV2L    A = s i , α 1 , s j , α 2 , then, the accuracy function  H ( A )  and score function  S ( A )  are explained by the following functions, respectively:
H A = j i / g + α 2 α 1
S A = i + j / 2 g + ( α 1 + α 2 ) / 2
where  0 H A 1  and  0 S A 1   .
Definition 5
([27,40]). Let  S = s 0 ,   s 1 , , s g  be an ordered set of linguistic terms.  A = s i , α 1 , s j , α 2  and  B = s k , α 3 , s l , α 4   are two IV2L models:
  • If  S A = S B , then:
      • (1)
        If  H A < H B , then  A > B ;
        (2)
        If  H A > H B , then  A < B ;
        (3)
        If  H A = H B , then  A = B .
        • If  S A > S B , then A > B ;
        • If  S A < S B , then  A < B .
Definition 6
([27,40]). Let  X = { s 1 , α 1 , t 1 , ε 1 ,   s 2 , α 2 , t 2 , ε 2 ,   , s n , α n , t n , ε n }   be a IV2L set, and  w = ( w 1 , w 2 , , w n ) T   be a corresponding related weights vector, with  i = 1 n w i = 1  and  w i [ 0 ,   1 ]   ( i = 1 , 2 , , n ). The interval value 2-tuple weighted average (IV2WA) operator is expressed as:
I V 2 W A X = i = 1 n w i 1 s i , α i , i = 1 n w i 1 t i , ε i
Definition 7
([27]). Let  a ~ = s 1 , α 1 , t 1 , ε 1  and  b ~ = s 2 , α 2 , t 2 , ε 2  be two IV2L models; the  a ~  distance from  b ~  is defined as:
d a ~ , b ~ = 1 2 1 s 1 , α 1 1 s 2 , α 2 + 1 t 1 , ε 1 1 t 2 , ε 2

2.3. AHP Method

The analytic hierarchy process (AHP) method is a subjective weight calculation method. It uses an initial pairwise comparison matrix (X) to calculate the subjective weights of evaluation criteria [41].
X = 1 x 12 x 1 n 1 x 12 1 x 2 n 1 x 1 n 1 x 2 n 1
According to the initial pairwise comparisons matrix, the maximum eigenvalue ( λ m a x ) is calculated, and the consistency index (CI) and consistency ratio (CR) are used to perform a consistency test [42,43]. If CR ≤ 0.1, it indicates that the initial pairwise comparisons matrix is reasonable.
X w = λ m a x w ,   j = 1 n w j = 1
C I = λ m a x n n 1
C R = C I R I

2.4. SWARA Method

The stepwise weight assessment ratio analysis (SWARA) method is an objective weight calculation method. It was first introduced by Keršuliene, Zavadskas, and Turskis [44], and uses stepwise and ratio values of different evaluation criteria to calculate the objective weights of evaluation criteria [45].
The calculation steps of the SWARA method are as follows [46,47].
(1)
The aggregated evaluation criterion values, t j , are sorted in descending order.
(2)
Calculate the comparative coefficient, k j .
k j = 1 j = 1 t j + 1 j > 1
(3)
Calculate the initial weights of the evaluation criteria, l j .
l j = 1 j = 1 l j 1 k j j > 1
(4)
Calculate the objective weights of the evaluation criteria, w j .
w j O W = l j j = 1 n l j ,   j = 1 ,   2 ,   3 , ,   n

3. Proposed Novel Flexible Risk Assessment Method

Today’s enterprise environment, with highly intensive competition, makes risk assessment a key issue for the sustainable development of an enterprise. It will affect how much capital of the company will be invested to prevent the occurrence of risks. In addition, the correctness of the risk assessment results will affect the quality of the products and market competitiveness. The RPN of FMEA method is one of the most commonly used practical approaches among all risk assessment methods. However, the traditional RPN method cannot handle incomplete information or hesitation information provided by experts. Moreover, the traditional RPN approach does not consider the subjective and objective weights of risk assessment factors S, O, and D. These restrictions of the traditional RPN technique will affect the risk assessment outcome, causing misjudgment by decision makers. To overcome these restrictions, this paper proposed a flexible RPN method, which integrates the IV2WA method and considers the integrated weights of risk assessment factors to handle issues related to risk assessment. A flow diagram of the proposed flexible RPN method is depicted in Figure 1.

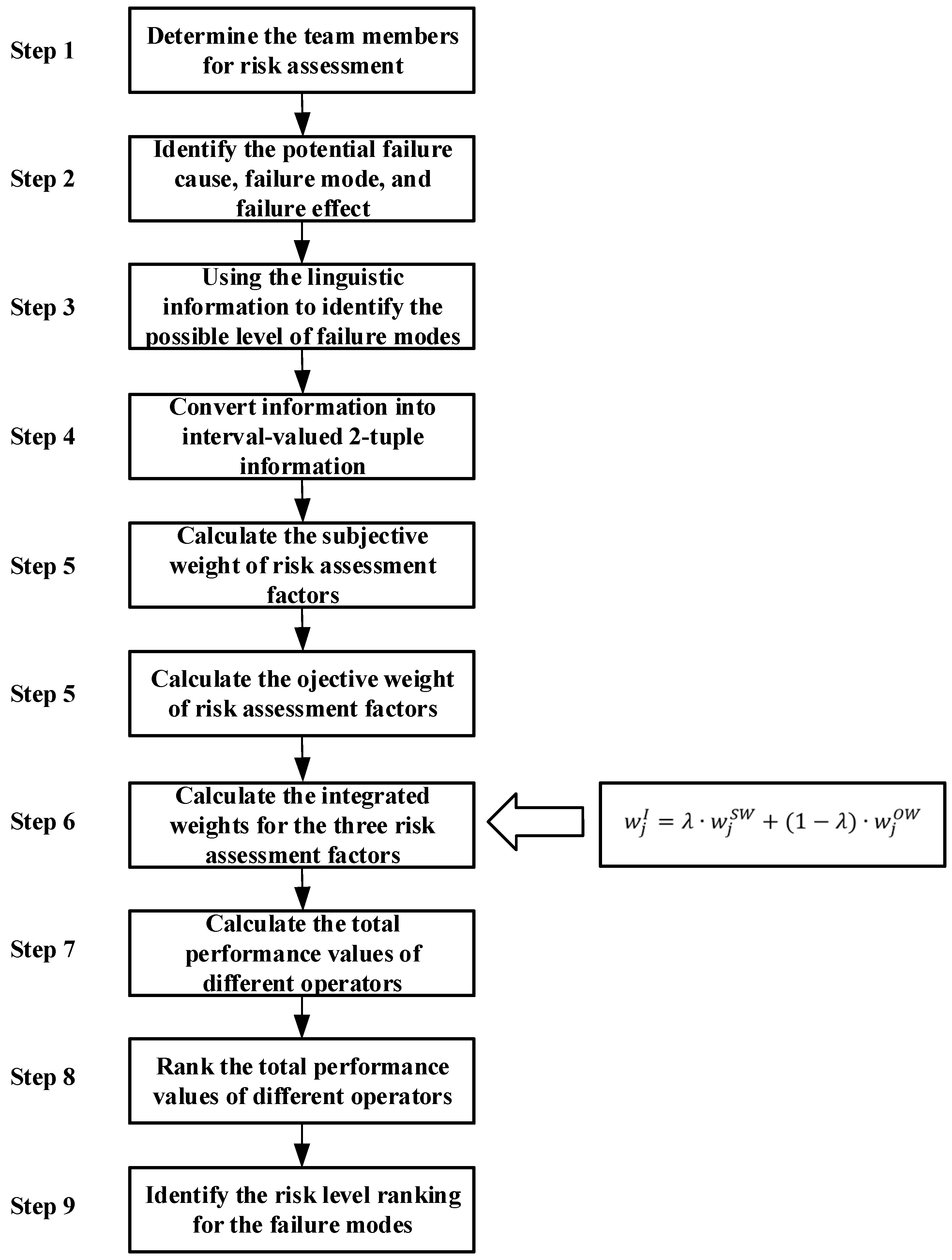

The procedure of the proposed flexible RPN approach is outlined as follows:
  • Step 1: Determine the team members for risk assessment.
This will be based on the different backgrounds and experience to form a cross-disciplinary risk assessment team.
  • Step 2: Identify the potential failure cause, failure mode, and failure effect.
Cross-disciplinary risk assessment team members discuss possible failure items and identify the potential failure cause, failure mode, and failure effect of these failure items.
  • Step 3: Use the linguistic information to identify the possible level of failure modes.
Every risk assessment team member uses the linguistic information to identify the level of failure modes and the risk assessment factors. The linguistic terms’ rating of three risk assessment factors is from s1 to s10, as shown in Table 1.
  • Step 4: Convert information into interval-valued 2-tuple information.
The interdisciplinary experts use 10 levels of linguistic terms to provide their linguistic assessments as follows:
S = { s 1 = A l m o s t   n o n e ,   s 2 = V e r y   s l i g h t ,   s 3 = S l i g h t ,   s 4 = V e r y   l o w ,   s 5 = L o w , s 6 = M o d e r a t e ,   s 7 = M o d e r a t e   h i g h ,   s 8 = H i g h ,   s 9 = V e r y   h i g h ,   s 10 = H a z a r d o u s }
(1)
If the information is a certain linguistic term such as “ V e r y   l o w ”, this can be expressed as ( s 4 , 0 , ( s 4 , 0 ) ] .
(2)
If the information is a certain linguistic term interval such as “ V e r y   l o w L o w ”, this can be expressed as ( s 4 , 0 , ( s 5 , 0 ) ] .
(3)
If the information is incomplete information, use the information of the maximum operator, minimum operator, or average operator to replace it.
  • Step 5: Calculate the subjective weight of risk assessment factors.
The subjective weights ( w j S W ) of risk assessment factors j are calculated using the AHP method.
  • Step 6: Calculate the objective weight of risk assessment factors.
The objective weights ( w j O W ) of risk assessment factors j are calculated using the SWARA method.
  • Step 7: Calculate the integrated weights for the three risk assessment factors.
The integrated weights of the jth criteria ( w j I ) can be calculated by the following equation:
w j I = λ · w j S W + ( 1 λ ) · w j O W
where w j S W and w j O W represent the subjective weight and objective weight, respectively. The value of the preference parameter ( λ ) represents the subjective preferences of experts. If experts cannot determine the value of the preference parameter ( λ ) , 0.5 is typically used as the baseline.
  • Step 8: Calculate the total performance values of different operators.
Use the maximum operator, minimum operator, and average operator to calculate the total performance values.
  • Step 9: Rank the total performance values of different operators.
Rank the total performance values of the failure modes from highest to lowest for the different operators.
  • Step 10: Identify the risk level ranking for the failure modes.
According to the calculation result of Step 9, use the fuzzy majority rule to identify the ranking of risk levels in ascending order.

4. Empirical Analysis

In this section, this paper uses an example of stages of treatment planning for proton beam radiation therapy (adapted from [12]) to explain the correctness and rationality of the proposed flexible RPN method.

4.1. Problem Description

Proton beam radiotherapy is a novel irradiation medical technique. Although proton beam radiotherapy can greatly improve the results after treatment, it also has some possible failure risks in the treatment planning stage. This paper probed the most critical failure modes of the stages of treatment planning for proton beam radiation therapy. There were nine failure modes as shown in Table 2 [12]. The FMEA assessment team consisted of five interdisciplinary experts (P1, P2…, P5) to evaluate the most critical failure modes for the proton beam radiation therapy. The backgrounds of the five experts include risk management, radiation oncology, medical physics, radiation dosimetry, and radiation protection. The five interdisciplinary experts’ assigned weights were equal. According to Table 1, five experts determined the pairwise comparisons matrix of evaluation criteria, as shown in Table 3, and evaluated the possible range of failure modes for three risk factors, as shown in Table 4 [12].

4.2. Solving the Case by the RPN Method

The traditional RPN method used the three risk assessment factors to indicate the failure risk scores. A higher RPN score means a higher risk level and the need to give resource priority to prevent the occurrence of malfunction. The traditional RPN technique can only handle complete information for the risk factors of failure modes. Therefore, it only considers complete information (P2 and P4 provided), and does not apply hesitation information (P1 and P3 provided) and incomplete information (P5 provided) in the risk assessment of proton beam radiotherapy. According to Table 1 and Table 3, use Equation (1) to calculate the RPN scores of every failure mode for the proton beam radiotherapy, as shown in Table 5.
The risk assessment factors of S, O, and D belong to an ordered scale. However, the traditional RPN method uses the product of three risk assessment factors to calculate the RPN score. The multiplication calculation is not meaningful for ordinal scales.

4.3. Solving the Case by the 2-Tuple RPN Method

The 2-tuple RPN method [48] uses the 2-tuple fuzzy linguistic representation method to express semantic information in the process of aggregated semantic information. The 2-tuple RPN method, like the traditional RPN approach, cannot handle hesitation information and incomplete information. Therefore, for assessment of the failure risk for the proton beam radiotherapy, it only considered P2 and P4, which provided complete information.
The arithmetic mean of 2-tuple x ¯ is explained as follows [48]:
x ¯ = j = 1 n 1 n 1 ( r j , α j ) = 1 n j = 1 n β j
where x = { r 1 , α 1 , r 2 , α 2 , . , r n , α n } is a set of 2-tuples.
According to Table 1 and Table 4, use Equation (16) to calculate the 2-tuple RPN values of every failure mode for the proton beam radiotherapy, as shown in Table 6.

4.4. Solving the Case by the IV2WA Method

Because the traditional FMEA approach cannot handle incomplete or hesitant information during information processing, the IV2WA method [35] can overcome these limitations. This method is capable of handling complete, incomplete, and hesitant information simultaneously. For incomplete information processing, the IV2WA method uses the linguistic interval between the minimum and maximum risk linguistic rating terms to replace incomplete information. All information provided by experts is handled by the interval-valued information to assess the failure risk of the proton beam radiotherapy. According to Table 1 and Table 3, use Equation (6) to calculate the overall performance values of every failure mode for the proton beam radiotherapy, as shown in Table 7.

4.5. Solving the Case by the Proposed Flexible RPN Method

The first step in the risk assessment case for proton beam radiation therapy using the proposed flexible RPN method was to determine the team members for the assessment. Next, they identified the potential causes of failure, failure modes, and failure effects (Table 2). Each risk assessment team member determined the pairwise comparisons matrix for the evaluation criteria, as shown in Table 3, and each risk assessment team member then used linguistic information to identify the levels of failure modes and the risk assessment factors (Table 4).
Step 4: Convert information into interval-valued 2-tuple information.
According to Table 3, the possible range of failure information can be converted into interval-valued 2-tuple information. To handle incomplete information, the information of the maximum operator, minimum operator, and average operator can be used. The information from the maximum operator, minimum operator, and average operator reflects a decision maker’s current degree of optimism, pessimism, and neutrality.
Use the maximum operator, minimum operator, and average operator to calculate the overall performance values; that is, the aggregated S, O, and D values of different operators. The results are shown in Table 8.
  • Step 5: Calculate the subjective weight of risk assessment factors.
According to Table 3, and using Equations (8) and (9) to calculate the subjective weight of risk assessment factors, the results are shown in Table 9.
  • Step 6: Calculate the objective weight of risk assessment factors.
According to Table 4, and using Equations (12)–(14), calculate the objective weight of risk assessment factors; the results are shown in Table 9.
  • Step 7: Calculate the integrated weights for the three risk assessment factors.
According to the results of Step 5 and Step 6, use Equation (15) to compute the integrated weights for the three risk assessment factors. The value of the preference parameter (λ) is typically set at the baseline of 0.5; calculation results are as shown in Table 9.
For example, when the subjective weight ( w j S W ) of risk assessment factor S is 0.545, the objective weight ( w j O W ) of risk assessment factor S is 0.585 in the maximum operator, and by Equation (10), it is found that
w j I = λ · w j S W + 1 λ · w j O W = 0.5 × 0.545 + ( 1 0.5 ) × 0.585 = 0.565
  • Step 8: Calculate the total performance values of different operators.
According to Table 8 and Table 9, use Equation (6) to calculate the total performance values of every failure mode for the proton beam radiotherapy, as shown in Table 10.
  • Step 9: Rank the total performance values of different operators.
  • Step 10: Identify the risk level ranking for the failure modes.
For different operators, the overall performance value of the failure mode is ranked from highest to lowest; the results are shown in Table 10. Based on the ranking results of the maximum operator, minimum operator, and average operator, the fuzzy majority rule is used to determine the risk level ranking in ascending order; the results are shown in Table 10.
For example, when the S value is Δ([0.800, 0.800]), the O value is Δ([0.300, 0.320]), and the D value is Δ([0.800, 0.800]), in the maximum operator of failure modes No. 1 (Table 8), the corresponding weights of risk assessment factors S, O, and D are 0.585, 0.102, and 0.313, respectively. The overall performance values of the failure modes are No. 1 (Table 10) as Δ([0.749, 0.751]).
I V 2 W A X = Δ ( 0.585 × 0.800 + 0.102 × 0.300 + 0.313 × 0.800 ,   0.585 × 0.800 + 0.102 × 0.300 + 0.313 × 0.800 ) = Δ ( [ 0.749 , 0.751 ] )

4.6. Comparison and Analysis

In order to prove the effectiveness and rationality of the proposed flexible RPN method, an illustration of the treatment planning stages for proton beam radiation therapy is performed in Section 4, using the same input data (Table 1, Table 2, Table 3 and Table 4) to compare the results of four different calculation methods (the traditional RPN method, 2-tuple RPN approach, IV2WA method, and flexible RPN method). Table 11 shows the comparison of the risk ranking results of different risk ranking methods. The main differences in the factors considered between the traditional RPN method, the 2-tuple RPN approach, the IV2WA method, and the flexible RPN method are shown in Table 12.
The traditional RPN approach and 2-tuple RPN method can only handle complete information and cannot process incomplete and hesitation information. If the information provided by the expert contains some hesitation information or incomplete information, all of the information provided by this expert will not be considered. Clearly, these two methods do not fully consider the information provided by all experts; hence, they will generate biased assessment results. However, both the IV2WA method and the proposed flexible RPN method use the linguistic interval to handle complete, incomplete, and hesitation information. Specifically, for incomplete information processing, the IV2WA method uses the linguistic interval between minimum and maximum risk linguistic rating terms to replace incomplete information. Moreover, the IV2WA method considers more information than both the traditional RPN approach and the 2-tuple RPN method. However, for the processing of incomplete information, the IV2WA method does not refer to other experts on this failure mode for the provision of useful information. The proposed flexible RPN method uses the maximum operator, minimum operator, and average operator of other experts to accommodate this failure mode, thus deriving useful information to calculate the overall performance values. Therefore, all useful information in the risk assessment process can be considered by the proposed flexible RPN method.
Furthermore, the traditional RPN method, 2-tuple RPN method, and IV2WA approach do not consider subjective and objective weights; they only consider the subjective weight of risk assessment factors. These approaches will cause biased evaluation results and inform wrong decision making. However, the proposed flexible RPN method fully considers all subjective weights and objective weights between the risk assessment factors, S, O, and D. In its consideration of objective weights, the proposed flexible RPN method applies the statistical distance method to calculate the objective weights of risk assessment factors. The risk ranking comparison between the proposed flexible RPN method and other different risk ranking methods is as shown in Figure 2.

4.7. Sensitivity Analysis

This article uses different combinations of subjective and objective weights to conduct a sensitivity analysis of risk assessment in the treatment planning stage of proton beam radiotherapy. The sensitivity analysis uses six different λ values ( λ = 0.0 , λ = 0.2 , λ = 0.4 , λ = 0.6 , λ = 0.8 , λ = 1.0 ) to compare the failure risk ranking results of different failure modes, as shown in Table 13.
Based on the results in Table 13, we can see that the failure risk ranking results for the failure modes are the same when the λ values are 0.2 and 0.4, as well as when they are 0.6 and 0.8. When the λ values are 0.0 and 0.2, the failure risk ranking results of the failure modes are only slightly different. Specifically, the ranking positions of failure modes No. 2 and No. 8 are inter-changed. When the λ values are 0.8 and 1.0, the ranking results of the failure risks for failure modes No. 1, No. 2, No. 3, No. 4, No. 5, No. 7, No. 8, and No. 9 are consistent.

5. Conclusions and Future Work

Risk prevention and effective risk control are the most important issues for the sustainable operation of enterprises. Many international standards apply the RPN method to rank failure risk prevention under limited resources. However, the traditional RPN approach has some restrictions. These restrictions limit the typical RPN method from handling issues of incomplete information and hesitant information in information processing. Moreover, most risk assessment methods have not considered the objective weights of risk assessment factors (S, O, and D), which can lead to deviations in results. In order to overcome these restrictions of the typical RPN approach, this study proposed a novel flexible RPN approach to enhance risk assessment abilities.
This paper used the risk assessment of the stages of treatment planning for proton beam radiation therapy as a numerical example to verify the correctness of the proposed flexible RPN method. The risk ranking result of failure modes from the proposed flexible RPN method is No. 1 > No. 9 > No. 3 > No. 6 > No. 5 > No. 7 > No. 8 > No. 2 > No. 4. This differs from the RPN method, which is No. 1 > No. 3 > No. 2 > No. 6 > No. 7 > No. 5 > No. 4, No. 8, No. 9. It also differs from the 2-tuple RPN approach [36], which is No. 1 > No. 3 > No. 2, No. 6 > No. 7, No. 8, No. 9 > No. 5 > No. 4, and from the IV2WA method [32], which is No. 1 > No. 3 > No. 8, No. 9 > No. 2, No. 6 > No. 7 > No. 5 > No. 4.
The contributions of the proposed flexible RPN method as applied research are as follows:
(1)
The proposed flexible RPN approach is not limited to considering only the risk assessment factors, S, O, and D. It can consider extra risk factors depending on the product or system characteristics.
(2)
The proposed flexible RPN method can handle incomplete information and hesitant information during the aggregated process of information processing.
(3)
The proposed flexible RPN method considers the subjective and objective weights among risk assessment factors, thereby avoiding deviation in results.
Although the proposed flexible RPN method can handle incomplete and hesitant information in risk assessment problems, it does not process different types of fuzzy cognitive information, such as intuitionistic fuzzy set information, Pythagorean fuzzy information, Fermatean fuzzy information, picture fuzzy set information, and spherical fuzzy information. Future researchers may explore the processing of these different types of fuzzy cognitive information for risk assessment problems. Future research directions can use the proposed flexible RPN method to solve ranking issues in different fields such as talent selection, resource allocation, supplier selection, and material selection, to mention but a few. On the other hand, subsequent researchers may also employ gray relational analysis to address the imprecise data in risk assessment problems.

Author Contributions

Conceptualization, K.-H.C., T.-Y.F. and Z.-S.L.; methodology, K.-H.C., T.-Y.F. and Z.-S.L.; validation, K.-H.C.; data curation, K.-H.C. and T.-Y.F.; writing—original draft preparation, K.-H.C., T.-Y.F. and Z.-S.L.; writing—review and editing, K.-H.C.; funding acquisition, K.-H.C. All authors have read and agreed to the published version of the manuscript.

Funding

The authors would like to thank the National Science and Technology Council, Taiwan, for financially supporting this research under Contract No. NSTC 113-2221-E-145-002-MY2 and NSTC 112-2221-E-145-003.

Data Availability Statement

The data presented in this study are available on request from the corresponding author.

Conflicts of Interest

The authors declare no conflicts of interest.

References

  1. Yahmadi, R.; Brik, K.; ben Ammar, F. Fuzzy risk priority number assessment for solar gel battery manufacturing defects. Eng. Fail. Anal. 2021, 124, 105327. [Google Scholar] [CrossRef]
  2. Okoro, U.G.; Mubaraq, A.; Olugu, E.U.; Lawal, S.A.; Wong, K.Y. A dynamic maintenance planning methodology for HVAC systems based on Fuzzy-TOPSIS and failure mode and effect analysis. J. Build. Eng. 2024, 98, 111326. [Google Scholar] [CrossRef]
  3. Chang, K.H.; Chung, H.Y.; Wang, C.N.; Lai, Y.D.; Wu, C.H. A new hybrid Fermatean fuzzy set and entropy method for risk assessment. Axioms 2023, 12, 58. [Google Scholar] [CrossRef]
  4. Chang, K.H.; Chang, Y.C.; Wen, T.C.; Cheng, C.H. An innovative approach integrating 2-tuple and LOWGA operators in process failure mode and effects analysis. Int. J. Innov. Comput. Inf. Control 2012, 8, 747–761. [Google Scholar]
  5. Kumari, S.; Ahmad, K.; Khan, Z.A.; Ahmad, S. Failure mode and effects analysis of common effluent treatment plants of humid sub-tropical regions using fuzzy based MCDM methods. Eng. Fail. Anal. 2023, 145, 107010. [Google Scholar] [CrossRef]
  6. Li, X.T. Personal information security risk assessment for E-waste recycling based on Fuzzy-GRA-TOPSIS and FMEA. IEEE Trans. Eng. Manag. 2024, 71, 8240–8250. [Google Scholar] [CrossRef]
  7. Basaran, S.; Ighagbon, O.A. Enhanced FMEA methodology for evaluating mobile learning platforms using grey relational analysis and fuzzy AHP. Appl. Sci. 2024, 14, 8844. [Google Scholar] [CrossRef]
  8. Liu, P.D.; Xu, Y.Q.; Li, Y. An FMEA decision support model for hotel risk assessment based on the risk tolerance of multi-type travelers and online reviews, Inform. Sciences 2025, 690, 121525. [Google Scholar] [CrossRef]
  9. Ding, R.; Liu, Z.H.; Xu, J.T.; Meng, F.P.; Sui, Y.; Men, X.H. A novel approach for reliability assessment of residual heat removal system for HPR1000 based on failure mode and effect analysis, fault tree analysis, and fuzzy Bayesian network methods. Reliab. Eng. Syst. Saf. 2021, 216, 107911. [Google Scholar] [CrossRef]
  10. Yener, Y.; Can, G.F. A FMEA based novel intuitionistic fuzzy approach proposal: Intuitionistic fuzzy advance MCDM and mathematical modeling integration. Expert Syst. Appl. 2021, 183, 115413. [Google Scholar] [CrossRef]
  11. Liu, J.W.; Wang, D.J.; Lin, Q.L.; Deng, M.K. Risk assessment based on FMEA combining DEA and cloud model: A case application in robot-assisted rehabilitation. Expert Syst. Appl. 2023, 214, 119119. [Google Scholar] [CrossRef]
  12. Liu, H.C.; You, J.X.; Chen, S.; Chen, Y.Z. An integrated failure mode and effect analysis approach for accurate risk assessment under uncertainty. IIE Trans. 2016, 48, 1027–1042. [Google Scholar] [CrossRef]
  13. Chin, K.S.; Wang, Y.M.; Poon, G.K.K.; Yang, J.B. Failure mode and effects analysis by data envelopment analysis. Decis. Support Syst. 2009, 48, 246–256. [Google Scholar] [CrossRef]
  14. Yousefi, S.; Alizadeh, A.; Hayati, J.; Baghery, M. HSE risk prioritization using robust DEA-FMEA approach with undesirable outputs: A study of automotive parts industry in Iran. Saf. Sci. 2018, 102, 144–158. [Google Scholar] [CrossRef]
  15. Hosseinpour, M.; Amirkhan, M.; Rezaeian, J.; Doostideilami, M. A risk assessment model for health supply chain based on hybrid fuzzy MCDM method. Int. J. Ind. Eng. Theory 2024, 31, 128–151. [Google Scholar]
  16. Chang, K.H.; Chen, Y.J.; Liao, C.C. A novel improved FMEA method using data envelopment analysis method and 2-tuple fuzzy linguistic model. Ann. Oper. Res. 2024, 341, 485–507. [Google Scholar] [CrossRef]
  17. Chakhrit, A.; Djelamda, I.; Bougofa, M.; Guetarni, I.H.M.; Bouafia, A.; Chennoufi, M. Integrating fuzzy logic and multi-criteria decision-making in a hybrid FMECA for robust risk prioritization. Qual. Reliab. Eng. Int. 2024, 40, 3555–3580. [Google Scholar] [CrossRef]
  18. Wu, Y.N.; Yong, X.K.; Tao, Y.; Zhou, J.L.; He, J.M.; Chen, W.J.; Yang, Y.Y. Investment monitoring key points identification model of big science research infrastructures—Fuzzy BWM-entropy-PROMETHEE II method. Socio-Econ. Plan. Sci. 2023, 86, 101461. [Google Scholar] [CrossRef]
  19. Sarwar, M.; Ali, G.; Chaudhry, N.R. Decision-making model for failure modes and effect analysis based on rough fuzzy integrated clouds. Appl. Soft Comput. 2023, 136, 110148. [Google Scholar] [CrossRef]
  20. Liu, S.; Chan, F.T.S.; Ran, W.X. Decision making for the selection of cloud vendor: An improved approach under group decision-making with integrated weights and objective/subjective attributes. Expert Syst. Appl. 2016, 55, 37–47. [Google Scholar] [CrossRef]
  21. Yu, J.X.; Ding, H.Y.; Yu, Y.; Wu, S.B.; Zeng, Q.Z.; Xu, Y. Risk assessment of liquefied natural gas storage tank leakage using failure mode and effects analysis with Fermatean fuzzy sets and CoCoSo method. Appl. Soft Comput. 2024, 154, 111334. [Google Scholar] [CrossRef]
  22. Garcia-Cascales, M.S.; Molina-Garcia, A.; Sanchez-Lozano, J.M.; Mateo-Aroca, A.; Munier, N. Multi-criteria analysis techniques to enhance sustainability of water pumping irrigation. Energy Rep. 2021, 7, 4623–4632. [Google Scholar] [CrossRef]
  23. Li, X.Z.; Wang, J.S.; Chen, X.C.; Sun, C.Y. Safety evaluation of steel temporary beam service status based on the combination weighting-fuzzy model of game theory. Math. Probl. Eng. 2023, 2023, 6271946. [Google Scholar] [CrossRef]
  24. Chou, S.Y.; Chang, Y.H.; Shen, C.Y. A fuzzy simple additive weighting system under group decision-making for facility location selection with objective/subjective attributes. Eur. J. Oper. Res. 2008, 189, 132–145. [Google Scholar] [CrossRef]
  25. Wang, T.C.; Lee, H.D. Developing a fuzzy TOPSIS approach based on subjective weights and objective weights. Expert Syst. Appl. 2009, 36, 8980–8985. [Google Scholar] [CrossRef]
  26. Rao, R.V.; Patel, B.K. A subjective and objective integrated multiple attribute decision making method for material selection. Mater. Des. 2010, 31, 4738–4747. [Google Scholar] [CrossRef]
  27. Liu, H.C.; Liu, L.; Wu, J. Material selection using an interval 2-tuple linguistic VIKOR method considering subjective and objective weights. Mater. Des. 2013, 52, 158–167. [Google Scholar] [CrossRef]
  28. Su, J.F.; Liu, H.Y.; Chen, Y.J.; Zhang, N.; Li, J.J. A novel multi-criteria decision making method to evaluate green innovation ecosystem resilience. Eng. Appl. Artif. Intel. 2025, 139, 109528. [Google Scholar] [CrossRef]
  29. Lee, P.T.W.; Lin, C.W.; Chung, Y.S. Comparison analysis for subjective and objective weights of financial positions of container shipping companies. Marit. Policy Manag. 2014, 41, 241–250. [Google Scholar] [CrossRef]
  30. Dai, N.T.; Kuang, X.; Tang, G.L. Differential weighting of objective versus subjective measures in performance evaluation: Experimental evidence. Eur. Account. Rev. 2018, 27, 129–148. [Google Scholar] [CrossRef]
  31. Wang, B.H.; Zhang, S. A subjective and objective integration approach of determining weights for trustworthy measurement. IEEE Access 2018, 6, 25829–25835. [Google Scholar] [CrossRef]
  32. Liu, L.L.; Wang, W.; Jiang, G.R.; Zhang, J. Identifying key node in multi-region opportunistic sensor network based on improved TOPSIS. Comput. Sci. Inf. Syst. 2021, 18, 1041–1056. [Google Scholar] [CrossRef]
  33. Zhang, R.T.; Zhao, B.T.; Xing, Y.P.; Bai, K.Y. A novel multicriteria decision-making approach with unknown weight information under q-rung orthopair fuzzy environment. Int. J. Intell. Syst. 2021, 36, 7309–7339. [Google Scholar] [CrossRef]
  34. Akyuz, E.; Celik, E. A quantitative risk analysis by using interval type-2 fuzzy FMEA approach: The case of oil spill. Marit. Policy Manag. 2018, 45, 979–994. [Google Scholar] [CrossRef]
  35. Zhang, H.M. The multiattribute group decision making method based on aggregation operators with interval-valued 2-tuple linguistic information. Math. Comput. Model. 2012, 56, 27–35. [Google Scholar] [CrossRef]
  36. Chang, K.H.; Chang, Y.C.; Lai, P.T. Applying the concept of exponential approach to enhance the assessment capability of FMEA. J. Intell. Manuf. 2014, 25, 1413–1427. [Google Scholar] [CrossRef]
  37. Kan, Z.; Wei, Y.M.; Zhao, T.Y.; Cao, J.T. Risk evaluation of submarine pipelines in FMEA by combination of gray relation projection and VIKOR method. Ocean Eng. 2024, 302, 117695. [Google Scholar] [CrossRef]
  38. Liao, H.C.; Hu, Z.Y.; Zhang, Z.Y.; Tang, M.; Banaitis, A. Outranking-based failure mode and effects analysis considering interactions between risk factors and its application to food cold chain management. Eng. Appl. Artif. Intel. 2023, 126, 106831. [Google Scholar] [CrossRef]
  39. Herrera, F.; Martinez, L. A 2-tuple fuzzy linguistic representation model for computing with words. IEEE Trans. Fuzzy Syst. 2000, 8, 746–752. [Google Scholar]
  40. Zhang, H.M. Some interval-valued 2-tuple linguistic aggregation operators and application in multiattribute group decision making. Appl. Math. Model. 2013, 37, 4269–4282. [Google Scholar] [CrossRef]
  41. Chang, K.H.; Chang, Y.C.; Chung, H.Y. A novel AHP-based benefit evaluation model of military simulation training systems. Math. Probl. Eng. 2015, 2015, 956757. [Google Scholar] [CrossRef]
  42. Zhang, J.H.; Zhan, Q.C.; Liang, H.P. Application research of artificial intelligence algorithms in energy-efficient design for low-carbon building landscapes. Int. J. Low-Carbon Technol. 2024, 1, 2814–2821. [Google Scholar] [CrossRef]
  43. Liu, X.X. Research on function optimization of electric vehicle charging stations based on user demand analysis: An empirical study using the Kano model and AHP method. Sustainability 2024, 16, 10783. [Google Scholar] [CrossRef]
  44. Keršuliene, V.; Zavadskas, E.K.; Turskis, Z. Selection of rational dispute resolution method by applying new step-wise weight assessment ratio analysis (Swara). J. Bus. Econ. Manag. 2010, 11, 243–258. [Google Scholar] [CrossRef]
  45. Debnath, K.; Roy, S.K.; Deveci, M.; Tomásková, H. Integrated MADM approach based on extended MABAC method with Aczel-Alsina generalized weighted Bonferroni mean operator. Artif. Intell. Rev. 2025, 58, 27. [Google Scholar] [CrossRef]
  46. Mishra, A.R.; Rani, P.; Saeidi, P.; Deveci, M.; Alrasheedi, A.F. Fermatean fuzzy score function and distance measure based group decision making framework for household waste recycling plant location selection. Sci. Rep. 2024, 14, 28106. [Google Scholar] [CrossRef]
  47. Bakioglu, G. Selection of sustainable transportation strategies for campuses using hybrid decision-making approach under picture fuzzy sets. Technol. Forecast. Soc. Change. 2024, 206, 123567. [Google Scholar] [CrossRef]
  48. Chang, K.H.; Wen, T.C.; Chung, H.Y. Soft failure mode and effects analysis using the OWG operator and hesitant fuzzy linguistic term sets. J. Intell. Fuzzy Syst. 2018, 34, 2625–2639. [Google Scholar] [CrossRef]
Figure 1. Flow chart of proposed flexible RPN technique.
Figure 1. Flow chart of proposed flexible RPN technique.
Electronics 14 00518 g001
Figure 2. The risk ranking comparison between the different risk ranking methods.
Figure 2. The risk ranking comparison between the different risk ranking methods.
Electronics 14 00518 g002
Table 1. Semantic terms for the ratings for typical risk factors.
Table 1. Semantic terms for the ratings for typical risk factors.
LevelsSOD
s1ANI (Almost no impact)ANH (Almost never happens)EH (Extremely high)
s2VSI (Very slight impact)VVL (Very very low)VVH (Very very high)
s3VMI (Very minor impact)VL (Very low)VH (Very high)
s4LI (Low impact)RL (Relatively low)MH (Medium High)
s5RLI (Relatively low impact)L (Low)M (Medium)
s6MI (Moderate impact)M (Medium)L (Low)
s7MHI (Medium to high impact)MH (Medium High)RL (Relatively low)
s8HI (High impact)VH (Very high)VL (Very low)
s9VHI (Very high impact)VVH (Very very high)VVL (Very very low)
s10EI (Extreme impact)EH (Extremely high)AWF (Almost will find)
Table 2. Planning stage FMEA of proton beam radiotherapy.
Table 2. Planning stage FMEA of proton beam radiotherapy.
ItemsPotential Failure ModePotential Failure CausePotential Failure Effect
No. 1Outdated manifestations of anatomyRelated to time delay for anatomical changesDose distribution mistake/dose delivery mistake
No. 2Inaccurate delineationHuman mistakeDose distribution mistake
No. 3Incorrect Hounsfield unit numbers’ manual assignmentHuman mistake or lack of documentation for referring cliniciansDose distribution mistake
No. 4The couch origin definition of coordinates is wrong (mall amount, in units of 2–3 mm)Human mistakeUnexpected normal tissue irradiated and loss of clinical target volume
No. 5Wrong gantry angle selection/bed frame rotation: the beam stops on a dangerous organOperators lack skillsPlan robustness low (uncertain range)
No. 6Wrong gantry angle selection/bed frame rotation: the light beam passes through unstable tissueOperators lack skillsPlan robustness low (uncertain range)
No. 7Wrong selection of physical beam model and/or computing gridHuman mistake due to time pressure or lack of skills Dose distribution mistake
No. 8Field isocenter definition is wrongHuman mistakeDose delivery mistake
No. 9Approval of wrong planHuman mistake, communication between operators failsDose delivery mistake
Table 3. The pairwise comparisons matrix of evaluation criteria.
Table 3. The pairwise comparisons matrix of evaluation criteria.
SOD
SP1122
P2133
P3122
P4122
P5133
OP11/211
P21/311
P31/211
P41/211
P51/311
DP11/211
P21/311
P31/211
P41/211
P51/311
Table 4. Linguistic evaluation of the possible range of failure.
Table 4. Linguistic evaluation of the possible range of failure.
ItemsSOD
P1P2P3P4P5P1P2P3P4P5P1P2P3P4P5
No. 1HIHIHIHIHIVLRLVL-RLVLVVLRLVLVLVLVVL
No. 2MIMIMIMHIRLIRLVLRLLRLL-RLLMLL
No. 3MHIMIMHIMHI*RLRLRLRL*RLLRLVLRL
No. 4LIRLIRLI-MIRLIRLIRL-LRLRLRLLLLLLL
No. 5HIHIHIHIHIVLRLRL-LRLRLVHMHMVHMH
No. 6HIVHIHIMHIHIVLRLVLVLVLMHMM-LMM
No. 7MHIHIMHIMIHIRLRLRLRLRLMMMMM
No. 8RLIRLIRLI-MIRLI*RLVLVLVL*VLVLVLVLRL
No. 9HIVHIHIMHIHIVL-RLVLVLVLVLLMMMMH
“*” represents missing or nonexistent data.
Table 5. Traditional RPN for the proton beam radiotherapy.
Table 5. Traditional RPN for the proton beam radiotherapy.
Failure ModesSODRPN
No. 1848256
No. 2746168
No. 3747196
No. 4546120
No. 5844128
No. 6845160
No. 7745140
No. 8538120
No. 9835120
Table 6. Two-tuple RPN values of the proton beam radiotherapy.
Table 6. Two-tuple RPN values of the proton beam radiotherapy.
Failure ModesSOD2-Tuple RPN
No. 1(s8, 0)(s4, −0.5)(s8, 0)(s7, −0.500)
No. 2(s7, −0.5)(s4, 0)(s6, 0)(s6, −0.500)
No. 3(s7, −0.5)(s4, 0)(s7, 0)(s6, −0.167)
No. 4(s5, 0)(s4, −0.5)(s6, 0)(s5, −0.167)
No. 5(s8, 0)(s4, 0)(s4, −0.5)(s5, 0.167)
No. 6(s8, 0)(s4, −0.5)(s5, 0)(s6, −0.500)
No. 7(s7, 0)(s4, 0)(s5, 0)(s5, 0.333)
No. 8(s5, 0)(s3, 0)(s8, 0)(s5, 0.333)
No. 9(s8, 0)(s3, 0)(s5, 0)(s5, 0.333)
Table 7. IV2WA values of the proton beam radiotherapy.
Table 7. IV2WA values of the proton beam radiotherapy.
Failure ModesP1P2P3P4P5Overall Performance Values
No. 1Δ([0.600, 0.600])Δ([0.667, 0.667])Δ([0.633, 0.667])Δ([0.633, 0.633])Δ([0.633, 0.633])Δ([0.633, 0.642])
No. 2Δ([0.533, 0.567])Δ([0.500, 0.500])Δ([0.500, 0.500])Δ([0.600, 0.600])Δ([0.500, 0.500])Δ([0.533, 0.542])
No. 3Δ([0.600, 0.600])Δ([0.533, 0.533])Δ([0.600, 0.600])Δ([0.633, 0.633])Δ([0.300, 0.900])Δ([0.592, 0.592])
No. 4Δ([0.467, 0.500])Δ([0.467, 0.467])Δ([0.500, 0.533])Δ([0.500, 0.500])Δ([0.533, 0.533])Δ([0.483, 0.500])
No. 5Δ([0.467, 0.467])Δ([0.533, 0.533])Δ([0.567, 0.600])Δ([0.500, 0.500])Δ([0.533, 0.533])Δ([0.517, 0.525])
No. 6Δ([0.500, 0.500])Δ([0.600, 0.600])Δ([0.533, 0.567])Δ([0.500, 0.500])Δ([0.533, 0.533])Δ([0.533, 0.542])
No. 7Δ([0.533, 0.533])Δ([0.567, 0.567])Δ([0.533, 0.533])Δ([0.500, 0.500])Δ([0.567, 0.567])Δ([0.533, 0.533])
No. 8Δ([0.567, 0.567])Δ([0.533, 0.533])Δ([0.533, 0.567])Δ([0.533, 0.533])Δ([0.300, 0.900])Δ([0.542, 0.550])
No. 9Δ([0.567, 0.600])Δ([0.567, 0.567])Δ([0.533, 0.533])Δ([0.500, 0.500])Δ([0.500, 0.500])Δ([0.542, 0.550])
Table 8. The aggregated S, O, and D values of different operators.
Table 8. The aggregated S, O, and D values of different operators.
Failure ModesMaximum OperatorMinimum OperatorAverage Operator
SODSODSOD
No. 1Δ([0.800, 0.800])Δ([0.300, 0.320])Δ([0.800, 0.800])Δ([0.800, 0.800])Δ([0.300, 0.320])Δ([0.800, 0.800])Δ([0.800, 0.800])Δ([0.300, 0.320])Δ([0.800, 0.800])
No. 2Δ([0.600, 0.600])Δ([0.400, 0.400])Δ([0.580, 0.600])Δ([0.600, 0.600])Δ([0.400, 0.400])Δ([0.580, 0.600])Δ([0.600, 0.600])Δ([0.400, 0.400])Δ([0.580, 0.600])
No. 3Δ([0.680, 0.680])Δ([0.400, 0.400])Δ([0.700, 0.700])Δ([0.660, 0.660])Δ([0.400, 0.400])Δ([0.700, 0.700])Δ([0.675, 0.675])Δ([0.400, 0.400])Δ([0.700, 0.700])
No. 4Δ([0.480, 0.500])Δ([0.400, 0.420])Δ([0.600, 0.600])Δ([0.480, 0.500])Δ([0.400, 0.420])Δ([0.600, 0.600])Δ([0.480, 0.500])Δ([0.400, 0.420])Δ([0.600, 0.600])
No. 5Δ([0.800, 0.800])Δ([0.380, 0.400])Δ([0.380, 0.380])Δ([0.800, 0.800])Δ([0.380, 0.400])Δ([0.380, 0.380])Δ([0.800, 0.800])Δ([0.380, 0.400])Δ([0.380, 0.380])
No. 6Δ([0.800, 0.800])Δ([0.320, 0.320])Δ([0.480, 0.500])Δ([0.800, 0.800])Δ([0.320, 0.320])Δ([0.480, 0.500])Δ([0.800, 0.800])Δ([0.320, 0.320])Δ([0.480, 0.500])
No. 7Δ([0.720, 0.720])Δ([0.400, 0.400])Δ([0.500, 0.500])Δ([0.720, 0.720])Δ([0.400, 0.400])Δ([0.500, 0.500])Δ([0.720, 0.720])Δ([0.400, 0.400])Δ([0.500, 0.500])
No. 8Δ([0.500, 0.540])Δ([0.340, 0.340])Δ([0.780, 0.780])Δ([0.500, 0.520])Δ([0.320, 0.320])Δ([0.780, 0.780])Δ([0.500, 0.525])Δ([0.325, 0.325])Δ([0.780, 0.780])
No. 9Δ([0.800, 0.800])Δ([0.300, 0.320])Δ([0.500, 0.500])Δ([0.800, 0.800])Δ([0.300, 0.320])Δ([0.500, 0.500])Δ([0.800, 0.800])Δ([0.300, 0.320])Δ([0.500, 0.500])
Table 9. Subjective, objective, and average weights of different operators.
Table 9. Subjective, objective, and average weights of different operators.
Maximum OperatorMinimum OperatorAverage Operator
SODSODSOD
Subjective weight0.5450.2270.2270.5450.2270.2270.5450.2270.227
Objective weight0.5850.1020.3130.5810.1030.3160.5840.1020.314
Average weight0.5650.1650.2700.5630.1650.2720.5650.1650.271
Table 10. Fuzzy majority rule ranking of the proton beam radiotherapy.
Table 10. Fuzzy majority rule ranking of the proton beam radiotherapy.
Failure ModesMaximum Operator Minimum Operator Average Operator Fuzzy Majority Rule
Overall Performance ValuesRankingOverall Performance ValuesRankingOverall Performance ValuesRanking
No. 1Δ([0.749, 0.751])1Δ([0.749, 0.751])1Δ([0.749, 0.751])11
No. 2Δ([0.573, 0.580])8Δ([0.573, 0.580])7Δ([0.573, 0.580])88
No. 3Δ([0.658, 0.658])2Δ([0.646, 0.646])4Δ([0.655, 0.655])33
No. 4Δ([0.509, 0.523])9Δ([0.509, 0.523])9Δ([0.509, 0.523])99
No. 5Δ([0.626, 0.628])5Δ([0.626, 0.628])5Δ([0.626, 0.628])55
No. 6Δ([0.651, 0.657])4Δ([0.651, 0.657])3Δ([0.651, 0.657])44
No. 7Δ([0.619, 0.619])6Δ([0.619, 0.619])6Δ([0.619, 0.619])66
No. 8Δ([0.571, 0.595])7Δ([0.569, 0.581])8Δ([0.570, 0.584])77
No. 9Δ([0.655, 0.657])3Δ([0.655, 0.657])2Δ([0.655, 0.657])22
Table 11. Risk ranking results’ comparison of the different risk ranking methods.
Table 11. Risk ranking results’ comparison of the different risk ranking methods.
Failure ModesTraditional RPN Method2-Tuple RPN MethodIV2WA MethodProposed Method
RPNRanking2-Tuple RPNRankingOverall Performance ValuesRankingMaximum OperatorMinimum OperatorAverage OperatorFuzzy Majority Rule
No. 12561(s7, −0.500)1Δ([0.633, 0.642])1Δ([0.749, 0.751])Δ([0.749, 0.751])Δ([0.749, 0.751])1
No. 21683(s6, −0.500)3Δ([0.533, 0.542])5Δ([0.573, 0.580])Δ([0.573, 0.580])Δ([0.573, 0.580])8
No. 31962(s6, −0.167)2Δ([0.592, 0.592])2Δ([0.658, 0.658])Δ([0.646, 0.646])Δ([0.655, 0.655])3
No. 41207(s5, −0.167)9Δ([0.483, 0.500])9Δ([0.509, 0.523])Δ([0.509, 0.523])Δ([0.509, 0.523])9
No. 51286(s5, 0.167)8Δ([0.517, 0.525])8Δ([0.626, 0.628])Δ([0.626, 0.628])Δ([0.626, 0.628])5
No. 61604(s6, −0.500)3Δ([0.533, 0.542])5Δ([0.651, 0.657])Δ([0.651, 0.657])Δ([0.651, 0.657])4
No. 71405(s5, 0.333)5Δ([0.533, 0.533])7Δ([0.619, 0.619])Δ([0.619, 0.619])Δ([0.619, 0.619])6
No. 81207(s5, 0.333)5Δ([0.542, 0.550])3Δ([0.571, 0.595])Δ([0.569, 0.581])Δ([0.570, 0.584])7
No. 91207(s5, 0.333)5Δ([0.542, 0.550])3Δ([0.655, 0.657])Δ([0.655, 0.657])Δ([0.655, 0.657])2
Table 12. The main differences lie in the factors considered by different risk ranking methods.
Table 12. The main differences lie in the factors considered by different risk ranking methods.
MethodFactors Consideration
Process the Hesitation InformationProcess the Incomplete InformationObjective Weight Consideration of Risk Assessment Factors
The RPN methodNoNoNo
The 2-tuple RPN approach [36]NoNoNo
The IV2WA method [32]YesYesNo
Proposed methodYesYesYes
Table 13. Risk ranking results for different α values.
Table 13. Risk ranking results for different α values.
α Value α = 0.0 α = 0.2
Failure ModesMaximum OperatorMinimum OperatorAverage OperatorFuzzy Majority RuleMaximum OperatorMinimum OperatorAverage OperatorFuzzy Majority Rule
No. 1Δ([0.749, 0.751])Δ([0.749, 0.751])Δ([0.749, 0.751])1Δ([0.735, 0.737])Δ([0.736, 0.739])Δ([0.737, 0.739])1
No. 2Δ([0.573, 0.580])Δ([0.573, 0.579])Δ([0.573, 0.580])8Δ([0.567, 0.573])Δ([0.568, 0.574])Δ([0.569, 0.575])7
No. 3Δ([0.658, 0.658])Δ([0.646, 0.646])Δ([0.655, 0.655])3Δ([0.649, 0.649])Δ([0.639, 0.639])Δ([0.648, 0.648])3
No. 4Δ([0.510, 0.523])Δ([0.510, 0.523])Δ([0.510, 0.523])9Δ([0.504, 0.518])Δ([0.506, 0.520])Δ([0.505, 0.520])9
No. 5Δ([0.624, 0.628])Δ([0.624, 0.626])Δ([0.625, 0.627])5Δ([0.621, 0.623])Δ([0.621, 0.624])Δ([0.622, 0.624])5
No. 6Δ([0.649, 0.657])Δ([0.649, 0.656])Δ([0.651, 0.657])4Δ([0.643, 0.649])Δ([0.643, 0.649])Δ([0.644, 0.650])4
No. 7Δ([0.619, 0.619])Δ([0.618, 0.618])Δ([0.618, 0.618])6Δ([0.613, 0.613])Δ([0.613, 0.613])Δ([0.614, 0.614])6
No. 8Δ([0.572, 0.595])Δ([0.570, 0.582])Δ([0.570, 0.585])7Δ([0.562, 0.585])Δ([0.560, 0.572])Δ([0.561, 0.575])8
No. 9Δ([0.654, 0.657])Δ([0.654, 0.656])Δ([0.655, 0.657])2Δ([0.646, 0.649])Δ([0.647, 0.649])Δ([0.647, 0.650])2
α value α = 0.4 α = 0.6
Failure modesMaximum operatorMinimum operatorAverage operatorFuzzy majority ruleMaximum operatorMinimum operatorAverage operatorFuzzy majority rule
No. 1Δ([0.724, 0.727])Δ([0.724, 0.727])Δ([0.723, 0.726])1Δ([0.711, 0.714])Δ([0.711, 0.714])Δ([0.712, 0.715])1
No. 2Δ([0.564, 0.570])Δ([0.564, 0.569])Δ([0.563, 0.569])7Δ([0.559, 0.564])Δ([0.559, 0.564])Δ([0.559, 0.565])7
No. 3Δ([0.643, 0.643])Δ([0.631, 0.631])Δ([0.640, 0.640])3Δ([0.635, 0.635])Δ([0.624, 0.624])Δ([0.633, 0.633])4
No. 4Δ([0.501, 0.516])Δ([0.501, 0.516])Δ([0.501, 0.515])9Δ([0.497, 0.511])Δ([0.497, 0.512)Δ([0.497, 0.512)9
No. 5Δ([0.619, 0.622])Δ([0.618, 0.621])Δ([0.618, 0.621])5Δ([0.615, 0.619])Δ([0.614, 0.618])Δ([0.616, 0.619])5
No. 6Δ([0.638, 0.643])Δ([0.637, 0.643])Δ([0.637, 0.643])4Δ([0.631, 0.636])Δ([0.630, 0.635])Δ([0.631, 0.636])3
No. 7Δ([0.610, 0.610])Δ([0.609, 0.609])Δ([0.609, 0.609])6Δ([0.605, 0.605])Δ([0.605, 0.605])Δ([0.606, 0.606])6
No. 8Δ([0.554, 0.577])Δ([0.551, 0.562])Δ([0.551, 0.565])8Δ([0.544, 0.567])Δ([0.541, 0.552])Δ([0.542, 0.556])8
No. 9Δ([0.640, 0.643])Δ([0.640, 0.643])Δ([0.640, 0.643])2Δ([0.632, 0.636])Δ([0.632, 0.635])Δ([0.633, 0.636])2
α value α = 0.8 α = 1.0
Failure modesMaximum operatorMinimum operatorAverage operatorFuzzy majority ruleMaximum operatorMinimum operatorAverage operatorFuzzy majority rule
No. 1Δ([0.698, 0.702])Δ([0.698, 0.702])Δ([0.698, 0.702])1Δ([0.686, 0.690])Δ([0.686, 0.690])Δ([0.686, 0.690])1
No. 2Δ([0.554, 0.559])Δ([0.554, 0.559])Δ([0.554, 0.559])7Δ([0.549, 0.554])Δ([0.549, 0.554])Δ([0.549, 0.554])7
No. 3Δ([0.628, 0.628])Δ([0.617, 0.617])Δ([0.625, 0.625])4Δ([0.620, 0.620])Δ([0.609, 0.609])Δ([0.618, 0.618])4
No. 4Δ([0.493, 0.508])Δ([0.493, 0.508])Δ([0.493, 0.508])9Δ([0.489, 0.504])Δ([0.489, 0.504])Δ([0.489, 0.504])9
No. 5Δ([0.612, 0.616])Δ([0.611, 0.616])Δ([0.612, 0.616])5Δ([0.609, 0.613])Δ([0.609, 0.613])Δ([0.609, 0.613])5
No. 6Δ([0.624, 0.629])Δ([0.624, 0.629])Δ([0.624, 0.629])3Δ([0.618, 0.622])Δ([0.618, 0.622])Δ([0.618, 0.622])2
No. 7Δ([0.601, 0.601])Δ([0.601, 0.601])Δ([0.601, 0.601])6Δ([0.597, 0.597])Δ([0.597, 0.597])Δ([0.597, 0.597])6
No. 8Δ([0.536, 0.558])Δ([0.532, 0.543])Δ([0.532, 0.546])8Δ([0.527, 0.549])Δ([0.522, 0.533])Δ([0.523, 0.537])8
No. 9Δ([0.625, 0.629])Δ([0.625, 0.629])Δ([0.625, 0.629])2Δ([0.618, 0.622])Δ([0.618, 0.622])Δ([0.618, 0.622])2
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.

Share and Cite

MDPI and ACS Style

Chang, K.-H.; Fang, T.-Y.; Li, Z.-S. Using a Flexible Risk Priority Number Method to Reinforce Abilities of Imprecise Data Assessments of Risk Assessment Problems. Electronics 2025, 14, 518. https://doi.org/10.3390/electronics14030518

AMA Style

Chang K-H, Fang T-Y, Li Z-S. Using a Flexible Risk Priority Number Method to Reinforce Abilities of Imprecise Data Assessments of Risk Assessment Problems. Electronics. 2025; 14(3):518. https://doi.org/10.3390/electronics14030518

Chicago/Turabian Style

Chang, Kuei-Hu, Tzu-Yi Fang, and Zong-Sian Li. 2025. "Using a Flexible Risk Priority Number Method to Reinforce Abilities of Imprecise Data Assessments of Risk Assessment Problems" Electronics 14, no. 3: 518. https://doi.org/10.3390/electronics14030518

APA Style

Chang, K.-H., Fang, T.-Y., & Li, Z.-S. (2025). Using a Flexible Risk Priority Number Method to Reinforce Abilities of Imprecise Data Assessments of Risk Assessment Problems. Electronics, 14(3), 518. https://doi.org/10.3390/electronics14030518

Note that from the first issue of 2016, this journal uses article numbers instead of page numbers. See further details here.

Article Metrics

Back to TopTop
