Predicting Extension of Time and Increasing Contract Price in Road Infrastructure Projects Using a Sugeno Fuzzy Logic Model

by
Aleksandar Senić
1,
Momčilo Dobrodolac
2,* and
Zoran Stojadinović
1
1
Faculty of Civil Engineering, University of Belgrade, 11000 Beograd, Serbia
2
Faculty of Transport and Traffic Engineering, University of Belgrade, 11000 Beograd, Serbia
*
Author to whom correspondence should be addressed.
Mathematics 2024, 12(18), 2852; https://doi.org/10.3390/math12182852
Submission received: 2 August 2024 / Revised: 4 September 2024 / Accepted: 11 September 2024 / Published: 13 September 2024

Abstract

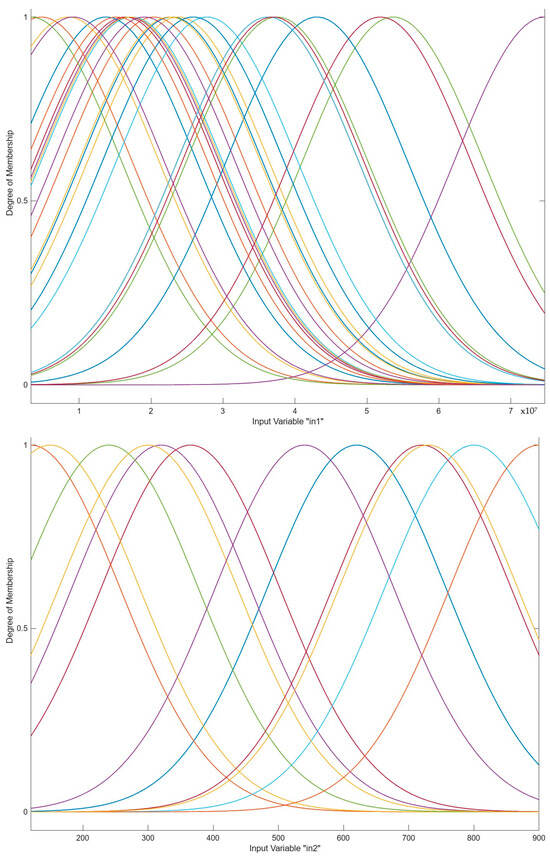

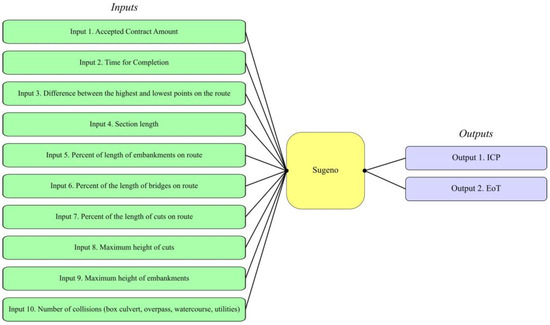

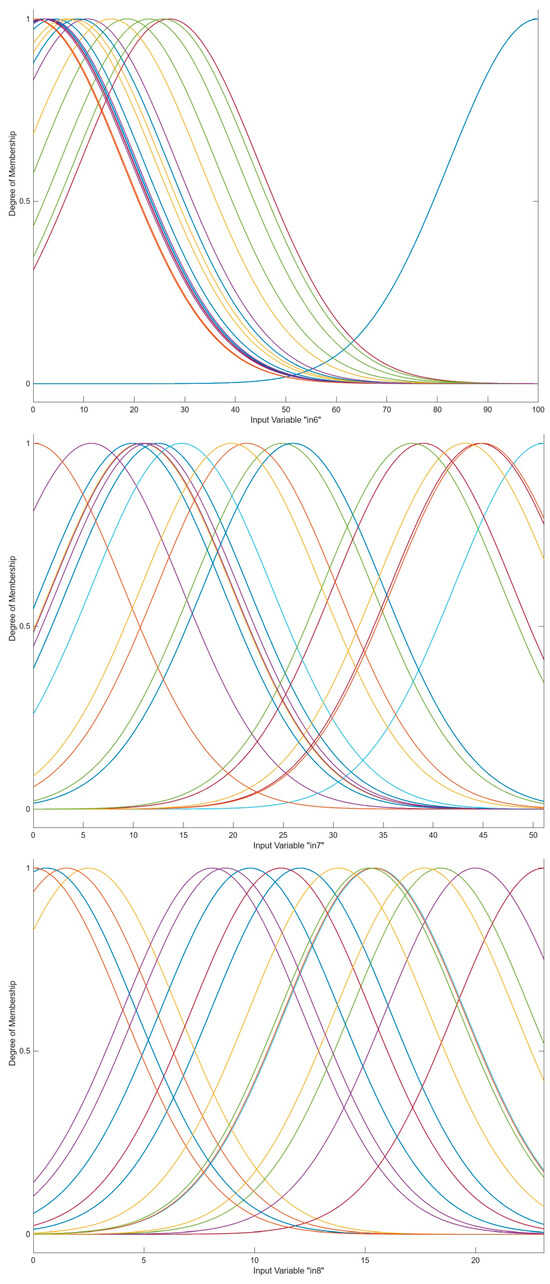

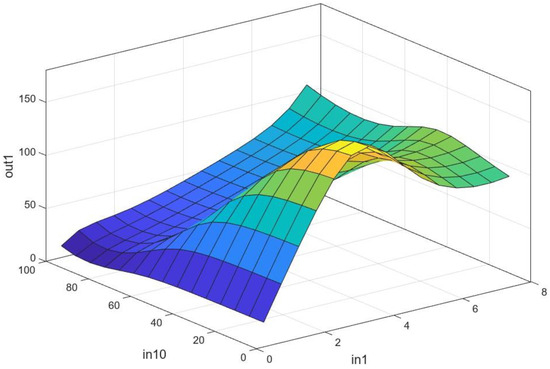

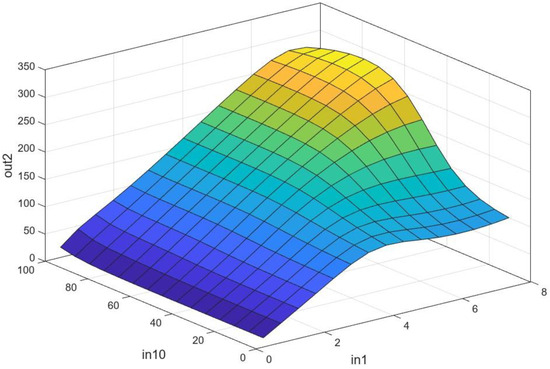

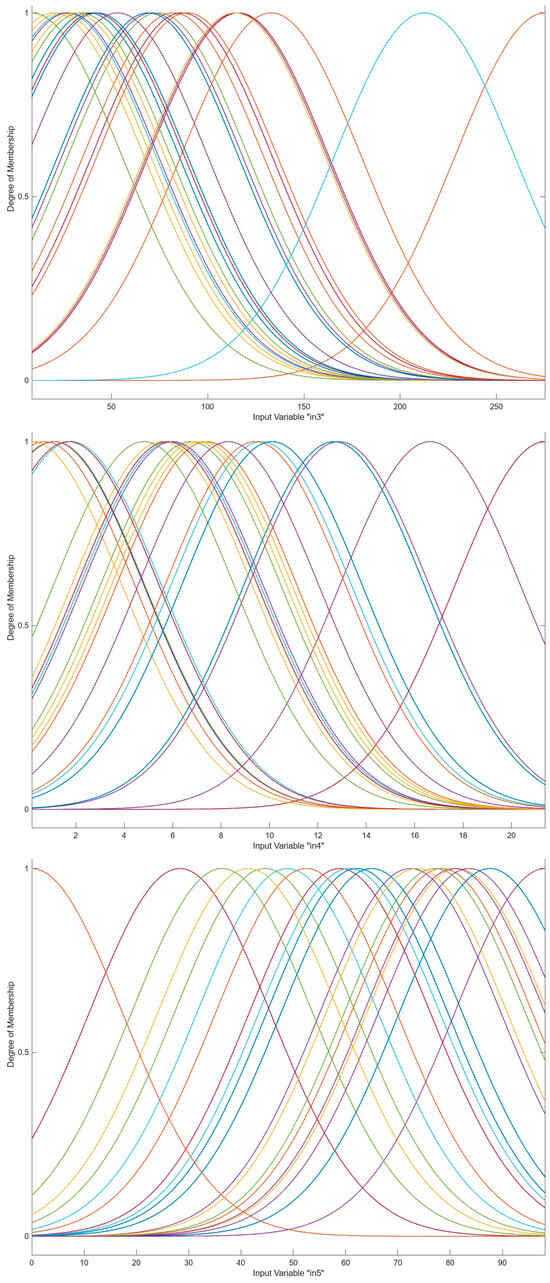

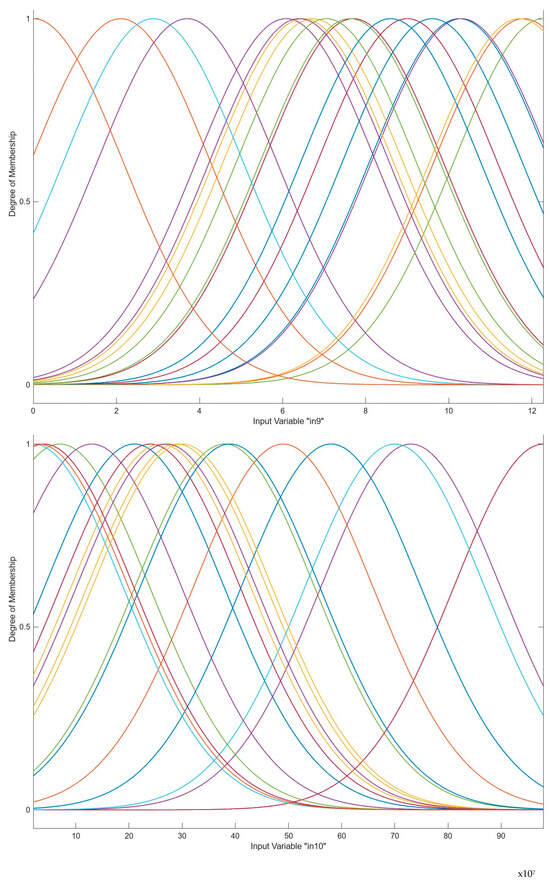

Road infrastructure plays a crucial role in the development of countries, significantly influencing economic growth, social progress, and environmental sustainability. Major infrastructure projects are frequently challenged by substantial risks and uncertainties, leading to delays, budget overruns, and compromised quality. These issues can undermine the economic viability and efficiency of projects, making effective risk management essential for minimizing negative impacts and ensuring project success. For these reasons, a study was conducted using a Sugeno fuzzy logic system applied to completed projects. The resulting model is based on 10 project characteristics and provides highly accurate predictions for Extension of Time (EoT) and Increasing Contract Price (ICP). By utilizing this model, project management can be significantly improved through more accurate forecasting of potential delays and cost overruns. The high precision of the Sugeno fuzzy logic system enables better risk assessment and proactive decision-making, allowing project managers to implement targeted strategies to mitigate risks and optimize project outcomes.
Keywords: road infrastructure; Sugeno fuzzy logic; Extension of Time (EoT); Increasing Contract Price (ICP); risk management road infrastructure; Sugeno fuzzy logic; Extension of Time (EoT); Increasing Contract Price (ICP); risk management

Share and Cite

MDPI and ACS Style

Senić, A.; Dobrodolac, M.; Stojadinović, Z. Predicting Extension of Time and Increasing Contract Price in Road Infrastructure Projects Using a Sugeno Fuzzy Logic Model. Mathematics 2024, 12, 2852. https://doi.org/10.3390/math12182852

AMA Style

Senić A, Dobrodolac M, Stojadinović Z. Predicting Extension of Time and Increasing Contract Price in Road Infrastructure Projects Using a Sugeno Fuzzy Logic Model. Mathematics. 2024; 12(18):2852. https://doi.org/10.3390/math12182852

Chicago/Turabian Style

Senić, Aleksandar, Momčilo Dobrodolac, and Zoran Stojadinović. 2024. "Predicting Extension of Time and Increasing Contract Price in Road Infrastructure Projects Using a Sugeno Fuzzy Logic Model" Mathematics 12, no. 18: 2852. https://doi.org/10.3390/math12182852
