Development of a New Method for Assessing Project Risks in Sustainable Building Construction Projects in Developing Countries: The Case of Jordan
Abstract
:1. Introduction
- To identify the project risks impacting sustainable construction projects in Jordan;
- To assess the probability of the risks occurring and the cost and time impacts of each identified risk in sustainable building projects;
- To rank the risks in Jordanian sustainable construction projects on the basis of their probabilities of occurrence and impacts on time and cost.
2. Research Methods
2.1. Identification of the Risks in Sustainable Building Construction Projects
2.2. The Proposed Risk Assessment Method
2.2.1. Assessment of the Risks’ Probabilities of Occurrence Using the RII Method
2.2.2. Assessment of the Risks’ Impacts Using the Analytic Hierarchy Process (AHP) Method
2.2.3. Proposed Assessment of Risks Based on Their Probabilities of Occurrence and Impacts
2.3. Validating the Results Using Focus Group Discussions
3. Results
3.1. Identified Risks
3.2. Probabilities of the Risks’ Occurrence
3.3. Impacts of the Risks on Time and Cost
3.3.1. Impact of the Risks in Sustainable Building Construction Projects on Time
3.3.2. Impact of the Risks in Sustainable Building Construction Projects on Cost
3.3.3. Risk Assessment Based on Probabilities and Impacts
3.4. Validation of the Proposed Method
4. Discussion
5. Conclusions
Author Contributions
Funding
Data Availability Statement
Conflicts of Interest
References
- Project Management Institute. A Guide to the Project Management Body of Knowledge (PMBOK Guide), 6th ed.; Project Management Institute: Newton Square, PA, USA, 2017. [Google Scholar]
- Rodrigues-da-Silva, L.H.; Crispim, J.A. The project risk management process, a preliminary study. Procedia Technol. 2014, 16, 943949. [Google Scholar] [CrossRef]
- Latham, M. Constructing the Team: Joint Review of Procurement and Contractual Agreements in the UK Construction Industry; Department of the Environment: London, UK, 1994. [Google Scholar]
- Ariska, T.Y.; Mubarak, M.; Husin, S.; Maulina, F.; Mahmuddin, M. Analysis of the risk impact of internal factors on time in building construction projects in Aceh Province. AIP Conf. Proc. 2024, 3082, 030017. [Google Scholar] [CrossRef]
- Kazaz, A.; Arslan, G. A Multi-Criteria Decision Support Model for the Management of Construction Project Risks. J. Constr. Eng. Manag. Innov. (Online) 2023, 6, 57–69. [Google Scholar] [CrossRef]
- Serpella, A.F.; Ferrada, X.; Howard, R.; Rubio, L. Risk management in construction projects: A knowledge-based approach. Procedia-Soc. Behav. Sci. 2014, 119, 653–662. [Google Scholar] [CrossRef]
- Yousri, E.; Sayed, A.E.B.; Farag, M.A.M.; Abdelalim, A.M. Risk identification of building construction projects in Egypt. Buildings 2023, 13, 1084. [Google Scholar] [CrossRef]
- Krechowicz, M. Effective risk management in innovative projects: A case study of the construction of energy-efficient, sustainable building of the laboratory of intelligent building in Cracow. IOP Conf. Ser. Mater. Sci. Eng. 2017, 245, 062006. Available online: https://iopscience.iop.org/article/10.1088/1757-899X/245/6/062006 (accessed on 1 March 2024). [CrossRef]
- Ilter, D.A.; Bakioglu, G. Modeling the relationship between risk and dispute in subcontractor contracts. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2018, 10, 04517022. [Google Scholar] [CrossRef]
- Maqbool, R.; Arul, T.; Ashfaq, S. A mixed-methods study of sustainable construction practices in the UK. J. Clean. Prod. 2023, 430, 139087. [Google Scholar] [CrossRef]
- Rafindadi, A.D.; Mikić, M.; Kovačić, I.; Cekić, Z. Global perception of sustainable construction project risks. Procedia-Soc. Behav. Sci. 2014, 119, 456–465. [Google Scholar] [CrossRef]
- Issa, U.; Sharaky, I.; Alwetaishi, M.; Balabel, A.; Shamseldin, A.; Abdelhafiz, A.; Al-Surf, M.; Al-Harthi, M.; Osman, M.M.A. Developing and applying a model for evaluating risks affecting greening existing buildings. Sustainability 2021, 13, 6403. [Google Scholar] [CrossRef]
- Gurgun, A.P.; Arditi, D.; Vilar, P.C. Impacts of construction risks on costs in LEED-certified projects. J. Green Build. 2016, 11, 163–181. [Google Scholar] [CrossRef]
- Erdenekhuu, N.; Kocsi, B.; Máté, D. A risk-based analysis approach to sustainable construction by environmental impacts. Energies 2022, 15, 6736. [Google Scholar] [CrossRef]
- Alattyih, W.; Haider, H.; Boussabaine, H. Risk factors impacting the project value created by green buildings in Saudi Arabia. Appl. Sci. 2020, 10, 7388. [Google Scholar] [CrossRef]
- Nguyen, H.D.; Macchion, L. A comprehensive risk assessment model based on a fuzzy synthetic evaluation approach for green building projects: The case of Vietnam. Eng. Constr. Archit. Manag. 2023, 30, 2837–2861. [Google Scholar] [CrossRef]
- Xiao, L.; Bie, L.; Bai, X. Controlling the schedule risk in green building projects: Buffer management framework with activity dependence. J. Clean. Prod. 2021, 278, 123852. [Google Scholar] [CrossRef]
- Wang, L.; Chan, D.W.; Darko, A.; Oluleye, B. Review on green buildings: A perspective of risk management process. J. Build. Eng. 2024, 86, 108738. [Google Scholar] [CrossRef]
- Nguyen, H.D.; Macchion, L. Exploring critical risk factors for Green Building projects in developing countries: The case of Vietnam. J. Clean. Prod. 2022, 381, 135138. [Google Scholar] [CrossRef]
- Koc, K.; Kunkcu, H.; Gurgun, A.P. A life cycle risk management framework for green building project stakeholders. J. Manag. Eng. 2023, 39, 04023022. [Google Scholar] [CrossRef]
- Herath, N.; Vaz-Serra, P.; Hui, F.K.P.; Mendis, P.; Aye, L. Risk Mitigation Measures in Green Building Projects: An Investigation. In International Conference on Sustainable Built Environment; Springer: Singapore, 2023; pp. 277–289. [Google Scholar] [CrossRef]
- Krechowicz, M.; Krechowicz, A. Risk Management in Designing and Developing Innovative, Sustainable Buildings. In Sustainability in Energy and Buildings 2023. Smart Innovation, Systems and Technologies; Littlewood, J.R., Jain, L., Howlett, R.J., Eds.; Springer: Singapore, 2024; Volume 378. [Google Scholar] [CrossRef]
- Ismael, D.; Shealy, T. Sustainable construction risk perceptions in the Kuwaiti construction industry. Sustainability 2018, 10, 1854. [Google Scholar] [CrossRef]
- Jaradat, H.; Alshboul, O.A.M.; Obeidat, I.M.; Zoubi, M.K. Green building, carbon emission, and environmental sustainability of construction industry in Jordan: Awareness, actions and barriers. Ain Shams Eng. J. 2024, 15, 102441. [Google Scholar] [CrossRef]
- Qazi, A.; Shamayleh, A.; El-Sayegh, S.; Formaneck, S. Prioritizing risks in sustainable construction projects using a risk matrix-based Monte Carlo Simulation approach. Sustain. Cities Soc. 2021, 65, 102576. [Google Scholar] [CrossRef]
- Al-Saffar, M.A.; Darwish, A.S.; Farrell, P.; Saffar, N. A Critical Analysis of Traditional and Ai-Based Risk Assessment Frameworks for Sustainable Construction Projects. J. Eng. Sci. Technol. 2024, 18, 35–54. [Google Scholar]
- Abu Salem, Z.T.; Suleiman, A. Risk factors causing time delay in the Jordanian construction sector. Int. J. Eng. Res. Technol. 2020, 13, 307–315. [Google Scholar] [CrossRef]
- The World Green Building Council (WorldGBC). What Is a Sustainable Built Environment? Available online: https://worldgbc.org/what-is-a-sustainable-built-environment/ (accessed on 1 April 2024).
- Ministry of Water & Irrigation, Jordan. Water Sector Facts and Figures. 2022. Available online: https://www.mwi.gov.jo/ebv4.0/root_storage/ar/eb_list_page/jordan_water_sector_-_facts_and_figures_2022.pdf (accessed on 1 April 2024).
- Al-Addous, M.; Bdour, M.; Alnaief, M.; Rabaiah, S.; Schweimanns, N. Water Resources in Jordan: A Review of Current Challenges and Future Opportunities. Water 2023, 15, 3729. [Google Scholar] [CrossRef]
- The Ministry of Energy and Mineral Resources. Summary of Jordan Energy Strategy 2020–2030. Available online: https://www.memr.gov.jo/EBV4.0/Root_Storage/EN/EB_Info_Page/StrategyEN2020.pdf (accessed on 1 April 2024).
- Hammad, B.; Al-Dahidi, S.; Aldahouk, Y.; Majrouh, D.; Al-Remawi, S. Constrains and barriers of implementing sustainability into architectural professional practice in Jordan. Alex. Eng. J. 2019, 58, 1011–1023. [Google Scholar] [CrossRef]
- Kasapoğlu, E. Risk management in construction. In Sustainable Buildings Interaction between a Holistic Conceptual Act and Materials Properties; Almusaed, A., Ed.; IntechOpen: London, UK, 2018. [Google Scholar] [CrossRef]
- Sweis, G.J. Factors affecting time overruns in public construction projects: The case of Jordan. Int. J. Bus. Manag. 2013, 8, 120. Available online: https://www.ccsenet.org/journal/index.php/ijbm/article/view/29813 (accessed on 1 April 2024). [CrossRef]
- Bahamid, R.A.; Doh, S.I.; Khoiry, M.A.; Kassem, M.A.; Al-Sharafi, M.A. The current risk management practices and knowledge in the construction industry. Buildings 2022, 12, 1016. [Google Scholar] [CrossRef]
- Kivrak, S.; Udan, O.H. Risk Management Practices in Ethiopian Somali Regional State Construction Projects. Buildings 2023, 13, 3130. [Google Scholar] [CrossRef]
- Abdel-Monem, M.; Alshaer, K.T.; El-Dash, K. Assessing Risk Factors Affecting the Accuracy of Conceptual Cost Estimation in the Middle East. Buildings 2022, 12, 950. [Google Scholar] [CrossRef]
- Hiyassat, M.A.; Alkasagi, F.; El-Mashaleh, M.; Sweis, G.J. Risk allocation in public construction projects: The case of Jordan. Int. J. Constr. Manag. 2022, 22, 1478–1488. [Google Scholar] [CrossRef]
- Abu-Reishah, L.; Hiyassat, M.A. The severity of design-construction interface risks in Jordanian construction industry. Int. J. Constr. Manag. 2023, 23, 1540–1548. [Google Scholar] [CrossRef]
- Hulett, D.T.; Preston, J.Y. Garbage in, garbage out? Collect better data for your risk assessment. In Proceedings of the Project Management Institute Annual Seminars & Symposium, Houston, TX, USA; Project Management Institute: Newtown Square, PA, USA, 2000. [Google Scholar]
- El-Sayegh, S.M.; Manjikian, S.; Ibrahim, A.; Abouelyousr, A.; Jabbour, R. Risk identification and assessment in sustainable construction projects in the UAE. Int. J. Constr. Manag. 2018, 21, 327–336. [Google Scholar] [CrossRef]
- Hwang, B.-G.; Shan, M.; Supa’at, N.N.B. Green commercial building projects in Singapore: Critical risk factors and mitigation measures. Sustain. Cities Soc. 2017, 30, 237–247. [Google Scholar] [CrossRef]
- Nguyen, H.D.; Macchion, L. Risk management in green building: A review of the current state of research and future directions. Environ. Dev. Sustain. 2023, 25, 2136–2172. [Google Scholar] [CrossRef]
- Andal, E.R.; Juanzon, J.B.P. Identifying Risks in Implementing Sustainable Building Materials in Condominium Fit-out Projects Using Analytic Hierarchy Process. Civ. Eng. Archit. 2020, 8, 1266–1276. [Google Scholar] [CrossRef]
- Muneeswaran, G.; Manoharan, P.; Awoyera, P.O.; Adesina, A. A statistical approach to assess the schedule delays and risks in Indian construction industry. Int. J. Constr. Manag. 2020, 20, 450–461. [Google Scholar] [CrossRef]
- Genc, O. Identifying principal risk factors in Turkish construction sector according to their probability of occurrences: A relative importance index (RII) and exploratory factor analysis (EFA) approach. Int. J. Constr. Manag. 2023, 23, 979–987. [Google Scholar] [CrossRef]
- Al Khatib, B.; Poh, Y.S.; El-Shafie, A. Delay factors management and ranking for reconstruction and rehabilitation projects based on the relative importance index (RII). Sustainability 2020, 12, 6171. [Google Scholar] [CrossRef]
- Cheng, M.-Y.; Darsa, M.H. Construction schedule risk assessment and management strategy for foreign general contractors working in the Ethiopian construction industry. Sustainability 2021, 13, 7830. [Google Scholar] [CrossRef]
- Antoniou, F.; Tsioulpa, A.V. Assessing the Delay, Cost, and Quality Risks of Claims on Construction Contract Performance. Buildings 2024, 14, 333. [Google Scholar] [CrossRef]
- Darko, A.; Chan, A.P.C.; Ameyaw, E.E.; Owusu, E.K.; Parn, E.; Edwards, D.J. Review of application of analytic hierarchy process (AHP) in construction. Int. J. Constr. Manag. 2019, 19, 436–452. [Google Scholar] [CrossRef]
- Gamal, Y.A.S.; Saber, A.M.A. Analyzing the application of the analytical hierarchy process in developing a robust risk management framework for construction projects in Egypt. Asian J. Civ. Eng. 2024, 2024, 1–17. [Google Scholar] [CrossRef]
- Khodabocus, S.; Seyis, S. Multi-criteria decision-making model for risk management in modular construction projects. Int. J. Constr. Manag. 2024, 24, 240–250. [Google Scholar] [CrossRef]
- Nikbakht, M.V.; Gheibi, M.; Montazeri, H.; Khaksar, R.Y.; Moezzi, R.; Vadiee, A. Identification and Ranking of Factors Affecting the Delay Risk of High-Rise Construction Projects Using AHP and VIKOR Methods. Infrastructures 2024, 9, 24. [Google Scholar] [CrossRef]
- Uğural, M.N. Risk Assessment for International Construction Projects. Int. J. Innov. Eng. Appl. 2023, 7, 44–51. Available online: https://dergipark.org.tr/en/pub/ijiea/issue/78156/1114344 (accessed on 1 March 2024). [CrossRef]
- Mahdinia, M.; Yarandi, M.S.; Jafarinia, E.; Soltanzadeh, A. Development of a new technique for safety risk assessment in construction projects based on fuzzy analytic hierarchy process. ASCE-ASME J. Risk Uncertain. Eng. Syst. Part A Civ. Eng. 2021, 7, 04021037. [Google Scholar] [CrossRef]
- Hossen, M.M.; Kang, S.; Kim, J. Construction schedule delay risk assessment by using combined AHP-RII methodology for an international NPP project. Nucl. Eng. Technol. 2015, 47, 362–379. [Google Scholar] [CrossRef]
- Saaty, T.L. How to make a decision: The analytic hierarchy process. Eur. J. Oper. Res. 1990, 48, 9–26. [Google Scholar] [CrossRef]
- Saaty, T.L. Decision making with the analytic hierarchy process. Int. J. Serv. Sci. 2008, 1, 83–98. [Google Scholar] [CrossRef]
- Saaty, T.L.; Shang, J.S. Group decision-making: Head-count versus intensity of preference. Socio-Econ. Plan. Sci. 2007, 41, 22–37. [Google Scholar] [CrossRef]
- Saaty, T.L.; Vargas, L.G. The possibility of group welfare functions. Int. J. Inf. Technol. Decis. Mak. 2005, 4, 167–176. [Google Scholar] [CrossRef]
- Ho, W. Integrated analytic hierarchy process and its applications—A literature review. Eur. J. Oper. Res. 2008, 186, 211–228. [Google Scholar] [CrossRef]
- Ereiba, Y.H.; Glass, J.; Thorpe, T. TBY using focus groups in construction management research. In Proceedings of the 20th Annual ARCOM Conference, Heriot Watt University, Edinburgh, UK, 1–3 September 2004; Khosrowshahi, F., Ed.; Association of Researchers in Construction Management: Leeds, UK, 2004; Volume 2, pp. 857–865. [Google Scholar]
- Omar, D. Focus group discussion in built environment qualitative research practice. IOP Conf. Ser. Earth Environ. Sci. 2018, 117, 012050. [Google Scholar] [CrossRef]
- Qin, X.; Mo, Y.; Jing, L. Risk perceptions of the life-cycle of green buildings in China. J. Clean. Prod. 2016, 126, 148–158. [Google Scholar] [CrossRef]
Category | ID | Risks | References |
---|---|---|---|
Management | M1 | Inadequate planning for sustainable building projects | [15,23,25,41,42,43] |
M2 | Tight project schedule for sustainable building projects | [15,25,41,43,44] | |
M3 | The identification of sustainable construction’s scope is insufficient. | [15,25,41,42,43] | |
M4 | Inadequate selection of construction techniques in sustainable construction | [15,23,25,41,42,43] | |
M5 | Long lead time for sustainable and green building construction materials | [15,25,41] | |
M6 | Budgeting inaccuracies owing to a lack of experience with sustainable building projects | [15,23,25,41,42,43] | |
M7 | Additional costs incurred as a result of the use of sustainable building construction materials and equipment | [15,23,25,41,42,43] | |
Organizational | O1 | Insufficient funds from clients | [15,23,25,41,43,44] |
O2 | Clients’ reluctance to embrace new sustainability principles | [15,42,43] | |
O3 | The contractor has only a limited level of experience with sustainable and green practices | [23,25,41,43] | |
O4 | The project manager’s skills concerning a sustainable building projects are lacking | [15,25,41,43] | |
O5 | Shortage of skilled workers in sustainable building projects | [15,23,25,41,42,43] | |
O6 | Low productivity of labor in sustainable construction | [23,25,41,42] | |
Technical | T1 | Changes to the original design | [15,23,25,41,42,43] |
T2 | Inadequate or inaccurate sustainable design information | [15,23,25,41,42,43,44] | |
T3 | Inadequate or insufficient green specifications | [15,23,25,41,42,43,44] | |
T4 | Scarcity of documents and information for new green technologies | [15,25,41,42,43,44] | |
External | E1 | The consultant has a limited level of experience with sustainable practices | [25,28,43] |
E2 | Lack of availability and competence of green suppliers | [25,41,42,43,44] | |
E3 | Lack of availability and competence of green sub-contractors | [23,25,41,43] | |
E4 | Lack of sustainable building construction materials | [15,23,25,41,43,44] | |
E5 | Changes to the codes and regulations governing sustainable construction | [15,23,25,41,43,44] | |
E6 | Price increases for sustainable building construction materials | [15,23,25,41,42,43,44] |
Category | ID | Risks | Probability (RII) |
---|---|---|---|
Management | M1 | Inadequate planning for sustainable building projects | 0.74 |
M2 | Tight project schedule for sustainable building projects | 0.89 | |
M3 | The identification of sustainable construction’s scope is insufficient. | 0.92 | |
M4 | Inadequate selection of construction techniques in sustainable construction | 0.72 | |
M5 | Long lead time for sustainable and green building construction materials | 0.89 | |
M6 | Budgeting inaccuracies owing to a lack of experience with sustainable building projects | 0.86 | |
M7 | Additional costs incurred as a result of the use of sustainable building construction materials and equipment | 0.91 | |
Organizational | O1 | Insufficient funds from clients | 0.53 |
O2 | Clients’ reluctance to embrace new sustainability principles | 0.81 | |
O3 | The contractor has only a limited level of experience with sustainable and green practices. | 0.78 | |
O4 | The project manager’s skills concerning a sustainable building project are lacking | 0.72 | |
O5 | Shortage of skilled workers in sustainable building projects | 0.52 | |
O6 | Low productivity of labors in sustainable construction | 0.46 | |
Technical | T1 | Changes to the original design | 0.73 |
T2 | Inadequate or inaccurate sustainable design information | 0.59 | |
T3 | Inadequate or insufficient green specifications | 0.56 | |
T4 | Scarcity of documents and information for new green technologies | 0.37 | |
External | E1 | The consultant has a limited level of experience with sustainable practices | 0.55 |
E2 | Lack of availability and competence of green suppliers | 0.62 | |
E3 | Lack of availability and competence of green sub-contractors | 0.68 | |
E4 | Lack of sustainable building construction materials | 0.55 | |
E5 | Changes to the codes and regulations governing sustainable construction | 0.39 | |
E6 | Price increases for sustainable building construction materials | 0.70 |
Risk Category | Local Weight of the Category | Risk | Local Weight of the Risk | Global Weight |
---|---|---|---|---|

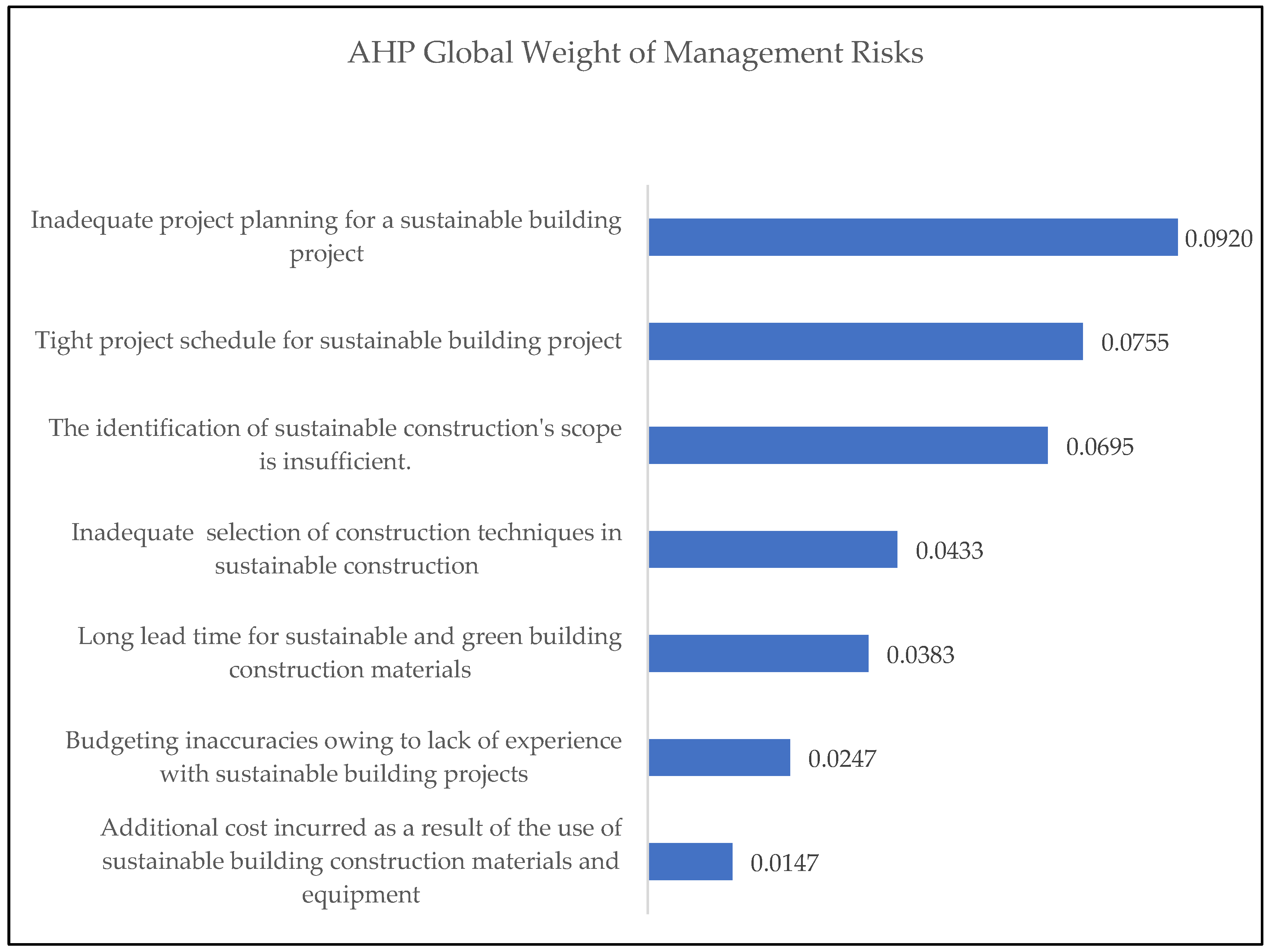

Project management | 0.358 | Inadequate planning for sustainable building projects | 0.257 | 0.0920 |
Tight project schedule for sustainable building projects | 0.211 | 0.0755 | ||
The identification of sustainable construction’s scope is insufficient | 0.194 | 0.0695 | ||
Long lead time for sustainable and green building construction materials | 0.107 | 0.0383 | ||
Inadequate selection of construction techniques in sustainable construction | 0.121 | 0.0433 | ||
Budgeting inaccuracies owing to a lack of experience with sustainable building projects | 0.069 | 0.0247 | ||
Additional costs incurred as a result of the use of sustainable building construction materials and equipment | 0.041 | 0.0147 | ||

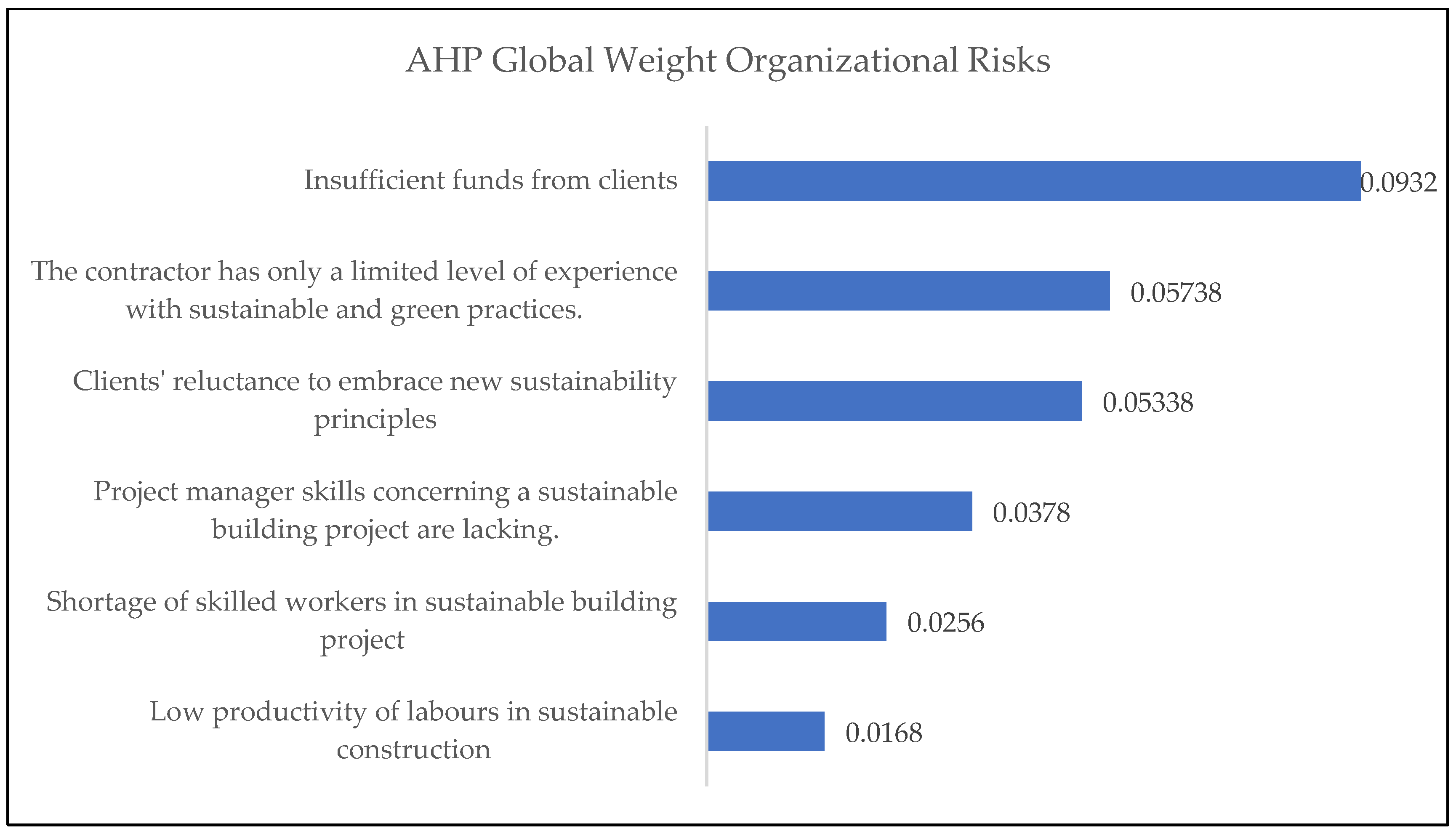

Organizational | 0.284 | Insufficient funds from clients | 0.328 | 0.0932 |
Clients’ reluctance to embrace new sustainability principles | 0.188 | 0.0534 | ||
The contractor has only a limited level of experience with sustainable and green practices. | 0.202 | 0.0574 | ||
The project manager’s skills concerning a sustainable building project are lacking | 0.133 | 0.0378 | ||
Shortage of skilled workers in sustainable building projects | 0.09 | 0.0256 | ||
Low productivity of labors in sustainable construction | 0.059 | 0.0168 | ||
Technical | 0.224 | Changes to the original design | 0.448 | 0.1004 |
Inadequate or inaccurate sustainable design information | 0.225 | 0.0504 | ||
Inadequate or insufficient green specifications | 0.209 | 0.0468 | ||
Scarcity of documents and information for new green technologies | 0.118 | 0.0264 | ||

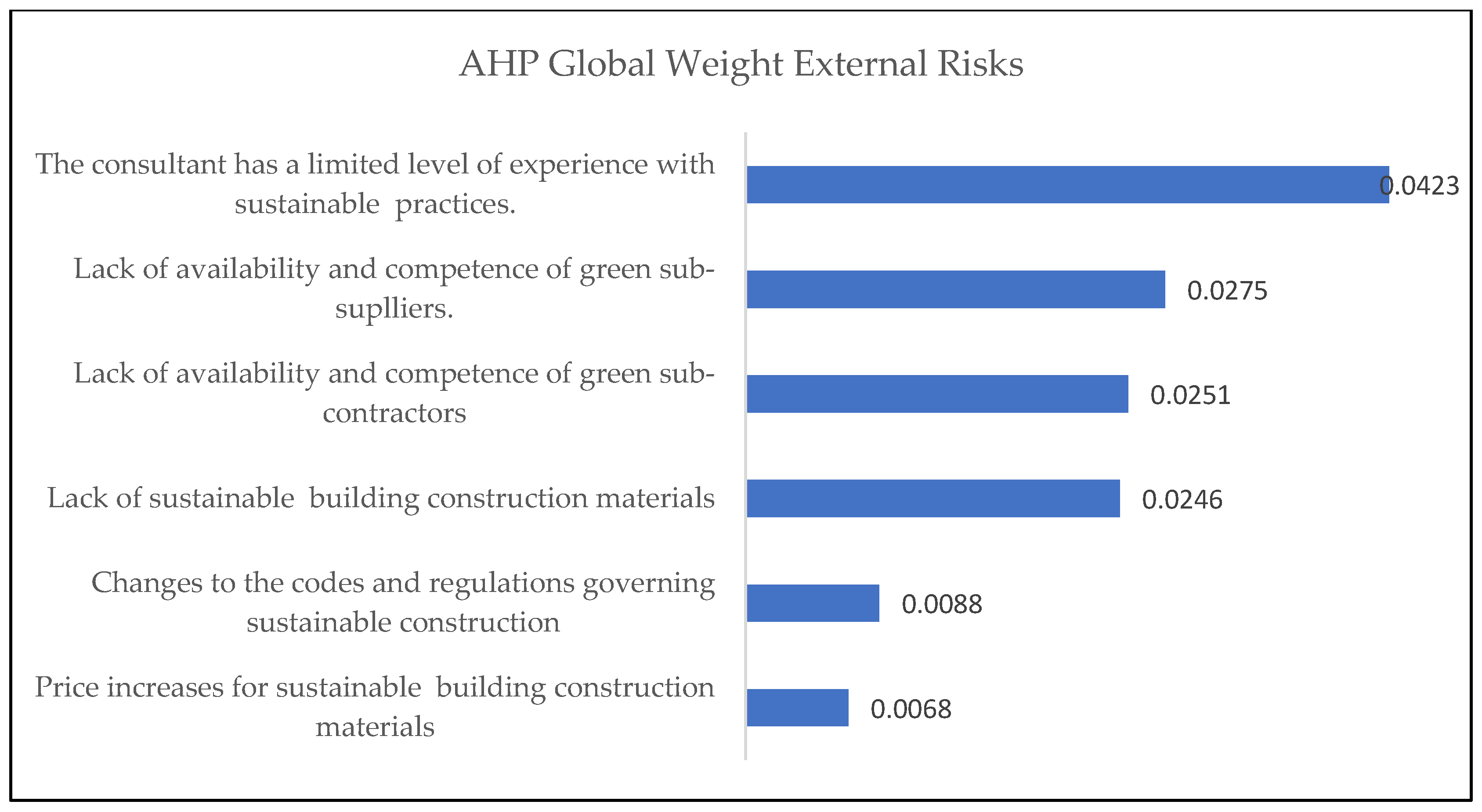

External | 0.135 | The consultant has a limited level of experience with sustainable practices | 0.313 | 0.0423 |
Lack of availability and competence of green suppliers. | 0.204 | 0.0275 | ||
Lack of availability and competence of green sub-contractors | 0.186 | 0.0251 | ||
Lack of sustainable building construction materials | 0.182 | 0.0246 | ||
Changes to the codes and regulations governing sustainable construction | 0.065 | 0.0088 | ||
Price increases for sustainable building construction materials | 0.05 | 0.0068 |

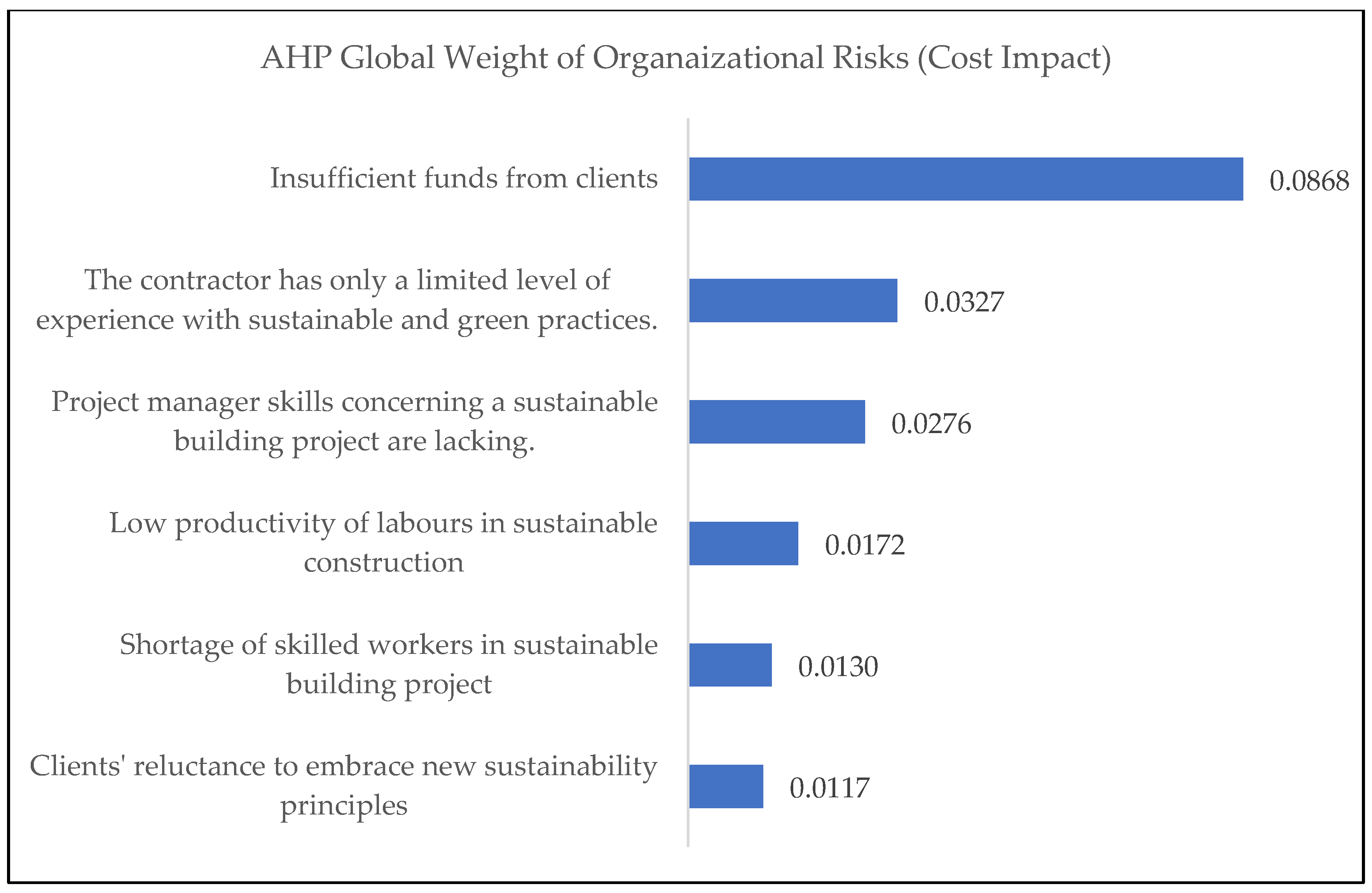

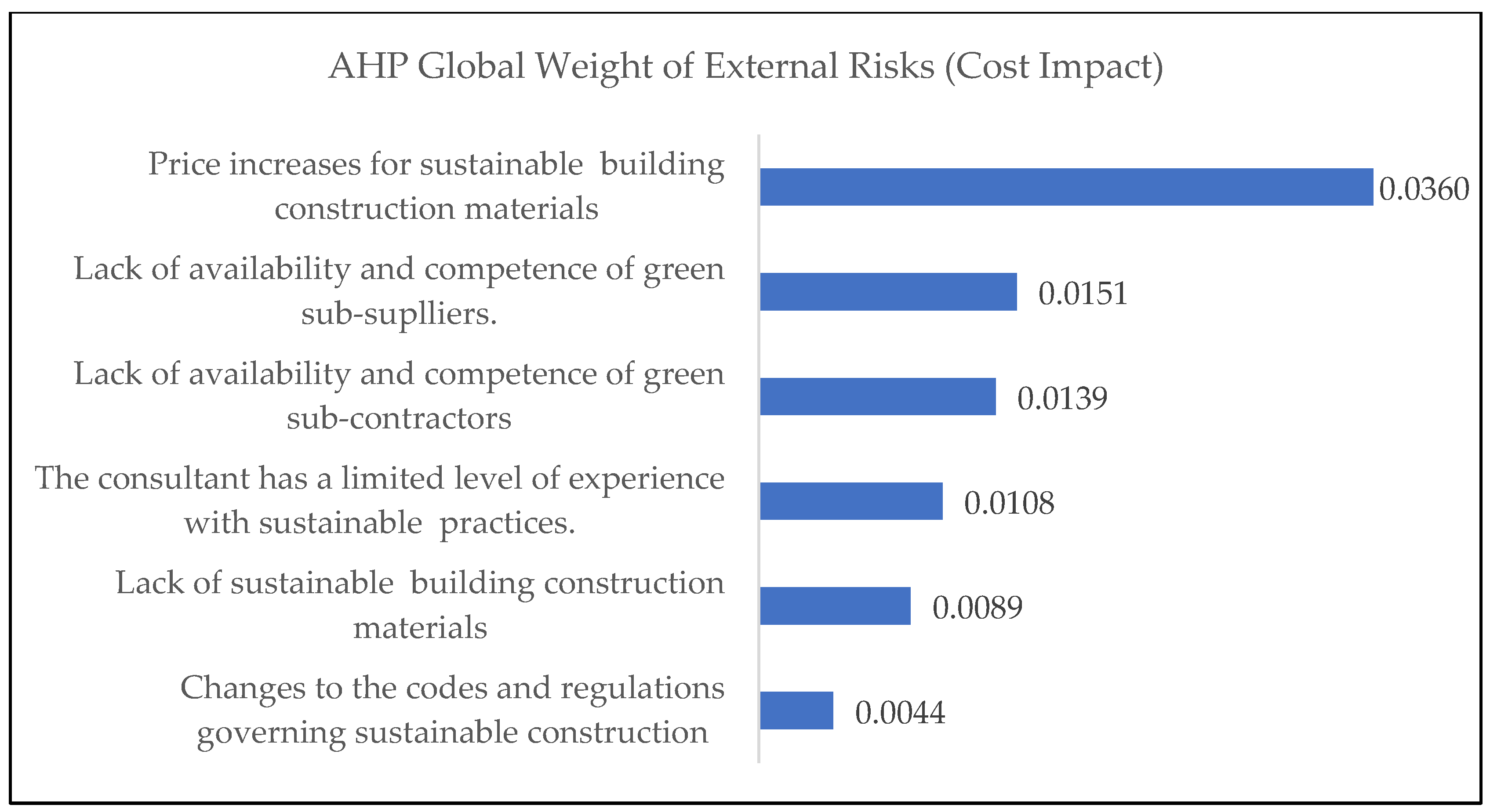

Risk Category | Local Weight of the Category | Risk | Local Weight of the Risks | Global Weight |
---|---|---|---|---|
Project management | 0.337 | Budgeting inaccuracies owing to a lack of experience with sustainable building projects | 0.254 | 0.0856 |
Additional costs incurred as a result of the use of sustainable building construction materials and equipment | 0.23 | 0.0775 | ||
Inadequate planning for a sustainable building project | 0.175 | 0.0590 | ||
The identification of sustainable construction’s scope is insufficient. | 0.11 | 0.0371 | ||
Tight project schedule for sustainable building projects | 0.101 | 0.0340 | ||
Inadequate selection of construction techniques in sustainable construction | 0.077 | 0.0259 | ||
Long lead time for sustainable and green building construction materials | 0.053 | 0.0179 | ||
Organizational | 0.189 | Insufficient funds from clients | 0.459 | 0.0868 |
The contractor has only a limited level of experience with sustainable and green practices. | 0.173 | 0.0327 | ||
The project manager’s skills concerning a sustainable building project are lacking | 0.146 | 0.0276 | ||
Low productivity of labors in sustainable construction | 0.091 | 0.0172 | ||
Shortage of skilled workers in sustainable building project | 0.069 | 0.0130 | ||
Clients’ reluctance to embrace new sustainability principles | 0.062 | 0.0117 | ||
Technical | 0.385 | Changes to the original design | 0.492 | 0.1894 |
Inadequate or insufficient green specifications | 0.207 | 0.0797 | ||
Inadequate or inaccurate sustainable design information | 0.203 | 0.0782 | ||
Scarcity of documents and information for new green technologies | 0.099 | 0.0381 | ||
External | 0.089 | Price increases for sustainable building construction materials | 0.405 | 0.0360 |
Lack of availability and competence of green suppliers | 0.17 | 0.0151 | ||
Lack of availability and competence of green sub-contractors | 0.156 | 0.0139 | ||
The consultant has a limited level of experience with sustainable practices | 0.121 | 0.0108 | ||
Lack of sustainable building construction materials | 0.1 | 0.0089 | ||
Changes to the codes and regulations governing sustainable construction | 0.049 | 0.0044 |
Risk Category | Risk | Impact on Time (AHP Global Weight) | Probability (RII) | Score |
---|---|---|---|---|
Project management | Inadequate planning for sustainable building projects | 0.092 | 0.740 | 0.068 |
Tight project schedule for sustainable building projects | 0.076 | 0.890 | 0.067 | |
The identification of sustainable construction’s scope is insufficient. | 0.069 | 0.920 | 0.064 | |
Long lead time for sustainable and green building construction materials | 0.038 | 0.890 | 0.034 | |
Inadequate selection of construction techniques in sustainable construction | 0.043 | 0.720 | 0.031 | |
Budgeting inaccuracies owing to a lack of experience with sustainable building projects | 0.025 | 0.860 | 0.021 | |
Additional costs incurred as a result of the use of sustainable building construction materials and equipment | 0.015 | 0.910 | 0.013 | |
Organizational | Insufficient funds from clients | 0.093 | 0.533 | 0.050 |
Clients’ reluctance to embrace new sustainability principles | 0.053 | 0.810 | 0.043 | |
The contractor has only a limited level of experience with sustainable and green practices | 0.057 | 0.780 | 0.045 | |
The project manager’s skills concerning a sustainable building project are lacking | 0.038 | 0.720 | 0.027 | |
Shortage of skilled workers in sustainable building projects | 0.026 | 0.520 | 0.013 | |
Low productivity of labors in sustainable construction | 0.017 | 0.460 | 0.008 | |
Technical | Changes to the original design | 0.100 | 0.730 | 0.073 |
Inadequate or inaccurate sustainable design information | 0.050 | 0.590 | 0.030 | |
Inadequate or insufficient green specifications | 0.047 | 0.560 | 0.026 | |
Scarcity of documents and information for new green technologies | 0.026 | 0.374 | 0.010 | |
External | The consultant has a limited level of experience with sustainable practices | 0.042 | 0.550 | 0.023 |
Lack of availability and competence of green suppliers | 0.028 | 0.620 | 0.017 | |
Lack of availability and competence of green sub-contractors | 0.025 | 0.680 | 0.017 | |
Lack of sustainable building construction materials | 0.025 | 0.550 | 0.014 | |
Changes to the codes and regulations governing sustainable construction | 0.009 | 0.390 | 0.003 | |
Price increases for sustainable building construction materials | 0.007 | 0.700 | 0.005 |
Risk Category | Risk | Impact on Cost (AHP Global Weight) | Probability (RII) | Score |
---|---|---|---|---|
Project management | Budgeting inaccuracies owing to a lack of experience with sustainable building projects | 0.086 | 0.860 | 0.074 |
Additional costs incurred as a result of the use of sustainable building construction materials and equipment | 0.078 | 0.910 | 0.071 | |
Inadequate planning for a sustainable building project | 0.059 | 0.740 | 0.044 | |
The identification of sustainable construction’s scope is insufficient. | 0.037 | 0.920 | 0.034 | |
Tight project schedule for sustainable building projects | 0.034 | 0.890 | 0.030 | |
Inadequate selection of construction techniques in sustainable construction | 0.026 | 0.720 | 0.019 | |
Long lead time for sustainable and green building construction materials | 0.018 | 0.890 | 0.016 | |
Organizational | Insufficient funds from clients | 0.087 | 0.530 | 0.046 |
The contractor has only a limited level of experience with sustainable and green practices | 0.033 | 0.780 | 0.026 | |
The project manager’s skills concerning a sustainable building project are lacking | 0.028 | 0.720 | 0.020 | |
Low productivity of labors in sustainable construction | 0.017 | 0.460 | 0.008 | |
Shortage of skilled workers in sustainable building projects | 0.013 | 0.520 | 0.007 | |
Clients’ reluctance to embrace new sustainability principles | 0.012 | 0.810 | 0.009 | |
Technical | Changes to the original design | 0.189 | 0.730 | 0.138 |
Inadequate or insufficient green specifications | 0.080 | 0.560 | 0.045 | |
Inadequate or inaccurate sustainable design information | 0.078 | 0.590 | 0.046 | |
Scarcity of documents and information for new green technologies | 0.038 | 0.374 | 0.014 | |
External | Price increases for sustainable building construction materials | 0.036 | 0.700 | 0.025 |
Lack of availability and competence of green sub-suppliers | 0.015 | 0.620 | 0.009 | |
Lack of availability and competence of green sub-contractors | 0.014 | 0.680 | 0.009 | |
The consultant has a limited level of experience with sustainable practices | 0.011 | 0.550 | 0.006 | |
Lack of sustainable building construction materials | 0.009 | 0.550 | 0.005 | |
Changes to the codes and regulations governing sustainable construction | 0.004 | 0.390 | 0.002 |
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2024 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (https://creativecommons.org/licenses/by/4.0/).
Share and Cite
Alawneh, R.; Jannoud, I.; Rabayah, H.; Asaad, S.; Almasaeid, H.; Imam, R.; Ghazali, F.E.M. Development of a New Method for Assessing Project Risks in Sustainable Building Construction Projects in Developing Countries: The Case of Jordan. Buildings 2024, 14, 1573. https://doi.org/10.3390/buildings14061573
Alawneh R, Jannoud I, Rabayah H, Asaad S, Almasaeid H, Imam R, Ghazali FEM. Development of a New Method for Assessing Project Risks in Sustainable Building Construction Projects in Developing Countries: The Case of Jordan. Buildings. 2024; 14(6):1573. https://doi.org/10.3390/buildings14061573
Chicago/Turabian StyleAlawneh, Rami, Ismael Jannoud, Hesham Rabayah, Samaher Asaad, Hatem Almasaeid, Rana Imam, and Farid Ezanee Mohamed Ghazali. 2024. "Development of a New Method for Assessing Project Risks in Sustainable Building Construction Projects in Developing Countries: The Case of Jordan" Buildings 14, no. 6: 1573. https://doi.org/10.3390/buildings14061573
