Cost Overrun Causative Factors in Road Infrastructure Projects: A Frequency and Importance Analysis
Abstract
:1. Introduction
2. Research Method

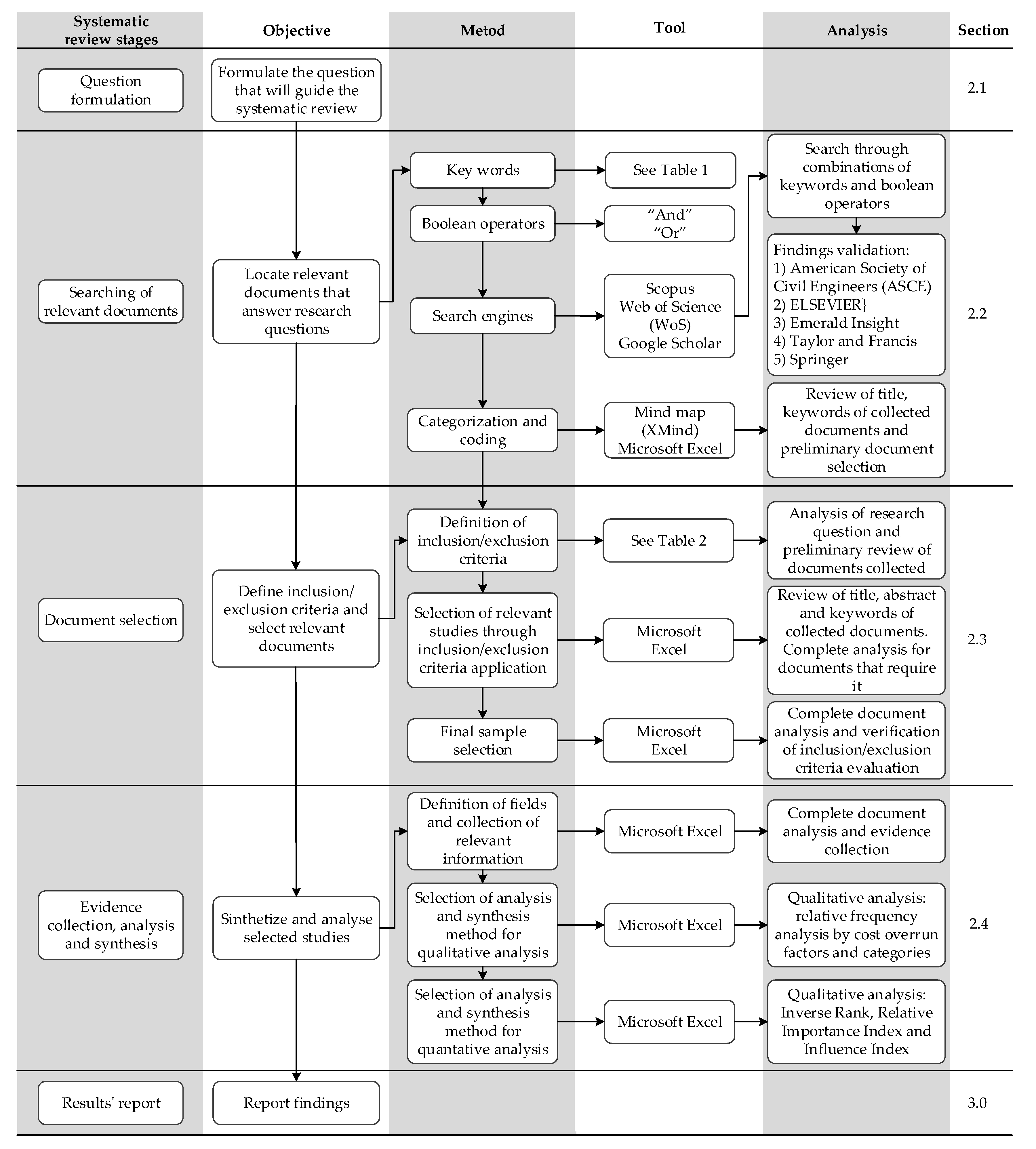

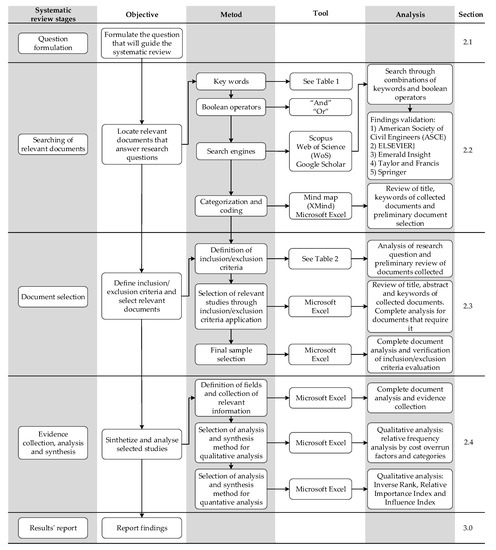

2.1. Question Formulation
- Research question 1: what are the cost overrun factors in road infrastructure projects?
- Research question 2: what are the frequency and level of importance for each cost overrun factor?
- Research question 3: which are the project stakeholders responsible for cost overruns occurrence in road infrastructure projects?

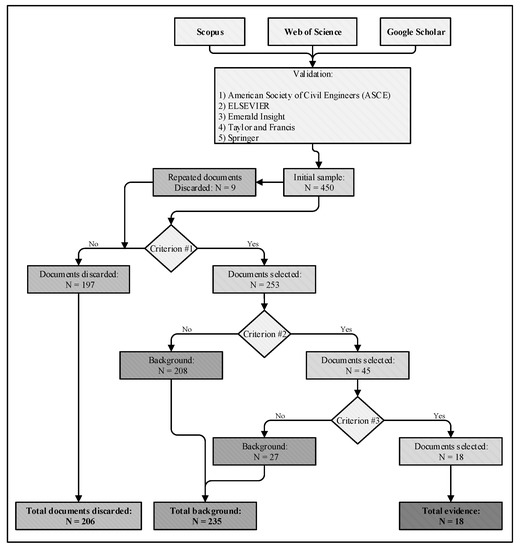

2.2. Searching of Relevant Documents
2.3. Document Selection
2.4. Evidence Collection, Analysis, and Synthesis
2.4.1. Qualitative Analysis
2.4.2. Quantitative Analysis
2.4.3. Network Analysis
3. Results and Discussion
3.1. Studies on Cost Overrun Factors Related to Road Infrastructure Projects
3.2. Sample Composition for the Qualitative, Quantitative, and Network Analysis
3.2.1. Publication Year and Geographical Area
3.2.2. Data Source and Measurement Method
3.2.3. Number of Factors and Categories
3.3. Qualitative Analysis
3.3.1. Qualitative Analysis by Factor
3.3.2. Qualitative Analysis by Category
3.4. Quantitative Analysis
3.4.1. Quantitative Analysis by Factor
3.4.2. Quantitative Analysis by Category
3.4.3. Quantitative Analysis by Stakeholder’s Group

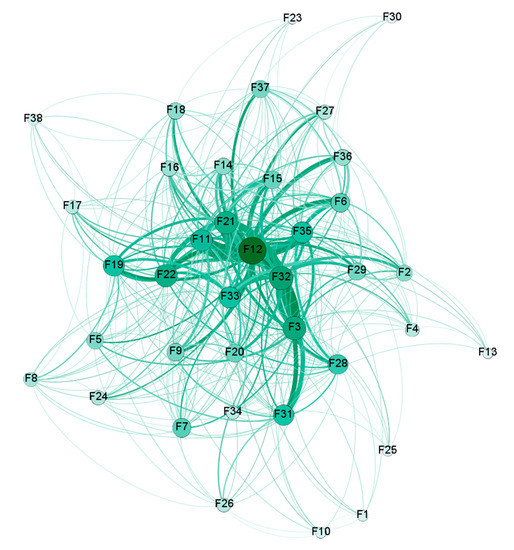

3.5. Network Analysis
3.6. Comparative Analysis between Studies: Top-10 Factors
4. Cost Overrun Factors by Region: Limitations and Challenges
5. Conclusions
Supplementary Materials
Author Contributions
Funding
Acknowledgments
Conflicts of Interest
References
- Amare, Y.; Quezon, E.T.; Busier, M. Causes of delays during construction phase of road projects due to the failures of contractor, consultant, and employer in Addis Ababa City Road Authority. Int. J. Sci. Eng. Res. 2017, 8, 15–25. [Google Scholar]
- Al Hosani, I.; Dweiri, F.; Ojiako, U. A study of cost overruns in complex multi-stakeholder road projects in the United Arab Emirates. Int. J. Syst. Assur. Eng. Manag. 2020. [Google Scholar] [CrossRef]
- Lee, E.B.; Thomas, D.K.; Alleman, D. Incorporating road user costs into integrated life-cycle cost analyses for infrastructure sustainability: A case study on Sr-91 corridor improvement project (Ca). Sustainability 2018, 10, 179. [Google Scholar] [CrossRef] [Green Version]
- Lee, E.B.; Alleman, D. Ensuring efficient incentive and disincentive values for highway construction projects: A systematic approach balancing road user, agency and contractor acceleration costs and savings. Sustainability 2018, 10, 701. [Google Scholar] [CrossRef] [Green Version]
- Love, P.E.D.; Ahiaga-dagbui, D.D.; Irani, Z. Cost overruns in transportation infrastructure projects: Sowing the seeds for a probabilistic theory of causation. Transp. Res. Part A 2016, 92, 184–194. [Google Scholar] [CrossRef] [Green Version]
- Aziz, R.; Abdel-hakam, A. Exploring delay causes of road construction projects in Egypt. Alex. Eng. J. 2016, 55, 1515–1539. [Google Scholar] [CrossRef] [Green Version]
- Parikh, D.; Joshi, G.J.; Patel, D.A. Development of prediction models for claim cause analyses in highway projects. J. Leg. Aff. Disput. Resolut. Eng. Constr. 2019, 11. [Google Scholar] [CrossRef]
- Rehak, D.; Senovsky, P.; Slivkova, S. Resilience of critical infrastructure elements and its main factors. Systems 2018, 6, 21. [Google Scholar] [CrossRef] [Green Version]
- Useche, S.; Montoro, L.; Alonso, F.; Oviedo-Trespalacios, O. Infrastructural and human factors affecting safety outcomes of cyclists. Sustainability 2018, 10, 299. [Google Scholar] [CrossRef] [Green Version]
- Song, Y.; Wright, G.L.; Wu, P.; Thatcher, D.; McHugh, T.; Li, Q.; Li, S.J.; Wang, X. Segment-based spatial analysis for assessing road infrastructure performance using monitoring observations and remote sensing data. Remote Sens. 2018, 10, 1696. [Google Scholar] [CrossRef] [Green Version]
- Cavalieri, M.; Cristaudo, R.; Guccio, C. On the magnitude of cost overruns throughout the project life-cycle: An assessment for the Italian transport infrastructure projects. Transp. Policy 2019, 79, 21–36. [Google Scholar] [CrossRef]
- Love, P.E.D.; Wang, X.; Sing, C.P.; Tiong, R.L.K. Determining the probability of project cost overruns. J. Constr. Eng. Manag. 2013, 139, 321–330. [Google Scholar] [CrossRef]
- Catalão, F.P.; Cruz, C.O.; Sarmento, J.M. The determinants of cost deviations and overruns in transport projects, an endogenous models approach. Transp. Policy 2019, 74, 224–238. [Google Scholar] [CrossRef]
- Bucciol, A.; Chillemi, O.; Palazzi, G. Cost overrun and auction format in small size public works. Eur. J. Polit. Econ. 2013, 30, 35–42. [Google Scholar] [CrossRef]
- Huo, T.; Ren, H.; Cai, W.; Shen, G.Q.; Liu, B.; Zhu, M.; Wu, H. Measurement and dependence analysis of cost overruns in megatransport infrastructure projects: Case study in Hong Kong. J. Constr. Eng. Manag. 2018, 144. [Google Scholar] [CrossRef]
- Bohórquez, J.J.; Oviedo, N.S.; Mejía, G. Cost overruns in transport infrastructure projects: A current review. In Proceedings of the InNGENIO 2018, Medellin, Colombia, 22–24 August 2018; pp. 1–9. [Google Scholar]
- Bordat, C.; McCullouch, B.G.; Labi, S.; Sinha, K. An Analysis of Cost Overruns and Time Delays of INDOT Projects; Joint Transportation Research Program; Indiana Department of Transportation and Purdue University: West Lafayette, Indiana, 2004. [Google Scholar] [CrossRef]
- Creedy, G.; Skitmore, M.; Wong, J. Evaluation of risk factors leading to cost overrun in delivery of highway construction projects. J. Constr. Eng. Manag. 2010, 136, 528–537. [Google Scholar] [CrossRef] [Green Version]
- Love, P.; Sing, C.; Carey, B.; Kim, J. Estimating construction contingency: Accommodating the potential for cost overruns in road construction projects. J. Infrastruct. Syst. 2014, 21. [Google Scholar] [CrossRef]
- Cantarelli, C.; Van Wee, B.; Molin, E.; Flyvbjerg, B. Different cost performance: Different determinants? The case of cost overruns in Dutch transport infrastructure projects. Transp. Policy 2012, 22, 88–95. [Google Scholar] [CrossRef] [Green Version]
- Lee, J. Cost overrun and cause in Korean social overhead capital projects: Roads, rails, airports, and ports. J. Urban Plan. Dev. 2008, 134, 59–62. [Google Scholar] [CrossRef]
- Roxas, N.; Chalermpong, S. Forecasting inaccuracies in transportation projects in selected South East Asian countries. In Proceedings of the 16th Annual Conference of the Transportation Science Society of the Philippines, Pasay City, Philippines, 19 September 2008; Volume 9, p. 11. [Google Scholar]
- Mahamid, I.; Bruland, A. Cost deviation in road construction projects: The case of Palestine. Australas. J. Constr. Econ. Build. 2012, 12, 58–71. [Google Scholar]
- Rwakarehe, E.E.; Mfinanga, D.A. Effect of inadequate design on cost and time overrun of road construction projects in Tanzania. J. Constr. Eng. Proj. Manag. 2014, 4, 15–28. [Google Scholar] [CrossRef] [Green Version]
- Pai, S.; Patnaik, B.; Mittal, A.; Anand, N. Identification of risks causing time and cost overrun in roads and highway projects in India. Int. J. Civ. Eng. Technol. 2018, 9, 683–697. [Google Scholar]
- Shemi, S.; Asok, K. Examination of cost overrun in highway projects using artificial neural networks in Kerala. Int. J. Innov. Sci. Res. Technol. 2020, 5, 1382–1392. [Google Scholar]
- Tranfield, D.; Denyer, D.; Smart, P. Towards a methodology for developing evidence-informed management knowledge by means of systematic review. Br. J. Manag. 2003, 14, 207–222. [Google Scholar] [CrossRef]
- Briner, R.; Denyer, D. Systematic review and evidence synthesis as a practice and scholarship tool. In The Oxford Handbook of Evidence-Based Management; Oxford University Press: Oxford, UK, 2012; pp. 112–129. [Google Scholar]
- Saieg, P.; Dominguez, E.; Nascimento, D.; Goyannes, R. Interactions of Building Information Modeling, Lean and Sustainability on the Architectural, Engineering and Construction industry: A systematic review. J. Clean. Prod. 2018, 174, 788–806. [Google Scholar] [CrossRef]
- Costin, A.; Adibfar, A.; Hu, H.; Chen, S.S. Building Information Modeling (BIM) for transportation infrastructure—Literature review, applications, challenges, and recommendations. Autom. Constr. 2018, 94, 257–281. [Google Scholar] [CrossRef]
- Mahamid, I.; Bruland, A. Cost overrun causes in road construction projects: Consultants’ perspective. In Proceedings of the 2nd International Conference on Construction and Project Management IPEDR, Singapore, 16–18 September 2011; Volume 15, pp. 6–10. [Google Scholar]
- Ahbab, C.; Daneshvar, S.; Çelik, T. Cost and time management efficiency assessment for large road projects using data envelopment analysis. Tek. Dergi Tech. J. Turkish Chamb. Civ. Eng. 2019, 30, 8937–8959. [Google Scholar] [CrossRef]
- Sánchez, O.; Castañeda, K.; Herrera, R.; Pellicer, E. Benefits of Last Planner® System in mitigation of delay causes in road infrastructure projects. In Proceedings of the XI Simpósio Brasileiro de Gestão e Economia da Construção, Londrina, Brazil, 23–25 October 2019; pp. 1–8. [Google Scholar]
- Rehman, A.; Farooq, H.; Muhammad, R. Cost and time overruns in highway projects of. In Proceedings of the Sixth International Conference on Construction in the 21st Century (CITC-VI) “Construction Challenges in the New Decade”, Kuala Lumpur, Malaysia, 5–7 July 2011; p. 9. [Google Scholar]
- Akogbe, R.K.T.M.; Feng, X.; Zhou, J. Importance and ranking evaluation of delay factors for development construction projects in Benin. KSCE J. Civ. Eng. 2013, 17, 1213–1222. [Google Scholar] [CrossRef]
- Santoso, D.S.; Soeng, S. Analyzing delays of road construction projects in Cambodia: Causes and effects. J. Manag. Eng. 2016, 32, 05016020. [Google Scholar] [CrossRef]
- Rachid, Z.; Toufik, B.; Mohammed, B. Causes of schedule delays in construction projects in Algeria. Int. J. Constr. Manag. 2018, 19, 371–381. [Google Scholar] [CrossRef]
- Adamic, L.; Adar, E. How to Search a Social Network. Soc. Networks 2005, 27, 187–203. [Google Scholar] [CrossRef] [Green Version]
- Pryke, S. Social Network Analysis in Construction; Wiley-Blackwell: Hoboken, NJ, USA, 2012; ISBN 1118343913. [Google Scholar]
- Meeampol, S.; Ogunlan, S. Factors affecting cost and time performance on highway construction projects: Evidence from Thailand. J. Financ. Manag. Prop. Constr. 2006, 11, 3–20. [Google Scholar] [CrossRef]
- Park, Y.I.; Papadopoulou, T. Causes of cost overruns in transport infrastructure projects in Asia: Their significance and relationship with project size. Built Environ. Proj. Asset Manag. 2012, 2, 195–216. [Google Scholar] [CrossRef]
- Zafar, I.; Yousaf, T.; Ahmed, D.S. Evaluation of risk factors causing cost overrun in road projects in terrorism affected areas Pakistan—A case study. KSCE J. Civ. Eng. 2015, 20, 1613–1620. [Google Scholar] [CrossRef]
- Al-Zwainy, F.; Mezher, R. Diagnose the causes of cost deviation in highway construction projects by using root cause analysis techniques. Arab. J. Sci. Eng. 2017, 43, 2001–2012. [Google Scholar] [CrossRef]
- Sohu, S.; Halid, A.; Nagapan, S.; Fattah, A.; Latif, I.; Ullah, K. Causative factors of cost overrun in highway projects of Sindh province of Pakistan. In Proceedings of the IOP Conference Series: Materials Science and Engineering, Johor Bahru, Malaysia, 28–29 August 2017; Volume 271, p. 7. [Google Scholar]
- Mahamid, I. Study of relationship between cost overrun and labour productivity in road construction projects. Int. J. Product. Qual. Manag. 2018, 24, 143–164. [Google Scholar] [CrossRef]
- Preliminary Findings of the Construction Risk Factors Affecting the Cost Overruns of Public Projects in Malaysia. Available online: http://www.academia.edu/download/49466188/PrelimFindingsConstRiskFactorsAffectingCost_OverrunsPublicProjectsMalaysia.PDF (accessed on 25 June 2020).
- Venkateswaran, C.B.; Murugasan, R. Time delay and cost overrun of road over bridge (ROB) construction projects in India. J. Constr. Dev. Ctries. 2017, 22, 79–96. [Google Scholar] [CrossRef]
- Lende, P.K.; Rathod, A.D. Study of factors affecting cost overrun in road construction project. Int. J. Res. Eng. Sci. Manag. 2018, 1, 115–119. [Google Scholar]
- Mahamid, I. Effects of project’s physical characteristics on cost deviation in road construction. J. King Saud Univ. Eng. Sci. 2013, 25, 81–88. [Google Scholar] [CrossRef] [Green Version]
- Sohu, S.; Abdullah, A.H.; Nagapan, S.; Fattah, A.; Ullah, K.; Kumar, K. Contractors perspective for critical factors of cost overrun in highway projects of Sindh, Pakistan. AIP Conf. Proc. 2017, 1892, 080002. [Google Scholar]
- Vu, H.A.; Wang, J.; Min, L.; Mai, S.H.; Nguyen, H.P. Research on cost overrun risk of construction phase of Vietnam highway international contracting project. Engineering 2016, 8, 86–98. [Google Scholar] [CrossRef] [Green Version]
- Prasad, A.; Singh, V.; Srivastava, V. Causative factors of cost overrun in highway projects of East Uttar Pradesh State of India. Int. J. Eng. Res. Appl. 2018, 8, 64–71. [Google Scholar]
- Ramanathan, C.T.; Sambu Potty, N.; Bin Idrus, A. Risk factors influencing time and cost overrun in multiple D&B projects in Malaysia: A case study. In Proceedings of the 2011 IEEE International Conference on Industrial Engineering and Engineering Management, Singapore, 6–9 December 2011; pp. 854–859. [Google Scholar] [CrossRef]
- Alhomidan, A. Factors affecting cost overrun in road construction projects in Saudi Arabia. Int. J. Civ. Environ. Eng. IJCEE-IJENS 2013, 13, 1–4. [Google Scholar]
- Chileshe, N.; Berko, P. Causes of project cost overruns within the Ghanaian road construction sector. In Proceedings of the 5th Built Environment Conference, Durban, South Africa, 18–20 July 2010. [Google Scholar]
- Buertey, J.; Kumi, T.; Astrim, F.; Boateng, K. Managing the drivers of cost escalation in the Road Development Sector: An Overview. Int. J. Sci. Technol. Soc. 2015, 3, 295. [Google Scholar] [CrossRef] [Green Version]
- Belachew, A.; Mengesha, W.; Mohammed, M. Cost overruns on Federal Capital Territory Authority road construction projects. Am. J. Civ. Eng. 2017, 5, 27. [Google Scholar] [CrossRef] [Green Version]
- Anigbogu, N.; Ahmad, Z.; Molwus, J. Cost overruns on Federal Capital territory Authority road construction projects. FUTY J. Environ. 2019, 13, 1–14. [Google Scholar]
- Yousry Akal, A.; Abu El-Maaty, A.E.; El-Hamrawy, S. Mapping the causes of time, cost overruns and quality shortfall in Egyptian Public Highway Projects. Eur. Bus. Manag. 2017, 3, 120. [Google Scholar] [CrossRef] [Green Version]
- El-Kholy, A.M. Exploring the best ANN model based on four paradigms to predict delay and cost overrun percentages of highway projects. Int. J. Constr. Manag. 2019, 1–19. [Google Scholar] [CrossRef]
- Gituro, W.; Mwawasi, S. Time and cost overruns in road construction projects in Kenya under Kenya National Highways Authority. Oper. Res. Soc. East. Afr. J. 2016, 6, 117–156. [Google Scholar]
- Kaliba, C.; Muya, M.; Mumba, K. Cost escalation and schedule delays in road construction projects in Zambia. Int. J. Proj. Manag. 2009, 27, 522–531. [Google Scholar] [CrossRef]
- Mansfield, N.; Ugwu, O.; Doran, T. Causes of delay and cost overruns in Nigerian construction projects. Int. J. Proj. Manag. 1994, 12, 254–260. [Google Scholar] [CrossRef]
- Kogi, B.W.; Were, S. Factors affecting cost overruns in construction projects a case of Kenya National Highways Authority. Int. J. Proj. Manag. 2017, 1, 167–182. [Google Scholar]
- Amadi, A.I.; Higham, A. Latent geotechnical pathogens inducing cost overruns in highway projects. J. Financ. Manag. Prop. Constr. 2017, 22, 269–285. [Google Scholar] [CrossRef]
- Amadi, A.I.; Higham, A. The trickle-down effect of psycho-social constructs and knowledge deficiencies as organizational barriers to cost performance on highway projects. J. Financ. Manag. Prop. Constr. 2008, 23, 57–72. [Google Scholar] [CrossRef]
- Tadewos, S.G.; Patel, D. Factors influencing time and cost overruns in road construction projects: Addis Ababa, Ethiopian scenario. Int. Res. J. Eng. Technol. 2018, 5, 177–180. [Google Scholar]
- Chang, A. Reasons for cost and schedule increase for engineering design projects. J. Manag. Eng. 2002, 18, 29–36. [Google Scholar] [CrossRef] [Green Version]
- Anastasopoulos, P.C.; Haddock, J.E.; Peeta, S. Cost overrun in public-private partnerships: Toward sustainable highway maintenance and rehabilitation. J. Constr. Eng. Manag. 2014, 140. [Google Scholar] [CrossRef]
- Bhargava, A.; Anastasopoulos, P.C.; Labi, S.; Sinha, K.C.; Mannering, F.L. Three-stage least-squares analysis of time and cost overruns in construction contracts. J. Constr. Eng. Manag. 2010, 136, 1207–1218. [Google Scholar] [CrossRef]
- Hastak, M.; Baim, E. Risk factors affecting management and maintenance cost of urban infrastructure. J. Infrastruct. Syst. 2001, 7, 67–76. [Google Scholar] [CrossRef]
- Shane, J.S.; Molenaar, K.R.; Anderson, S.; Schexnayder, C. Construction project cost escalation factors. J. Manag. Eng. 2009, 4, 166–176. [Google Scholar]
- Torp, O.; Belay, A.; Thodesen, C.; Klakegg, O. Cost development over-time at construction planning phase: Empirical evidence from Norwegian construction projects. Procedia Eng. 2016, 145, 1177–1184. [Google Scholar] [CrossRef] [Green Version]
- Ahiaga-Dagbui, D.D.; Love, P.E.D.; Smith, S.D.; Ackermann, F. Toward a systemic view to cost overrun causation in infrastructure projects: A review and implications for research. Proj. Manag. J. 2017, 48, 88–98. [Google Scholar] [CrossRef]
- Lind, H.; Brunes, F. Explaining cost overruns in infrastructure projects: A new framework with applications to Sweden. Constr. Manag. Econ. 2015, 33, 554–568. [Google Scholar] [CrossRef]
- Odeck, J. Cost overruns in road construction—what are their sizesand determinants? Transp. Policy 2004, 11, 43–53. [Google Scholar] [CrossRef]
- Aforla, B.; Woode, A.; Amoah, D.K. Causes of delays in highway construction projects in Ghana. Civ. Environ. Res. 2016, 8, 69–76. [Google Scholar]
- AIA. California Council Integrated Project Delivery: A Guide; The American Institute of Architects: Washington, DC, USA, 2007; pp. 1–62. [Google Scholar]
- Mesa, H.A.; Molenaar, K.R.; Alarcón, L.F. Exploring performance of the integrated project delivery process on complex building projects. Int. J. Proj. Manag. 2016, 34, 1089–1101. [Google Scholar] [CrossRef]
- Semple, C.; Hartman, F.T.; Jergeas, G. Construction claims and disputes: Causes and cost/time overruns. J. Constr. Eng. Manag. 1994, 120, 785–795. [Google Scholar] [CrossRef]
- Jergeas, G.; Ruwanpura, J. Why cost and schedule overruns on mega oil sands projects? Pract. Period. Struct. Des. Constr. 2010, 15, 40–43. [Google Scholar] [CrossRef]
- Knight, K.; Fayek, A. A preliminary study of the factors affecting the cost escalation of construction projects. Can. J. Civ. Eng. 2000, 27, 73–83. [Google Scholar] [CrossRef]
- Shalwani, A.; Lines, B.C. An empirical analysis of the causes of cost and schedule growth for small healthcare and educational construction projects. Int. J. Constr. Educ. Res. 2020. [Google Scholar] [CrossRef]
- França, A.; Haddad, A. Causes of construction projects cost overrun in Brazil. Int. J. Sustain. Constr. Eng. Technol. 2018, 9, 69–83. [Google Scholar] [CrossRef]
- Lozano, S.; Patiño, I.; Gómez, A.; Torres, A. Identificación de factores que generan diferencias de tiempo y costos en proyectos de construcción en Colombia. Ing. Cienc. 2018, 14, 117–151. [Google Scholar] [CrossRef]
- Ellis, L.; Martin, H.; Ramcharitar, S. Factors influencing triple constraints in public sector projects in Trinidad and Tobago. Proc. Inst. Civ. Eng. Manag. Procure. Law 2019, 172, 157–169. [Google Scholar] [CrossRef]
- Radujkovic, M. The causes of time and cost overruns in construction projects. In Proceedings of the CIB W55 & W65 Joint Triennial Symposium, Cape Town, South Africa, 5–10 September 1999; pp. 5–10. [Google Scholar]
- Larsen, J.K.; Brunoe, T.D.; Lindhard, S.M. Analyzing factors affecting time, cost, and quality between diverse public construction agencies. In Proceedings of the ICCREM 2015, Lulea, Sweden, 11–12 August 2015; pp. 1–11. [Google Scholar]
- Larsen, J.K.; Shen, G.Q.; Lindhard, S.M.; Brunoe, T.D. Factors affecting schedule delay, cost overrun, and quality level in public construction projects. J. Manag. Eng. 2016, 32, 04015032. [Google Scholar] [CrossRef] [Green Version]
- Kostka, G.; Anzinger, N. Offshore wind power expansion in Germany: Scale patterns, and causes of time delays and cost overruns. In Large Infrastructure Projects in Germany: Between Ambition and Realities; Palgrave Macmillan: Cham, Switzerland, 2016; pp. 147–189. [Google Scholar]
- Gudiene, N.; Banaitis, A.; Banaitiene, N.; Lopes, J. Development of a conceptual critical success factors model for construction projects: A case of lithuania. In Proceedings of the 11th International Conference on Modern Building Materials, Structures and Techniques, Vilnius, Lithuania, 16–17 May 2013; Elsevier B.V.: Kidlington, UK, 2013; Volume 57, pp. 392–397. [Google Scholar]
- Kayrbekova, D.; Markeset, T.; Panesar, S.S. Identification of factors causing time and cost overruns in offshore petroleum modification projects. IFIP Adv. Inf. Commun. Technol. 2012, 384, 268–275. [Google Scholar]
- Moura, H.; Teixeira, J.; Pires, B. Dealing with cost and time in the Portuguese construction industry. In Proceedings of the CIB World Building Congress, Cape Town, South Africa, 14–17 May 2007; Volume 422, pp. 1252–1265. [Google Scholar]
- Catalão Pinheiro, F.; Cruz, C.O.; Miranda Sarmento, J. Exogenous determinants of cost deviations and overruns in local infrastructure projects. Constr. Manag. Econ. 2019, 37, 697–711. [Google Scholar] [CrossRef]
- Jackson, S. Project cost overruns and risk management. In Proceedings of the Association of Researchers in Construction Management 18th Annual ARCOM Conference, Newcastle, Northumber University, UK, 2–4 September 2002; pp. 1–10. [Google Scholar]
- Jennings, W. Why costs overrun: Risk, optimism and uncertainty in budgeting for the London 2012 Olympic Games. Constr. Manag. Econ. 2012, 30, 455–462. [Google Scholar] [CrossRef]
- Alzahrani, J.I.; Emsley, M.W. The impact of contractors’ attributes on construction project success: A post construction evaluation. Int. J. Proj. Manag. 2013, 31, 313–322. [Google Scholar] [CrossRef]
- Doloi, H. Cost overruns and failure in project management: Understanding the roles of key stakeholders in construction projects. J. Constr. Eng. Manag. 2013, 139. [Google Scholar] [CrossRef]
- Adafin, J.; Rotimi, J.O.B.; Wilkinson, S.; Mbachu, J. An assessment of risk factors impacting budget variability in New Zealand commercial construction projects. In Proceedings of the 35th Annual ARCOM Conference, Leeds, UK, 2–4 September 2019; pp. 44–53. [Google Scholar]
- Zhao, L.; Wang, B.; Mbachu, J.; Liu, Z. New Zealand building project cost and its influential factors: A structural equation modelling approach. Adv. Civ. Eng. 2019, 2019, 1362730. [Google Scholar] [CrossRef]
- Zhao, L.; Mbachu, J.; Liu, Z. Identifying significant cost-influencing factors for sustainable development in construction industry using structural equation modelling. Math. Probl. Eng. 2020, 2020, 4810136. [Google Scholar] [CrossRef]
Keyword | B.O. * | Keyword | B.O. * | Keyword | B.O. * | Keyword |
---|---|---|---|---|---|---|
Road Highway Motorway Roadway | “AND” “OR” | Cost Cost overrun Cost extensions Cost deviations | “AND” “OR” | Causes Factors Reasons | “AND” “OR” | Construction Design Maintenance |
Region | Research Method | Total | ||
---|---|---|---|---|
Questionnaires | Projects | Literature Review | ||
Asia | [2,25,26,31,34,40,41,42,43,44,45,46,47,48,49,50,51,52] | [32,53] | [54] | 21 |
Africa | [55,56,57,58,59,60,61,62,63,64] | [65,66] | [67] | 13 |
America | [68,69,70,71] | [72] | 5 | |
Oceania | [18] | 1 | ||
Europe | [73,74,75] | [20,76] | 5 | |
Total | 32 | 10 | 3 | 45 |
Id | Reference | Country | Area | Data Source | Measurement Method | Sample Detail | Sample Size | Factors Analyzed | Number of Categories |
---|---|---|---|---|---|---|---|---|---|
D1 | (Chang, 2002) [68] | United States | America | Projects | Cost Deviation Percentage (CDP) | Projects (4) | 4 | 10 | 3 |
D2 | (Meeampol & Ogunlan, 2006) [40] | Thailand | Asia | Questionnaires | Likert Scale (5 Points) | Site Managers (99) | 99 | 13 | - |
D3 | (Chileshe & Berko, 2010) [55] | Ghana | Africa | Questionnaires | Likert Scale (4 Points) | Contractors (7), Consultants (4), Clients (23) | 34 | 14 | - |
D4 | (Creedy et al. 2010) [18] | Australia | Oceania | Questionnaires | Likert Scale: 10 points | Experts (8) | 8 | 28 | - |
D5 | (Mahamid & Bruland, 2011) [31] | Palestine | Asia | Questionnaires | Likert Scale (5 Points) | Consultants (40) | 40 | 51 | 5 |
D6 | (Rehman et al. 2011) [34] | Pakistan | Asia | Questionnaires | Likert Scale (5 Points) | Contractors (19), Consultants (18) | 37 | 28 | - |
D7 | (Park & Papadopoulou, 2012) [41] | Various * | Asia | Questionnaires | Likert Scale (5 Points) | - | 145 | 27 | - |
D8 | (Buertey, Kumi, Astrim, & Boateng, 2015) [56] | Ghana | Africa | Questionnaires | Likert Scale (5 Points) | - | 46 | 26 | - |
D9 | (Zafar, Yousaf, & Ahmed, 2015) [42] | Pakistan | Asia | Questionnaires | Likert Scale (5 Points) | Contractors (37), Consultants (17), Owners (9) | 63 | 18 | - |
D10 | (Torp, Belay, Thodesen, & Klakegg, 2016) [73] | Norway | Europe | Questionnaires | Likert Scale (5 Points) | - | - | 24 | - |
D11 | (Al-Zwainy & Mezher, 2017) [43] | Iraq | Asia | Questionnaires and personal interviews with experts | Weight of each factor | - | - | 20 | 3 |
D12 | (Belachew, Mengesha, & Mohammed, 2017) [57] | Ethiopia | Africa | Questionnaires | Likert Scale (7 Points) | Contractors (11), Consultants (31), Owners (3) | 45 | 40 | 3 |
D13 | (Sohu et al. 2017) [44] | Pakistan | Asia | Questionnaires | Likert Scale (5 Points) | - | 30 | 64 | - |
D14 | (Mahamid, 2018) [45] | Palestine | Asia | Questionnaires | Likert Scale (5 Points) | Contractors (52), Consultants (23) | 75 | 21 | - |
D15 | (Ahbab et al. 2019) [32] | Various ** | Asia | Projects | Frequency of occurrence | Projects (63) | 63 | 66 | - |
D16 | (Anigbogu, Ahmad, & Molwus, 2019) [58] | Nigeria | Africa | Questionnaires | Likert Scale (5 Points) | Contractors (99), Consultants (62), Owners (106) | 267 | 71 | - |
D17 | (Al Hosani et al. 2020) [2] | United Arab Emirates | Asia | Questionnaires | Likert Scale (5 Points) | Contractors (36), Consultants (62), Clients (45) | 143 | 44 | 9 |
D18 | (Shemi & Asok, 2020) [26] | India | Asia | Questionnaires | Likert Scale (4 Points) | - | - | 40 | - |
ID | Category | Factors | Stakeholders’ Group | Relative Frequency | Frequency Rank |
---|---|---|---|---|---|
F1 | Consultant | Late decision making by consultants | Designer and Consultant | 0.56% | 33 |
F2 | Contract | Poor contract management | Contractor | 1.67% | 22 |
F3 | Unrealistic contract duration | Owner | 4.44% | 5 | |
F4 | Contractor | Delays of activities | Contractor | 1.11% | 29 |
F5 | Inadequate construction methods | Contractor | 1.67% | 22 | |
F6 | Inadequate contractor’s experience | Contractor | 2.78% | 11 | |
F7 | Poor site management and supervision | Contractor | 3.33% | 7 | |
F8 | Contractual relationships | Claims and disputes with stakeholders | External Agent | 1.11% | 29 |
F9 | Poor communication among stakeholders | External Agent | 2.78% | 11 | |
F10 | Poor coordination among stakeholders | External Agent | 0.56% | 33 | |
F11 | Design | Design changes | Designer and Consultant | 4.44% | 5 |
F12 | Failures in design | Designer and Consultant | 12.78% | 1 | |
F13 | Equipment | Shortage of equipment | Supplier and Subcontractor | 0.56% | 33 |
F14 | External factors | Economy issues | External Agent | 2.78% | 11 |
F15 | Political situation | External Agent | 3.33% | 7 | |
F16 | Unethical activities | External Agent | 1.67% | 22 | |
F17 | Weather | External Agent | 1.11% | 29 | |
F18 | Financial | Financial difficulties of contractor | Contractor | 2.22% | 17 |
F19 | Financial difficulties of owner | Owner | 2.78% | 11 | |
F20 | Payment delays to contractor | Owner | 2.22% | 17 | |
F21 | Price variation of materials | External Agent | 6.67% | 2 | |
F22 | Laws and regulations | Legal issues | External Agent | 3.33% | 7 |
F23 | Slow permits by local authorities | External Agent | 0.56% | 33 | |
F24 | Materials | Shortage of materials | Supplier and Subcontractor | 1.67% | 22 |
F25 | Owner | Change orders due to the owner | Owner | 0.56% | 33 |
F26 | Lack of owner’s management skills | Owner | 1.67% | 22 | |
F27 | Land acquisition | Owner | 1.67% | 22 | |
F28 | Late decision making by owner | Owner | 2.78% | 11 | |
F29 | Scope changes due to the owner | Owner | 2.22% | 17 | |
F30 | Personal | Low productivity of labor | Contractor | 1.11% | 29 |
F31 | Staffing problems | Contractor | 2.78% | 11 | |
F32 | Programming and control | Inadequate project planning | Owner | 5.56% | 3 |
F33 | Project | Inadequate bidding method | Owner | 3.33% | 7 |
F34 | Project characteristics | Owner | 1.67% | 22 | |
F35 | Project scope changes | Owner | 5.56% | 3 | |
F36 | Site | Ground conditions | Designer and Consultant | 2.22% | 17 |
F37 | Poor site investigation | Designer and Consultant | 2.22% | 17 | |
F38 | Relocation of underground utilities | Designer and Consultant | 0.56% | 33 |
Frequency Rank (n = 18) | Factors | Number of Documents that Report the Factor (n = 45) |
---|---|---|
1 | Failures in design | 35 |
2 | Price variation of materials | 30 |
3 | Inadequate project planning | 29 |
3 | Project scope changes | 26 |
5 | Design changes | 25 |
5 | Unrealistic contract duration | 17 |
7 | Inadequate bidding method | 25 |
7 | Poor site management and supervision | 23 |
7 | Political situation | 18 |
7 | Legal issues | 18 |
Id | Category | Factors Classified | Relative Frequency | Cumulative Relative Frequency | Category Rank |
---|---|---|---|---|---|
C1 | Design | 2 | 17.22% | 17.22% | 1 |
C2 | Financial | 4 | 13.89% | 31.11% | 2 |
C3 | Project | 3 | 10.56% | 41.67% | 3 |
C4 | Contractor | 4 | 8.89% | 50.56% | 4 |
C5 | Owner | 5 | 8.89% | 59.45% | 5 |
C6 | External factors | 4 | 8.89% | 68.34% | 5 |
C7 | Contract | 2 | 6.11% | 74.45% | 7 |
C8 | Programming and control | 1 | 5.56% | 80.01% | 8 |
C9 | Site | 3 | 5.00% | 85.01% | 9 |
C10 | Contractual relationships | 3 | 4.44% | 89.45% | 10 |
C11 | Laws and regulations | 2 | 3.89% | 93.34% | 11 |
C12 | Personal | 2 | 3.89% | 97.23% | 11 |
C13 | Materials | 1 | 1.67% | 98.90% | 13 |
C14 | Consultant | 1 | 0.56% | 99.44% | 14 |
C15 | Equipment | 1 | 0.56% | 100.00% | 14 |
Total | 38 | 100% |
ID | Factors | Relative Frequency | RII | II | Influence Rank |
---|---|---|---|---|---|
F12 | Failures in design | 12.78% | 0.5947 | 7.60% | 1 |
F21 | Price variation of materials | 6.67% | 0.5053 | 3.37% | 2 |
F32 | Inadequate project planning | 5.56% | 0.3421 | 1.90% | 3 |
F35 | Project scope changes | 5.56% | 0.2632 | 1.46% | 4 |
F11 | Design changes | 4.44% | 0.2579 | 1.15% | 5 |
F3 | Unrealistic contract duration | 4.44% | 0.1711 | 0.76% | 6 |
F33 | Inadequate bidding method | 3.33% | 0.1947 | 0.65% | 7 |
F22 | Legal issues | 3.33% | 0.1842 | 0.61% | 8 |
F28 | Late decision making by owner | 2.78% | 0.1868 | 0.52% | 9 |
F15 | Political situation | 3.33% | 0.1500 | 0.50% | 10 |
F19 | Financial difficulties of owner | 2.78% | 0.1526 | 0.42% | 11 |
F6 | Inadequate contractor’s experience | 2.78% | 0.1474 | 0.41% | 12 |
F7 | Poor site management and supervision | 3.33% | 0.1158 | 0.39% | 13 |
F14 | Economy issues | 2.78% | 0.1316 | 0.37% | 14 |
F37 | Poor site investigation | 2.22% | 0.1632 | 0.36% | 15 |
F9 | Poor communication among stakeholders | 2.78% | 0.1237 | 0.34% | 16 |
F20 | Payment delays to contractor | 2.22% | 0.1526 | 0.34% | 17 |
F31 | Staffing problems | 2.78% | 0.1211 | 0.34% | 18 |
F36 | Ground conditions | 2.22% | 0.1474 | 0.33% | 19 |
F29 | Scope changes due to the owner | 2.22% | 0.1079 | 0.24% | 20 |
F5 | Inadequate construction methods | 1.67% | 0.0895 | 0.15% | 21 |
F2 | Poor contract management | 1.67% | 0.0895 | 0.15% | 21 |
F27 | Land acquisition | 1.67% | 0.0868 | 0.14% | 23 |
F18 | Financial difficulties of contractor | 2.22% | 0.0605 | 0.13% | 24 |
F16 | Unethical activities | 1.67% | 0.0789 | 0.13% | 25 |
F24 | Shortage of materials | 1.67% | 0.0789 | 0.13% | 25 |
F34 | Project characteristics | 1.67% | 0.0658 | 0.11% | 27 |
F26 | Lack of owner’s management skills | 1.67% | 0.0447 | 0.07% | 28 |
F8 | Claims and disputes with stakeholders | 1.11% | 0.0500 | 0.06% | 29 |
F4 | Delays of activities | 1.11% | 0.0421 | 0.05% | 30 |
F30 | Low productivity of labor | 1.11% | 0.0368 | 0.04% | 31 |
F25 | Change orders due to the owner | 0.56% | 0.0526 | 0.03% | 32 |
F23 | Slow permits by local authorities | 0.56% | 0.0526 | 0.03% | 32 |
F10 | Poor coordination among stakeholders | 0.56% | 0.0474 | 0.03% | 34 |
F13 | Shortage of equipment | 0.56% | 0.0421 | 0.02% | 35 |
F1 | Late decision making by consultants | 0.56% | 0.0316 | 0.02% | 36 |
F38 | Relocation of underground utilities | 0.56% | 0.0316 | 0.02% | 36 |
F17 | Weather | 1.11% | 0.0158 | 0.02% | 36 |
Id | Category | Relative Frequency | AII | Category Rank |
---|---|---|---|---|
C1 | Design | 17.22% | 4.37% | 1 |
C8 | Programming and control | 5.56% | 1.90% | 2 |
C2 | Financial | 13.89% | 1.07% | 3 |
C3 | Project | 10.56% | 0.74% | 4 |
C7 | Contract | 6.11% | 0.46% | 5 |
C11 | Laws and regulations | 3.89% | 0.32% | 6 |
C6 | External factors | 8.89% | 0.25% | 7 |
C4 | Contractor | 8.89% | 0.25% | 8 |
C9 | Site | 5.00% | 0.24% | 9 |
C5 | Owner | 8.89% | 0.20% | 10 |
C12 | Personal | 3.89% | 0.19% | 11 |
C10 | Contractual relationships | 4.44% | 0.14% | 12 |
C13 | Materials | 1.67% | 0.13% | 13 |
C15 | Equipment | 0.56% | 0.02% | 14 |
C14 | Consultant | 0.56% | 0.02% | 15 |
Stakeholder’s Group | SII | Ranking |
---|---|---|
Designer and Consultant | 40.51% | 1 |
Owner | 28.45% | 2 |
External Agent | 23.32% | 3 |
Contractor | 7.07% | 4 |
Supplier and Subcontractor | 0.66% | 5 |
* | D1 | D2 | D3 | D4 | D5 | D6 | D7 | D8 | D9 | D10 | D11 | D12 | D13 | D14 | D15 | D16 | D17 | D18 |
---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
D1 | 10 | |||||||||||||||||
D2 | 3 | 10 | ||||||||||||||||
D3 | 1 | 1 | 10 | |||||||||||||||
D4 | 2 | 2 | 3 | 10 | ||||||||||||||
D5 | 3 | 2 | 5 | 3 | 10 | |||||||||||||
D6 | 4 | 1 | 4 | 3 | 5 | 10 | ||||||||||||
D7 | 2 | 2 | 3 | 2 | 3 | 3 | 10 | |||||||||||
D8 | 1 | 2 | 4 | 2 | 3 | 4 | 2 | 10 | ||||||||||
D9 | 1 | 0 | 2 | 2 | 3 | 3 | 4 | 1 | 10 | |||||||||
D10 | 2 | 0 | 3 | 2 | 5 | 3 | 4 | 2 | 3 | 10 | ||||||||
D11 | 3 | 3 | 4 | 2 | 2 | 3 | 5 | 1 | 1 | 2 | 10 | |||||||
D12 | 3 | 2 | 4 | 2 | 3 | 4 | 4 | 3 | 1 | 2 | 6 | 10 | ||||||
D13 | 3 | 1 | 3 | 2 | 1 | 3 | 5 | 3 | 1 | 3 | 3 | 2 | 10 | |||||
D14 | 2 | 2 | 5 | 6 | 3 | 3 | 3 | 3 | 1 | 3 | 3 | 3 | 4 | 10 | ||||
D15 | 2 | 0 | 4 | 3 | 4 | 4 | 2 | 1 | 3 | 4 | 2 | 3 | 1 | 3 | 10 | |||
D16 | 2 | 1 | 3 | 4 | 3 | 3 | 2 | 4 | 1 | 2 | 2 | 2 | 3 | 5 | 3 | 10 | ||
D17 | 2 | 0 | 3 | 3 | 3 | 3 | 2 | 0 | 1 | 3 | 4 | 3 | 2 | 2 | 5 | 1 | 10 | |
D18 | 3 | 2 | 4 | 2 | 3 | 2 | 1 | 1 | 1 | 3 | 2 | 2 | 2 | 3 | 2 | 1 | 2 | 10 |
Influence Rank | Factors | Region | ||||
---|---|---|---|---|---|---|
Asia | Africa | Oceania | Europe | America | ||
1 | Failures in design | ✔ | ✔ | ✔ | ✔ | ✔ |
2 | Price variation of materials | ✔ | ✔ | ✔ | ||
3 | Inadequate project planning | ✔ | ✔ | ✔ | ||
4 | Project scope changes | ✔ | ✔ | ✔ | ||
5 | Design changes | ✔ | ✔ | ✔ | ✔ | |
6 | Unrealistic contract duration | ✔ | ✔ | ✔ | ||
7 | Inadequate bidding method | ✔ | ✔ | |||
8 | Legal issues | ✔ | ✔ | ✔ | ✔ | |
9 | Late decision making by owner | ✔ | ✔ | |||
10 | Political situation | ✔ | ✔ | |||
11 | Financial difficulties of owner | ✔ | ✔ | ✔ | ||
12 | Inadequate contractor’s experience | ✔ | ✔ | |||
13 | Poor site management and supervision | ✔ | ✔ | |||
14 | Economy issues | ✔ | ✔ | |||
15 | Poor site investigation | ✔ | ✔ |
© 2020 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (http://creativecommons.org/licenses/by/4.0/).
Share and Cite
Herrera, R.F.; Sánchez, O.; Castañeda, K.; Porras, H. Cost Overrun Causative Factors in Road Infrastructure Projects: A Frequency and Importance Analysis. Appl. Sci. 2020, 10, 5506. https://doi.org/10.3390/app10165506
Herrera RF, Sánchez O, Castañeda K, Porras H. Cost Overrun Causative Factors in Road Infrastructure Projects: A Frequency and Importance Analysis. Applied Sciences. 2020; 10(16):5506. https://doi.org/10.3390/app10165506
Chicago/Turabian StyleHerrera, Rodrigo F., Omar Sánchez, Karen Castañeda, and Hernán Porras. 2020. "Cost Overrun Causative Factors in Road Infrastructure Projects: A Frequency and Importance Analysis" Applied Sciences 10, no. 16: 5506. https://doi.org/10.3390/app10165506
APA StyleHerrera, R. F., Sánchez, O., Castañeda, K., & Porras, H. (2020). Cost Overrun Causative Factors in Road Infrastructure Projects: A Frequency and Importance Analysis. Applied Sciences, 10(16), 5506. https://doi.org/10.3390/app10165506
