Comparative Analysis of Building Information Modeling (BIM) Patterns and Trends in the United Arab Emirates (UAE) with Developed Countries
Abstract
:1. Introduction
1.1. BIM Adoption Status in the UAE
1.2. BIM Protocol and Global Mandates
2. Methodology
3. Results
- (1)

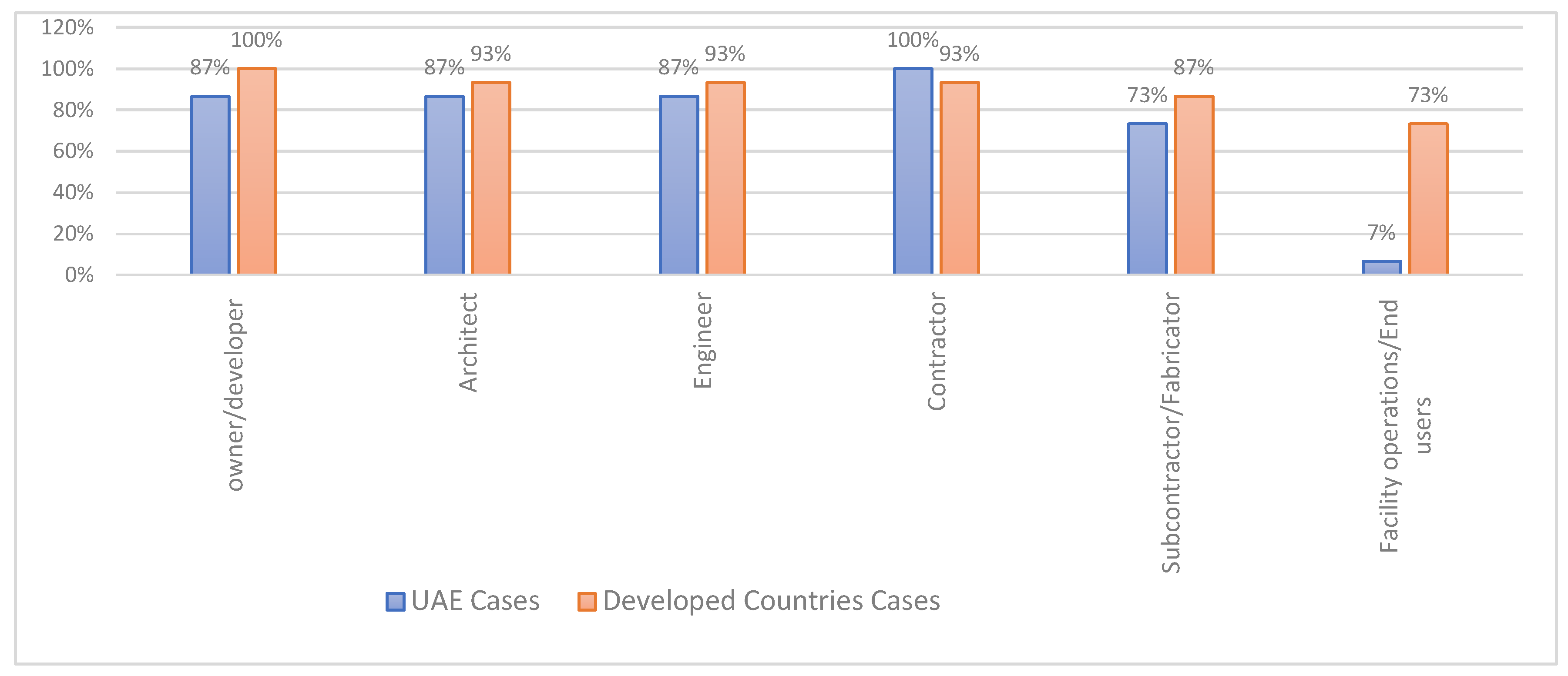

- Extent of Participant (parties and teams) Involvement
- (2)
- BIM Utilization by Phases of Projects’ Lifecycle
- (3)

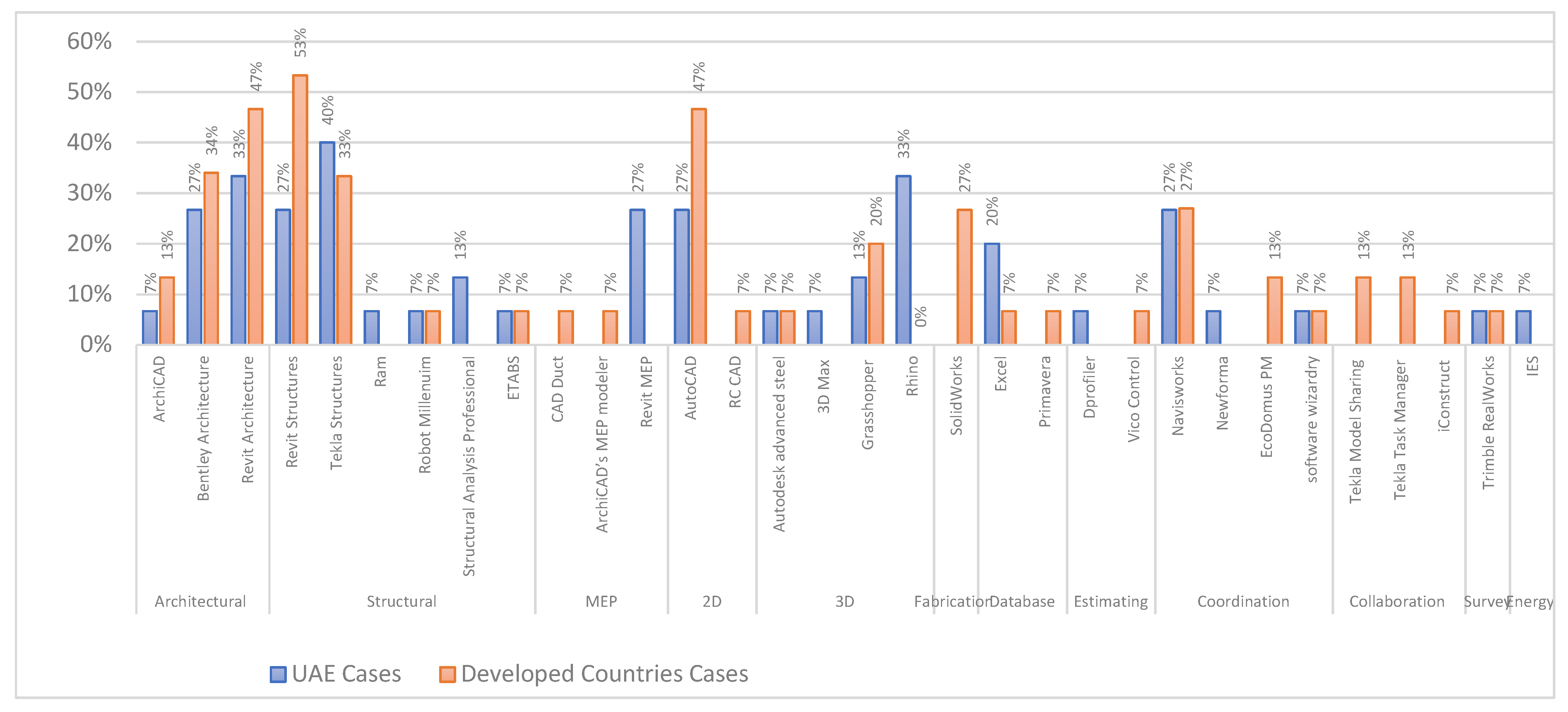

- Tools utilized during BIM process
- (4)

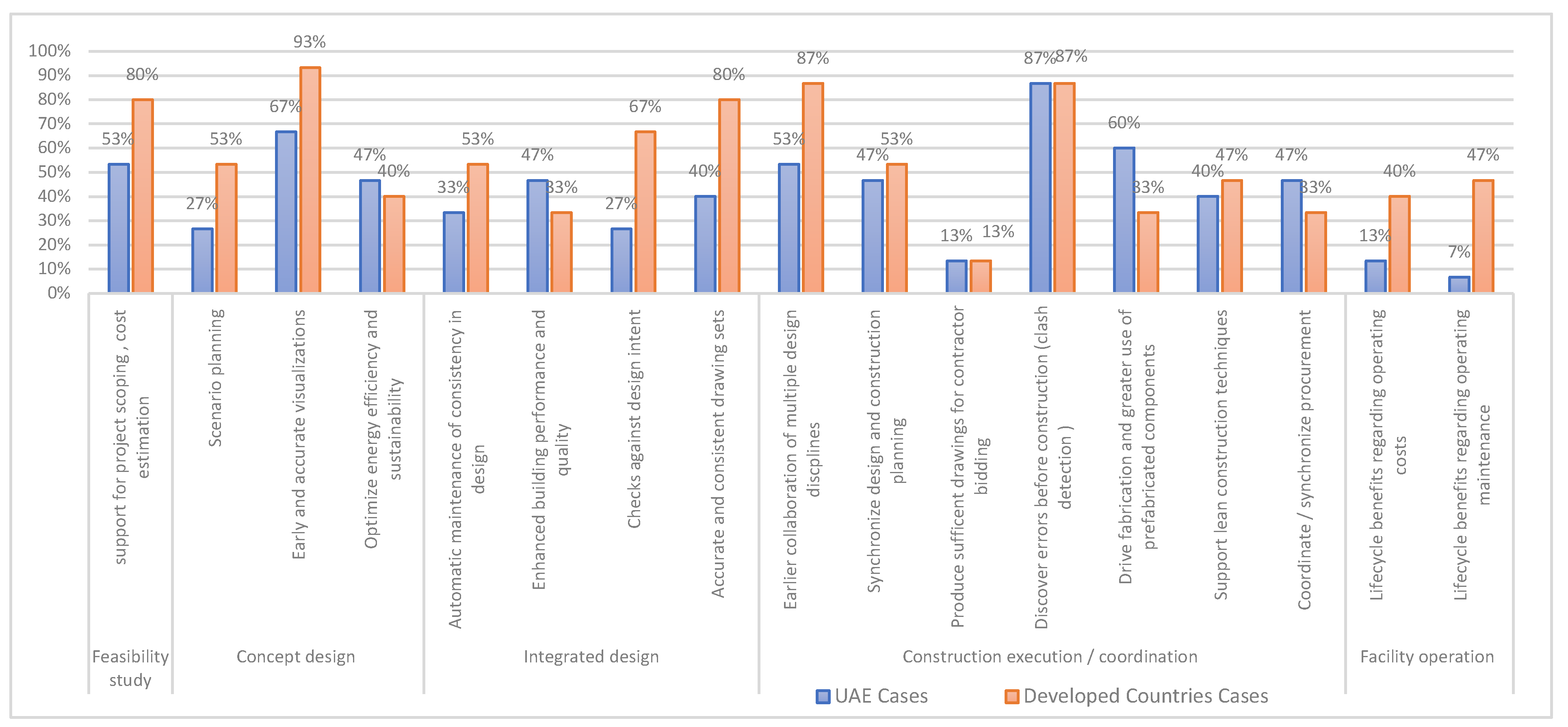

- BIM benefits
4. Discussion and Implications
4.1. Extent of Participant (Parties and Teams) Involvement
4.2. BIM Utilization by Phases of Projects’ Lifecycle
“Once the airport is done, it will be operated for 25 years, including the operation stage, where BIM will play a major role. “This methodology will allow us to reach the necessary information and solve future operation problems related to the airport systems along the pre-commissioning and maintenance stages. In addition, BIM will be used for all dimensions. The 6th dimension includes both facility management and lifecycle management stage” [22].
“The client set this as a key requirement in order for the model to be used in the future for maintenance and development purposes” [54].
“Now, NATO has a quality 3D BIM model that can be used to operate their new headquarters” [21].
“Finally, the documentation of the building and its correspondence to an accurate digital model provided a valuable database for building maintenance” [30].
“However, most of these (expert’s firm) projects are still under construction phase. So, we did not reach actually to that phase (FM) where we are really running the system efficiently”.
4.3. Tools Utilized during BIM Process
4.4. BIM Benefits
“at the moment, we see something called the design intent model, and then we can see the contractor coming in and developing something from scratch, which is called a construction intent model. For many reasons, one of them is liability and risk; another is the modeling methodology; the other is the fact there is no trust between the contractor and the designer. The contractor would rather build something from scratch by themselves”.
“… contractors would never want to take (risk) their life ability to use someone else’s models”.
“99% of the time, the contractor would want to develop their own, and they would call that construction intent model. Because when the design is conceived, all the way to the detailed design or even tender stage of the design, the designer/consultant uses a different methodology; they use a different way of modeling and designing that are contractor cannot/do not easily utilize”.
“In the UK, it is totally different; the designer provides fully detailed drawings, so as a subcontractor, you need only to add hangers and support and continue to use the same model “.
4.5. Ranking BIM’s Benefits by Experts
4.6. Experts on Unrealized UAE BIM Potential in FM
“the municipality is asking to do a model, and that is it. That model could be empty or just like the simple exterior model and nothing inside. There was no auditing or reviewing, and eventually, the engineers were reviewing the information in 2D drawings”.
“in the UAE, the potential of utilizing BIM in FM stage is very high. Though our clients are well aware of what BIM can bring for them at FM stage, they do not know where to start”
“Facility operation is the new trend actually, and we are encouraging the clients to do it and so on, but, I think, except few attempts, there is no real yet full and efficient deployment. So, for some people trying to prove a concept, but it is not actually”.
“The asset information model can be handed over to the facility management team and operation or even the asset owners. And this has a lot more potential than receiving drawings and specs and information about the building in printouts and boxes”.
5. Conclusions
Author Contributions
Funding
Institutional Review Board Statement
Informed Consent Statement
Data Availability Statement
Conflicts of Interest
References
- Sacks, R.; Eastman, C.; Lee, G.; Teicholz, P. BIM Handbook: A Guide to Building Information Modeling for Owners, Designers, Engineers, Contractors, and Facility Managers; John Wiley & Sons: Hoboken, NJ, USA, 2018. [Google Scholar]
- Abbasnejad, B.; Nepal, M.P.; Ahankoob, A.; Nasirian, A.; Drogemuller, R. Building Information Modelling (BIM) adoption and implementation enablers in AEC firms: A systematic literature review. Archit. Eng. Des. Manag. 2021, 17, 411–433. [Google Scholar] [CrossRef]
- Aksenova, G.; Kiviniemi, A.; Kocaturk, T.; Lejeune, A. From Finnish AEC knowledge ecosystem to business ecosystem: Lessons learned from the national deployment of BIM. Constr. Manag. Econ. 2019, 37, 317–335. [Google Scholar] [CrossRef]
- Shafiq, M.T. Client-Driven Level 2 BIM Implementation: A Case Study from the UAE. Open Constr. Build. Technol. J. 2021, 15, 1. [Google Scholar] [CrossRef]
- Al-Hammadi, M.A.; Tian, W. Challenges and barriers of building information modeling adoption in the Saudi Arabian construction industry. Open Constr. Build. Technol. J. 2020, 14, 98–110. [Google Scholar] [CrossRef]
- Olawumi, T.O.; Chan, D.W. Development of a benchmarking model for BIM implementation in developing countries. Benchmarking Int. J. 2019, 26, 1210–1232. [Google Scholar] [CrossRef]
- Cherian, A. The construction industry in the perspective of an economic boost in the United Arab Emirates (UAE). Int. Res. J. Eng. Technol. 2020, 7, 270–276. [Google Scholar]
- Gerges, M.; Austin, S.; Mayouf, M.; Ahiakwo, O.; Jaeger, M.; Saad, A.; El Gohary, T. An investigation into the implementation of Building Information Modeling in the Middle East. J. Inf. Technol. Constr. 2017, 22, 1–15. [Google Scholar]
- Omar, H.; Dulaimi, M. Solutions for effective diffusion of BIM for BIM late adopters: Case study of UAE AEC industry. Int. J. Constr. Manag. 2021, 1–10. [Google Scholar] [CrossRef]
- Edirisinghe, R.; London, K. Comparative analysis of international and national level BIM standardization efforts and BIM adoption. In Proceedings of the 32nd CIB W78, Eindhoven, The Netherlands, 27–29 October 2015; pp. 800–809. [Google Scholar]
- Mehran, D. Exploring the Adoption of BIM in the UAE Construction Industry for AEC Firms. Procedia Eng. 2016, 145, 1110–1118. [Google Scholar] [CrossRef] [Green Version]
- Dubai Building Code. Dubai Municipality. 2022. Available online: https://www.dm.gov.ae/municipality-business/planning-and-construction/dubai-building-code-2/ (accessed on 18 February 2023).
- Dadlani, D. 2021 UAE Launches National Guide for Smart Construction, Construction Week. Available online: https://www.constructionweekonline.com/products-services/270919-uae-launches-national-guide-for-smart-construction (accessed on 18 February 2023).
- Ministry of Energy & Infrastructure. News. Media Centre. Ministry of Energy and Infrastructure in UAE. 2021. Available online: https://www.moei.gov.ae/en/media-centre/news (accessed on 18 February 2023).
- Eastman, C.M.; Eastman, C.; Teicholz, P.; Sacks, R.; Liston, K. BIM Handbook: A Guide to Building Information Modeling for Owners, Managers, Designers, Engineers, and Contractors; John Wiley & Sons: Hoboken, NJ, USA, 2011. [Google Scholar]
- Prabhakaran, A.; Mahamadu, A.M.; Mahdjoubi, L.; Andric, J.; Manu, P.; Mzyece, D. An investigation into macro BIM maturity and its impacts: A comparison of Qatar and the United Kingdom. Archit. Eng. Des. Manag. 2021, 17, 496–515. [Google Scholar] [CrossRef]
- Lee, S.; Yu, J. Comparative study of BIM acceptance between Korea and the United States. J. Constr. Eng. Manag. 2016, 142, 05015016. [Google Scholar] [CrossRef]
- Wong, A.K.; Wong, F.K.; Nadeem, A. Government roles in implementing building information modelling systems: Comparison between Hong Kong and the United States, Constr. Innov. 2011, 11, 61–76. [Google Scholar] [CrossRef]
- Trimble Solutions Middle East. Middle East Construction Industry Technology and Trends. 2023. Available online: https://www.tekla.com/ae/resources (accessed on 26 February 2023).
- TheB1M. Engineering Dubai Opera House. 2016. Available online: https://www.theb1m.com/video/engineering-dubai-opera-house (accessed on 26 February 2023).
- BIM Community. Case Studies: Real Stories from Real BIM People. BIM Has Been Used to Design and Build the New NATO Headquarters in Brussels. 2018. Available online: https://www.bimcommunity.com/experiences/load/1`36/bim-has-been-used-to-design-and-build-the-new-nato-headquarters-in-Brussels (accessed on 21 January 2023).
- BIM community. Case Studies: Real Stories from Real BIM People. BIM in Turkey: The Use of BIM on the Istanbul Grand Airport. 2018. Available online: https://www.bimcommunity.com/experiences/load/142/Blank (accessed on 22 January 2023).
- ME Construction News. Features. 2023. Available online: https://meconstructionnews.com/list/features (accessed on 25 February 2023).
- World Economic Forum. Shaping the Future of Construction Lessons from leading innovators and disruptors. 2023. Available online: https://www3.weforum.org/docs/WEF_Future_of_Construction_Softlaunch_Report_Jan2017.pdf (accessed on 25 February 2023).
- SOM. Meet the Man Behind Burj Khalifa. 2016. Available online: https://www.som.com/news/meet-the-man-behind-burj-khalifa/ (accessed on 25 February 2023).
- The B1M Construction tech for sustainability. Available online: https://www.theb1m.com/ (accessed on 26 February 2023).
- Thornton Tomasetti. 2023. Hazza Bin Zayed Stadium. 2017. Available online: https://www.thorntontomasetti.com/project/hazza-bin-zayed-stadium (accessed on 25 February 2023).
- OBERMEYER. New Al Ain Hospital. 2023. Available online: https://www.obermeyer-group.com/en/references/detail/new-al-ain-hospital (accessed on 25 February 2023).
- Autodesk. Customer Story Finder. 2023. Available online: https://www.autodesk.ae/customer-stories/case-studies (accessed on 25 February 2023).
- Autodesk. BIM Implementation—Case Studies. 2021. Available online: https://www.breakwithanarchitect.com/post/bim-case-studies (accessed on 21 January 2023).
- Burohappold Engineering. A Sustainable Desert Icon for Bee’ah: Bee’ah Headquarters Emirate of Sharjah, UAE. 2023. Available online: https://www.burohappold.com/projects/beeah-headquarters/ (accessed on 25 February 2023).
- MEED. Case Study: Siemens Digitises HQ Construction Process Using BIM. 2018. Available online: https://www.meed.com/siemens-hq-construction-bim-digital (accessed on 25 February 2023).
- Mpofu, B.; Ochieng, E.; Moobela, C.; Pretorius, A. Profiling causative factors leading to construction project delays in the United Arab Emirates. Eng. Constr. Archit. Manag. 2017, 24, 346–376. [Google Scholar] [CrossRef] [Green Version]
- Koseoglu, O. Bim in the Middle East—Construction Week Online. Construction Week Middle East. 2021. Available online: https://www.constructionweekonline.com/business/article-20854-bim-in-the-middle-east (accessed on 22 January 2023).
- Marketline. Construction in United Arab Emirates; Market Line e-book: London, UK, 2016; Available online: https://store.marketline.com/report/construction-in-united-arab-emirates-5/ (accessed on 15 January 2023).
- Omar, H.S. Solutions for the UAE Architecture, Engineering, and Construction (AEC) Industry to Mandate Building Information Modeling (BIM). PhD Dissertation, The British University in Dubai, Dubai, United Arab Emirates, 2015. [Google Scholar]
- Jiang, Y.; Ma, P.; Zhang, S. Contractual Governance of BIM-Enabled Projects: Where Are We? Int. J. Archit. Eng. Constr. 2018, 7, 1. [Google Scholar] [CrossRef]
- Lee, G.; Borrmann, A. BIM policy and management. Constr. Manag. Econ. 2020, 38, 413–419. [Google Scholar] [CrossRef] [Green Version]
- Sielker, F.; Allmendinger, P. International Experiences: Future Cities and BIM. 2018. Available online: https://www.cdbb.cam.ac.uk/system/files/documents/FutureCitiesandBuildingInformationManagement_Report.pdf (accessed on 22 January 2023).
- EU BIM Task Group. Bringing Together National Efforts into a Common and Aligned European Approach to Develop a World-Class Digital Construction Sector. 2022. Available online: http://www.eubim.eu/ (accessed on 22 January 2023).
- Centre for Digital Built Britain. Centre for Digital Built Britain Completed Its Five-Year Mission and Closed Its Doors at the End of September 2022. 2018. Available online: https://www.cdbb.cam.ac.uk/Resources/Publications (accessed on 22 January 2023).
- Thompson, W.R. The UK BIM Revolution. Bachelor Thesis, Construction Management Department, California Polytechnic State University, San Luis Obispo, CA, USA, 2017. [Google Scholar]
- Panteli, C.; Polycarpou, K.; Morsink-Georgalli, F.Z.; Stasiuliene, L.; Pupeikis, D.; Jurelionis, A.; Fokaides, P.A. Overview of BIM integration into the construction sector in European member states and European Union Acquis. IOP Conf. Ser. Earth Environ. Sci. 2020, 410, 012073. [Google Scholar] [CrossRef]
- Lee, K.; Park, Y.H.; Lee, G.; Jung, W.; Lee, S.; Lee, H. An Introduction to South Korea’s BIM Knowledge Base Development Project. In Proceedings of the International Symposium on Automation and Robotics in Construction, Oulu, Finland, 15–18 June 2015; Available online: https://www.iaarc.org/publications/2015_proceedings_of_the_32st_isarc_oulu_finland/an_introduction_to_south_koreas_bim_knowledge_base_development_project.html (accessed on 26 January 2023).
- Liao, L.; Teo, E.A.L.; Chang, R.; Li, L. Investigating critical non-value-adding activities and their resulting wastes in BIM-based project delivery. Sustainability 2020, 12, 355. [Google Scholar] [CrossRef] [Green Version]
- Bryman, A. Triangulation and Measurement. Retrieved from Department of Social Sciences, Loughborough University, Loughborough, Leicestershire. 2004. Available online: www.referenceworld.com/sage/socialscience/triangulation.pdf (accessed on 25 February 2023).
- Denzin, N.K. The Research Act: A Theoretical Introduction to Sociological Methods; Routledge: New York, NY, USA, 2017. [Google Scholar]
- Patton, M.Q. Two decades of developments in qualitative inquiry: A personal, experiential perspective. Qual. Soc. Work. 2002, 1, 261–283. [Google Scholar] [CrossRef]
- Ragin, C.C. The Comparative Method: Moving Beyond Qualitative and Quantitative Strategies; University of California Press: Oakland, CA, USA, 2014. [Google Scholar]
- Weaver, A.; Atkinson, P. Microcomputing and Qualitative Data Analysis; Aldershot: Avebury, UK, 1994. [Google Scholar]
- Trading Economics. 2022 Turkey GDP per capita 2022 Data—2023 Forecast. Trading Economics. Available online: https://tradingeconomics.com/turkey/gdp-per-capita (accessed on 19 February 2023).
- World Bank. GDP per Capita (Current US$)—Turkiye, Data. The World Bank. 2021. Available online: https://data.worldbank.org/indicator/NY.GDP.PCAP.CD?locations=TR (accessed on 19 February 2023).
- ChinaPower Team. “Is China a Developed Country?” China Power. 2020. Available online: https://chinapower.csis.org/is-china-a-developed-country/ (accessed on 19 February 2023).
- Lahdelma & Mahlamäki Architects. BIM Community. Case Studies: Real Stories from Real BIM People. Easton Commercial Centre, Helsinki: Bimcommunity. 2019. Available online: https://www.bimcommunity.com/experiences/load/60/easton-commercial-centre-helsinki (accessed on 21 January 2023).
- Chahrour, R.; Atif Hafeez, M.; Mohammad Ahmad, A.; Sulieman, H.I.; Dawood, H.; Rodriguez-Trejo, S.; Kassem, M.; Naji, K.K.; Dawood, N. Cost-benefit analysis of BIM-enabled design clash detection and resolution. Constr. Manag. Econ. 2021, 39, 55–72. [Google Scholar] [CrossRef]
UAE BIM Cases | DC (Developed Countries) BIM Cases | |||||||
---|---|---|---|---|---|---|---|---|
Typology | P ID | Project | Location | Year | P ID | Project | Country | Year |
Opera House | UA 1 | Dubai Opera House [19,20] | Dubai | 2013–2016 | DC 1 | Sydney Opera house [21] | Australia | 2007 |
Airport | UA 2 | Midfield Terminal, Airport [20,21] | Abu Dhabi | 2012–2023 | DC 2 | Istanbul Grand Airport [21,22] | Turkey | 2018 |
High-rise Tower | UA 3 | Damac Towers [2,23] | Dubai | 2012–2017 | DC 3 | Shanghai Tower [19,21] | China | 2008–2014 |
UA 4 | Burj Khalifa [24,25] | Dubai | 2004–2010 | DC 4 | Alto Tower [19,21] | France | 2011–2015 | |
UA 5 | Capital Gate [19] | Abu Dhabi | 2007–2011 | DC 5 | One Nine Elms [20,26] | UK | 2015–2023 | |
Stadium | UA 6 | Hazza Bin Zayed Stadium [27] | Abu Dhabi | 2012–2014 | DC 6 | CSKA Moscow Stadium [21] | Russia | 2016 |
Hospital | UA 7 | New Al Ain hospital [28] | Abu Dhabi | 2007–2011 | DC 7 | Queen Elizabeth Univ. Hospital [20] | UK | 2015 |
UA 8 | Mediclinic Parkview Hospital [23] | Dubai | 2015–2018 | DC 8 | Perth’s Children Hospital [20,21] | Australia | 2018 | |
Hotel | UA 9 | The Address JBR [19] | Dubai | 2015–2018 | DC 9 | Hilton Garden Inn Atlanta [29] | USA | 2006–2008 |
Shopping Mall | UA 10 | Al Zahia city center mall [19,21] | Sharjah | 2017–2021 | DC 10 | Easton Commercial Centre [21] | Finland | 2017 |
UA 11 | The Dubai Mall [19,27] | Dubai | 2015–2018 | DC 11 | Mall of Tripla [27] | Finland | 2015–2019 | |
Museum | UA 12 | Museum of the Future [19,21,30] | Dubai | 2015–2021 | DC 12 | V&A Dundee Museum [21] | UK | 2015–2018 |
UA 13 | Louvre Museum [21,30] | Abu Dhabi | 2009–2017 | DC 13 | House of the Future [20] | Germany | 2017 | |
Headquarter | UA 14 | Sharjah Bee’ah Headquarter [31] | Sharjah | 2016–2021 | DC 14 | NATO headquarters [21] | Belgium | 2010–2016 |
UA 15 | Aldar headquarters [19] | Abu Dhabi | 2007–2010 | DC 15 | Siemens Headquarters [21,32] | Switzerland | 2016–2018 |
UAE BIM Cases | Developed Countries BIM Cases | ||||||||||||||||||||||||||||||
---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
U A 1 | U A 2 | U A 3 | U A 4 | U A 5 | U A 6 | U A 7 | U A 8 | U A 9 | U A 10 | U A 11 | U A 12 | U A 13 | U A 14 | U A 15 | D C 1 | D C 2 | D C 3 | D C 4 | D C 5 | D C 6 | D C 7 | D C 8 | D C 9 | D C 10 | D C 11 | D C 12 | D C 13 | D C 14 | D C 15 | ||
Project Scope | Feasibility | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||||||||||||||||||||
Concept Development | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||||||||
Design Development | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||||||
Design Documents | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||
Pre-construction | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||||
Construction | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||
Operation | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||||||||||||||||
Participants | owner/developer | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||
Architect | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||||
Engineer | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||||
Contractor | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||
Subcontractor/Fabricator | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||
Facility operations/End users | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||||||||||||||
BIM Benefits | Feasibility study: Support for project scoping, cost estimation | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||||||||||
Concept design: 1. Scenario planning | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||||||||||||||
2. Early and accurate visualizations | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||
3 Optimize energy efficiency and sustainability | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||||||||||||||||||
Integrated design/cons.: 1. Automatic maintenance of consistency in design. | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||||||||||||||||||
2. Enhanced building performance and quality. | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||||||||||||||
3. Checks against design intent. | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||||||||||||
4. Accurate and consistent drawing sets | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||||||||
Construction execution/coordination: 1. Earlier collaboration of multiple design disciplines | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||||||||||
2. Synchronize design and construction planning. | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||||||||||||||||
3. Produce sufficient drawings for contractor bidding. | ● | ● | ● | ● | |||||||||||||||||||||||||||
4. Discover errors before construction (clash detection). | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||
5. Drive fabrication and greater use of prefabricated components. | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||||||||||||
6. Support lean construction techniques. | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ||||||||||||||||||
7. Coordinate/synchronize procurement. | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | ● | |||||||||||||||||||
Facility operation: 1. Lifecycle benefits regarding operating costs. | ● | ● | ● | ● | ● | ● | |||||||||||||||||||||||||
2. Lifecycle benefits regarding operating maintenance | ● | ● | ● | ● | ● | ● | ● | ● | ● |
Expert | Affiliation | Field/Role | Experience/Years in AEC | Organization Type | No. of Employees |
---|---|---|---|---|---|
E1 | Turner Construction—International LLC: Digital Construction Lead | BIM speaker, BIM conferences/events contributor and organizer. Government consulting and partnering | 18 | Construction/contractor | 171 |
E2 | Centre of Excellence in Smart Construction | Director- Consultant/BIM consultant | 12 | Consultancy/Research | 200 |
E3 | EVERSENDAI ENGINEERING (L.L.C.) | Detailing Manager/Innovation in construction and composite structures. BIM structural modeling | 15 | Steel Contractor | 99 |
E4 | ASGC: a leading construction conglomerate | Digital Innovation Manager/BIM specialist | 11 | construction conglomerate | 11,584 |
E5 | Engineering group | Engineer manager/BIM specialist | 14 | Engineering contracting | 525 |
E6 | KFM Consultant | Design and Technical | 7 | Consultancy | 1323 |
E7 | Redington Gulf FZE | Technical Consultant AEC | 18 | Autodesk Software Solution Distributor | 45 |
Feasibility Study | Concept Design | Integrated Design | Construction Execution/Coordination | Facility Operation | |||||||||||||
---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
support for project scoping, cost estimation | Scenario planning | Early and accurate visualizations | Optimize energy efficiency and sustainability | Automatic maintenance of consistency in design | Enhanced building performance and quality | Checks against design intent | Accurate and consistent drawing sets | Earlier collaboration of multiple design disciplines | Synchronize design and construction planning | Produce sufficient drawings for contractor bidding | Discover errors before construction (clash detection) | Drive fabrication and greater use of prefabricated components | Support lean construction techniques | Coordinate / synchronize procurement | Lifecycle benefits regarding operating costs | Lifecycle benefits regarding operating maintenance | |
E 1 | 5 | 3 | 4 | 1 | 2 | ||||||||||||
E 2 | 1 | 2 | 4 | 3 | 5 | 6 | 7 | 8 | 9 | ||||||||
E 3 | 3 | 2 | 4 | 5 | 1 | ||||||||||||
E 4 | 5 | 6 | 4 | 1 | 2 | 7 | 3 | ||||||||||
E 5 | 2 | 1 | 6 | 3 | 4 | 5 | |||||||||||
E 6 | 1 | 3 | 2 | 5 | 4 | ||||||||||||
E 7 | 5 | 1 | 3 | 2 | 4 | 5 | 6 | 7 | 9 | 8 | |||||||
Ranking Scale: 1: Top-ranked; 9: lowest ranked |
